CONSTRUCTORA HERNANDEZ JAVIER & ASOCS.
DISEÑOS, CONSTRUCCION, SUPERVISION.
AV. Independencia # 1103 Residencial Don Pedro Local 101 Tel. 809-534-5696 Cel: 829-657-1404, Santo Domingo, Rep. Dom.
Email: felixhj2@hotmail.com
LISTA DE MATERIALES PARA CONSTRUCCION DE CASA ESTHER ROBLES ( 42 MT2 )
N° PARTIDAS CANTIDAD U.D P. U. VALOR SUB-TOTAL
LISTA DE MATERIALES
1.000 MATERIALES VARIOS
1.010 BLOCKS 6´´ 1,301.00 UNDS 24.00 31,224.00
1.020 BLOCKS 4´´ 65.00 UNDS 22.00 1,430.00
1.030 CEMENTO GRIS 290.00 FUNDAS 300.00 87,000.00
1.040 CEMENTO BLANCO 2.00 FUNDAS 675.00 1,350.00
PAGATO 12.00 FUNDAS 225.00 2,700.00
1.050 VARILLAS Ø 3/8" 24.75 QQ 2,080.00 51,480.00
1.060 VARILLAS Ø 1/2" 5.50 QQ 2,080.00 11,440.00
1.070 ALAMBRE CAL 18 60.50 LBS 35.00 2,117.50
1.080 ARENA ITABO PARA H.A 10.00 M3 750.00 7,500.00
1.090 ARENA ITABO PARA COLOCAR BLOCKS 5.00 M3 750.00 3,750.00
1.100 GRAVA PARA H.A 8.00 M3 850.00 6,800.00
1.110 ARENA FINA PARA PAÑETE 8.00 M3 900.00 7,200.00
1.120 ARENA PARA FINO DE TECHO 3.00 M3 750.00 2,250.00
1.130 CALICHE O MATERIAL DE RELLENO CLASIFICADO 18.00 M3 300.00 5,400.00
1.140 IMPERMEABILIZANTE ACRILICO 1.00 CUBETA 3,850.00 3,850.00
1.150 PORCELANATO REGULAR ANTI MANCHAS 40X40 CMS 40.00 M2 380.00 15,200.00
1.160 PISO CERAMICA PARA BAÑO 2.50 M2 210.00 525.00
1.170 CERAMICA DE PARED PARA BAÑO 15.00 M2 225.00 3,375.00
1.180 CERAMICA DE PARED PARA COCINA 1.50 M2 250.00 375.00
1.190 INODORO 1.00 UNDS 2,650.00 2,650.00
1.200 PLATO DE DUCHA 1.00 UNDS 1,800.00 1,800.00
1.210 LAVAMANO TAINO 1.00 UNDS 850.00 850.00
1.220 FREGADERO SENCILLO 1.00 UNDS 1,200.00 1,200.00
1.230 LLAVE MEZCLADORA PARA DUCHA 1.00 UNDS 850.00 850.00
1.240 LLAVE MEZCLADORA PARA FREGADERO 1.00 UNDS 750.00 750.00
1.250 LLAVE MEZCLADORA PARA LAVAMANO 1.00 UNDS 450.00 450.00
1.260 TUBERIAS Y PIEZAS 1.00 UNDS 4,500.00 4,500.00
1.270 Panel de distribucion de 4 circuitos a 8 circuitos INCLUYE BREAKERS 1.00 ud 1,200.00 1,200.00
1.280 toma corriente 110v 8.00 uds 75.00 600.00
1.290 toma corriente 220v 2.00 uds 75.00 150.00
1.300 Insterruptores sencillo 5.00 uds 75.00 375.00
1.310 Luces cenitales 5.00 uds 60.00 300.00
1.320 salida de cable tv 3.00 uds 75.00 225.00
1.330 salida de telefono 2.00 uds 95.00 190.00
1.340 Alambre calibre 8 para conexion desde calle hasta caja de breaker 300.00 pies 18.00 5,400.00

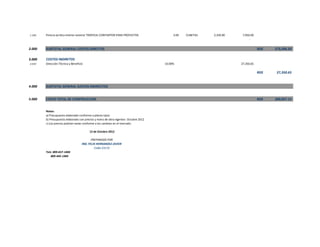

1.350 Pintura acrilica interior exterior TROPICAL CONTARTOR PARA PROYECTOS 3.00 CUBETAS 2,350.00 7,050.00
-
2.000 SUBTOTAL GENERAL COSTOS DIRECTOS 273,506.50RD$
3.000 COSTOS INDIRETOS
2.010 Dirección Técnica y Beneficio 10.00% 27,350.65
27,350.65RD$
4.000 SUBTOTAL GENERAL GASTOS INDIRECTOS
5.000 COSTO TOTAL DE CONSTRUCCION 300,857.15RD$
Notas:
a) Presupuesto elaborado conforme a planos tipos
b) Presupuesto elaborado con precios y mano de obra vigentes Octubre 2012
c) Los precios podrían variar conforme a los cambios en el mercado.
12 de Octubre 2012
PREPARADO POR
ING: FELIX HERNANDEZ JAVIER
Codia 23110
Tels: 809-657-1404
809-445-1404
CONSTRUCTORA HERNANDEZ JAVIER & ASOCS.
DISEÑOS, CONSTRUCCION, SUPERVISION.
AV. Independencia # 1103 Residencial Don Pedro Local 101 Tel. 809-534-5696 Cel: 829-657-1404, Santo Domingo, Rep. Dom.
Email: felixhj2@hotmail.com
LISTA DE MANO DE OBRA CONSTRUCCION CASA ESTHER ROBLES ( 42 MT2 )
N° PARTIDAS CANTIDAD U.D P. U. VALOR
LISTA DE MANO DE OBRA A PAGAR
1.000 TRABAJOS PRELIMINARES

1.010 Replanteos casa ( incluye madera y pago a maestro ) 42.00 M² 30.00 1,260.00
1.020
Conexiones temporales o facilidades de agua y energía eléctrica para áreas de construcción y campamento
personal 1.00 PA 1,500.00 1,500.00
1.030 Habilitar área almacén materiales 1.00 PA 10,000.00 10,000.00
2.000 MOVIMIENTO DE TIERRAS
2.010 M.O EXCAVACION Zapatas muros bloques 6´´ 13.28 M3 300.00 3,985.20
2.020 M.O EXCAVACION Zapatas muros bloques 4´´ 0.24 M3 300.00 72.00
2.020 M.O EXCAVACION Zapatas columnas ( 1,0 x 1,0 ) mts 5.40 M3 300.00 1,620.00
2.030 M.O Relleno compactado interior casa material seleccionado 16.80 M3 100.00 1,680.00
2.040 M.O Relleno de reposicion interior casa material excavado 9.34 M3 80.00 747.36
3.000 HORMIGON ARMADO EN ESTRUCTURAS DE :
3.100 ZAPATA DE MUROS DE 6´´
3.110 M.O ACERO EN Zapatas muros 6" =3 Ø 3/8" con cangrejos @ 0.25 m. 36.90 M.L 50.00 1,845.00
3.120 M.O LIGADO Y VACIADO DE Zapatas muros 6" =3 Ø 3/8" con cangrejos @ 0.25 m. 3.32 M3 700.00 2,324.70
3.200 ZAPATA DE MUROS DE 4´´
3.210 M.O ACERO EN Zapatas muros 4" =3 Ø 3/8" con cangrejos @ 0.25 m. 2.00 M.L 50.00 100.00
3.220 M.O LIGADO Y VACIADO DE Zapatas muros 4" =3 Ø 3/8" con cangrejos @ 0.25 m. 1.50 M3 7,231.14 10,846.71
3.300 ZAPATA DE COLUMNAS DE CARGAS
3.310 M.O ACERO EN Zapatas columnas =6 Ø 1/2" con S= @ 0.20 m. 6.00 UNDS 100.00 600.00
3.320 M.O LIGADO Y VACIADO DE Zapatas columnas =6 Ø 1/2" con S= @ 0.20 m. 1.50 M3 700.00 1,050.00
3.400 COLUMNAS DE CARGAS -
3.410 M.O ACERO C1, primer nivel = 4 Ø 1/2" con estribos @ 0.20 m. 21.60 M.L 60.00 1,296.00
3.420 M.O ENCOFRADO C1, primer nivel = 4 Ø 1/2" con estribos @ 0.20 m. 21.60 M.L 175.00 3,780.00
3.430 M.O LIGADO Y VACIADO C1, primer nivel = 4 Ø 1/2" con estribos @ 0.20 m. 1.00 PA 1,200.00 1,200.00
3.500 VIGAS DE CARGAS Y DINTLES -
3.510 M.O ACERO EN Vigas de cargas en primer nivel = 3 Ø 1/2" + 2 Ø 3/8"con estribos @ 0.20 m. 41.00 M.L 60.00 2,460.00
3.520 M.O ENCOFRADO Vigas de cargas en primer nivel = 3 Ø 1/2" + 2 Ø 3/8"con estribos @ 0.20 m. 41.00 M.L 175.00 7,175.00
3.530 M.O LIGADO Y VACIADO Vigas de cargas en primer nivel = 3 Ø 1/2" + 2 Ø 3/8"con estribos @ 0.20 m. 1.85 M3 850.00 1,568.25
3.520 M.O ACERO Vigas perimetral nivel de piso = 4 Ø 3/8" con estribos @ 0.20 m. 28.00 M.L 55.00 1,540.00
3.530 M.O ENCOFRADO Vigas perimetral nivel de piso = 4 Ø 3/8" con estribos @ 0.20 m. 28.00 M.L 175.00 4,900.00
3.540 M.O LIGADO Y VACIADO Vigas perimetral nivel de piso = 4 Ø 3/8" con estribos @ 0.20 m. 1.00 PA 900.00 900.00

3.530 M.O ACERO Viga dintel 4 Ø 3/8" con estribos @ 0.20 m. 13.80 M.L 55.00 759.00
3.540 M.O ENCOFRADO Viga dintel 4 Ø 3/8" con estribos @ 0.20 m. 13.80 M.L 175.00 2,415.00
3.550 M.O LIGADO Y VACIADO Viga dintel 4 Ø 3/8" con estribos @ 0.20 m. 1.00 PA 900.00 900.00
3.600 LOSA DE ENTREPISO Y TECHO -
3.610 M.O ACERO Losa de Hormigon Armado de H= 0.12m con Fc= 210kg/cm2 incluye vuelo ( Ø 3/8") 7.00 QQ 190.00 1,330.00
3.620 M.O ENCOFRADO Losa de Hormigon Armado de H= 0.12m con Fc= 210kg/cm2 incluye vuelo 42.00 M2 175.00 7,350.00
3.630 M.O LIGADO Y VACIADO Losa de Hormigon Armado de H= 0.12m con Fc= 210kg/cm2 incluye vuelo 5.04 M3 850.00 4,284.00
4.000 MAMPOSTERIA -
4.100 Block 15 cms. con acero vertical=Ø 3/8" @ 0.80 m. -
0.010 M.O COLOCACION BLOCKS 1er nivel BNP 288.00 UNDS 10.00 2,880.00
4.010 M.O COLOCACION BLOCKS 1er nivel SNP 940.00 UNDS 10.00 9,400.00
4.110 M.O COLOCACION BLOCKS Antepecho 73.00 UNDS 10.00 730.00
4.200 Block 10 cms. con acero vertical=Ø 3/8" @ 0.80 m. -
4.210 M.O COLOCACION BLOCK SBNP 5.20 UNDS 10.00 52.00
4.220 M.O COLOCACION BLOCKS 1er nivel SNP 59.80 UNDS 10.00 598.00
-
5.000 TERMINACIÓN DE SUPERFICIES -
5.100 Fraguache de superficies hormigones -
5.110 M.O FRAGUECHE 1er nivel exterior 65.86 M² 10.00 658.60
5.120 M.O FRAGUACHE 1er nivel interior 126.90 M² 10.00 1,269.00
5.130 M.O FRAGUACHE Techo 42.00 M² 10.00 420.00
5.140 M.O FRAGUACHE Antepecho 11.20 M² 10.00 112.00
5.200 Pañete liso en muros de bloques en General -
5.210 M.O PAÑETE 1er nivel exterior 65.86 M² 90.00 5,927.40
5.220 M.O PAÑETE 1er nivel interior 126.90 M² 80.00 10,152.00
5.230 M.O PAÑETE En techo 42.00 M² 85.00 3,570.00
5.240 M.O PAÑETE Antepecho 11.20 M² 90.00 1,008.00
5.250 M.O CONFECCION Mocheta en general en puertas y ventanas y muros 41.60 ML 40.00 1,664.00
5.260 M.O CONFECCION Cantos en general, incluye vuelo perímetral 83.20 ML 20.00 1,664.00
-
6.000 TERMINACION DE TECHOS -
6.010 M.O CONFECCION Fino de techo en losas planas 40.00 M² 100.00 4,000.00
6.020 M.O CONFECCION Zabaletas en general en losas 28.00 ML 40.00 1,120.00
6.030 M.O Impermebilizante acrilico dos manos lanco 40.00 M² 50.00 2,000.00
-
7.000 TERMINACION DE PISOS -
7.010 M.O COLOCACION 1er nivel porcelanato 40.00 M² 200.00 8,000.00
7.020 M.O COLOCACION Zocalos en porcelanato 45.80 ml 50.00 2,290.00
7.030 M.O COLOCACION Pisos baños primer nivel 2.00 M² 150.00 300.00
-
8.000 REVESTIMIENTO CERAMICA EN PAREDES COCINA Y BAÑOS -
8.100 BAÑOS -

8.110 M.O COLOCACION 1er nivel 15.00 M² 150.00 2,250.00
8.200 COCINA -
8.210 M.O COLOCACION 1er nivel 1.08 M² 150.00 162.00
-
9.000 INSTALACION SANITARIA DOS NIVELES -
9.010 M.O instalacion de inodoros 1.00 uds 500.00 500.00
9.020 M.O instalacion de ducha de plato en esquina 1.00 uds 500.00 500.00
9.030 M.O instalacion de Lavamanos 1.00 uds 350.00 350.00
9.040 M.O instalacion de Fragadero sencillo 1.00 uds 500.00 500.00
9.050 M.O instalacion de Duchas mezcladora en Fragadero 1.00 uds 350.00 350.00
9.060 M.O instalacion de Duchas mezcladora en cabina 1.00 uds 350.00 350.00
9.070 M.O instalacion de tubeerias de arrastre de 2" interior desague de fondo 1.00 pa 750.00 750.00
9.080 M.O instalacion de tubeerias de arrastre de 4" exterior descarga baños 1.00 pa 500.00 500.00
9.090 M.O Construcion de registro sanitario 2.00 uds 800.00 1,600.00
9.100 M.O Construcion de registro trampa de grasa 1.00 uds 800.00 800.00
-
10.000 COCINA -
10.010 Gabinetes de piso 6.56 PL 1,200.00 7,872.00
10.020 Gabinetes de pared 6.56 PL 1,200.00 7,872.00
10.030 Topes de cocina en granito 6.45 P2 480.00 3,098.30
-
11.000 INSTALACION ELECTRICA EN GENERAL -
11.010 M.O INSTALACION Panel de distribucion de 4 circuitos a 8 circuitos 1.00 ud 500.00 500.00
11.020 M.O INSTALACION toma corriente 110v 8.00 uds 250.00 2,000.00
11.030 M.O INSTALACION toma corriente 220v 2.00 uds 250.00 500.00
11.040 M.O INSTALACION Insterruptores sencillo 5.00 uds 250.00 1,250.00
11.050 M.O INSTALACION Luces cenitales 5.00 uds 250.00 1,250.00
11.060 M.O INSTALACION salida de cable tv 3.00 uds 250.00 750.00
11.070 M.O INSTALACION salida de telefono 2.00 uds 250.00 500.00
11.080 M.O conexion exterior desde poste hasta casa 1.00 pa 2,000.00 2,000.00
-
12.000 PORTAJE -
13.100 1er nivel -
13.110 Puerta principal en madera completa 1.00 uds 8,500.00 8,500.00
13.120 Puerta salida patio exerior 1.00 uds 5,500.00 5,500.00
13.130 Puertas en baños 1.00 uds 5,500.00 5,500.00
13.140 Puerta entrada habitaciones 3.00 uds 5,500.00 16,500.00
-
13.000 VENTANAS -
14.100 1er nivel -
14.110 V1 ( 1.20*1.10)m 7 unidades iguales 85.20 p2 170.00 14,484.57
14.120 V2 ( 0.60*0,60)m en baño ´´celosias´´ 17.43 p2 170.00 2,962.75
-
14.000 PINTURA -
15.100 1er nivel 2do nivel -
15.110 Pintura acrilica interior exterior 245.96 M² 30.00 7,378.80
-

15.000 MICELANEOS -
15.010 Jardineria en patio 1.00 pa 5,000.00 5,000.00
15.020 Acera de hormigon simple laterales en hormigon frotado 6.80 M² 100.00 680.00
15.030 Piezas de Gramaquin de 20*20 cm entrada puerta principal 15.00 und 50.00 750.00
15.040 Limpieza general continua y final ( incluye bote de escombros ) 1.00 pa 5,000.00 5,000.00
16.000 SUBTOTAL GENERAL COSTOS DIRECTOS
17.000 COSTOS INDIRETOS
16.010 Dirección Técnica y Beneficio 10.00%
-
-
18.000 SUBTOTAL GENERAL GASTOS INDIRECTOS
19.000 COSTO TOTAL DE CONSTRUCCION
Notas:
a) Presupuesto elaborado conforme a planos tipos
b) Presupuesto elaborado con precios y mano de obra vigentes Octubre 2012
c) Los precios podrían variar conforme a los cambios en el mercado.
12 de Octubre 2012
PREPARADO POR
ING: FELIX HERNANDEZ JAVIER
Codia 23110
Tels: 809-657-1404
809-445-1404
SUB-TOTAL
12,760.00RD$
8,104.56RD$

58,623.66RD$

13,660.00RD$
26,445.00RD$
7,120.00RD$
10,590.00RD$
2,412.00RD$
6,200.00RD$
18,842.30RD$
8,750.00RD$
36,000.00RD$
17,447.32RD$
7,378.80RD$
11,430.00RD$
245,763.65RD$
24,576.36
24,576.36RD$
270,340.01RD$

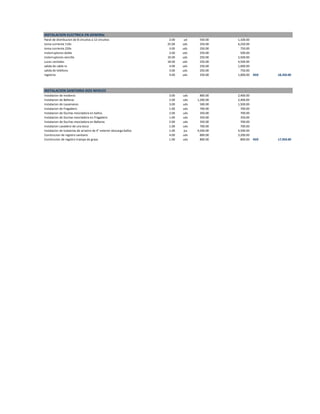

INSTALACION ELECTRICA EN GENERAL -
Panel de distribucion de 8 circuitos a 12 circuitos 2.00 ud 550.00 1,100.00
toma corriente 110v 25.00 uds 250.00 6,250.00
toma corriente 220v 3.00 uds 250.00 750.00
Insterruptores doble 2.00 uds 250.00 500.00
Insterruptores sencillo 10.00 uds 250.00 2,500.00
Luces cenitales 18.00 uds 250.00 4,500.00
salida de cable tv 4.00 uds 250.00 1,000.00
salida de telefono 3.00 uds 250.00 750.00
registros 4.00 uds 250.00 1,000.00 18,350.00RD$
INSTALACION SANITARIA DOS NIVELES -
Instalacion de inodoros 3.00 uds 800.00 2,400.00
Instalacion de Bañeras 2.00 uds 1,200.00 2,400.00
Instalacion de Lavamanos 3.00 uds 500.00 1,500.00
Instalacion de Fragadero 1.00 uds 700.00 700.00
Instalacion de Duchas mezcladora en baños 2.00 uds 350.00 700.00
Instalacion de Duchas mezcladora en Fragadero 1.00 uds 350.00 350.00
Instalacion de Duchas mezcladora en Bañeras 2.00 uds 350.00 700.00
Instalacion Lavadero de una boca 1.00 uds 700.00 700.00
Instalacion de tubeerias de arrastre de 4" exterior descarga baños 1.00 pa 4,500.00 4,500.00
Construcion de registro sanitario 4.00 uds 800.00 3,200.00
Construcion de registro trampa de grasa 1.00 uds 800.00 800.00 17,950.00RD$
No. Costo
1 RD$5,158.40
2 RD$1,920.00
3 RD$7,680.00
4 RD$10,857.47
5 RD$27,212.24
6 RD$80,477.38
7 RD$43,597.76
8 RD$120,968.43
9 RD$5,833.73
10 RD$64,715.10
11 RD$78,137.87
12 RD$6,864.38
13 RD$45,705.47
14 RD$25,517.06
15 RD$39,446.53
16 RD$9,983.36
17 RD$68,808.91
18 RD$60,787.20
19 RD$69,907.75
20 RD$42,880.00
21 RD$22,605.23
22 RD$4,160.00
23 RD$119,937.24
24 RD$37,757.07
25 RD$18,408.33
26 RD$1,920.00
LISTA DE ACTIVIDADES CON COSTO
Actividad
Replanteos casa
Conexiones temporales
Habilitar área almacén materiales
Excavaciones de zapatas muros bloques y columnas
Acero para zapatas de muros y columnas y para columnas de carga
Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas
Colocación de bloques BNP de 0.15 y 0.10 mts
Colocación de bloques SNP de 0.15 y 0.10 mts
Construcion de registro sanitario y registro trampa de grasa
Acero para dintel, losa y vigas
Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas
Colocación de bloques antepecho de 0.15 mts
Fino , zabaletas y impermeabilizante
Pañete exterior y antepecho
Encofrado para dintel, losa y vigas
Fraguache interior, exterior y techo + techo galeria
Suministro e instalacion de accesorios electricos
Suministro e instalacion de accesorios sanitarios
Pintura acrilica interior y exterior
Cocina (gabinetes de piso, pared y topes de cocina en granito)
Limpieza general continua y final
Pañete interior, en techo y mochetas
Portaje
Ventanas
Jardineria en patio
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de

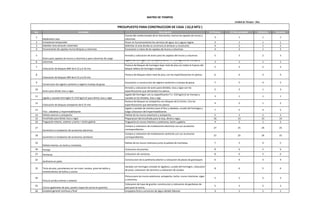

No. Actividad Descripción (t) Pésimo (t) Más probable (t)Optimo Duración
1
Replanteos casa
Consta del confeccionado de la charrancha, marcar las zapatas de muros y
columnas.
3 1 1 1
2 Conexiones temporales Poner en funcionamiento los servicios de agua, luz y aguas negras. 3 1 1 1
3 Habilitar área almacén materiales Delimitar el area donde se construira el almacen y construirlo. 4 2 1 2
4 Excavaciones de zapatas muros bloques y columnas Excavacion a mano de las zapatas de muros y columnas 4 2 1 2
5
Acero para zapatas de muros y columnas y para columnas de carga
Armado y colocacion de acero para las zapatas del muros y columnas. 5 3 2 3
6
Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y
columnas
Ligado del hormigon con su especificacion f´c= 210 kg/cm2 en trompo y
vaciado en las diferentes zapatas de muros y columnas.
3 1 1 1
7
Colocación de bloques BNP de 0.15 y 0.10 mts
Postura de bloques de hormigon bajo nivel de piso con todos lo huecos del
bloque relleno de hormigon simple.
5 3 2 3
8
Colocación de bloques SNP de 0.15 y 0.10 mts
Postura de bloques sobre nivel de piso, con las especificaciones en planos. 6 4 3 4
9
Construcion de registro sanitario y registro trampa de grasa
Excavacion y construccion de registro sanitarios y trampa de grasa. 7 5 4 5
10
Acero para dintel, losa y vigas
Armado y colocacion de acero para dinteles, losa y vigas con las
especificaciones que demandan los planos.
5 3 1 3
11
Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas
Ligado del hormigon con su especificacion f´c= 210 kg/cm2 en trompo y
vaciado en los dinteles, losa y viga.
3 1 1 1
12
Colocación de bloques antepecho de 0.15 mts
Postura de bloques en antepecho con bloques de 0.15mtrs. Con las
especificaciones que demandan los planos.
4 2 1 2
13
Fino , zabaletas y impermeabilizante
Ligado y vaciado de mortero para el fino y sabaleta, curado del hormigos y
luego colocacion del impermeabilizante.
7 5 4 5
14 Pañete exterior y antepecho Pañete de los muros exteriores y antepecho. 5 3 2 3
15 Encofrado para dintel, losa y vigas Preparacion del encofrado para la losa, dintel y vigas. 16 14 13 14

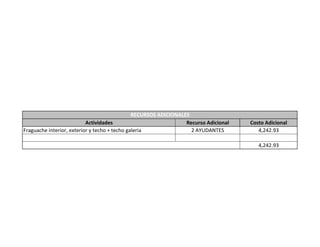

16 Fraguache interior, exterior y techo + techo galeria Fraguache en muros interiore y exteriores, techo y galeria. 4 2 1 2
17
Suministro e instalacion de accesorios electricos
Compra y colocacion de instalaciones electricas con sus accesorios
correspondientes.
27 25 24 25
18
Suministro e instalacion de accesorios sanitarios
Compra y colocacion de instalaciones sanitarias con sus accesorios
correspondientes.
27 25 24 25
19
Pañete interior, en techo y mochetas
Pañete de los muros interiores junto al pañete de mochetas. 7 5 4 5
20 Portaje Colocacion de puertas. 8 6 5 6
21 Ventanas Colocacion de ventanas. 8 6 5 6
22
Jardineria en patio
Construccion de la jardineria exterior y colocacion de piezas de gramaquin. 6 4 3 4
23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y
revestimientos de baños y cocina
Vaciado con hormigon armado en ligadora, curado del hormigon, colocacion
de pisos, colocacion de ceramica y colocacion de zocalos.
8 6 5 6
24
Pintura acrilica interior y exterior
Pintura para los muros exteriores, antepecho, techo, muros interiores, vigas
y columnas.
5 3 2 3
25
Cocina (gabinetes de piso, pared y topes de cocina en granito)
Colocacion de tope de granito, construccion y colocacion de ganitenes de
piso para la cocina.
5 3 2 3
26 Limpieza general continua y final Limppieza final y correccion de algun detalle faltante. 3 1 1 1
MATRIZ DE TIEMPOS
Unidad de Tiempo= Dias
PRESUPUESTO PARA CONSTRUCCION DE CASA ( 62,0 MT2 )
No. Actividad Descripción Antecedentes Secuencias Duración
1
Replanteos casa
Consta del confeccionado de la charrancha, marcar las
zapatas de muros y columnas.
- 5 1
2 Conexiones temporales
Poner en funcionamiento los servicios de agua, luz y aguas
negras.
- 4 1
3 Habilitar área almacén materiales
Delimitar el area donde se construira el almacen y
construirlo.
- - 2
4 Excavaciones de zapatas muros bloques y columnas
Excavacion a mano de las zapatas de muros y columnas 2
-
2
5
Acero para zapatas de muros y columnas y para columnas de carga
Armado y colocacion de acero para las zapatas del muros y
columnas.
1 1 3
6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y
columnas
Ligado del hormigon con su especificacion f´c= 210 kg/cm2
en trompo y vaciado en las diferentes zapatas de muros y
columnas.
5 7 3
7
Colocación de bloques BNP de 0.15 y 0.10 mts
Postura de bloques de hormigon bajo nivel de piso con
todos lo huecos del bloque relleno de hormigon simple.
6 8, 9, 17, 18 3
8
Colocación de bloques SNP de 0.15 y 0.10 mts
Postura de bloques sobre nivel de piso, con las
especificaciones en planos.
8 10, 15 5
9
Construcion de registro sanitario y registro trampa de grasa
Excavacion y construccion de registro sanitarios y trampa
de grasa.
7 - 4
10
Acero para dintel, losa y vigas
Armado y colocacion de acero para dinteles, losa y vigas
con las especificaciones que demandan los planos.
8 11 3
11
Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas
Ligado del hormigon con su especificacion f´c= 210 kg/cm2
en trompo y vaciado en los dinteles, losa y viga.
10 12 1
12
Colocación de bloques antepecho de 0.15 mts
Postura de bloques en antepecho con bloques de 0.15mtrs.
Con las especificaciones que demandan los planos.
11 13 2
13
Fino , zabaletas y impermeabilizante
Ligado y vaciado de mortero para el fino y sabaleta, curado
del hormigos y luego colocacion del impermeabilizante.
12 14 5
14 Pañete exterior y antepecho Pañete de los muros exteriores y antepecho. 13 - 3
15
Encofrado para dintel, losa y vigas
Preparacion del encofrado para la losa, dintel y vigas. 8 16 14
16
Fraguache interior, exterior y techo + techo galeria
Fraguache en muros interiore y exteriores, techo y galeria. 15 19, 20, 21 2
17
Suministro e instalacion de accesorios electricos
Compra y colocacion de instalaciones electricas con sus
accesorios correspondientes.
7 - 25
18
Suministro e instalacion de accesorios sanitarios
Compra y colocacion de instalaciones sanitarias con sus
accesorios correspondientes.
7 22 25
19
Pañete interior, en techo y mochetas
Pañete de los muros interiores junto al pañete de
mochetas.
16 23 5
20 Portaje Colocacion de puertas. 16 - 6
21 Ventanas Colocacion de ventanas. 16 - 6
22 Jardineria en patio Construccion de la jardineria exterior. 18 - 4
23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y
revestimientos de baños y cocina
Vaciado con hormigon armado en ligadora, curado del
hormigon, colocacion de pisos, colocacion de ceramica y
colocacion de zocalos.
19 24, 25 6
24
Pintura acrilica interior y exterior
Pintura para los muros exteriores, antepecho, techo, muros
interiores, vigas y columnas.
23 - 3
25
Cocina (gabinetes de piso, pared y topes de cocina en granito)
Colocacion de tope de granito, construccion y colocacion de
ganitenes de piso para la cocina.
23 26 1
26
Limpieza general continua y final ( incluye bote de escombros )
Limppieza final y correccion de algun detalle faltante. 25 - 1
Simultaneo con actividades 8,
17, 18

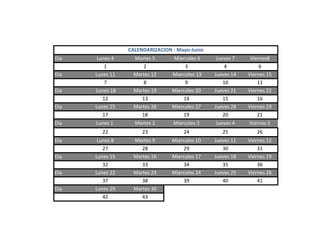

MATRIZ DE INFORMACION
PRESUPUESTO PARA CONSTRUCCION DE CASA ( 62,0 MT2 )
Observaciones
Simultaneo con actividad 2 y
3.
Simultaneo con actividad 1 y
3.
Simultaneo con actividad 1 y
2.
Simultaneo con colocacion de
acerod en zapata y columnas.
-
-
-
Simultaneo con actividades 9,
17, 18
Simultaneo con actividades
Simultaneo con actividades
15, 17, 18
Simultaneo con actividades
15, 17, 18
Simultaneo con actividades
15, 17, 18
Simultaneo con actividades
15, 17, 18
Simultaneo con actividades
Simultaneo con actividades
10, 11, 12, 13, 14, 17, 18
Simultaneo con actividades
17, 18
Simultaneo con actividades 8,
9, 10, 11, 12, 13, 14, 15, 16,
Simultaneo con actividades 8,
9, 10, 11, 12, 13, 14, 15, 16,
Simultaneo con actividades
17, 18, 20, 21, 22
Simultaneo con actividades
Simultaneo con actividades
Simultaneo con actividades
20, 21, 22
Simultaneo con actividades 25
Simultaneo con actididad 24
Actividad final

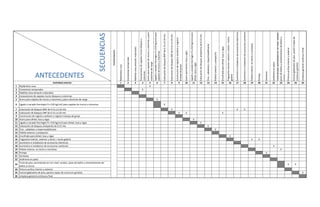

Replanteoscasa
Conexionestemporales
Habilitaráreaalmacénmateriales
Excavacionesdezapatasmurosbloquesy
columnas
Aceroparazapatasdemurosycolumnasypara
columnasdecarga
LigadoyvaciadoHormigónFc=210kg/cm2para
zapatasdemurosycolumnas
ColocacióndebloquesBNPde0.15y0.10mts
ColocacióndebloquesSNPde0.15y0.10mts
Construcionderegistrosanitarioyregistro
trampadegrasa
Aceroparadintel,losayvigas
LigadoyvaciadoHormigónFc=210kg/cm2para
dintel,losayvigas
Colocacióndebloquesantepechode0.15mts
Fino,zabaletasyimpermeabilizante
Pañeteexterioryantepecho
Encofradoparadintel,losayvigas
Fraguacheinterior,exteriorytecho+techo
galeria
Suministroeinstalaciondeaccesorioselectricos
Suministroeinstalaciondeaccesoriossanitarios
Pañeteinterior,entechoymochetas
Portaje
Ventanas
Jardineriaenpatio
Tortadepiso,porcelanatoen1ernivel,zocalos,
pisosdebañosyrevestimientosdebañosy
cocina
Pinturaacrilicainterioryexterior
Cocina(gabinetesdepiso,paredytopesde
cocinaengranito)
Limpiezageneralcontinuayfinal
1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26
1 Replanteos casa X
2 Conexiones temporales X
3 Habilitar área almacén materiales
4 Excavaciones de zapatas muros bloques y columnas
5 Acero para zapatas de muros y columnas y para columnas de carga X
6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas X
7 Colocación de bloques BNP de 0.15 y 0.10 mts X X X X
8 Colocación de bloques SNP de 0.15 y 0.10 mts X X
9 Construcion de registro sanitario y registro trampa de grasa
10 Acero para dintel, losa y vigas X
11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas X
12 Colocación de bloques antepecho de 0.15 mts X
13 Fino , zabaletas y impermeabilizante X
14 Pañete exterior y antepecho
15 Encofrado para dintel, losa y vigas X
16 Fraguache interior, exterior y techo + techo galeria X X X
17 Suministro e instalacion de accesorios electricos
18 Suministro e instalacion de accesorios sanitarios X
19 Pañete interior, en techo y mochetas X
20 Portaje
21 Ventanas
22 Jardineria en patio
23
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de
baños y cocina
X X
24 Pintura acrilica interior y exterior
25 Cocina (gabinetes de piso, pared y topes de cocina en granito) X
26 Limpieza general continua y final
Actividad anterior
Actividadsiguiente
ANTECEDENTES
SECUENCIAS
ANTECEDENTES
SECUENCIAS
No. Actividad t O $N $L m
1 Replanteos casa 1 1 5,158.40 5,158.40 0.00
2 Conexiones temporales 1 1 1,920.00 1,920.00 0.00
3 Habilitar área almacén materiales 2 1 7,680.00 10,944.00 3,264.00
4 Excavaciones de zapatas muros bloques y columnas 2 1 10,857.47 15,471.90 4,614.43
5 Acero para zapatas de muros y columnas y para columnas de carga 3 2 27,212.24 42,632.52 15,420.27
6
Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y
columnas
1 1 80,477.38 80,477.38 0.00
7 Colocación de bloques BNP de 0.15 y 0.10 mts 3 2 43,597.76 68,303.16 24,705.40
8 Colocación de bloques SNP de 0.15 y 0.10 mts 4 3 120,968.43 198,085.80 77,117.37
9 Construcion de registro sanitario y registro trampa de grasa 5 4 5,833.73 9,800.66 3,966.94
10 Acero para dintel, losa y vigas 3 1 64,715.10 101,386.99 18,335.94
11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas 1 1 78,137.87 78,137.87 0.00
12 Colocación de bloques antepecho de 0.15 mts 2 1 6,864.38 9,781.75 2,917.36
13 Fino , zabaletas y impermeabilizante 5 4 45,705.47 76,785.18 31,079.72
14 Pañete exterior y antepecho 3 2 25,517.06 39,976.73 14,459.67
15 Encofrado para dintel, losa y vigas 14 13 39,446.53 70,581.11 31,134.58
16 Fraguache interior, exterior y techo + techo galeria 1 1 9,983.36 9,983.36 0.00
17 Suministro e instalacion de accesorios electricos 25 24 68,808.91 124,956.98 56,148.07
18 Suministro e instalacion de accesorios sanitarios 25 24 60,787.20 110,389.56 49,602.36
19 Pañete interior, en techo y mochetas 5 4 69,907.75 117,445.01 47,537.27
20 Portaje 6 5 42,880.00 73,253.33 30,373.33
21 Ventanas 6 5 22,605.23 38,617.26 16,012.04
22 Jardineria en patio 4 3 4,160.00 6,812.00 2,652.00
23
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y
revestimientos de baños y cocina
6 5 119,937.24 204,892.79 84,955.55
24 Pintura acrilica interior y exterior 3 2 37,757.07 59,152.74 21,395.67
25 Cocina (gabinetes de piso, pared y topes de cocina en granito) 3 2 18,408.33 28,839.71 10,431.38
26 Limpieza general continua y final 1 1 1,920.00 1,920.00 0.00
m= Pendiente m= Costo/tiempo= ($L-$N)/(t-o)
t= Tiempo Estandar Nota:
o= Tiempo Optimo
$N= Costo a tiempo Estándar
$L= Costo a tiempo Optimo
PRESUPUESTO PARA CONSTRUCCION DE CASA ( 62,0 MT2 )
El valor de $L se obtuvo realizando una relación de tres
con los días a tiempo estándar y su costo asociado. Luego
se consideró el 85% del valor: (
0.85*($N * O)/t )
MATRIZ DE PENDIENTES
Costos Directos Proyecto en Tiempo Estandar= RD $ 797,849.15
Costo Operación Proyecto en Tiempo Estándar= RD $ 223,397.76 No. Actividad e
Costo Total de Proyecto (Sin ITBIS)= RD $ 1,021,246.91 1 Replanteos casa 1
2 Conexiones temporales 1
Duración Estándar de Proyecto= 44 días 3 Habilitar área almacén materiales 2
Costo Operación / día= RD $ 5,077.22 4 Excavaciones de zapatas muros bloques y columnas 2
5 Acero para zapatas de muros y columnas y para columnas de carga 3
Actividad Compresiones Operaciones Costo Total Costo Directo Total Costo Operación Costo Total Proyecto 6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1
16 1 día 1*4,242.93 RD $ 4,242.93 44-1= 43.00 RD $ 797,849.15 RD $ 218,320.54 RD $ 1,020,412.62 7 Colocación de bloques BNP de 0.15 y 0.10 mts 3
25 1 día 1*10,431.38 RD $ 10,431.38 43-1= 42 RD $ 1,020,412.62 RD $ 213,243.32 RD $ 1,244,087.32 8 Colocación de bloques SNP de 0.15 y 0.10 mts 4
9 Construcion de registro sanitario y registro trampa de grasa 5
10 Acero para dintel, losa y vigas 3
11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas 1
12 Colocación de bloques antepecho de 0.15 mts 2
13 Fino , zabaletas y impermeabilizante 5
14 Pañete exterior y antepecho 3
15 Encofrado para dintel, losa y vigas 14
16 Fraguache interior, exterior y techo + techo galeria 1
17 Suministro e instalacion de accesorios electricos 25
18 Suministro e instalacion de accesorios sanitarios 25
19 Pañete interior, en techo y mochetas 5
20 Portaje 6
21 Ventanas 6
22 Jardineria en patio 4
23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6
24 Pintura acrilica interior y exterior 3
25 Cocina (gabinetes de piso, pared y topes de cocina en granito) 3
26 Limpieza general continua y final 1
Duración=
Costos Directos Proyecto Comprimido=
Costo Operación Proyecto Comprimido=
Nuevo Costo de Proyecto =
TABLA DE COMPRESIONES SUCESIVAS PROYECTO COMPRIMIDO
ADECUACION DE ZONA PARA PARQUEO EN CENTRO ASISTENCIAL AL AUTOMOVILISTA COSTO OPTIMO Y DURACION DEL PROYECTO
Duración Reducida
Costo
RD $ 5,158.40
RD $ 1,920.00
RD $ 7,680.00
RD $ 10,857.47
RD $ 27,212.24
RD $ 80,477.38
RD $ 43,597.76
RD $ 120,968.43
RD $ 5,833.73
RD $ 64,715.10
RD $ 78,137.87
RD $ 6,864.38
RD $ 45,705.47
RD $ 25,517.06
RD $ 39,446.53
RD $ 4,906.14
RD $ 68,808.91
RD $ 60,787.20
RD $ 69,907.75
RD $ 42,880.00
RD $ 22,605.23
RD $ 4,160.00
RD $ 119,937.24
RD $ 37,757.07
RD $ 18,408.33
RD $ 1,920.00
43
RD $ 802,092.08
RD $ 218,320.54
RD $ 1,020,412.62
PROYECTO COMPRIMIDO
COSTO OPTIMO Y DURACION DEL PROYECTO
No.
Actividad
Descripción
(t)Pésimo
(t)Másprobable
(t)Optimo
Duración
1
Replanteos casa
Consta del confeccionado de la charrancha, marcar las
zapatas de muros y columnas.
3 1 1 1
2 Conexiones temporales
Poner en funcionamiento los servicios de agua, luz y aguas
negras.
3 1 1 1
3 Habilitar área almacén materiales
Delimitar el area donde se construira el almacen y
construirlo.
4 2 1 2
4 Excavaciones de zapatas muros bloques y columnas
Excavacion a mano de las zapatas de muros y columnas 4 2 1 2
5
Acero para zapatas de muros y columnas y para columnas de carga
Armado y colocacion de acero para las zapatas del muros y
columnas.
5 3 2 3
6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas
Ligado del hormigon con su especificacion f´c= 210 kg/cm2
en trompo y vaciado en las diferentes zapatas de muros y
3 1 1 1
7
Colocación de bloques BNP de 0.15 y 0.10 mts
Postura de bloques de hormigon bajo nivel de piso con
todos lo huecos del bloque relleno de hormigon simple.
5 3 2 3
8
Colocación de bloques SNP de 0.15 y 0.10 mts
Postura de bloques sobre nivel de piso, con las
especificaciones en planos.
6 4 3 4
9
Construcion de registro sanitario y registro trampa de grasa
Excavacion y construccion de registro sanitarios y trampa de
grasa.
7 5 4 5
10
Acero para dintel, losa y vigas
Armado y colocacion de acero para dinteles, losa y vigas con
las especificaciones que demandan los planos.
5 3 1 3
11
Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas
Ligado del hormigon con su especificacion f´c= 210 kg/cm2
en trompo y vaciado en los dinteles, losa y viga.
3 1 1 1
12
Colocación de bloques antepecho de 0.15 mts
Postura de bloques en antepecho con bloques de 0.15mtrs.
Con las especificaciones que demandan los planos.
4 2 1 2
13
Fino , zabaletas y impermeabilizante
Ligado y vaciado de mortero para el fino y sabaleta, curado
del hormigos y luego colocacion del impermeabilizante.
7 5 4 5
14 Pañete exterior y antepecho Pañete de los muros exteriores y antepecho. 5 3 2 3
15
Encofrado para dintel, losa y vigas
Preparacion del encofrado para la losa, dintel y vigas. 16 14 13 14
16
Fraguache interior, exterior y techo + techo galeria
Fraguache en muros interiore y exteriores, techo y galeria. 3 1 1 1
17
Suministro e instalacion de accesorios electricos
Compra y colocacion de instalaciones electricas con sus
accesorios correspondientes.
27 25 24 25
18
Suministro e instalacion de accesorios sanitarios
Compra y colocacion de instalaciones sanitarias con sus
accesorios correspondientes.
27 25 24 25
19
Pañete interior, en techo y mochetas
Pañete de los muros interiores junto al pañete de mochetas. 7 5 4 5
20 Portaje Colocacion de puertas. 8 6 5 6
21 Ventanas Colocacion de ventanas. 8 6 5 6
22
Jardineria en patio
Construccion de la jardineria exterior y colocacion de piezas
de gramaquin.
6 4 3 4
23
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y
revestimientos de baños y cocina
Vaciado con hormigon armado en ligadora, curado del
hormigon, colocacion de pisos, colocacion de ceramica y
colocacion de zocalos.
8 6 5 6
24
Pintura acrilica interior y exterior
Pintura para los muros exteriores, antepecho, techo, muros
interiores, vigas y columnas.
5 3 2 3
25
Cocina (gabinetes de piso, pared y topes de cocina en granito)
Colocacion de tope de granito, construccion y colocacion de
ganitenes de piso para la cocina.
5 3 2 3
26
Limpieza general continua y final
Limppieza final y correccion de algun detalle faltante. 3 1 1 1
Duración= ( o + 4*M + p)/6
MATRIZ DE TIEMPOS
Unidad de Tiempo= Dias
PRESUPUESTO PARA CONSTRUCCION DE CASA ( 62,0 MT2 )
No. Actividad Descripción
Antecedentes
Secuencias
Duración
1 Replanteos casa
Consta del confeccionado de la charrancha, marcar las zapatas de muros y
columnas.
- 5 1
2
Conexiones temporales Poner en funcionamiento los servicios de agua, luz y aguas negras. - 4 1
3
Habilitar área almacén materiales Delimitar el area donde se construira el almacen y construirlo. - - 2
4
Excavaciones de zapatas muros bloques y columnas Excavacion a mano de las zapatas de muros y columnas 2
-
2
5 Acero para zapatas de muros y columnas y para columnas de carga Armado y colocacion de acero para las zapatas del muros y columnas. 1 6 3
6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas
Ligado del hormigon con su especificacion f´c= 210 kg/cm2 en trompo y
vaciado en las diferentes zapatas de muros y columnas.
5 7 1
7 Colocación de bloques BNP de 0.15 y 0.10 mts
Postura de bloques de hormigon bajo nivel de piso con todos lo huecos
del bloque relleno de hormigon simple.
6 8, 17, 18. 3
8 Colocación de bloques SNP de 0.15 y 0.10 mts Postura de bloques sobre nivel de piso, con las especificaciones en planos. 7 9, 10, 15. 4
9 Construcion de registro sanitario y registro trampa de grasa Excavacion y construccion de registro sanitarios y trampa de grasa. 8 - 5
10 Acero para dintel, losa y vigas
Armado y colocacion de acero para dinteles, losa y vigas con las
especificaciones que demandan los planos.
8 11 3
11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas
Ligado del hormigon con su especificacion f´c= 210 kg/cm2 en trompo y
vaciado en los dinteles, losa y viga.
10 12 1
12 Colocación de bloques antepecho de 0.15 mts
Postura de bloques en antepecho con bloques de 0.15mtrs. Con las
especificaciones que demandan los planos.
11 13 2
13 Fino , zabaletas y impermeabilizante
Ligado y vaciado de mortero para el fino y sabaleta, curado del hormigos y
luego colocacion del impermeabilizante.
12 14 5
14 Pañete exterior y antepecho Pañete de los muros exteriores y antepecho. 13 - 3
15 Encofrado para dintel, losa y vigas Preparacion del encofrado para la losa, dintel y vigas. 8 16 14
16 Fraguache interior, exterior y techo + techo galeria Fraguache en muros interiore y exteriores, techo y galeria. 15 19, 20. 2
17 Suministro e instalacion de accesorios electricos
Compra y colocacion de instalaciones electricas con sus accesorios
correspondientes.
7 - 25
18 Suministro e instalacion de accesorios sanitarios
Compra y colocacion de instalaciones sanitarias con sus accesorios
correspondientes.
7 22 25
19 Pañete interior, en techo y mochetas Pañete de los muros interiores junto al pañete de mochetas. 16 23 5
20 Portaje Colocacion de puertas. 16 21 6
21 Ventanas Colocacion de ventanas. 20
-
6
22 Jardineria en patio
Construccion de la jardineria exterior y colocacion de piezas de
gramaquin.
18
-
4
23
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños
y cocina
Vaciado con hormigon armado en ligadora, curado del hormigon,
colocacion de pisos, colocacion de ceramica y colocacion de zocalos.
19 24, 25. 6
24 Pintura acrilica interior y exterior
Pintura para los muros exteriores, antepecho, techo, muros interiores,
vigas y columnas.
23 - 3
25 Cocina (gabinetes de piso, pared y topes de cocina en granito)
Colocacion de tope de granito, construccion y colocacion de ganitenes de
piso para la cocina.
23
26
3
26 Limpieza general continua y final ( incluye bote de escombros ) Limppieza final y correccion de algun detalle faltante. 25 - 1
MATRIZ DE INFORMACION
Simultanea con las actividades 9, 15, 17, 18.
Simultanea con las actividades 15, 17, 18.
Simultanea con las actividades 15, 17, 18.
PRESUPUESTO PARA CONSTRUCCION DE CASA ( 62,0 MT2 )
Observaciones
Simultanea con las actividades 2 y 3.
Simultanea con las actividades 1 y 3.
Simultanea con las actividades 8, 9, 10, 11, 12, 14, 17, 20.
Simultanea con las actividades 17, 18, 19.
Simultanea con las actividades 22, 23.
Simultanea con las actividades 21, 22.
Simultanea con las actividades 1 y 2.
Simultanea con las actividades 17 y 18.
-
Simultanea con las actividad 5.
Simultanea con la actividad 4.
-
Simultanea con las actividades 10 y 15.
Simultanea con las actividades 15, 17, 18.
Simultanea con las actividades 9, 10, 11, 12, 14, 17, 18.
Simultanea con las actividades 17 y 18.
Simultanea con las actividades 8, 9, 10, 11, 12, 14, 18, 20.
Simultanea con las actividades 9, 15, 17, 18.
Simultanea con las actividades 21, 23.
Simultanea con las actividade 25.
Simultanea con la actividad 24.
-
Simultanea con las actividades 17, 18, 20.
Replanteoscasa
Conexionestemporales
Habilitaráreaalmacénmateriales
Excavacionesdezapatasmurosbloquesy
columnas
Aceroparazapatasdemurosycolumnasypara
columnasdecarga
LigadoyvaciadoHormigónFc=210kg/cm2para
zapatasdemurosycolumnas
ColocacióndebloquesBNPde0.15y0.10mts
ColocacióndebloquesSNPde0.15y0.10mts
Construcionderegistrosanitarioyregistro
trampadegrasa
Aceroparadintel,losayvigas
LigadoyvaciadoHormigónFc=210kg/cm2para
dintel,losayvigas
Colocacióndebloquesantepechode0.15mts
Fino,zabaletasyimpermeabilizante
Pañeteexterioryantepecho
Encofradoparadintel,losayvigas
Fraguacheinterior,exteriorytecho+techo
galeria
Suministroeinstalaciondeaccesorioselectricos
Suministroeinstalaciondeaccesoriossanitarios
Pañeteinterior,entechoymochetas
Portaje
Ventanas
Jardineriaenpatio
Tortadepiso,porcelanatoen1ernivel,zocalos,
pisosdebañosyrevestimientosdebañosy
cocina
Pinturaacrilicainterioryexterior
Cocina(gabinetesdepiso,paredytopesde
cocinaengranito)
Limpiezageneralcontinuayfinal
1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26
1 Replanteos casa X
2 Conexiones temporales X
3 Habilitar área almacén materiales
4 Excavaciones de zapatas muros bloques y columnas
5 Acero para zapatas de muros y columnas y para columnas de carga X
6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas X
7 Colocación de bloques BNP de 0.15 y 0.10 mts X X X
8 Colocación de bloques SNP de 0.15 y 0.10 mts X X X
9 Construcion de registro sanitario y registro trampa de grasa
10 Acero para dintel, losa y vigas X
11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas X
12 Colocación de bloques antepecho de 0.15 mts X
13 Fino , zabaletas y impermeabilizante X
14 Pañete exterior y antepecho
15 Encofrado para dintel, losa y vigas X
16 Fraguache interior, exterior y techo + techo galeria X X
17 Suministro e instalacion de accesorios electricos
18 Suministro e instalacion de accesorios sanitarios X
19 Pañete interior, en techo y mochetas X
20 Portaje X
21 Ventanas
22 Jardineria en patio
23
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de
baños y cocina
X X
24 Pintura acrilica interior y exterior
25 Cocina (gabinetes de piso, pared y topes de cocina en granito) X
26 Limpieza general continua y final
Actividadsiguiente
Actividad anterior
ANTECEDENTES
SECUENCIAS
ANTECEDENTES
SECUENCIAS
No. Actividad t O $N $L m
1 Replanteos casa 1 1 5,158.40 5,158.40 0.00
2 Conexiones temporales 1 1 1,920.00 1,920.00 0.00
3 Habilitar área almacén materiales 2 1 7,680.00 10,944.00 3,264.00
4 Excavaciones de zapatas muros bloques y columnas 2 1 10,857.47 15,471.90 4,614.43
5 Acero para zapatas de muros y columnas y para columnas de carga 3 2 27,212.24 42,632.52 15,420.27
6
Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y
columnas
1 1 80,477.38 80,477.38 0.00
7 Colocación de bloques BNP de 0.15 y 0.10 mts 3 2 43,597.76 68,303.16 24,705.40
8 Colocación de bloques SNP de 0.15 y 0.10 mts 4 3 120,968.43 198,085.80 77,117.37
9 Construcion de registro sanitario y registro trampa de grasa 5 4 5,833.73 9,800.66 3,966.94
10 Acero para dintel, losa y vigas 3 1 64,715.10 101,386.99 18,335.94
11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas 1 1 78,137.87 78,137.87 0.00
12 Colocación de bloques antepecho de 0.15 mts 2 1 6,864.38 9,781.75 2,917.36
13 Fino , zabaletas y impermeabilizante 5 4 45,705.47 76,785.18 31,079.72
14 Pañete exterior y antepecho 3 2 25,517.06 39,976.73 14,459.67
15 Encofrado para dintel, losa y vigas 14 13 39,446.53 70,581.11 31,134.58
16 Fraguache interior, exterior y techo + techo galeria 1 1 14,226.29 14,226.29 0.00
17 Suministro e instalacion de accesorios electricos 25 24 68,808.91 124,956.98 56,148.07
18 Suministro e instalacion de accesorios sanitarios 25 24 60,787.20 110,389.56 49,602.36
19 Pañete interior, en techo y mochetas 5 4 69,907.75 117,445.01 47,537.27
20 Portaje 6 5 42,880.00 73,253.33 30,373.33
21 Ventanas 6 5 22,605.23 38,617.26 16,012.04
22 Jardineria en patio 4 3 4,160.00 6,812.00 2,652.00
23
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y
revestimientos de baños y cocina
6 5 119,937.24 204,892.79 84,955.55
24 Pintura acrilica interior y exterior 3 2 37,757.07 59,152.74 21,395.67
25 Cocina (gabinetes de piso, pared y topes de cocina en granito) 3 2 18,408.33 28,839.71 10,431.38
26 Limpieza general continua y final 1 1 1,920.00 1,920.00 0.00
m= Pendiente m= Costo/tiempo= ($L-$N)/(t-o)
t= Tiempo Estandar Nota:
o= Tiempo Optimo
$N= Costo a tiempo Estándar
$L= Costo a tiempo Optimo
El valor de $L se obtuvo realizando una relación de tres con
los días a tiempo estándar y su costo asociado. Luego se
consideró el 85% del valor: ( 0.85*($N *
O)/t )
MATRIZ DE PENDIENTES CON LIMITACIONES
PRESUPUESTO PARA CONSTRUCCION DE CASA ( 62,0 MT2 )
1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21
HT HL HI Compresion
No. Actividad Secuencia o M p e $N $L m TR1 IP1 TR2 IP2 dias % CI D D D % σ
1 Replanteos casa 1 1 3 1 5,158.40 5,158.40 0.00 0 0 1 1 0 0.00 C 0 0 0 0.25 0.33
2 Conexiones temporales 1 1 3 1 1,920.00 1,920.00 0.00 0 0 1 2 0 0.00 0 0 0 0.25 0.33
3 Habilitar área almacén materiales 1 2 4 2 7,680.00 10,944.00 3,264.00 0 0 4 4 2 0.00 2 2 1 0.54 0.50
4 Excavaciones de zapatas muros bloques y columnas 1 2 4 2 10,857.47 15,471.90 4,614.43 2 1 4 4 1 0.00 0 1 1 0.54 0.50
5 Acero para zapatas de muros y columnas y para columnas de carga 2 3 5 3 27,212.24 42,632.52 15,420.27 1 1 4 4 0 0.00 C 0 0 1 0.37 0.50
6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1 1 3 1 80,477.38 80,477.38 0.00 4 4 5 5 0 0.00 C 0 0 0 0.25 0.33
7 Colocación de bloques BNP de 0.15 y 0.10 mts 2 3 5 3 43,597.76 68,303.16 24,705.40 5 5 8 8 0 0.00 C 0 0 1 0.37 0.50
8 Colocación de bloques SNP de 0.15 y 0.10 mts 3 4 6 4 120,968.43 198,085.80 77,117.37 8 8 13 13 1 0.20 C 1 1 1 0.28 0.50
9 Construcion de registro sanitario y registro trampa de grasa 4 5 7 5 5,833.73 9,800.66 3,966.94 13 13 25 17 7 1.32 7 7 1 0.23 0.50
10 Acero para dintel, losa y vigas 1 3 5 3 64,715.10 101,386.99 18,335.94 13 13 16 22 0 0.00 0 0 2 0.67 0.67
11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas 1 1 3 1 78,137.87 78,137.87 0.00 22 16 17 23 0 0.00 6 0 0 0.25 0.33
12 Colocación de bloques antepecho de 0.15 mts 1 2 4 2 6,864.38 9,781.75 2,917.36 23 16 19 25 6 0.00 6 1 1 0.54 0.50
13 Fino , zabaletas y impermeabilizante 4 5 7 5 45,705.47 76,785.18 31,079.72 25 19 27 33 3 0.00 3 3 1 0.23 0.50
14 Pañete exterior y antepecho 2 3 5 3 25,517.06 39,976.73 14,459.67 30 24 33 33 6 0.00 0 6 1 0.37 0.50
15 Encofrado para dintel, losa y vigas 13 14 16 14 39,446.53 70,581.11 31,134.58 13 13 27 27 0 0.00 C 0 0 1 0.08 0.50
16 Fraguache interior, exterior y techo + techo galeria 1 1 3 1 9,983.36 9,983.36 0.00 27 27 28 28 0 0.00 C 0 0 0 0.00 0.33
17 Suministro e instalacion de accesorios electricos 24 25 27 25 68,808.91 124,956.98 56,148.07 8 8 43 43 10 0.39 10 10 1 0.05 0.50
18 Suministro e instalacion de accesorios sanitarios 24 25 27 25 60,787.20 110,389.56 49,602.36 8 8 33 39 0 0.00 0 0 1 0.05 0.50
19 Pañete interior, en techo y mochetas 4 5 7 5 69,907.75 117,445.01 47,537.27 28 28 33 33 0 0.00 C 0 0 1 0.23 0.50
20 Portaje 5 6 8 6 42,880.00 73,253.33 30,373.33 28 28 39 39 5 0.78 5 5 1 0.19 0.50
21 Ventanas 5 6 8 6 22,605.23 38,617.26 16,012.04 39 34 42 42 3 0.49 2 2 1 0.19 0.50
22 Jardineria en patio 3 4 6 4 4,160.00 6,812.00 2,652.00 39 33 43 43 6 0.00 0 6 1 0.28 0.50
23
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de
baños y cocina
5
6 8 6 119,937.24 204,892.79 84,955.55 33 33 39 39 0 0.00
C
0 0 1 0.19 0.50
24 Pintura acrilica interior y exterior 2 3 5 3 37,757.07 59,152.74 21,395.67 39 39 43 43 1 0.26 1 1 1 0.37 0.50
25 Cocina (gabinetes de piso, pared y topes de cocina en granito) 2 3 5 3 18,408.33 28,839.71 10,431.38 39 39 42 42 0 0.00 C 0 0 1 0.37 0.50
26 Limpieza general continua y final 1 1 3 1 1,920.00 1,920.00 0.00 42 42 43 43 0 0.00 C 0 0 0 0.25 0.33
Tiempos Costos Lecturas
Desviación Ruta
No. Actividad σ t Σt t + σ Σ(t + σ)
1 Replanteos casa 0.33 1 1 1.33 1.33
5 Acero para zapatas de muros y columnas y para columnas de carga 0.50 3 4 3.50 4.83
6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 0.33 1 5 1.33 6.16
7 Colocación de bloques BNP de 0.15 y 0.10 mts 0.50 3 8 3.50 9.66
8 Colocación de bloques SNP de 0.15 y 0.10 mts 0.50 4 12 4.50 14.16
15 Encofrado para dintel, losa y vigas 0.50 14 26 14.50 28.66
16 Fraguache interior, exterior y techo + techo galeria 0.50 1 27 1.50 30.16
19 Pañete interior, en techo y mochetas 0.50 5 32 5.50 35.66
23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.50 6 38 6.50 42.16
25 Cocina (gabinetes de piso, pared y topes de cocina en granito) 0.50 3 41 3.50 45.66
26 Limpieza general continua y final 0.33 1 42 1.33 46.99
Σ 5.00
El proyecto se va a ejecutar entre: 44 + 4.99 = 50 días
Σt= Tiempo Programado
Σ(t + σ)= Tiempo Tolerado
0.10 0.9204 1.10 0.2714 2.10 0.0358
0.20 0.8414 1.20 0.2302 2.20 0.0278
0.30 0.7642 1.30 0.1936 2.30 0.0214
0.40 0.6892 1.40 0.1616 2.40 0.0164
0.50 0.6170 1.50 0.1336 2.50 0.0124
0.60 0.5486 1.60 0.1096 2.60 0.0094
0.70 0.4840 1.70 0.0892 2.70 0.0070
0.80 0.4238 1.80 0.0718 2.80 0.0052
0.90 0.3682 1.90 0.0574 2.90 0.0038
1.00 0.3174 2.00 0.0456 3.00 0.0026
6 dias
Probabilidad de que se atrase 1 dia¨?
0.2
x1 0.1 0.8414 y1
x 0.20 0.9204
x2 0.2 0.9204 y2
92%
Probabilidad de que se atrase 3 dias?
0.6
x1 0.5 0.617 y1
x 0.60 0.5486
x2 0.6 0.5486 y2
55%
σ
Probabilidad de
Retraso
Retraso Previsto en el Camino Crítico
DIAS TOLERADOS
Desviación
σ Probabilidad de Retraso σ
Probabilid
ad de
Retraso
Dia Actividades por dia Actividades Acumuladas Avance Programado por Dia Dia Actividades por dia Actividades Acumuladas Avance Programado por Dia
1 3 3 0.022 25 4 80 0.593
2 3 6 0.044 26 4 84 0.622
3 2 8 0.059 27 4 88 0.652
4 1 9 0.067 28 3 91 0.674
5 1 10 0.074 29 4 95 0.704
6 1 11 0.081 30 4 99 0.733
7 1 12 0.089 31 4 103 0.763
8 1 13 0.096 32 4 107 0.793
9 3 16 0.119 33 4 111 0.822
10 3 19 0.141 34 3 114 0.844
11 3 22 0.163 35 3 117 0.867
12 3 25 0.185 36 3 120 0.889
13 3 28 0.207 37 3 123 0.911
14 5 33 0.244 38 2 125 0.926
15 5 38 0.281 39 2 127 0.941
16 5 43 0.319 40 3 130 0.963
17 5 48 0.356 41 2 132 0.978
18 4 52 0.385 42 2 134 0.993
19 4 56 0.415 43 1 135 1.000
20 4 60 0.444
21 4 64 0.474 1
22 4 68 0.504 ∑ Act. Acum.
23 4 72 0.533
24 4 76 0.563
fa = 0.00741
CALCULO DE AVANCE PROGRAMADO
1 2 3 4 5 6 7 8 9 10 11 12 13
Dia
a(Actividades)
e(DiasProgramados)
1/e
DiasTranscurridos
(Programados)
Porcentaje
Programados
PorcentajeReal
fa(FactorAvance)
Avancedea
Porcentaje
acumulado
AvancedelProyecto
AvanceProgramado
E(p)
1 Replanteos casa 1 1.00 1.00 1.00 1.00 0.0074 0.0074 T
Conexiones temporales 1 1.00 1.00 1.00 1.00 0.0074 0.0074 T
Habilitar área almacén materiales 2 0.50 1.00 0.50 0.50 0.0148 0.0074 0.0222 0.0222 1.000
2 T 0.0148
Habilitar área almacén materiales 2 0.50 2.00 1.00 1.00 0.0148 0.0148 T
Excavaciones de zapatas muros bloques y columnas 2 0.50 1.00 0.50 0.50 0.0148 0.0074
Acero para zapatas de muros y columnas y para columnas de carga 3 0.33 1.00 0.33 0.33 0.0222 0.0073 0.0444 0.0444 0.998
3 T 0.0296
Excavaciones de zapatas muros bloques y columnas 2 0.50 2.00 1.00 1.00 0.0148 0.0148 T
Acero para zapatas de muros y columnas y para columnas de carga 3 0.33 2.00 0.66 0.66 0.0222 0.0147 0.0591 0.0593 0.998
4 T 0.0444
Acero para zapatas de muros y columnas y para columnas de carga 3 0.33 3.00 1.00 1.00 0.0222 0.0222 T 0.0667 0.0667 1.000
5 T 0.0667
Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1 1.00 1.00 1.00 1.00 0.0074 0.0074 T 0.0741 0.0741 1.000
6 T 0.0741
Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 1.00 0.33 0.00 0.0222 0.0000 0.0741 0.0815 0.909
7 T 0.0741
Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 2.00 0.66 0.50 0.0222 0.0111 0.0852 0.0889 0.958
8 T 0.0741
Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 3.00 1.00 1.00 0.0222 0.0222 T 0.0963 0.0963 1.000
9 T 0.0963
Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 1.00 0.20 0.00 0.0370 0.0000
Suministro e instalacion de accesorios electricos 25 0.04 1.00 0.04 0.00 0.1852 0.0000
Suministro e instalacion de accesorios sanitarios 25 0.04 1.00 0.04 0.00 0.1852 0.0000 0.0963 0.1185 0.813
10 T 0.0963
Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 2.00 0.40 0.00 0.0370 0.0000
Suministro e instalacion de accesorios electricos 25 0.04 2.00 0.08 0.00 0.1852 0.0000
Suministro e instalacion de accesorios sanitarios 25 0.04 2.00 0.08 0.00 0.1852 0.0000 0.0963 0.1407 0.684
11 T 0.0963
Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 3.00 0.60 0.50 0.0370 0.0185
Suministro e instalacion de accesorios electricos 25 0.04 3.00 0.12 0.12 0.1852 0.0222
Suministro e instalacion de accesorios sanitarios 25 0.04 3.00 0.12 0.12 0.1852 0.0222 0.1593 0.1630 0.977
12 T 0.0963
Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 4.00 0.80 0.00 0.0370 0.0000
Suministro e instalacion de accesorios electricos 25 0.04 4.00 0.16 0.16 0.1852 0.0296
Suministro e instalacion de accesorios sanitarios 25 0.04 4.00 0.16 0.16 0.1852 0.0296 0.1556 0.1852 0.840
13 T 0.0963
Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 5.00 1.00 1.00 0.0370 0.0370 T
Suministro e instalacion de accesorios electricos 25 0.04 5.00 0.20 0.20 0.1852 0.0370
Suministro e instalacion de accesorios sanitarios 25 0.04 5.00 0.20 0.20 0.1852 0.0370 0.2074 0.2074 1.000
14 T 0.1333
Suministro e instalacion de accesorios electricos 25 0.04 6.00 0.24 0.24 0.1852 0.0444
Suministro e instalacion de accesorios sanitarios 25 0.04 6.00 0.24 0.24 0.1852 0.0444
Acero para dintel, losa y vigas 3 0.33 1.00 0.33 0.33 0.0222 0.0073
Construcion de registro sanitario y registro trampa de grasa 4 0.25 1.00 0.25 0.00 0.0296 0.0000
Encofrado para dintel, losa y vigas 14 0.07 1.00 0.07 0.07 0.1037 0.0073 0.2368 0.2444 0.969
15 T 0.1333
Suministro e instalacion de accesorios electricos 25 0.04 7.00 0.28 0.28 0.1852 0.0519
Suministro e instalacion de accesorios sanitarios 25 0.04 7.00 0.28 0.28 0.1852 0.0519
Acero para dintel, losa y vigas 3 0.33 2.00 0.66 0.66 0.0222 0.0147
Construcion de registro sanitario y registro trampa de grasa 4 0.25 2.00 0.50 0.30 0.0296 0.0089
Encofrado para dintel, losa y vigas 14 0.07 2.00 0.14 0.14 0.1037 0.0145 0.2751 0.2815 0.977
16 T 0.1333
Suministro e instalacion de accesorios electricos 25 0.04 8.00 0.32 0.32 0.1852 0.0593
Suministro e instalacion de accesorios sanitarios 25 0.04 8.00 0.32 0.32 0.1852 0.0593
Acero para dintel, losa y vigas 3 0.33 3.00 1.00 1.00 0.0222 0.0222 T
Construcion de registro sanitario y registro trampa de grasa 4 0.25 3.00 0.75 0.70 0.0296 0.0207
Encofrado para dintel, losa y vigas 14 0.07 3.00 0.21 0.21 0.1037 0.0218 0.3166 0.3185 0.994
17 T 0.1556
Suministro e instalacion de accesorios electricos 25 0.04 9.00 0.36 0.36 0.1852 0.0667
Suministro e instalacion de accesorios sanitarios 25 0.04 9.00 0.36 0.36 0.1852 0.0667
Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas 1 1.00 1.00 1.00 1.00 0.0074 0.0074 T
Construcion de registro sanitario y registro trampa de grasa 4 0.25 4.00 1.00 1.00 0.0296 0.0296 T
Encofrado para dintel, losa y vigas 14 0.07 4.00 0.28 0.28 0.1037 0.0290 0.3550 0.3556 0.998
18 T 0.1926
Suministro e instalacion de accesorios electricos 25 0.04 10.00 0.40 0.40 0.1852 0.0741
Suministro e instalacion de accesorios sanitarios 25 0.04 10.00 0.40 0.40 0.1852 0.0741
Colocación de bloques antepecho de 0.15 mts 2 0.50 1.00 0.50 0.50 0.0148 0.0074
Encofrado para dintel, losa y vigas 14 0.07 5.00 0.35 0.35 0.1037 0.0363 0.3844 0.3852 0.998
19 T 0.1926
Suministro e instalacion de accesorios electricos 25 0.04 11.00 0.44 0.44 0.1852 0.0815
Suministro e instalacion de accesorios sanitarios 25 0.04 11.00 0.44 0.44 0.1852 0.0815
Colocación de bloques antepecho de 0.15 mts 2 0.50 2.00 1.00 1.00 0.0148 0.0148 T
Encofrado para dintel, losa y vigas 14 0.07 6.00 0.42 0.42 0.1037 0.0436 0.4139 0.4148 0.998
20 T 0.2074
Suministro e instalacion de accesorios electricos 25 0.04 12.00 0.48 0.48 0.1852 0.0889
Suministro e instalacion de accesorios sanitarios 25 0.04 12.00 0.48 0.48 0.1852 0.0889
Encofrado para dintel, losa y vigas 14 0.07 7.00 0.49 0.49 0.1037 0.0508
Fino , zabaletas y impermeabilizante 5 0.20 1.00 0.20 0.20 0.0370 0.0074 0.4434 0.4444 0.998
21 T 0.2074
Suministro e instalacion de accesorios electricos 25 0.04 13.00 0.52 0.52 0.1852 0.0963
Suministro e instalacion de accesorios sanitarios 25 0.04 13.00 0.52 0.52 0.1852 0.0963
Encofrado para dintel, losa y vigas 14 0.07 8.00 0.56 0.56 0.1037 0.0581
Fino , zabaletas y impermeabilizante 5 0.20 2.00 0.40 0.40 0.0370 0.0148 0.4729 0.4741 0.998
22 T 0.2074
Suministro e instalacion de accesorios electricos 25 0.04 14.00 0.56 0.56 0.1852 0.1037
Suministro e instalacion de accesorios sanitarios 25 0.04 14.00 0.56 0.56 0.1852 0.1037
Encofrado para dintel, losa y vigas 14 0.07 9.00 0.63 0.63 0.1037 0.0653
Fino , zabaletas y impermeabilizante 5 0.20 3.00 0.60 0.60 0.0370 0.0222 0.5024 0.5037 0.997
23 T 0.2074
Suministro e instalacion de accesorios electricos 25 0.04 15.00 0.60 0.60 0.1852 0.1111
Suministro e instalacion de accesorios sanitarios 25 0.04 15.00 0.60 0.60 0.1852 0.1111
Encofrado para dintel, losa y vigas 14 0.07 10.00 0.70 0.70 0.1037 0.0726
Fino , zabaletas y impermeabilizante 5 0.20 4.00 0.80 0.80 0.0370 0.0296 0.5319 0.5333 0.997
24 T 0.2074
Suministro e instalacion de accesorios electricos 25 0.04 16.00 0.64 0.64 0.1852 0.1185
Suministro e instalacion de accesorios sanitarios 25 0.04 16.00 0.64 0.64 0.1852 0.1185
Encofrado para dintel, losa y vigas 14 0.07 11.00 0.77 0.77 0.1037 0.0799
Fino , zabaletas y impermeabilizante 5 0.20 5.00 1.00 1.00 0.0370 0.0370 T 0.5613 0.5630 0.997
25 T 0.2444
Suministro e instalacion de accesorios electricos 25 0.04 17.00 0.68 0.68 0.1852 0.1259
Suministro e instalacion de accesorios sanitarios 25 0.04 17.00 0.68 0.68 0.1852 0.1259
Encofrado para dintel, losa y vigas 14 0.07 12.00 0.84 0.84 0.1037 0.0871
Pañete exterior y antepecho 3 0.33 1.00 0.33 0.20 0.0222 0.0044 0.5879 0.5926 0.992
26 T 0.2444
Suministro e instalacion de accesorios electricos 25 0.04 18.00 0.72 0.72 0.1852 0.1333
Suministro e instalacion de accesorios sanitarios 25 0.04 18.00 0.72 0.72 0.1852 0.1333
Encofrado para dintel, losa y vigas 14 0.07 13.00 0.91 0.91 0.1037 0.0944
Pañete exterior y antepecho 3 0.33 2.00 0.66 0.80 0.0222 0.0178 0.6233 0.6222 1.002
27 T 0.2444
Suministro e instalacion de accesorios electricos 25 0.04 19.00 0.76 0.76 0.1852 0.1407
Suministro e instalacion de accesorios sanitarios 25 0.04 19.00 0.76 0.76 0.1852 0.1407
Encofrado para dintel, losa y vigas 14 0.07 14.00 1.00 1.00 0.1037 0.1037 T
Pañete exterior y antepecho 3 0.33 3.00 1.00 1.00 0.0222 0.0222 T 0.6519 0.6519 1.000
28 T 0.3704
Suministro e instalacion de accesorios electricos 25 0.04 20.00 0.80 0.80 0.1852 0.1481
Suministro e instalacion de accesorios sanitarios 25 0.04 20.00 0.80 0.80 0.1852 0.1481
Fraguache interior, exterior y techo + techo galeria 1 1.00 1.00 1.00 1.00 0.0074 0.0074 T 0.6741 0.6741 1.000
29 T 0.3778
Suministro e instalacion de accesorios electricos 25 0.04 21.00 0.84 0.84 0.1852 0.1556
Suministro e instalacion de accesorios sanitarios 25 0.04 21.00 0.84 0.84 0.1852 0.1556
Pañete interior, en techo y mochetas 5 0.20 1.00 0.20 0.20 0.0370 0.0074
Portaje 6 0.17 1.00 0.17 0.17 0.0444 0.0076 0.7039 0.7037 1.000
30 T 0.3778
Suministro e instalacion de accesorios electricos 25 0.04 22.00 0.88 0.88 0.1852 0.1630
Suministro e instalacion de accesorios sanitarios 25 0.04 22.00 0.88 0.88 0.1852 0.1630
Pañete interior, en techo y mochetas 5 0.20 2.00 0.40 0.40 0.0370 0.0148
Portaje 6 0.17 2.00 0.34 0.34 0.0444 0.0151 0.7336 0.7333 1.000
31 T 0.3778
Suministro e instalacion de accesorios electricos 25 0.04 23.00 0.92 0.92 0.1852 0.1704
Suministro e instalacion de accesorios sanitarios 25 0.04 23.00 0.92 0.92 0.1852 0.1704
Pañete interior, en techo y mochetas 5 0.20 3.00 0.60 0.60 0.0370 0.0222
Portaje 6 0.17 3.00 0.51 0.51 0.0444 0.0227 0.7634 0.7630 1.001
32 T 0.3778
Suministro e instalacion de accesorios electricos 25 0.04 24.00 0.96 0.96 0.1852 0.1778
Suministro e instalacion de accesorios sanitarios 25 0.04 24.00 0.96 0.96 0.1852 0.1778
Pañete interior, en techo y mochetas 5 0.20 4.00 0.80 0.80 0.0370 0.0296
Portaje 6 0.17 4.00 0.68 0.68 0.0444 0.0302 0.7932 0.7926 1.001
33 T 0.3778
Suministro e instalacion de accesorios electricos 25 0.04 25.00 1.00 1.00 0.1852 0.1852 T
Suministro e instalacion de accesorios sanitarios 25 0.04 25.00 1.00 1.00 0.1852 0.1852 T
Pañete interior, en techo y mochetas 5 0.20 5.00 1.00 1.00 0.0370 0.0370 T
Portaje 6 0.17 5.00 0.85 0.85 0.0444 0.0378 0.8230 0.8222 1.001
34 T 0.7852
Portaje 6 0.17 6.00 1.00 1.00 0.0444 0.0444 T
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de
baños y cocina
6 0.17 1.00 0.17 0.17 0.0444 0.0076
Jardineria en patio 4 0.25 1.00 0.25 0.00 0.0296 0.0000 0.8372 0.8444 0.991
35 T 0.8296
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de
baños y cocina
6 0.17 2.00 0.34 0.34 0.0444 0.0151
Jardineria en patio 4 0.25 2.00 0.50 0.50 0.0296 0.0148
Ventanas 6 0.17 1.00 0.17 0.17 0.0444 0.0076 0.8671 0.8667 1.001
36 T 0.8296
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de
baños y cocina
6 0.17 3.00 0.51 0.51 0.0444 0.0227
Jardineria en patio 4 0.25 3.00 0.75 0.50 0.0296 0.0148
Ventanas 6 0.17 2.00 0.34 0.34 0.0444 0.0151 0.8822 0.8889 0.993
37 T 0.8296
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de
baños y cocina
6 0.17 4.00 0.68 0.68 0.0444 0.0302
Jardineria en patio 4 0.25 4.00 1.00 1.00 0.0296 0.0296 T
Ventanas 6 0.17 3.00 0.51 0.51 0.0444 0.0227 0.9121 0.9111 1.001
38 T 0.8593
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de
baños y cocina
6 0.17 5.00 0.85 0.85 0.0444 0.0378
Ventanas 6 0.17 4.00 0.68 0.40 0.0444 0.0178 0.9148 0.9259 0.988
39 T 0.8593
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de
baños y cocina
6 0.17 6.00 1.00 1.00 0.0444 0.0444 T
Ventanas 5 0.20 5.00 0.85 0.60 0.0370 0.0222 0.9259 0.9407 0.984
40 T 0.9037
Ventanas 6 0.17 6.00 1.00 1.00 0.0444 0.0444 T
Pintura acrilica interior y exterior 3 0.33 1.00 0.33 0.20 0.0222 0.0044
Cocina (gabinetes de piso, pared y topes de cocina en granito) 3 0.33 1.00 0.33 0.33 0.0222 0.0073 0.9599 0.9630 0.997
41 T 0.9481
Pintura acrilica interior y exterior 3 0.33 2.00 0.66 0.80 0.0222 0.0178
Cocina (gabinetes de piso, pared y topes de cocina en granito) 3 0.33 2.00 0.66 0.66 0.0222 0.0147 0.9806 0.9778 1.003
42 T 0.9481
Pintura acrilica interior y exterior 3 0.33 3.00 1.00 1.00 0.0222 0.0222 T
Cocina (gabinetes de piso, pared y topes de cocina en granito) 3 0.33 3.00 1.00 1.00 0.0222 0.0222 T 0.9926 0.9926 1.000
43 T 0.9926
Limpieza general continua y final ( incluye bote de escombros ) 1 1.00 1.00 1.00 1.00 0.0074 0.0074 T 1.0000 1.0000 1.000
Dia Actividades por dia Actividades Acumuladas Avance Programado por Dia Dia Actividades por dia Actividades Acumuladas Avance Programado por Dia
1 1 1 0.023 23 1 23 0.535
2 1 2 0.047 24 1 24 0.558
3 1 3 0.070 25 1 25 0.581
4 1 4 0.093 26 1 26 0.605
5 1 5 0.116 27 1 27 0.628
6 1 6 0.140 28 1 28 0.651
7 1 7 0.163 29 1 29 0.674
8 1 8 0.186 30 1 30 0.698
9 1 9 0.209 31 1 31 0.721
10 1 10 0.233 32 1 32 0.744
11 1 11 0.256 33 1 33 0.767
12 1 12 0.279 34 1 34 0.791
13 1 13 0.302 35 1 35 0.814
14 1 14 0.326 36 1 36 0.837
15 1 15 0.349 37 1 37 0.860
16 1 16 0.372 38 1 38 0.884
17 1 17 0.395 39 1 39 0.907
18 1 18 0.419 40 1 40 0.930
19 1 19 0.442 41 1 41 0.953
20 1 20 0.465 42 1 42 0.977
21 1 21 0.488 43 1 43 1.000
22 1 22 0.512
1
∑ Act. Acum.
fa = 0.02326
CALCULO DE AVANCE PROGRAMADO
1 2 3 4 5 6 7 8 9 10 11 12 13
Dia
a(Actividades)
e(DiasProgramados)
1/e
DiasTranscurridos
(Programados)
Porcentaje
Programados
PorcentajeReal
fa(FactorAvance)
Avancedea
Porcentaje
acumulado
AvancedelProyecto
AvanceProgramado
E(p)
1 Replanteos casa 1 1.00 1.00 1.00 1.00 0.0233 0.0233 T 0.0233 0.0233 1.00
2 T 0.0233
Acero para zapatas de muros y columnas y para columnas de carga 3 0.33 1.00 0.33 0.00 0.0698 0.0000 0.0233 0.0465 0.50
3 T 0.0233
Acero para zapatas de muros y columnas y para columnas de carga 3 0.33 2.00 0.66 0.60 0.0698 0.0419 0.0651 0.0698 0.93
4 T 0.0233
Acero para zapatas de muros y columnas y para columnas de carga 3 0.33 3.00 1.00 1.00 0.0698 0.0698 T 0.0930 0.0930 1.00
5 T 0.0930
Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1 1.00 1.00 1.00 1.00 0.0233 0.0233 T 0.1163 0.1163 1.00
6 T 0.1163
Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 1.00 0.33 0.00 0.0698 0.0000 0.1163 0.1395 0.83
7 T 0.1163
Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 2.00 0.66 0.00 0.0698 0.0000 0.1163 0.1628 0.71
8 T 0.1163
Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 3.00 1.00 1.00 0.0698 0.0698 T 0.1860 0.1860 1.00
9 T 0.1860
Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 1.00 0.20 0.00 0.1163 0.0000 0.1860 0.2093 0.89
10 T 0.1860
Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 2.00 0.40 0.00 0.1163 0.0000 0.1860 0.2326 0.80
11 T 0.1860
Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 3.00 0.60 0.20 0.1163 0.0233 0.2093 0.2558 0.82
12 T 0.1860
Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 4.00 0.80 0.70 0.1163 0.0814 0.2674 0.2791 0.96
13 T 0.1860
Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 5.00 1.00 1.00 0.1163 0.1163 T 0.3023 0.3023 1.00
14 T 0.3023
Encofrado para dintel, losa y vigas 14 0.07 1.00 0.07 0.07 0.3256 0.0228 0.3251 0.3256 1.00
15 T 0.3023
Encofrado para dintel, losa y vigas 14 0.07 2.00 0.14 0.14 0.3256 0.0456 0.3479 0.3488 1.00
16 T 0.3023
Encofrado para dintel, losa y vigas 14 0.07 3.00 0.21 0.21 0.3256 0.0684 0.3707 0.3721 1.00
17 T 0.3023
Encofrado para dintel, losa y vigas 14 0.07 4.00 0.28 0.28 0.3256 0.0912 0.3935 0.3953 1.00
18 T 0.3023
Encofrado para dintel, losa y vigas 14 0.07 5.00 0.35 0.35 0.3256 0.1140 0.4163 0.4186 0.99
19 T 0.3023
Encofrado para dintel, losa y vigas 14 0.07 6.00 0.42 0.42 0.3256 0.1367 0.4391 0.4419 0.99
20 T 0.3023
Encofrado para dintel, losa y vigas 14 0.07 7.00 0.49 0.49 0.3256 0.1595 0.4619 0.4651 0.99
21 T 0.3023
Encofrado para dintel, losa y vigas 14 0.07 8.00 0.56 0.56 0.3256 0.1823 0.4847 0.4884 0.99
22 T 0.3023
Encofrado para dintel, losa y vigas 14 0.07 9.00 0.63 0.63 0.3256 0.2051 0.5074 0.5116 0.99
23 T 0.3023
Encofrado para dintel, losa y vigas 14 0.07 10.00 0.70 0.70 0.3256 0.2279 0.5302 0.5349 0.99
24 T 0.3023
Encofrado para dintel, losa y vigas 14 0.07 11.00 0.77 0.77 0.3256 0.2507 0.5530 0.5581 0.99
25 T 0.3023
Encofrado para dintel, losa y vigas 14 0.07 12.00 0.84 0.84 0.3256 0.2735 0.5758 0.5814 0.99
26 T 0.3023
Encofrado para dintel, losa y vigas 14 0.07 13.00 0.91 0.91 0.3256 0.2963 0.5986 0.6047 0.99
27 T 0.3023
Encofrado para dintel, losa y vigas 14 0.07 14.00 1.00 1.00 0.3256 0.3256 T 0.6279 0.6279 1.00
28 T 0.6279
Fraguache interior, exterior y techo + techo galeria 1 1.00 1.00 1.00 1.00 0.0233 0.0233 T 0.6512 0.6512 1.00
29 T 0.6512
Pañete interior, en techo y mochetas 5 0.20 1.00 0.20 0.00 0.1163 0.0000 0.6512 0.6744 0.97
30 T 0.6512
Pañete interior, en techo y mochetas 5 0.20 2.00 0.40 0.35 0.1163 0.0407 0.6919 0.6977 0.99
31 T 0.6512
Pañete interior, en techo y mochetas 5 0.20 3.00 0.60 0.70 0.1163 0.0814 0.7326 0.7209 1.02
32 T 0.6512
Pañete interior, en techo y mochetas 5 0.20 4.00 0.80 0.80 0.1163 0.0930 0.7442 0.7442 1.00
33 T 0.6512
Pañete interior, en techo y mochetas 5 0.20 5.00 1.00 1.00 0.1163 0.1163 T 0.7674 0.7674 1.00
34 T 0.7674
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 1.00 0.17 0.17 0.1395 0.0237 0.7912 0.7907 1.00
35 T 0.7674
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 2.00 0.34 0.34 0.1395 0.0474 0.8149 0.8140 1.00
36 T 0.7674
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 3.00 0.51 0.51 0.1395 0.0712 0.8386 0.8372 1.00
37 T 0.7674
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 4.00 0.68 0.68 0.1395 0.0949 0.8623 0.8605 1.00
38 T 0.7674
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 5.00 0.85 0.85 0.1395 0.1186 0.8860 0.8837 1.00
39 T 0.7674
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 6.00 1.00 1.00 0.1395 0.1395 T 0.9070 0.9070 1.00
40 T 0.9070
Cocina (gabinetes de piso, pared y topes de cocina en granito) 3 0.33 1.00 0.33 0.00 0.0698 0.0000 0.9070 0.9302 0.98
41 T 0.9070
Cocina (gabinetes de piso, pared y topes de cocina en granito) 3 0.33 2.00 0.66 0.00 0.0698 0.0000 0.9070 0.9535 0.95
42 T 0.9070
Cocina (gabinetes de piso, pared y topes de cocina en granito) 3 0.33 3.00 1.00 1.00 0.0698 0.0698 T 0.9767 0.9767 1.00
43 T 0.9767
Limpieza general continua y final ( incluye bote de escombros ) 1 1.00 1.00 1.00 1.00 0.0233 0.0233 T 1.0000 1.0000 1.00
Dia Actividades por dia Actividades Acumuladas Avance Programado por Dia Dia Actividades por dia Actividades Acumuladas Avance Programado por Dia
1 1 1 0.027 23 1 23 0.622
2 1 2 0.054 24 1 24 0.649
3 1 3 0.081 25 1 25 0.676
4 1 4 0.108 26 1 26 0.703
5 1 5 0.135 27 1 27 0.730
6 1 6 0.162 28 1 28 0.757
7 1 7 0.189 29 1 29 0.784
8 1 8 0.216 30 1 30 0.811
9 1 9 0.243 31 1 31 0.838
10 1 10 0.270 32 1 32 0.865
11 1 11 0.297 33 1 33 0.892
12 1 12 0.324 34 1 34 0.919
13 1 13 0.351 35 1 35 0.946
14 1 14 0.378 36 1 36 0.973
15 1 15 0.405 37 1 37 1.000
16 1 16 0.432
17 1 17 0.459 1
18 1 18 0.486 ∑ Act. Acum.
19 1 19 0.514
20 1 20 0.541
21 1 21 0.568
22 1 22 0.595
fa = 0.02703
CALCULO DE AVANCE PROGRAMADO
Dia
a(Actividades)
e(Dias
Programados)
1/e
Dias
Transcurridos
(Programados)
Porcentaje
Programados
PorcentajeReal
fa(FactorAvance)
Avancedea
Porcentaje
acumulado
Avancedel
Proyecto
Avance
Programado
E(p)
1 Conexiones temporales 1 1.00 1.00 1.00 1.00 0.0270 0.0270 T 0.0270 0.0270 1.00
2 T 0.0270
Excavaciones de zapatas muros bloques y columnas 2 0.50 1.00 0.50 0.50 0.0541 0.0270 0.0541 0.0541 1.00
3 T 0.0270
Excavaciones de zapatas muros bloques y columnas 2 0.50 2.00 1.00 1.00 0.0541 0.0541 T 0.0811 0.0811 1.00
4 T 0.0811
Actividad ficticia 0 - - 1.00 1.00 0.0000 0.0000 T 0.0811 0.1081 0.75
5 T 0.0811
Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1 1.00 1.00 1.00 1.00 0.0270 0.0270 T 0.1081 0.1351 0.80
6 T 0.1081
Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 1.00 0.33 0.00 0.0811 0.0000 0.1081 0.1622 0.67
7 T 0.1081
Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 2.00 0.66 0.50 0.0811 0.0405 0.1486 0.1892 0.79
8 T 0.1081
Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 3.00 1.00 1.00 0.0811 0.0811 T 0.1892 0.2162 0.88
9 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 1.00 0.04 0.02 0.6757 0.0135 0.2027 0.2432 0.83
10 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 2.00 0.08 0.02 0.6757 0.0135 0.2027 0.2703 0.75
11 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 3.00 0.12 0.02 0.6757 0.0135 0.2027 0.2973 0.68
12 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 4.00 0.16 0.10 0.6757 0.0676 0.2568 0.3243 0.79
13 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 5.00 0.20 0.12 0.6757 0.0811 0.2703 0.3514 0.77
14 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 6.00 0.24 0.16 0.6757 0.1081 0.2973 0.3784 0.79
15 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 7.00 0.28 0.20 0.6757 0.1351 0.3243 0.4054 0.80
16 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 8.00 0.32 0.24 0.6757 0.1622 0.3514 0.4324 0.81
17 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 9.00 0.36 0.30 0.6757 0.2027 0.3919 0.4595 0.85
18 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 10.00 0.40 0.35 0.6757 0.2365 0.4257 0.4865 0.88
19 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 11.00 0.44 0.40 0.6757 0.2703 0.4595 0.5135 0.89
20 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 12.00 0.48 0.45 0.6757 0.3041 0.4932 0.5405 0.91
21 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 13.00 0.52 0.50 0.6757 0.3378 0.5270 0.5676 0.93
22 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 14.00 0.56 0.54 0.6757 0.3649 0.5541 0.5946 0.93
23 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 15.00 0.60 0.60 0.6757 0.4054 0.5946 0.6216 0.96
24 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 16.00 0.64 0.62 0.6757 0.4189 0.6081 0.6486 0.94
25 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 17.00 0.68 0.66 0.6757 0.4459 0.6351 0.6757 0.94
26 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 18.00 0.72 0.70 0.6757 0.4730 0.6622 0.7027 0.94
27 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 19.00 0.76 0.78 0.6757 0.5270 0.7162 0.7297 0.98
28 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 20.00 0.80 0.85 0.6757 0.5743 0.7635 0.7568 1.01
29 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 21.00 0.84 0.86 0.6757 0.5811 0.7703 0.7838 0.98
30 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 22.00 0.88 0.87 0.6757 0.5878 0.7770 0.8108 0.96
31 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 23.00 0.92 0.95 0.6757 0.6419 0.8311 0.8378 0.99
32 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 24.00 0.96 0.96 0.6757 0.6486 0.8378 0.8649 0.97
33 T 0.1892
Suministro e instalacion de accesorios sanitarios 25 0.04 25.00 1.00 1.00 0.6757 0.6757 T 0.8649 0.8919 0.97
34 T 0.8649
Jardineria en patio 4 0.25 1.00 0.25 0.00 0.1081 0.0000 0.8649 0.9189 0.94
35 T 0.8649
Jardineria en patio 4 0.25 2.00 0.50 0.50 0.1081 0.0541 0.9189 0.9459 0.97
36 T 0.8649
Jardineria en patio 4 0.25 3.00 0.75 0.75 0.1081 0.0811 0.9459 0.9730 0.97
37 T 0.8649
Jardineria en patio 4 0.25 4.00 1.00 1.00 0.1081 0.1081 T 1.0000 1.0000 1.00
1 2 3 4 5 6 7 8 9
Dea
DelProyecto
Delproceso
Procentajeacumulado
Totaldelproceso
1 Replanteos casa 1 0.00740741 0.0233 T 0.0000 0.0233 0.0233 1.00
2 T 0.0233 0.0233
Acero para zapatas de muros y columnas y para columnas de carga 0.33 0.00733333 0.02302326 0.0233 0.0463 0.0465 1.00
3 T 0.0233 0.0233
Acero para zapatas de muros y columnas y para columnas de carga 0.66 0.01466667 0.04604651 0.0233 0.0693 0.0698 0.99
4 T 0.0233 0.0233
Acero para zapatas de muros y columnas y para columnas de carga 1 0.02222222 0.0698 T 0.0233 0.0930 0.0930 1.00
5 T 0.0930 0.0930
Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1 0.00740741 0.0233 T 0.0930 0.1163 0.1163 1.00
6 T 0.1163 0.1163
Colocación de bloques BNP de 0.15 y 0.10 mts 0.33 0 0 0.1163 0.1163 0.1395 0.83
7 T 0.1163 0.1163
Colocación de bloques BNP de 0.15 y 0.10 mts 0.66 0.01111111 0.03488372 0.1163 0.1512 0.1628 0.93
8 T 0.1163 0.1163
Colocación de bloques BNP de 0.15 y 0.10 mts 1 0.02222222 0.0698 T 0.1163 0.1860 0.1860 1.00
9 T 0.1860 0.1860
Colocación de bloques SNP de 0.15 y 0.10 mts 0.2 0 0 0.1860 0.1860 0.2093 0.89
10 T 0.1860 0.1860
Colocación de bloques SNP de 0.15 y 0.10 mts 0.4 0 0 0.1860 0.1860 0.2326 0.80
11 T 0.1860 0.1860
Colocación de bloques SNP de 0.15 y 0.10 mts 0.6 0.01851852 0.05813953 0.1860 0.2442 0.2558 0.95
12 T 0.1860 0.1860
Colocación de bloques SNP de 0.15 y 0.10 mts 0.8 0 0 0.1860 0.1860 0.2791 0.67
13 T 0.1860 0.1860
Colocación de bloques SNP de 0.15 y 0.10 mts 1 0.03703704 0.1163 T 0.1860 0.3023 0.3023 1.00
14 T 0.3023 0.3023
Encofrado para dintel, losa y vigas 0.07 0.00725926 0.0227907 0.3023 0.3251 0.3256 1.00
15 T 0.3023 0.3023
Encofrado para dintel, losa y vigas 0.14 0.01451852 0.0455814 0.3023 0.3479 0.3488 1.00
16 T 0.3023 0.3023
Encofrado para dintel, losa y vigas 0.21 0.02177778 0.06837209 0.3023 0.3707 0.3721 1.00
17 T 0.3023 0.3023
Encofrado para dintel, losa y vigas 0.28 0.02903704 0.09116279 0.3023 0.3935 0.3953 1.00
18 T 0.3023 0.3023
Encofrado para dintel, losa y vigas 0.35 0.0362963 0.11395349 0.3023 0.4163 0.4186 0.99
19 T 0.3023 0.3023
Encofrado para dintel, losa y vigas 0.42 0.04355556 0.13674419 0.3023 0.4391 0.4419 0.99
20 T 0.3023 0.3023
Encofrado para dintel, losa y vigas 0.49 0.05081481 0.15953488 0.3023 0.4619 0.4651 0.99
21 T 0.3023 0.3023
Encofrado para dintel, losa y vigas 0.56 0.05807407 0.18232558 0.3023 0.4847 0.4884 0.99
22 T 0.3023 0.3023
Encofrado para dintel, losa y vigas 0.63 0.06533333 0.20511628 0.3023 0.5074 0.5116 0.99
23 T 0.3023 0.3023
Encofrado para dintel, losa y vigas 0.7 0.07259259 0.22790698 0.3023 0.5302 0.5349 0.99
24 T 0.3023 0.3023
Encofrado para dintel, losa y vigas 0.77 0.07985185 0.25069767 0.3023 0.5530 0.5581 0.99
25 T 0.3023 0.3023
Encofrado para dintel, losa y vigas 0.84 0.08711111 0.27348837 0.3023 0.5758 0.5814 0.99
26 T 0.3023 0.3023
Encofrado para dintel, losa y vigas 0.91 0.09437037 0.29627907 0.3023 0.5986 0.6047 0.99
27 T 0.3023 0.3023
Encofrado para dintel, losa y vigas 1 0.1037037 0.3256 T 0.3023 0.6279 0.6279 1.00
28 T 0.6279 0.6279
Fraguache interior, exterior y techo + techo galeria 1 0.00740741 0.0233 T 0.6279 0.6512 0.6512 1.00
29 T 0.6512 0.6512
Pañete interior, en techo y mochetas 0.2 0.00740741 0.02325581 0.6512 0.6744 0.6744 1.00
30 T 0.6512 0.6512
Pañete interior, en techo y mochetas 0.4 0.01481481 0.04651163 0.6512 0.6977 0.6977 1.00
31 T 0.6512 0.6512
Pañete interior, en techo y mochetas 0.6 0.02222222 0.06976744 0.6512 0.7209 0.7209 1.00
32 T 0.6512 0.6512
Pañete interior, en techo y mochetas 0.8 0.02962963 0.09302326 0.6512 0.7442 0.7442 1.00
33 T 0.6512 0.6512
Pañete interior, en techo y mochetas 1 0.03703704 0.1163 T 0.6512 0.7674 0.7674 1.00
34 T 0.7674 0.7674
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.17 0.00755556 0.02372093 0.7674 0.7912 0.7907 1.00
35 T 0.7674 0.7674
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.34 0.01511111 0.04744186 0.7674 0.8149 0.8140 1.00
36 T 0.7674 0.7674
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.51 0.02266667 0.07116279 0.7674 0.8386 0.8372 1.00
37 T 0.7674 0.7674
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.68 0.03022222 0.09488372 0.7674 0.8623 0.8605 1.00
38 T 0.7674 0.7674
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.85 0.03777778 0.11860465 0.7674 0.8860 0.8837 1.00
39 T 0.7674 0.7674
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 1 0.04444444 0.1395 T 0.7674 0.9070 0.9070 1.00
40 T 0.9070 0.9070
Cocina (gabinetes de piso, pared y topes de cocina en granito) 0.33 0.00733333 0.02302326 0.9070 0.9300 0.9302 1.00
41 T 0.9070 0.9070
Cocina (gabinetes de piso, pared y topes de cocina en granito) 0.66 0.01466667 0.04604651 0.9070 0.9530 0.9535 1.00
42 T 0.9070 0.9070
Cocina (gabinetes de piso, pared y topes de cocina en granito) 1 0.02222222 0.0698 T 0.9070 0.9767 0.9767 1.00
43 T 0.9767 0.9767
Limpieza general continua y final ( incluye bote de escombros ) 1 0.00740741 0.0233 T 0.9767 1.0000 1.0000 1.00

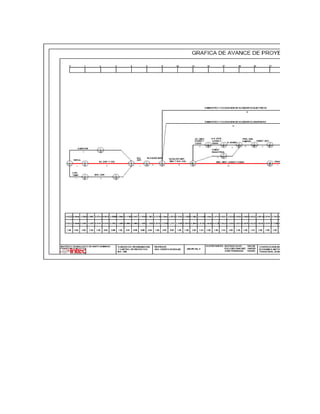

Cuadro de avance del proceso A
Día
Actividad
AVANCE
1 2 3 4 5 6 7 8 9
Dea
DelProyecto
Delproceso
Procentajeacumulado
Totaldelproceso
1 Conexiones temporales 1.00 0.00740741 0.0270 T 0.0000 0.0270 0.0270 1.00
2 T 0.0270 0.0270
Excavaciones de zapatas muros bloques y columnas 0.50 0.00740741 0.02702703 0.0270 0.0541 0.0541 1.00
3 T 0.0270 0.0270
Excavaciones de zapatas muros bloques y columnas 1.00 0.01481481 0.0541 T 0.0270 0.0811 0.0811 1.00
4 T 0.0811 0.0811
Actividad ficticia 1.00 0 0.0000 T 0.0811 0.0811 0.1081 0.75
5 T 0.0811 0.0811
Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1.00 0.00740741 0.0270 T 0.0811 0.1081 0.1351 0.80
6 T 0.1081 0.1081
Colocación de bloques BNP de 0.15 y 0.10 mts 0.33 0 0 0.1081 0.1081 0.1622 0.67
7 T 0.1081 0.1081
Colocación de bloques BNP de 0.15 y 0.10 mts 0.66 0.01111111 0.04054054 0.1081 0.1486 0.1892 0.79
8 T 0.1081 0.1081
Colocación de bloques BNP de 0.15 y 0.10 mts 1.00 0.02222222 0.0811 T 0.1081 0.1892 0.2162 0.88
9 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.04 0 0 0.1892 0.1892 0.2432 0.78
10 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.08 0 0 0.1892 0.1892 0.2703 0.70
11 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.12 0.02222222 0.08108108 0.1892 0.2703 0.2973 0.91
12 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.16 0.02962963 0.10810811 0.1892 0.2973 0.3243 0.92
13 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.20 0.03703704 0.13513514 0.1892 0.3243 0.3514 0.92
14 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.24 0.04444444 0.16216216 0.1892 0.3514 0.3784 0.93
15 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.28 0.05185185 0.18918919 0.1892 0.3784 0.4054 0.93
16 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.32 0.05925926 0.21621622 0.1892 0.4054 0.4324 0.94
17 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.36 0.06666667 0.24324324 0.1892 0.4324 0.4595 0.94
18 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.40 0.07407407 0.27027027 0.1892 0.4595 0.4865 0.94
19 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.44 0.08148148 0.2972973 0.1892 0.4865 0.5135 0.95
20 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.48 0.08888889 0.32432432 0.1892 0.5135 0.5405 0.95
21 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.52 0.0962963 0.35135135 0.1892 0.5405 0.5676 0.95
22 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.56 0.1037037 0.37837838 0.1892 0.5676 0.5946 0.95
23 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.60 0.11111111 0.40540541 0.1892 0.5946 0.6216 0.96
24 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.64 0.11851852 0.43243243 0.1892 0.6216 0.6486 0.96
25 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.68 0.12592593 0.45945946 0.1892 0.6486 0.6757 0.96
26 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.72 0.13333333 0.48648649 0.1892 0.6757 0.7027 0.96
27 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.76 0.14074074 0.51351351 0.1892 0.7027 0.7297 0.96
28 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.80 0.14814815 0.54054054 0.1892 0.7297 0.7568 0.96
29 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.84 0.15555556 0.56756757 0.1892 0.7568 0.7838 0.97
30 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.88 0.16296296 0.59459459 0.1892 0.7838 0.8108 0.97
31 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.92 0.17037037 0.62162162 0.1892 0.8108 0.8378 0.97
32 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 0.96 0.17777778 0.64864865 0.1892 0.8378 0.8649 0.97
33 T 0.1892 0.1892
Suministro e instalacion de accesorios sanitarios 1.00 0.18518519 0.6757 T 0.1892 0.8649 0.8919 0.97
34 T 0.8649 0.8649
Jardineria en patio 0.25 0 0 0.8649 0.8649 0.9189 0.94
35 T 0.8649 0.8649
Jardineria en patio 0.50 0.01481481 0.05405405 0.8649 0.9189 0.9459 0.97
36 T 0.8649 0.8649
Jardineria en patio 0.75 0.01481481 0.05405405 0.8649 0.9189 0.9730 0.94
37 T 0.8649 0.8649
Jardineria en patio 1.00 0.02962963 0.1081 T 0.8649 0.9730 1.0000 0.97
Cuadro de avance del proceso A
Día
Actividad
AVANCE
0 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32 33 34 35 36 37 38 39 40 41 42 43
1 Replanteos casa
5 Acero para zapatas de muros y columnas y para columnas de carga
6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas
7 Colocación de bloques BNP de 0.15 y 0.10 mts
8 Colocación de bloques SNP de 0.15 y 0.10 mts
15 Encofrado para dintel, losa y vigas
16 Fraguache interior, exterior y techo + techo galeria
19 Pañete interior, en techo y mochetas
23 Torta de piso
25 Cocina (gabinetes de piso, pared y topes de cocina en granito)
26 Limpieza general continua y final ( incluye bote de escombros )
2 Conexiones temporales
4 Excavacion zapatas
Actividad ficticia
3 Almacen
Actividad ficticia
Suministro y colocacion de accesorios electricos
Actividad ficticia
Suministro y colocacion de accesorios sanitarios
Jardineria
Acero de dinteles y vigas y losa
H.A. dintel, viga y losa
Bloques de antepecho
Fino, zabaleta e impermeablizante de techo
Pañete exterior
Actividad ficticia
Construccion de registro
Actividad ficticia
Pintura
Actividad ficticia
Puertas
Ventanas
Actividad ficticia
Actividad ficticia Tiempos remotos
Tiempos próximos Actividad crítica

DIAGRAMA DE GANTT
CONSTRUCCION DE CASA ( 62,0 MT2 )
No. Actividad
Días
APLICACIÓN METODO BURGESS
Actividad: Construccion de registros
Duración= 4
HL= 2
M.O= 5 Hombres/ día
5 Hombres/Actividad 1
IP13-IP14 IP14-IP15 IP15-IP16 IP16-IP17 IP17-IP18 IP18-IP19 (5)²+(0)²+(0)²+(0)²+ (0)²+(0)²+(0)²+(0)²=25
1
1
1
1
1
IP13-IP14 IP14-IP15 IP15-IP16 IP16-IP17 IP17-IP18 IP18-IP19 (4)²+(1)²+(0)²+(0)²+ (0)²+(0)²+(0)²+(0)²=17
1
1
1
1
1
IP13-IP14 IP14-IP15 IP15-IP16 IP16-IP17 IP17-IP18 IP18-IP19 (3)²+(2)²+(0)²+(0)²+ (0)²+(0)²+(0)²+(0)²=13
1
1
1
1
1
IP13-IP14 IP14-IP15 IP15-IP16 IP16-IP17 IP17-IP18 IP18-IP19 (2)²+(2)²+(1)²+(0)²+ (0)²+(0)²+(0)²+(0)²=9
1
1
1
1
1
IP13-IP14 IP14-IP15 IP15-IP16 IP16-IP17 IP17-IP18 IP18-IP19 (1)²+(1)²+(1)²+(1)²+ (1)²+(0)²+(0)²+(0)²=5 MEJOR OPCION
1 1 1 1 1
IP13-IP14 IP14-IP15 IP15-IP16 IP16-IP17 IP17-IP18 IP18-IP19 (1)²+(3)²+(1)²+(0)²+ (0)²+(0)²+(0)²+(0)²=11
1
1
1
1
1
Actividad: Jardineria
Duración= 4
HL= 5
M.O= 3 Hombres/ día
3 Hombres/Actividad
IP34-IP35 IP35-IP36 IP36-IP37 IP37-IP38 IP38-IP39 IP39-IP40 IP40-IP41 IP41-IP42 IP42-IP43 (3)²+(0)²+(0)²+(0)²+ (0)²+(0)²+(0)²+(0)²=9
1
1
1
IP34-IP35 IP35-IP36 IP36-IP37 IP37-IP38 IP38-IP39 IP39-IP40 IP40-IP41 IP41-IP42 IP42-IP43 (2)²+(1)²+(0)²+(0)²+ (0)²+(0)²+(0)²+(0)²=5
1
1
1
IP34-IP35 IP35-IP36 IP36-IP37 IP37-IP38 IP38-IP39 IP39-IP40 IP40-IP41 IP41-IP42 IP42-IP43 (1)²+(1)²+(1)²+(0)²+ (0)²+(0)²+(0)²+(0)²=3 MEJOR OPCION
1 1 1
Premisas: 1. La provisión de efectivo para el proyecto estará distribuida de la forma siguiente:
Día - 1: 40% RD $ 408,165.05
Día 10: 50% RD $ 510,206.31
Día 20: 10% RD $ 102,041.26
RD $ 1,020,412.62
3. El costo de los gastos fijos estan incluidos en las actividades.
Día Saldo Inicial Provisión Préstamo Suma Ingresos Actividad Anticipos Liquidación Fijos Pago Préstamo Suma Egresos Saldo Final
-1 -RD$ 408,165.05RD$ -RD$ 408,165.05RD$ 1 2,579.20RD$ -RD$ -RD$ -RD$
2 960.00RD$ -RD$ -RD$ -RD$
3 3,840.00RD$ -RD$ -RD$ -RD$ 7,379.20RD$ 400,785.85RD$
0 400,785.85RD$ -RD$ -RD$ 400,785.85RD$ 4 5,428.74RD$ -RD$ -RD$ -RD$
5 13,606.12RD$ -RD$ -RD$ -RD$ 19,034.86RD$ 381,750.99RD$
1 381,750.99RD$ -RD$ -RD$ 381,750.99RD$ 1 -RD$ 2,579.20RD$ -RD$ -RD$
2 -RD$ 960.00RD$ -RD$ -RD$ 3,539.20RD$ 378,211.79RD$
2 378,211.79RD$ -RD$ -RD$ 378,211.79RD$ 3 -RD$ 3,840.00RD$ -RD$ -RD$ 3,840.00RD$ 374,371.79RD$
3 374,371.79RD$ -RD$ -RD$ 374,371.79RD$ 4 -RD$ 5,428.74RD$ -RD$ -RD$
6 40,238.69 -RD$ -RD$ -RD$ 45,667.43RD$ 328,704.36RD$
4 328,704.36RD$ -RD$ -RD$ 328,704.36RD$ 5 -RD$ 13,606.12RD$ -RD$ -RD$
7 21,798.88RD$ -RD$ -RD$ -RD$ 35,405.00RD$ 293,299.36RD$
5 293,299.36RD$ -RD$ -RD$ 293,299.36RD$ 6 -RD$ 40,238.69RD$ -RD$ -RD$ 40,238.69RD$ 253,060.67RD$
6 253,060.67RD$ -RD$ -RD$ 253,060.67RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 253,060.67RD$
7 253,060.67RD$ -RD$ -RD$ 253,060.67RD$ 8 60,484.21RD$ -RD$ -RD$ -RD$
17 34,404.45RD$ -RD$ -RD$ -RD$
18 30,393.60RD$ -RD$ -RD$ -RD$ 125,282.27RD$ 127,778.40RD$
8 127,778.40RD$ -RD$ -RD$ 127,778.40RD$ 7 -RD$ 21,798.88RD$ -RD$ -RD$ 21,798.88RD$ 105,979.52RD$
9 105,979.52RD$ -RD$ -RD$ 105,979.52RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 105,979.52RD$
10 105,979.52RD$ -RD$ -RD$ 105,979.52RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 105,979.52RD$
11 105,979.52RD$ -RD$ -RD$ 105,979.52RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 105,979.52RD$
12 105,979.52RD$ -RD$ -RD$ 105,979.52RD$ 9 2,916.86RD$ -RD$ -RD$ -RD$
10 32,357.55RD$ -RD$ -RD$ -RD$
15 19,723.27RD$ -RD$ -RD$ -RD$ 54,997.68RD$ 50,981.84RD$
13 50,981.84RD$ 510,206.31RD$ -RD$ 561,188.15RD$ 8 -RD$ 60,484.21RD$ -RD$ -RD$ 60,484.21RD$ 500,703.93RD$
14 500,703.93RD$ -RD$ -RD$ 500,703.93RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 500,703.93RD$
15 500,703.93RD$ -RD$ -RD$ 500,703.93RD$ 11 39,068.94RD$ -RD$ -RD$ -RD$ 39,068.94RD$ 461,635.00RD$
16 461,635.00RD$ -RD$ -RD$ 461,635.00RD$ 10 -RD$ 32,357.55RD$ -RD$ -RD$
12 3,432.19RD$ -RD$ -RD$ -RD$ 35,789.74RD$ 425,845.25RD$
17 425,845.25RD$ -RD$ -RD$ 425,845.25RD$ 9 -RD$ 2,916.86RD$ -RD$ -RD$
11 -RD$ 39,068.94RD$ -RD$ -RD$ 41,985.80RD$ 383,859.45RD$
18 383,859.45RD$ -RD$ -RD$ 383,859.45RD$ 13 22,852.73RD$ -RD$ -RD$ -RD$ 22,852.73RD$ 361,006.72RD$
19 361,006.72RD$ -RD$ -RD$ 361,006.72RD$ 12 -RD$ 3,432.19RD$ -RD$ -RD$ 3,432.19RD$ 357,574.53RD$
20 357,574.53RD$ -RD$ -RD$ 357,574.53RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 357,574.53RD$
21 357,574.53RD$ -RD$ -RD$ 357,574.53RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 357,574.53RD$
22 357,574.53RD$ -RD$ -RD$ 357,574.53RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 357,574.53RD$
23 357,574.53RD$ -RD$ -RD$ 357,574.53RD$ 14 12,758.53RD$ -RD$ -RD$ -RD$ 12,758.53RD$ 344,816.00RD$
24 344,816.00RD$ -RD$ -RD$ 344,816.00RD$ 13 -RD$ 22,852.73RD$ -RD$ -RD$ 22,852.73RD$ 321,963.26RD$
25 321,963.26RD$ -RD$ -RD$ 321,963.26RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 321,963.26RD$
26 321,963.26RD$ -RD$ -RD$ 321,963.26RD$ 16 2,453.07RD$ -RD$ -RD$ -RD$ 2,453.07RD$ 319,510.19RD$
27 319,510.19RD$ -RD$ -RD$ 319,510.19RD$ 14 -RD$ 12,758.53RD$ -RD$ -RD$
15 -RD$ 19,723.27RD$ -RD$ -RD$
19 34,953.87RD$ -RD$ -RD$ -RD$
20 21,440.00RD$ -RD$ -RD$ -RD$ 88,875.67RD$ 230,634.53RD$
28 230,634.53RD$ -RD$ -RD$ 230,634.53RD$ 16 -RD$ 2,453.07RD$ -RD$ -RD$ 2,453.07RD$ 228,181.46RD$
29 228,181.46RD$ -RD$ -RD$ 228,181.46RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 228,181.46RD$
30 228,181.46RD$ -RD$ -RD$ 228,181.46RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 228,181.46RD$
31 228,181.46RD$ -RD$ -RD$ 228,181.46RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 228,181.46RD$
32 228,181.46RD$ -RD$ -RD$ 228,181.46RD$ 22 2,080.00RD$ -RD$ -RD$ -RD$
23 59,968.62RD$ -RD$ -RD$ -RD$ 62,048.62RD$ 166,132.84RD$
33 166,132.84RD$ 102,041.26RD$ -RD$ 268,174.10RD$ 17 -RD$ 34,404.45RD$ -RD$ -RD$
18 -RD$ 30,393.60RD$ -RD$ -RD$
19 -RD$ 34,953.87RD$ -RD$ -RD$
21 11,302.61RD$ -RD$ -RD$ -RD$ 111,054.54RD$ 157,119.56RD$
34 157,119.56RD$ -RD$ -RD$ 157,119.56RD$ 20 -RD$ 21,440.00RD$ -RD$ -RD$ 21,440.00RD$ 135,679.56RD$
35 135,679.56RD$ -RD$ -RD$ 135,679.56RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 135,679.56RD$
36 135,679.56RD$ -RD$ -RD$ 135,679.56RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 135,679.56RD$
37 135,679.56RD$ -RD$ -RD$ 135,679.56RD$ 22 -RD$ 2,080.00RD$ -RD$ -RD$ 2,080.00RD$ 133,599.56RD$
38 133,599.56RD$ -RD$ -RD$ 133,599.56RD$ 24 18,878.53RD$ -RD$ -RD$ -RD$
25 9,204.16RD$ -RD$ -RD$ -RD$ 28,082.70RD$ 105,516.86RD$
39 105,516.86RD$ -RD$ -RD$ 105,516.86RD$ 23 -RD$ 59,968.62RD$ -RD$ -RD$ 59,968.62RD$ 45,548.24RD$
40 45,548.24RD$ -RD$ -RD$ 45,548.24RD$ 21 -RD$ 11,302.61RD$ -RD$ -RD$ 11,302.61RD$ 34,245.63RD$
41 34,245.63RD$ -RD$ -RD$ 34,245.63RD$ 26 960.00RD$ -RD$ -RD$ -RD$ 960.00RD$ 33,285.63RD$
42 33,285.63RD$ -RD$ -RD$ 33,285.63RD$ 24 -RD$ 18,878.53RD$ -RD$ -RD$
25 -RD$ 9,204.16RD$ -RD$ -RD$ 28,082.70RD$ 5,202.93RD$
43 5,202.93RD$ -RD$ -RD$ 5,202.93RD$ 26 -RD$ 960.00RD$ -RD$ -RD$ 960.00RD$ 4,242.93RD$
Σ 1,020,412.62RD$ -RD$ 1,020,412.62RD$ 508,084.84RD$ 508,084.84RD$ -RD$ -RD$ 1,016,169.69RD$ 4,242.93RD$
2. Deberá pagarse 50% del monto a los proveedores un día antes de inicio de la actividad, y el 50% restante una vez finalizada la
actividad.
ESTADO DE FLUJO DE CAJA
CONSTRUCCION DE VIVIENDA ECONOMICA 62 M2
A
-1 0 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32 33 34 35 36 37 38 39 40 41 42 43
1 2,579.20 2,579.20
2 960.00 960.00
3 3,840.00 3,840.00
4 5,428.74 5,428.74
5 13,606.12 13,606.12
6 40,238.69 40,238.69
7 21,798.88 21,798.88
8 60,484.21 60,484.21
9 2,916.86RD$ 2,916.86
10 32,357.55 32,357.55
11 39,068.94 39,068.94
12 3,432.19 3,432.19
13 22,852.73 22,852.73
14 12,758.53 12,758.53
15 19,723.27 19,723.27
16 30,393.60 4,574.53 4,574.53
17 34,404.45 34,404.45
18 30,393.60
19 34,953.87 34,953.87
20 21,440.00 21,440.00
21 11,302.61 11,302.61
22 2,080.00 2,080.00
23 59,968.62 59,968.62
24 18,878.53 18,878.53
25 9,204.16 9,204.16
26 960.00 960.00
Equipos
Costo Fijo
Total 7,379.20 19,034.86 3,539.20 3,840.00 45,667.43 35,405.00 40,238.69 0.00 94,888.66 21,798.88 0.00 0.00 0.00 85,391.28 60,484.21 0.00 39,068.94 35,789.74 41,985.80 22,852.73 3,432.19 0.00 0.00 0.00 12,758.53 22,852.73 0.00 4,574.53 88,875.67 4,574.53 0.00 0.00 0.00 62,048.62 111,054.53 21,440.00 0.00 0.00 2,080.00 28,082.69 59,968.62 11,302.61 960.00 28,082.69 960.00
Nota:
El costo de los gastos fijos estan incluidos en las actividades.
DIAS
PRESUPUESTO Y PROGRAMACION DE EGRESOS
CONSTRUCCION DE VIVIENDA 62M2
PERIODO= 5 días del Proyecto
Día Gasto Diario Dotación
-1 7,379.20RD$
0 19,034.86RD$
1 3,539.20RD$
2 3,840.00RD$
3 45,667.43RD$
4 35,405.00RD$
5 40,238.69RD$ 155,104.38RD$
6 -RD$
7 94,888.66RD$
8 21,798.88RD$
9 -RD$
10 -RD$ 116,687.54RD$
11 -RD$
12 85,391.28RD$
13 60,484.21RD$
14 -RD$
15 39,068.94RD$ 184,944.43RD$
16 35,789.74RD$
17 41,985.80RD$
18 22,852.73RD$
19 3,432.19RD$
20 -RD$ 104,060.47RD$
21 -RD$
22 -RD$
23 12,758.53RD$
24 22,852.73RD$
25 -RD$ 35,611.26RD$
26 4,574.53RD$
27 88,875.67RD$
28 4,574.53RD$
29 -RD$
30 -RD$ 98,024.73RD$
31 -RD$
32 62,048.62RD$
33 111,054.53RD$
34 21,440.00RD$
35 -RD$ 194,543.15RD$
36 -RD$
37 2,080.00RD$
38 28,082.69RD$
39 59,968.62RD$
40 11,302.61RD$ 101,433.92RD$
41 960.00RD$
42 28,082.69RD$
43 960.00RD$ 30,002.69RD$
Σ 1,020,412.57
DOTACION DE GASTOS
No. Actividad Descripción Antecedentes Secuencias Duración
1 Replanteos casa
Consta del confeccionado de la charrancha,
marcar las zapatas de muros y columnas.
- 5 1
2
Conexiones
temporales
Poner en funcionamiento los servicios de
agua, luz y aguas negras. - 4
1
3
Habilitar área
almacén
materiales
Delimitar el area donde se construira el
almacen y construirlo.
- -
2
4
Excavaciones de
zapatas muros
bloques y
columnas
Excavacion a mano de las zapatas de muros
y columnas
2 -
2
5
Acero para zapatas
de muros y
columnas y para
columnas de carga
Armado y colocacion de acero para las
zapatas del muros y columnas.
1 6 3
6
Ligado y vaciado
Hormigón Fc=210
kg/cm2 para
zapatas de muros y
columnas
Ligado del hormigon con su especificacion
f´c= 210 kg/cm2 en trompo y vaciado en las
diferentes zapatas de muros y columnas.
5 7 1
7
Colocación de
bloques BNP de
0.15 y 0.10 mts
Postura de bloques de hormigon bajo nivel
de piso con todos lo huecos del bloque
relleno de hormigon simple.
6 8, 17, 18. 3
8
Colocación de
bloques SNP de
0.15 y 0.10 mts
Postura de bloques sobre nivel de piso, con
las especificaciones en planos.
7 9, 10, 15. 4 LIMITACION POR M.O. POR ACTIVIDAD 9
9
Construcion de
registro sanitario y
registro trampa de
grasa
Excavacion y construccion de registro
sanitarios y trampa de grasa.
8 - 5 LIMITACION POR M.O. POR ACTIVIDAD 8
10
Acero para dintel,
losa y vigas
Armado y colocacion de acero para dinteles,
losa y vigas con las especificaciones que
demandan los planos.
8 11
3
11
Ligado y vaciado
Hormigón Fc=210
kg/cm2 para
dintel, losa y vigas
Ligado del hormigon con su especificacion
f´c= 210 kg/cm2 en trompo y vaciado en los
dinteles, losa y viga.
10 12 1
12
Colocación de
bloques antepecho
de 0.15 mts
Postura de bloques en antepecho con
bloques de 0.15mtrs. Con las
especificaciones que demandan los planos.
11 13 2
13
Fino , zabaletas y
impermeabilizante
Ligado y vaciado de mortero para el fino y
sabaleta, curado del hormigos y luego
colocacion del impermeabilizante.
12 14
5
14
Pañete exterior y
antepecho
Pañete de los muros exteriores y antepecho. 13 - 3
15
Encofrado para
dintel, losa y vigas
Preparacion del encofrado para la losa,
dintel y vigas.
8 16 14
16
Fraguache interior,
exterior y techo +
techo galeria
Fraguache en muros interiore y exteriores,
techo y galeria.
15 19, 20.
2
17
Suministro e
instalacion de
accesorios
electricos
Compra y colocacion de instalaciones
electricas con sus accesorios
correspondientes.
7 - 25
18
Suministro e
instalacion de
accesorios
sanitarios
Compra y colocacion de instalaciones
sanitarias con sus accesorios
correspondientes.
7 22
25
19
Pañete interior, en
techo y mochetas
Pañete de los muros interiores junto al
pañete de mochetas.
16 23
5
20 Portaje Colocacion de puertas. 16 21 6
21 Ventanas Colocacion de ventanas. 20 - 6 LIMITACION DE RECURSOS ACTIVIDAD 22
22 Jardineria en patio
Construccion de la jardineria exterior y
colocacion de piezas de gramaquin. 18 -
4
LIMITACION DE RECURSOS ACTIVIDAD 21
23
Torta de piso,
porcelanato en 1er
nivel, zocalos,
pisos de baños y
revestimientos de
baños y cocina
Vaciado con hormigon armado en ligadora,
curado del hormigon, colocacion de pisos,
colocacion de ceramica y colocacion de
zocalos.
19 24, 25. 6
24
Pintura acrilica
interior y exterior
Pintura para los muros exteriores,
antepecho, techo, muros interiores, vigas y
columnas.
23 - 3
25
Cocina (gabinetes
de piso, pared y
topes de cocina en
granito)
Colocacion de tope de granito, construccion
y colocacion de ganitenes de piso para la
cocina.
23 26
3
26 Limpieza final
Limppieza final y correccion de algun detalle
faltante.
25 - 1
LIMITACIONES
CONSTRUCCION DE CASA ( 62,0 MT2 )
Limitaciones
Actividades Recurso Adicional Costo Adicional
Fraguache interior, exterior y techo + techo galeria 2 AYUDANTES 4,242.93
4,242.93
RECURSOS ADICIONALES
1 2 3 4 6 8 9
ING MAE O A T P PV
Replanteos casa X X Hilo, Nivel, etc 700.00
Conexiones temporales X Materiales y Herramientas 300.00
Habilitar área almacén materiales X Materiales y Herramientas 12000.00
Excavaciones de zapatas muros bloques y columnas X X Pico y pala 2450.00
Acero para zapatas de muros y columnas y para columnas de carga X disco de corte, alambre, etc 1500.00
Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas X Ligadoras y herramientas menores 10000.00
Colocación de bloques BNP de 0.15 y 0.10 mts X Hilo, Nivel, etc 700.00
Colocación de bloques SNP de 0.15 y 0.10 mts X Hilo, Nivel, etc 700.00
Construcion de registro sanitario y registro trampa de grasa X X Herramientas menores 1375.00
Acero para dintel, losa y vigas X X disco de corte, alambre, etc 1500.00
Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas X X Ligadoras y herramientas menores 10000.00
Colocación de bloques antepecho de 0.15 mts X X herramientas 9000.00
Fino , zabaletas y impermeabilizante X X X X herramientas 500.00
Pañete exterior y antepecho X X Herramientas 525.00
Encofrado para dintel, losa y vigas X X madera y herramientas 600.00
Fraguache interior, exterior y techo + techo galeria X X madera y herramientas 500.00
Suministro e instalacion de accesorios electricos X accesorios electricos 420.00
Suministro e instalacion de accesorios sanitarios X accesorios sanitarios 530.00
Pañete interior, en techo y mochetas X X X herramientas 800.00
Portaje X herramientas para puertas 2000.00
Ventanas X herramientas para ventanas 1200.00
Jardineria en patio X - -
Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina X X herramientas 8000.00
Pintura acrilica interior y exterior X Pintura y Herramientas Menores 15000.00
Cocina (gabinetes de piso, pared y topes de cocina en granito) X Herramientas 9000.00
Limpieza general continua y final X Herramientas menores 1500.00
INGENIERO ING
MAESTRO MAE
OPERADOR O
ALBANIL A
TERMINADOR T
PINTURA P
PUERTAS Y VENTANAS PV
Actividades Materiales y Equipos Costo Directo
DISTRIBUCION DE RECURSOS
Dia Lunes 4 Martes 5 Miercoles 6 Jueves 7 Viernes8
1 2 3 4 6
Dia Lunes 11 Martes 12 Miercoles 13 Jueves 14 Viernes 15
7 8 9 10 11
Dia Lunes 18 Martes 19 Miercoles 20 Jueves 21 Viernes 22
12 13 14 15 16
Dia Lunes 25 Martes 26 Miercoles 27 Jueves 28 Viernes 29
17 18 19 20 21
Dia Lunes 1 Martes 2 Miercoles 3 Jueves 4 Viernes 5
22 23 24 25 26
Dia Lunes 8 Martes 9 Miercoles 10 Jueves 11 Viernes 12
27 28 29 30 31
Dia Lunes 15 Martes 16 Miercoles 17 Jueves 18 Viernes 19
32 33 34 35 36
Dia Lunes 22 Martes 23 Miercoles 24 Jueves 25 Viernes 26
37 38 39 40 41
Dia Lunes 29 Martes 30
42 43
CALENDARIZACION : Mayo-Junio
No. Actividades 01/05/2015 -15/05/2015 16/05/2015 -29/01/2015 01/06/2015 -15/06/2015 16/06/2015 -30/06/2015
1 Replanteos casa RD$5,158.40
2 Conexiones temporales RD$1,920.00
3 Habilitar área almacén materiales RD$7,680.00
4 Excavaciones de zapatas muros bloques y columnas RD$10,857.47
5 Acero para zapatas de muros y columnas y para columnas de carga RD$27,212.24
6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas RD$80,477.38
7 Colocación de bloques BNP de 0.15 y 0.10 mts RD$43,597.76
8 Colocación de bloques SNP de 0.15 y 0.10 mts RD$120,968.43
9 Construcion de registro sanitario y registro trampa de grasa RD$5,833.73
10 Acero para dintel, losa y vigas RD$64,715.10
11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas RD$78,137.87
12 Colocación de bloques antepecho de 0.15 mts RD$6,864.38
13 Fino , zabaletas y impermeabilizante RD$45,705.47
14 Pañete exterior y antepecho RD$25,517.06
15 Encofrado para dintel, losa y vigas RD$39,446.53
16 Fraguache interior, exterior y techo + techo galeria RD$9,983.36
17 Suministro e instalacion de accesorios electricos RD$68,808.91
18 Suministro e instalacion de accesorios sanitarios RD$60,787.20
19 Pañete interior, en techo y mochetas RD$69,907.75
20 Portaje RD$42,880.00
21 Ventanas RD$22,605.23
22 Jardineria en patio RD$4,160.00
23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina RD$119,937.24
24 Pintura acrilica interior y exterior RD$37,757.07
25 Cocina (gabinetes de piso, pared y topes de cocina en granito) RD$18,408.33
26 Limpieza general continua y final RD$1,920.00
Desembolsos
D a avance resto e transc necesario disp faltante d usada disp o neces faltante m e-o resto costo
1 Replanteos casa 1 0 1 1 0 0 0 0 0 0 1 0 0 0 0 0 0
2 Acero para zapatas de muros y columnas y para columnas de carga 0.33 0.67 3 1 2.01 2 0.01 0 0 0 2 1.34 0 15420.27195 1 0.67 10331.58221
3 Acero para zapatas de muros y columnas y para columnas de carga 0.66 0.34 3 2 1.02 1 0.02 0 0 0 2 0.68 0 15420.27195 1 0.34 5242.892464
4 Acero para zapatas de muros y columnas y para columnas de carga 1 0 3 3 0 0 0 0 0 0 2 0 0 15420.27195 1 0 0
5 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1 0 1 1 0 0 0 0 0 0 1 0 0 0 0 0 0
6 Colocación de bloques BNP de 0.15 y 0.10 mts 0.33 0.67 3 1 2.01 2 0.01 0 0 0 2 1.34 0 24705.39853 1 0.67 16552.61701
7 Colocación de bloques BNP de 0.15 y 0.10 mts 0.66 0.34 3 2 1.02 1 0.02 0 0 0 2 0.68 0 24705.39853 1 0.34 8399.8355
8 Colocación de bloques BNP de 0.15 y 0.10 mts 1 0 3 3 0 0 0 0 0 0 2 0 0 24705.39853 1 0 0
9 Colocación de bloques SNP de 0.15 y 0.10 mts 0.2 0.8 5 1 4 4 0 0 0 0 3 2.4 0 77117.37236 2 0.8 123387.7958
10 Colocación de bloques SNP de 0.15 y 0.10 mts 0.4 0.6 5 2 3 3 0 0 0 0 3 1.8 0 77117.37236 2 0.6 92540.84683
11 Colocación de bloques SNP de 0.15 y 0.10 mts 0.6 0.4 5 3 2 2 0 0 0 0 3 1.2 0 77117.37236 2 0.4 61693.89789
12 Colocación de bloques SNP de 0.15 y 0.10 mts 0.8 0.2 5 4 1 1 0 0 0 0 3 0.6 0 77117.37236 2 0.2 30846.94894
13 Colocación de bloques SNP de 0.15 y 0.10 mts 1 0 5 5 0 0 0 0 0 0 3 0 0 77117.37236 2 0 0
14 Encofrado para dintel, losa y vigas 0.07 0.93 14 1 13.02 13 0.02 0 0 0 13 12.09 0 31134.58289 1 0.93 28955.16209
15 Encofrado para dintel, losa y vigas 0.14 0.86 14 2 12.04 12 0.04 0 0 0 13 11.18 0 31134.58289 1 0.86 26775.74129
16 Encofrado para dintel, losa y vigas 0.21 0.79 14 3 11.06 11 0.06 0 0 0 13 10.27 0 31134.58289 1 0.79 24596.32049
17 Encofrado para dintel, losa y vigas 0.28 0.72 14 4 10.08 10 0.08 0 0 0 13 9.36 0 31134.58289 1 0.72 22416.89968
18 Encofrado para dintel, losa y vigas 0.35 0.65 14 5 9.1 9 0.1 0 0 0 13 8.45 0 31134.58289 1 0.65 20237.47888
19 Encofrado para dintel, losa y vigas 0.42 0.58 14 6 8.12 8 0.12 0 0 0 13 7.54 0 31134.58289 1 0.58 18058.05808
20 Encofrado para dintel, losa y vigas 0.49 0.51 14 7 7.14 7 0.14 0 0 0 13 6.63 0 31134.58289 1 0.51 15878.63728
21 Encofrado para dintel, losa y vigas 0.56 0.44 14 8 6.16 6 0.16 0 0 0 13 5.72 0 31134.58289 1 0.44 13699.21647
22 Encofrado para dintel, losa y vigas 0.63 0.37 14 9 5.18 5 0.18 0 0 0 13 4.81 0 31134.58289 1 0.37 11519.79567
23 Encofrado para dintel, losa y vigas 0.7 0.3 14 10 4.2 4 0.2 0 0 0 13 3.9 0 31134.58289 1 0.3 9340.374868
24 Encofrado para dintel, losa y vigas 0.77 0.23 14 11 3.22 3 0.22 0 0 0 13 2.99 0 31134.58289 1 0.23 7160.954066
25 Encofrado para dintel, losa y vigas 0.84 0.16 14 12 2.24 2 0.24 0 0 0 13 2.08 0.24 31134.58289 1 0.16 4981.533263
26 Encofrado para dintel, losa y vigas 0.91 0.09 14 13 1.26 1 0.26 0 0 0 13 1.17 0.26 31134.58289 1 0.09 2802.11246
27 Encofrado para dintel, losa y vigas 1 0 14 14 0 0 0 0 0 0 13 0 0 31134.58289 1 0 0
28 Fraguache interior, exterior y techo + techo galeria 1 0 1 1 0 0 0 0 0 0 1 0 0 4242.928 0 0 0
29 Pañete interior, en techo y mochetas 0.2 0.8 5 1 4 4 0 0 0 0 4 3.2 0 47537.26723 1 0.8 38029.81378
30 Pañete interior, en techo y mochetas 0.4 0.6 5 2 3 3 0 0 0 0 4 2.4 0 47537.26723 1 0.6 28522.36034
31 Pañete interior, en techo y mochetas 0.6 0.4 5 3 2 2 0 0 0 0 4 1.6 0 47537.26723 1 0.4 19014.90689
32 Pañete interior, en techo y mochetas 0.8 0.2 5 4 1 1 0 0 0 0 4 0.8 0 47537.26723 1 0.2 9507.453446
33 Pañete interior, en techo y mochetas 1 0 5 5 0 0 0 0 0 0 4 0 0 47537.26723 1 0 0
34 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.17 0.83 6 1 4.98 5 -0.02 0 0 0 5 4.15 0 84955.54523 1 0.83 70513.10254
35 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.34 0.66 6 2 3.96 4 -0.04 0 0 0 5 3.3 0 84955.54523 1 0.66 56070.65985
36 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.51 0.49 6 3 2.94 3 -0.06 0 0 0 5 2.45 0 84955.54523 1 0.49 41628.21716
37 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.68 0.32 6 4 1.92 2 -0.08 0 0 0 5 1.6 0 84955.54523 1 0.32 27185.77447
38 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.85 0.15 6 5 0.9 1 -0.1 0 0 0 5 0.75 0 84955.54523 1 0.15 12743.33178
39 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 1 0 6 6 0 0 0 0 0 0 5 0 0 84955.54523 1 0 0
40 Cocina (gabinetes de piso, pared y topes de cocina en granito) 0.33 0.67 3 1 2.01 2 0.01 0 0 0 2 1.34 0 10431.38423 1 0.67 6989.027437
41 Cocina (gabinetes de piso, pared y topes de cocina en granito) 0.66 0.34 3 2 1.02 1 0.02 0 0 0 2 0.68 0 10431.38423 1 0.34 3546.67064
42 Cocina (gabinetes de piso, pared y topes de cocina en granito) 1 0 3 3 0 0 0 0 0 0 2 0 0 10431.38423 1 0 0
43 Limpieza general continua y final ( incluye bote de escombros ) 1 0 1 1 0 0 0 0 0 0 1 0 0 0 0 0 0
Proceso A
% Tiempo Holgura Total a ejecucion
D a avance resto e transc necesario disp faltante d usada disp o neces faltante m e-o resto costo
1 Conexiones temporales 1 0 1 1 0 0 0 1 0 1 1 0 0 0 0 0 0
2 Excavaciones de zapatas muros bloques y columnas 0.5 0.5 2 1 1 1 0 1 0 1 1 0.5 0 4614.4256 1 0.5 2307.2128
3 Excavaciones de zapatas muros bloques y columnas 1 0 2 2 0 0 0 1 0 1 1 0 0 4614.4256 1 0 0
4 Actividad ficticia 1 0 1 1 0 0 0 0 0 0 0 0 0 0 1 0 0
5 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1 0 1 1 0 0 0 0 0 0 1 0 0 0 0 0 0
6 Colocación de bloques BNP de 0.15 y 0.10 mts 0.33 0.67 3 1 2.01 2 0.01 0 0 0 2 1.34 0 24705.39853 1 0.67 16552.61701
7 Colocación de bloques BNP de 0.15 y 0.10 mts 0.66 0.34 3 2 1.02 1 0.02 0 0 0 2 0.68 0 24705.39853 1 0.34 8399.8355
8 Colocación de bloques BNP de 0.15 y 0.10 mts 1 0 3 3 0 0 0 0 0 0 2 0 0 24705.39853 1 0 0
9 Suministro e instalacion de accesorios sanitarios 0.04 0.96 25 1 24 24 0 6 0 6 24 23.04 0 49602.3552 1 0.96 47618.26099
10 Suministro e instalacion de accesorios sanitarios 0.08 0.92 25 2 23 23 0 6 0 6 24 22.08 0 49602.3552 1 0.92 45634.16678
11 Suministro e instalacion de accesorios sanitarios 0.12 0.88 25 3 22 22 0 6 0 6 24 21.12 0 49602.3552 1 0.88 43650.07258
12 Suministro e instalacion de accesorios sanitarios 0.16 0.84 25 4 21 21 0 6 0 6 24 20.16 0 49602.3552 1 0.84 41665.97837
13 Suministro e instalacion de accesorios sanitarios 0.2 0.8 25 5 20 20 0 6 0 6 24 19.2 0 49602.3552 1 0.8 39681.88416
14 Suministro e instalacion de accesorios sanitarios 0.24 0.76 25 6 19 19 0 6 0 6 24 18.24 0 49602.3552 1 0.76 37697.78995
15 Suministro e instalacion de accesorios sanitarios 0.28 0.72 25 7 18 18 0 6 0 6 24 17.28 0 49602.3552 1 0.72 35713.69574
16 Suministro e instalacion de accesorios sanitarios 0.32 0.68 25 8 17 17 0 6 0 6 24 16.32 0 49602.3552 1 0.68 33729.60154
17 Suministro e instalacion de accesorios sanitarios 0.36 0.64 25 9 16 16 0 6 0 6 24 15.36 0 49602.3552 1 0.64 31745.50733
18 Suministro e instalacion de accesorios sanitarios 0.4 0.6 25 10 15 15 0 6 0 6 24 14.4 0 49602.3552 1 0.6 29761.41312
19 Suministro e instalacion de accesorios sanitarios 0.44 0.56 25 11 14 14 0 6 0 6 24 13.44 0 49602.3552 1 0.56 27777.31891
20 Suministro e instalacion de accesorios sanitarios 0.48 0.52 25 12 13 13 0 6 0 6 24 12.48 0 49602.3552 1 0.52 25793.2247
21 Suministro e instalacion de accesorios sanitarios 0.52 0.48 25 13 12 12 0 6 0 6 24 11.52 0 49602.3552 1 0.48 23809.1305
22 Suministro e instalacion de accesorios sanitarios 0.56 0.44 25 14 11 11 0 6 0 6 24 10.56 0 49602.3552 1 0.44 21825.03629
23 Suministro e instalacion de accesorios sanitarios 0.6 0.4 25 15 10 10 0 6 0 6 24 9.6 0 49602.3552 1 0.4 19840.94208
24 Suministro e instalacion de accesorios sanitarios 0.64 0.36 25 16 9 9 0 6 0 6 24 8.64 0 49602.3552 1 0.36 17856.84787
25 Suministro e instalacion de accesorios sanitarios 0.68 0.32 25 17 8 8 0 6 0 6 24 7.68 0 49602.3552 1 0.32 15872.75366
26 Suministro e instalacion de accesorios sanitarios 0.72 0.28 25 18 7 7 0 6 0 6 24 6.72 0 49602.3552 1 0.28 13888.65946
27 Suministro e instalacion de accesorios sanitarios 0.76 0.24 25 19 6 6 0 6 0 6 24 5.76 0 49602.3552 1 0.24 11904.56525
28 Suministro e instalacion de accesorios sanitarios 0.8 0.2 25 20 5 5 0 6 0 6 24 4.8 0 49602.3552 1 0.2 9920.47104
29 Suministro e instalacion de accesorios sanitarios 0.84 0.16 25 21 4 4 0 6 0 6 24 3.84 0 49602.3552 1 0.16 7936.376832
30 Suministro e instalacion de accesorios sanitarios 0.88 0.12 25 22 3 3 0 6 0 6 24 2.88 0 49602.3552 1 0.12 5952.282624
31 Suministro e instalacion de accesorios sanitarios 0.92 0.08 25 23 2 2 0 6 0 6 24 1.92 0 49602.3552 1 0.08 3968.188416
32 Suministro e instalacion de accesorios sanitarios 0.96 0.04 25 24 1 1 0 6 0 6 24 0.96 0 49602.3552 1 0.04 1984.094208
33 Suministro e instalacion de accesorios sanitarios 1 0 25 25 0 0 0 6 0 6 24 0 0 49602.3552 1 0 0
34 Jardineria en patio 0.25 0.75 4 1 3 3 0 6 0 6 3 2.25 0 2652 1 0.75 1989
35 Jardineria en patio 0.5 0.5 4 2 2 2 0 6 0 6 3 1.5 0 2652 1 0.5 1326
36 Jardineria en patio 0.75 0.25 4 3 1 1 0 6 0 6 3 0.75 0 2652 1 0.25 663
37 Jardineria en patio 1 0 4 4 0 0 0 6 0 6 3 0 0 2652 1 0 0
Proceso B
% Tiempo Holgura Total a ejecucion
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
1.000 Hormigón Armado en:
1.010 Zapata de muro Muros de 0.15m.
1.011 Hormigón Fc=210 kg/cm2. 1.050 m3 5,336.00 5,602.80
1.012 Ligado y vaciado. 1.050 m3 650.00 682.50
1.013 Acero f 3/8" 0.740 qq 2,100.00 1,554.00
1.014 Calzos 0.740 qq 2.40 1.78
1.015 M. O. Acero 0.740 qq 183.60 135.86
1.016 Alambre #18 1.480 lbs 42.00 62.16
1.017 Herramientas y equipos 1.000 m3 120.59 120.59 8,159.69
0.010 Zapata de muro Muros de 0.10m.
0.011 Hormigón Fc=210 kg/cm2. 1.050 m3 5,336.00 5,602.80
0.012 Ligado y vaciado. 1.050 m3 650.00 682.50
0.013 Acero f 3/8" 0.740 qq 2,400.00 1,776.00
0.014 Calzos 0.740 qq 2.40 1.78
0.015 M. O. Acero 0.740 qq 183.60 135.86
0.016 Alambre #18 1.480 lbs 42.00 62.16
0.017 Herramientas y equipos 1.000 m3 123.92 123.92 8,385.02
1.020 Zapatas de Columnas.
1.021 Hormigón Fc=210 kg/cm2. 1.050 m3 5,336.00 5,602.80
1.022 Ligado y vaciado. 1.050 m3 650.00 682.50
1.023 Acero f 3/8" qq -
1.024 Acero f 1/2" 0.354 qq 2,100.00 743.40
1.025 Acero f 3/4" qq -
1.026 Acero f 1" qq -
1.027 Calzos 0.354 qq 2.40 0.85
1.028 M. O. Acero 0.354 qq 183.60 64.99
1.029 Alambre #18 0.708 lbs 42.00 29.74
1.030 Herramientas y equipos 1.000 m3 106.86 106.86 7,231.14
1.030 Platea de Escaleras y Ascensor.
1.031 Hormigón Fc=210 kg/cm2. 1.050 m3 5,336.00 5,602.80
1.032 Ligado y vaciado. 1.050 m3 425.00 446.25
1.033 Acero f 3/4" 2.156 qq 1,504.94 3,244.65
1.034 Acero f 1" 1.515 qq 1,504.94 2,279.99
1.035 Calzos 3.671 qq 2.40 8.81
1.036 M. O. Acero 2.156 qq 183.60 395.84
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 93
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
1.037 Alambre #18 4.312 lbs 42.00 181.10
1.038 Herramientas y equipos 1.000 m3 182.39 182.39 12,341.83
1.040 Columnas C1 (0.30*0.40) mts. 5to al 8vo Nivel.
1.041 Hormigón industrial Fc=240 kg/cm2. 1.050 m3 5,742.00 6,029.10
1.042 Ligado y vaciado. 1.050 m3 425.00 446.25
1.043 Acero f 3/4" 4.500 qq 1,504.94 6,772.24
1.044 Acero f 3/8" 2.461 qq 1,504.94 3,703.66
1.045 M. O. Acero 6.961 qq 183.60 1,278.04
1.046 Alambre #18 13.922 lbs 42.00 584.72
1.047 Madera a todo costo. 8.333 ml 1,020.00 8,500.00
1.048 Herramientas y equipos 1.000 m3 409.71 409.71 27,723.72
1.050 Columnas C1 (0.15*0.20) mts.1ro al 2do Nivel.
1.051 Hormigón industrial Fc=240 kg/cm2. 1.050 m3 5,742.00 6,029.10
1.052 Ligado y vaciado. 1.050 m3 650.00 682.50
1.053 Acero f 1/2" 3.280 qq 2,100.00 6,888.00
1.054 Acero f 3/8" 1.765 qq 2,100.00 3,706.50
1.055 M. O. Acero 5.045 qq 183.60 926.26
1.056 Alambre #18 10.090 lbs 42.00 423.78
1.057 Madera a todo costo. 33.333 ml 200.00 6,666.67
1.058 Herramientas y equipos 1.000 m3 379.84 379.84 25,702.65
1.060 Columnas C3 (0.30*0.40) mts. 1ro al 4to Nivel.
1.061 Hormigón industrial Fc=240 kg/cm2. 1.050 m3 5,742.00 6,029.10
1.062 Ligado y vaciado. 1.050 m3 425.00 446.25
1.063 Acero f 1" 3.799 qq 1,504.94 5,717.27
1.064 Acero f 3/4" 2.134 qq 1,504.94 3,211.55
1.065 Acero f 3/8" 2.551 qq 1,504.94 3,839.11
1.066 M. O. Acero 8.484 qq 183.60 1,557.66
1.067 Alambre #18 16.968 lbs 42.00 712.66
1.068 Madera a todo costo. 3.125 ml 1,020.00 3,187.50
1.069 Herramientas y equipos 1.000 m3 370.52 370.52 25,071.62
1.070 Rampas de Escalera (h = 0.12 mts):
1.071 Hormigón Fc=210 kg/cm2. 1.050 m3 5,336.00 5,602.80
1.072 Ligado y vaciado. 1.050 m3 425.00 446.25
1.073 Acero f 3/8" 0.210 qq 1,504.94 316.04
1.074 Acero f 1/2" 4.270 qq 1,504.94 6,426.10
1.075 M. O. Acero 4.480 qq 300.00 1,344.00
1.076 Alambre #18 8.960 lbs 42.00 376.32
1.077 Madera a todo costo. 8.333 m2 400.00 3,333.33
1.078 Herramientas y equipos 1.000 m3 267.67 267.67 18,112.51
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 94
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
1.080 Vigas de amarre primer nivel de (0.15*0.30) mts.
1.081 Hormigón Fc=210 kg/cm2. 1.050 m3 5,742.00 6,029.10
1.082 Ligado y vaciado. 1.050 m3 425.00 446.25
1.083 Acero f 3/8" 1.751 qq 2,100.00 3,677.10
1.084 Acero f 1/2" 0.955 qq 2,100.00 2,005.50
1.085 M. O. Acero 2.706 qq 183.60 496.82
1.086 Alambre #18 5.412 lbs 42.00 227.30
1.087 Madera a todo costo. 12.500 ml 300.00 3,750.00
1.088 Herramientas y equipos 1.000 m3 249.48 249.48 16,881.55
1.090 Vigas amarre segundo nivel de (0.15*0.25) mts.
1.091 Hormigón Fc=210 kg/cm2. 1.050 m3 5,742.00 6,029.10
1.092 Ligado y vaciado. 1.050 m3 425.00 446.25
1.093 Acero f 3/8" 1.673 qq 1,504.94 2,517.77
1.094 M. O. Acero 1.673 qq 183.60 307.16
1.095 Alambre #18 3.346 lbs 42.00 140.53
1.096 Madera a todo costo. 8.333 ml 300.00 2,500.00
1.097 Herramientas y equipos 1.000 m3 179.11 179.11 12,119.92
1.100 Vigas V1- de (0.15*0.30) mts.
1.101 Hormigón Fc=210 kg/cm2. 1.050 m3 5,742.00 6,029.10
1.102 Ligado y vaciado. 1.050 m3 650.00 682.50
1.103 Acero f 3/8" 1.110 qq 2,100.00 2,331.00
1.104 Acero f 1/2" 0.820 qq 2,100.00 1,722.00
1.105 Acero f 3/4" qq 1,504.94 -
1.106 M. O. Acero 1.930 qq 183.60 354.35
1.107 Alambre #18 3.860 lbs 42.00 162.12
1.108 Madera a todo costo. 11.111 ml 300.00 3,333.33
1.109 Herramientas y equipos 1.000 m3 219.22 219.22 14,833.62
1.110 Dinteles de (0.15*0.20) mts.
1.111 Hormigón Fc=210 kg/cm2. 1.050 m3 3,587.88 3,767.27
1.112 Ligado y vaciado. 1.050 m3 650.00 682.50
1.113 Acero f 3/8" 3.420 qq 2,100.00 7,182.00
1.114 M. O. Acero 3.420 qq 183.60 627.91
1.115 Alambre #18 6.840 lbs 42.00 287.28
1.116 Madera a todo costo. 33.333 ml 170.00 5,666.67
1.117 Herramientas y equipos 1.000 m3 273.20 273.20 18,486.83
1.120 Losas de entrepiso (h = 0.15mts):
1.121 Hormigón Industrial Fc=210kg/cm2. 1.050 m3 5,336.00 5,602.80
1.122 Ligado y vaciado. 1.050 m3 425.00 446.25
1.123 Acero f 3/8" 1.600 qq 1,504.94 2,407.91
1.124 M. O. Acero 1.600 qq 183.60 293.76
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 95
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
1.125 Alambre #18 3.200 lbs 42.00 134.40
1.125 Madera a todo costo. 6.667 m2 200.00 1,333.33
1.126 Herramientas y equipos 1.000 m3 153.28 153.28 10,371.73
1.130 Losas de entrepiso (h = 0.12mts):
1.131 Hormigón Industrial Fc=210kg/cm2. 1.050 m3 5,336.00 5,602.80
1.132 Ligado y vaciado. 1.050 m3 650.00 682.50
1.133 Acero f 3/8" 1.510 qq 2,300.00 3,473.00
1.134 M. O. Acero 1.510 qq 183.60 277.24
1.135 Alambre #18 3.020 lbs 42.00 126.84
1.135 Madera a todo costo. 8.333 m2 250.00 2,083.33
1.136 Herramientas y equipos 1.000 m3 183.69 183.69 12,429.40
1.140 Losas de Techo (h = 0.12mts):
1.141 Hormigón Industrial Fc=210kg/cm2. 1.050 m3 5,336.00 5,602.80
1.142 Ligado y vaciado. 1.050 m3 425.00 446.25
1.143 Acero f 3/8" 1.410 qq 1,504.94 2,121.97
1.144 M. O. Acero 1.410 qq 183.60 258.88
1.145 Alambre #18 2.820 lbs 42.00 118.44
1.145 Madera a todo costo. 8.333 m2 250.00 2,083.33
1.146 Herramientas y equipos 1.000 m3 159.48 159.48 10,791.15
1.150 Losas de piso (h = 0.15mts):
1.151 Hormigón Industrial Fc=210kg/cm2. 1.050 m3 5,336.00 5,602.80
1.152 Ligado y vaciado. 1.050 m3 425.00 446.25
1.153 Acero f 3/8" 1.410 qq 1,504.94 2,121.97
1.154 M. O. Acero 1.410 qq 183.60 258.88
1.155 Alambre #18 2.820 lbs 42.00 118.44
1.155 Regla de madera 10.000 ml 40.00 400.00
1.156 Herramientas y equipos 1.000 m3 134.23 134.23 9,082.57
1.160 Losas Superior de Cisterna
1.161 Hormigón Fc=180kg/cm2. 1.050 m3 3,409.62 3,580.10
1.162 Ligado y vaciado. 1.050 m3 420.00 441.00
1.163 Acero f3/8" 1.200 qq 1,504.94 1,805.93
1.164 Calzos 1.200 qq 2.40 2.88
1.165 M. O. Acero 1.200 qq 183.60 220.32
1.166 Alambre #18 2.400 lbs 42.00 100.80
1.167 Madera a todo costo 6.667 m2 120.00 800.00
1.168 Herramientas y equipos 1.000 m3 104.27 104.27 7,055.30
1.170 Losas Fondo de Cisterna
1.171 Hormigón Fc=180kg/cm2. 1.050 m3 3,409.62 3,580.10
1.172 Ligado y vaciado. 1.050 m3 420.00 441.00
1.173 Acero f3/8" 1.300 qq 1,504.94 1,956.42
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 96
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
1.174 Calzos 1.300 qq 2.40 3.12
1.175 M. O. Acero 1.300 qq 183.60 238.68
1.176 Alambre #18 2.600 lbs 42.00 109.20
1.177 Herramientas y equipos 1.000 m3 94.93 94.93 6,423.45
1.180 Vigas de Cisterna y/o vigas de amarre.
1.181 Hormigón Fc=180kg/cm2. 1.050 m3 3,409.62 3,580.10
1.182 Ligado y vaciado. 1.050 m3 420.00 441.00
1.183 Acero f3/8" 1.901 qq 1,504.94 2,860.89
1.184 Acero f1/2" 1.620 qq 1,504.94 2,438.01
1.185 M. O. Acero 3.521 qq 183.60 646.46
1.186 Alambre #18 7.042 lbs 42.00 295.76
1.187 Madera a todo costo 16.667 ml 120.00 2,000.04
1.188 Herramientas y equipos 1.000 m3 183.93 183.93 12,446.19
1.190 Antepecho de Cisterna.
1.191 Hormigón Fc=180kg/cm2 1.050 m3 3,409.62 3,580.10
1.192 Ligado vaciado 1.050 m3 420.00 441.00
1.193 Acero f1/4" 3.140 qq 2,646.47 8,309.92
1.194 Acero f3/8" 1.680 qq 1,504.94 2,528.30
1.195 Acero f1/2" 3.000 qq 1,504.94 4,514.82
1.196 M. O. Acero 4.680 qq 183.60 859.25
1.197 Alambre #18 9.360 lbs 42.00 393.12
1.198 Madera a todo costo 50.000 ml 80.00 4,000.00
1.199 Herramientas y equipos 1.000 m3 369.40 369.40 24,995.91
1.200 Columnas y columnas de Amare de Cisterna.
1.201 Hormigón Fc=210kg/cm2 1.050 m3 3,409.62 3,580.10
1.202 Ligado vaciado 1.050 m3 420.00 441.00
1.203 Acero f3/8" 1.512 qq 1,504.94 2,275.47
1.204 Acero f1/2" 1.386 qq 1,504.94 2,085.85
1.205 M. O. Acero 2.898 qq 183.60 532.07
1.206 Alambre #18 5.796 lbs 42.00 243.43
1.207 Madera a todo costo 25.000 ml 120.00 3,000.00
1.208 Herramientas y equipos 1.000 m3 243.16 243.16 12,401.08
1.210 Losas de Caseta de Bomba.
1.211 Hormigón Fc=180kg/cm2. 1.050 m3 3,409.62 3,580.10
1.212 Ligado y vaciado. 1.050 m3 420.00 441.00
1.213 Acero f3/8" 1.180 qq 1,504.94 1,775.83
1.214 Calzos 1.180 qq 2.40 2.83
1.215 M. O. Acero 1.180 qq 183.60 216.65
1.216 Alambre #18 2.360 lbs 42.00 99.12
1.217 Madera a todo costo 10.000 m2 120.00 1,200.00
1.218 Herramientas y equipos 1.000 m3 109.73 109.73 7,425.26
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 97
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
1.220 Vigas de Caseta de Bomba.
1.221 Hormigón Fc=180kg/cm2. 1.050 m3 3,409.62 3,580.10
1.222 Ligado y vaciado. 1.050 m3 420.00 441.00
1.223 Acero f3/8" 1.900 qq 1,504.94 2,859.39
1.224 M. O. Acero 1.900 qq 183.60 348.84
1.225 Alambre #18 3.800 lbs 42.00 159.60
1.226 Madera a todo costo 16.667 ml 120.00 2,000.04
1.227 Herramientas y equipos 1.000 m3 140.83 140.83 9,529.80
2.000 Sub-Partidas:
2.010 Mezcla 1:3
2.011 Cemento gris 11.510 fds 300.00 3,453.00
2.012 Arena gruesa 1.000 m3 600.00 600.00
2.013 Agua 69.040 gls 0.50 34.52
2.014 Herramientas y equipos 1.000 m3 61.31 61.31 4,087.52
2.020 Mezcla 1:4
2.021 Cemento gris 9.110 fds 300.00 2,733.00
2.022 Arena gruesa 1.060 m3 600.00 636.00
2.023 Agua 68.160 gls 0.50 34.08
2.024 Herramientas y equipos 1.000 m3 51.05 51.05 3,454.13
2.030 Mezcla 1:5
2.031 Cemento gris 7.560 fds 300.00 2,268.00
2.032 Arena gruesa 1.091 m3 600.00 654.60
2.033 Agua 67.990 gls 0.50 34.00
2.034 Herramientas y equipos 1.000 m3 44.35 44.35 3,000.95
2.040 Mortero 1:1.5:5
2.041 Cemento gris 9.460 fds 300.00 2,838.00
2.042 Arena para pañetes 0.910 m3 700.00 637.00
2.043 Agua 45.240 gls 0.50 22.62
2.044 Cal 50 lbs 6.290 fds 240.12 1,510.35
2.045 Herramientas y equipos 1.000 m3 75.12 75.12 5,083.09
2.050 Hormigón F´c=140 kgs/cm2
2.051 Cemento gris 7.530 fds 300.00 2,259.00
2.052 Arena gruesa 0.524 m3 600.00 314.40
2.053 Grava 0.726 m3 750.00 544.50
2.054 Agua 54.650 gls 0.50 27.33
2.055 Herramientas y equipos 1.000 m3 47.18 47.18 3,192.41
2.060 Mezcla 1:2.5:4 kgs/cm2 ciclopeos
2.061 Cemento gris 6.680 fds 300.00 2,004.00
2.062 Arena gruesa 0.480 m3 600.00 288.00
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 98
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
2.063 Grava 0.770 m3 750.00 577.50
2.064 Agua 54.650 gls 0.50 27.33
2.065 Herramientas y equipos 1.000 m3 43.45 43.45 2,940.28
2.070 Hormigón F´c=180 kgs/cm2
2.071 Cemento gris 8.310 fds 300.00 2,493.00
2.072 Arena gruesa 0.512 m3 600.00 307.20
2.073 Grava 0.710 m3 750.00 532.50
2.074 Agua 53.060 gls 0.50 26.53
2.075 Herramientas y equipos 1.000 m3 50.39 50.39 3,409.62
2.080 Hormigón F´c=210 kgs/cm2
2.081 Cemento gris 8.940 fds 300.00 2,682.00
2.082 Arena gruesa 0.505 m3 600.00 303.00
2.083 Grava 0.699 m3 750.00 524.25
2.084 Agua 51.220 gls 0.50 25.61
2.085 Herramientas y equipos 1.000 m3 53.02 53.02 3,587.88
2.090 Relleno compactado:
2.091 Relleno de caliche 1.300 m3 250.00 325.00
2.092 Regado, nivelado y apisonado 1.000 m3 76.00 76.00
2.093 Herramientas y equipos 1.000 m2 6.02 6.02 407.02
2.100 Relleno de reposición con material de mina:
2.101 Relleno de caliche 1.300 m3 250.00 325.00
2.102 Regado y nivelado. 1.000 m3 40.00 40.00
2.103 Herramientas y equipos 1.000 m2 5.48 5.48 370.48
2.110 Suministo y regado de Grava:
2.111 Grava. 1.000 m3 750.00 750.00
2.112 Regado de grava. 1.000 m3 50.00 50.00
2.113 Herramientas y equipos. 1.000 m2 12.00 12.00 812.00
2.120 Suministo y regado de piedra:
2.121 Piedra 1.000 m3 400.00 400.00
2.122 Regado de piedra. 1.000 m3 50.00 50.00
2.123 Herramientas y equipos. 1.000 m2 6.75 6.75 456.75
2.130 Andamios Interiores
2.131 Madera de pino 0.182 p2 45.00 8.19
2.132 Colocacion de andamios int. 1.000 m2 7.80 7.80
2.133 Herramientas y equipos 1.000 m2 0.24 0.24 16.23
2.140 Andamios Exteriores
2.141 Madera de pino 1.150 p2 45.00 51.75
2.142 Clavos Corrientes 0.160 lbs 29.00 4.64
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 99
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
2.143 Clavos de acero 0.030 lbs 47.00 1.41
2.144 Colocacion de andamios ext. 11.410 p2 4.50 51.35
2.145 Herramientas y equipos 1.000 m2 1.64 1.64 110.79
3.000 Muros de Bloques:
3.010 De 0.10mts B.N.P.
3.011 Bloques de 0.10 mts 12.875 u 22.00 283.25
3.012 Acero f 3/8" 0.011 qq 2,646.47 29.11
3.013 Alambre #18 0.022 lbs 42.00 0.92
3.014 Mezcla 1:3 0.020 m3 4,087.52 81.75
3.015 Hormigón Fc=140 kgs/cm2 0.009 m3 3,192.41 28.73
3.016 Colocación de bloques de 0.10 mts 13.000 u 10.80 140.40
3.017 Llenado de huecos a 0.80 mts 13.000 u 0.82 10.61
3.018 Corte y amarre de acero a 0.80 mts 13.000 u 0.42 5.46
3.019 Herramientas y equipos 1.000 m2 8.70 8.70 588.93
3.020 De 0.15mts B.N.P.
3.021 Bloques de 0.15 mts 12.875 u 24.00 309.00
3.022 Acero f 3/8" 0.024 qq 1,504.94 36.12
3.023 Alambre #18 0.048 lbs 42.00 2.02
3.024 Mezcla 1:3 0.031 m3 4,087.52 126.71
3.025 Hormigón Fc=140 kgs/cm2 0.019 m3 3,192.41 60.66
3.026 Colocación de bloques de 0.15 mts 13.000 u 10.80 140.40
3.027 Llenado de huecos a 0.80 mts 13.000 u 0.82 10.61
3.028 Corte y amarre de acero a 0.80 mts 13.000 u 0.42 5.46
3.029 Herramientas y equipos 1.000 m2 10.36 10.36 701.34
3.030 De 0.20 B.N.P.
3.031 Bloques de 0.20 mts 12.875 u 30.00 386.25
3.032 Acero f 3/8" 0.037 qq 1,504.94 55.68
3.033 Acero f 1/2" y 3/8" de refuerzos 0.025 qq 1,504.94 37.62
3.034 Alambre #18 0.124 lbs 42.00 5.21
3.035 Mezcla 1:3 0.039 m3 4,087.52 159.41
3.036 Hormigón Fc=140 kgs/cm2 0.048 m3 3,192.41 153.24
3.037 Colocación de bloques de 0.20 mts 13.000 u 10.80 140.40
3.038 Llenado de huecos a 0.80 mts 13.000 u 0.82 10.61
3.039 Corte y amarre de acero a 0.80 mts 13.000 u 0.93 12.09
3.03A Herramientas y equipos 1.000 m2 14.41 14.41 974.92
3.040 De 0.15 mts B.N.P. con C/LL y f 3/8" a 0.40 mts.
3.041 Bloques de 0.15 mts 12.875 u 24.00 309.00
3.042 Acero f 3/8" 0.037 qq 1,504.94 55.68
3.043 Alambre #18 0.074 lbs 42.00 3.11
3.044 Mezcla 1:3 0.031 m3 4,087.52 126.71
3.045 Hormigón Fc=140 kgs/cm2 0.048 m3 3,192.41 153.24
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 100
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
3.046 Colocación de bloques de 0.15 mts 13.000 u 10.80 140.40
3.047 Llenado de huecos a 0.40 mts 13.000 u 1.66 21.53
3.048 Corte y amarre de acero a 0.40 mts 13.000 u 0.82 10.61
3.049 Herramientas y equipos 1.000 m2 12.30 12.30 832.58
3.050 De 0.20 mts B.N.P. con C/LL y f 3/8" a 0.40 mts.
3.051 Bloques de 0.20 mts 12.875 u 30.00 386.25
3.052 Acero f 3/8" 0.024 qq 1,504.94 36.12
3.053 Alambre #18 0.048 lbs 42.00 2.02
3.054 Mezcla 1:3 0.039 m3 4,087.52 159.41
3.055 Hormigón Fc=140 kgs/cm2 0.031 m3 3,192.41 98.96
3.056 Colocación de bloques de 0.20 mts 13.000 u 10.80 140.40
3.057 Llenado de huecos a 0.80 mts 13.000 u 1.66 21.53
3.058 Corte y amarre de acero a 0.80 mts 13.000 u 0.82 10.61
3.059 Herramientas y equipos 1.000 m2 12.83 12.83 868.13
3.060 De 0.10mts S.N.P.
3.061 Bloques de 0.10 mts 12.875 u 22.00 283.25
3.062 Acero f 1/4" 0.011 qq 2,646.47 29.11
3.063 Alambre #18 0.022 lbs 42.00 0.92
3.064 Mezcla 1:3 0.020 m3 4,087.52 81.75
3.065 Hormigón Fc=140 kgs/cm2 0.009 m3 3,192.41 28.73
3.066 Colocación de bloques de 0.10 mts 13.000 u 10.80 140.40
3.067 Llenado de huecos a 0.80 mts 13.000 u 0.82 10.61
3.068 Corte y amarre de acero a 0.80 mts 13.000 u 0.42 5.46
3.069 Andamios interiores 1.000 m2 16.23 16.23
3.06A Herramientas y equipos 1.000 m2 8.95 8.95 605.41
3.070 De 0.15mts S.N.P.
3.071 Bloques de 0.15mts 12.875 u 24.00 309.00
3.072 Acero f 3/8" 0.024 qq 1,504.94 36.12
3.073 Alambre #18 0.048 lbs 42.00 2.02
3.074 Mezcla 1:3 0.031 m3 4,087.52 126.71
3.075 Hormigón Fc=140 kgs/cm2 0.019 m3 3,192.41 60.66
3.076 Colocación de bloques de 0.15 mts 13.000 u 10.80 140.40
3.077 Llenado de huecos a 0.80 mts 13.000 u 0.82 10.61
3.078 Corte y amarre de acero a 0.80 mts 13.000 u 0.42 5.46
3.079 Andamios interiores 1.000 m2 16.23 16.23
3.07A Herramientas y equipos 1.000 m2 10.61 10.61 717.82
3.080 De 0.20 Mts. S.N.P.
3.081 Bloques de 0.15mts 12.875 u 30.00 386.25
3.082 Acero f 3/8" 0.037 qq 1,504.94 55.68
3.083 Acero f 1/2" y 3/8" de refuerzos 0.025 qq 1,504.94 37.62
3.084 Alambre #18 0.124 lbs 42.00 5.21
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 101
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
3.085 Mezcla 1:3 0.039 m3 4,087.52 159.41
3.086 Hormigón Fc=140 kgs/cm2 0.048 m3 3,192.41 153.24
3.087 Colocación de bloques de 0.15 mts 13.000 u 10.80 140.40
3.088 Llenado de huecos a 0.80 mts 13.000 u 0.82 10.61
3.089 Corte y amarre de acero a 0.80 mts 13.000 u 0.93 12.09
3.08A Andamios interiores 1.000 m2 16.23 16.23
3.08B Herramientas y equipos 1.000 m2 14.65 14.65 991.39
4.000 Terminacion de Superficies:
4.010 Pañete liso en muros interiores.
4.011 Madera de pino 0.033 p2 45.00 1.49
4.012 Mortero 1:1.5:5 0.022 m3 5,083.09 111.83
4.013 Andamios interiores 1.000 m2 16.23 16.23
4.014 Pañete en interior,en paredes
maestreado y a plomo 1.000 m2 73.97 73.97
4.015 Herramientas y equipos 1.000 m2 3.05 3.05 206.57
4.020 Pañete liso en muros exteriores.
4.021 Madera de pino 0.033 p2 45.00 1.49
4.022 Mortero 1:1.5:5 0.022 m3 5,083.09 111.83
4.023 Andamios interiores 1.000 m2 16.23 16.23
4.024 Pañete en exterior,en paredes
maestreado y a plomo 1.000 m2 94.13 94.13
4.025 Herramientas y equipos 1.000 m2 3.36 3.36 227.04
4.030 Pañete liso en superficie de hormigón
4.031 Madera de pino 0.033 p2 45.00 1.49
4.032 Mortero 1:1.5:5 0.022 m3 5,083.09 111.83
4.033 Andamios interiores 1.000 m2 16.23 16.23
4.034 Pañete en techos y vigas 1.000 m2 95.88 95.88
4.035 Herramientas y equipos 1.000 m2 3.38 3.38 228.81
4.040 Pañete Pulido
4.041 Madera de pino 0.033 p2 45.00 1.49
4.042 Mortero 1:1.5:5 0.020 m3 5,083.09 101.66
4.043 Andamios interiores 1.000 m2 16.23 16.23
4.044 Pañete pulido sin color 1.000 m2 80.70 80.70
4.045 Cemento Gris 0.053 fds 240.00 12.72
4.046 Herramientas y equipos 1.000 m2 3.19 3.19 215.99
4.050 Zabaleta de Piso:
4.051 Mezcla 1:3. 0.008 m3 4,087.52 32.70
4.052 Zabaleta en Piso: 1.000 ml 24.00 24.00
4.053 Herramientas y equipos 1.000 ml 0.85 0.85 57.55
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 102
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
4.060 Fino en Losa Superior:
4.061 Madera de pino 0.013 p2 45.00 0.59
4.062 Mortero 1:3 0.021 m3 4,087.52 85.84
4.063 Fino en septicos y cisternas 1.000 m2 42.00 42.00
4.064 Herramientas y equipos 1.000 ml 1.93 1.93 130.36
4.070 Violines:
4.071 Mortero 1:1.5:5 0.009 m3 5,083.09 45.75
4.072 Confección y colocación 1.000 m2 12.75 12.75
4.073 Herramientas y equipos 1.000 m2 0.88 0.88 59.38
4.080 Fraguache en superficie de hormigón
4.081 Escoba 0.010 u 10.00 0.10
4.082 Mezcla 1:5 0.008 m3 3,000.95 24.01
4.083 Fraguache con escoba 1.000 m2 11.11 11.11
4.084 Herramientas y equipos 1.000 m2 0.53 0.53 35.75
4.090 Cantos
4.091 Madera de pino 0.109 p2 45.00 4.91
4.092 Mortero 1:1.5:5 0.004 m3 5,083.09 20.33
4.093 Cantos en vigas, columnas y muros 1.000 ml 32.20 32.20
4.094 Herramientas y equipos 1.000 ml 0.86 0.86 58.30
5.000 Terminación de Pisos:
5.010 Piso de Porcelanato de Importada de 0.40*0.40 mts.
5.011 Piso de cerámica de importada 0.40*0.40 m. 1.100 m2 400.00 440.00
5.012 Derretido cemento blanco. 0.070 fda. 406.00 28.42
5.013 Estopa. 0.050 lb 52.00 2.60
5.014 Mezcla 1:4 0.032 m3 3,454.13 110.53
5.015 Colocación de pisos de cerámica. 1.000 m2 252.00 252.00
5.016 Corte de chazos de 0.40m. 3.000 u 7.38 22.14
5.017 Herramientas y equipos 1.000 m2 12.84 12.84 868.53
5.020 Piso de Cerámica de Alto de Tráfico 0.30*0.30 mts.
5.021 Piso de cerámica de alto tráfico 0.30*0.30 mts. 1.100 m2 450.00 495.00
5.022 Derretido cemento blanco. 0.070 fda. 406.00 28.42
5.023 Estopa. 0.050 lb 52.00 2.60
5.024 Mezcla 1:4 0.032 m3 3,454.13 110.53
5.025 Colocación de pisos de cerámica importada. 1.000 m2 252.00 252.00
5.026 Corte de chazos de 0.40m. 3.000 u 7.38 22.14
5.027 Herramientas y equipos 1.000 m2 13.66 13.66 924.35
5.030 Piso de Cerámica de 0.30*0.30 mts.
5.031 Piso de cerámica de 0.30*0.30 mts. 1.100 m2 350.00 385.00
5.032 Derretido cemento blanco. 0.070 fda. 406.00 28.42
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 103
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
5.033 Estopa. 0.050 lb 52.00 2.60
5.034 Mezcla 1:4 0.032 m3 3,454.13 110.53
5.035 Colocación de pisos de cerámica importada. 1.000 m2 252.00 252.00
5.036 Corte de chazos de 0.40m. 3.000 u 7.38 22.14
5.037 Herramientas y equipos 1.000 m2 12.01 12.01 812.70
5.040 Zócalos de Porcelanato de 0.10*0.40 m.
5.041 Zocalos de porcelanato de 0.10*0.33m. 1.050 ml. 110.00 115.50
5.042 Derretido cemento blanco. 0.022 fda. 406.00 8.93
5.043 Mezcla 1:4 0.002 m3 3,454.13 6.91
5.044 Colocacion de zocalos 1.000 ml. 37.32 37.32
5.045 Corte de chazos de 0.40m 1.000 u 7.38 7.38
5.046 Herramientas y equipos 1.000 ml. 2.64 2.64 178.68
5.050 Zócalos de Cerámica de Alto Trafico de 0.10*0.40 m.
5.051 Zocalos de cerámica de alto trafico de 0.10*0.33m. 1.050 ml. 80.00 84.00
5.052 Derretido cemento blanco. 0.022 fda. 406.00 8.93
5.053 Mezcla 1:4 0.002 m3 3,454.13 6.91
5.054 Colocacion de zocalos 1.000 ml. 37.32 37.32
5.055 Corte de chazos de 0.40m 1.000 u 7.38 7.38
5.056 Herramientas y equipos 1.000 ml. 2.17 2.17 146.71
5.060 Zócalos de Cerámica de Importada de 0.10*0.40 m.
5.061 Zocalos de cerámica de Importada de 0.10*0.33m. 1.050 ml. 35.00 36.75
5.062 Derretido cemento blanco. 0.022 fda. 406.00 8.93
5.063 Mezcla 1:4 0.002 m3 3,454.13 6.91
5.064 Colocacion de zocalos 1.000 ml. 37.32 37.32
5.065 Corte de chazos de 0.40m 1.000 u 7.38 7.38
5.066 Herramientas y equipos 1.000 ml. 1.46 1.46 98.75
5.050 Piso de Hormigón Frotado.
5.051 Madera de Pino 0.088 p2 45.00 3.96
5.052 Mezcla 1:3 0.020 m3 4,087.52 81.75
5.053 Hormigón F'c = 140 kg/cm2 0.080 m3 3,192.41 255.39
5.054 Piso de hormigón frotado e = 0.08 m 1.000 m2 75.00 75.00
5.055 Cantos en pisos 0.800 ml 20.00 16.00
5.056 Herramientas y equipos 1.000 m2 6.48 6.48 438.58
5.060 Piso de Hormigón estampado.
5.061 Madera de Pino 0.088 p2 45.00 3.96
5.062 Mezcla 1:3 0.020 m3 4,087.52 81.75
5.063 Hormigón F'c = 140 kg/cm2 0.080 m3 3,192.41 255.39
5.064 Piso de hormigón frotado e = 0.08 m 1.000 m2 100.00 100.00
5.065 Acero malla" de 2.3*2.3 a 0.10*0.10m 1.000 m2 100.00 100.00
5.066 Estampado en piso de cemento con color 1.000 m2 200.00 200.00
5.067 Cantos en pisos 0.800 ml 20.00 16.00
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 104
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
5.068 Herramientas y equipos 1.000 m2 11.36 11.36 768.46
6.000 Terminación de Escaleras:
6.010 Escalones Revestidos de Porcelanato
6.011 Derretido de cemento blanco 0.025 fda 406.00 10.15
6.012 Escalones de porcelanato. 1.000 ml 300.00 300.00
6.013 Mezcla 1:3 0.007 m3 4,087.52 28.61
6.014 Hormigón F´c=140 kgs/cm2 0.025 m3 3,192.41 79.81
6.015 Confección de escalones revestido de mezcla. 1.000 ml 120.76 120.76
6.016 Montura de escalones en escalera 1.000 ml 132.72 132.72
6.017 Limpieza de escalones 1.000 ml 72.00 72.00
6.018 Herramientas y equipos 1.000 ml. 11.16 11.16 755.21
6.020 Zócalos de porcelanato.
6.021 Derretido de cemento blanco 0.022 fda 406.00 8.93
6.022 Zócalos de porcelanato en escalones. 1.050 u 140.00 147.00
6.023 Mezcla 1:4 0.001 m3 3,454.13 3.45
6.024 Colocación de zócalos para escaleras. 1.000 u 65.86 65.86
6.025 Herramientas y equipos 1.000 ml. 3.38 3.38 228.62
7.000 Enchapes o Revestimientos:
7.010 Cerámica Importada de Pared 0.20x0.30mts.En baños principales y cocinas
7.011 Derretido de cemento blanco. 0.070 fda 406.00 28.42
7.012 Estopa 0.050 lb 52.00 2.60
7.013 Cerámica importada de pared de 0.20*0.30 m. 1.050 m2 350.00 367.50
7.014 Mortero 1:1.5:5 0.022 m3 5,083.09 111.83
7.015 Colocacion de azulejos 1.000 m2 213.26 213.26
7.016 Corte de losetas de cerámica 3.750 u 7.38 27.68
7.017 Herramientas y equipos 1.000 m2 11.27 11.27 762.56
7.020 Cerámica Importada de Pared 0.20x0.30mts.En baños de servicio.
7.021 Derretido de cemento blanco. 0.070 fda 406.00 28.42
7.022 Estopa 0.050 lb 52.00 2.60
7.023 Cerámica importada de pared de 0.20*0.30 m. 1.050 m2 280.00 294.00
7.024 Mortero 1:1.5:5 0.022 m3 5,083.09 111.83
7.025 Colocacion de azulejos 1.000 m2 213.26 213.26
7.026 Corte de losetas de cerámica 3.750 u 7.38 27.68
7.027 Herramientas y equipos 1.000 m2 10.17 10.17 687.96
7.030 Ladrillos de 2" x 4" x 8".
7.031 Ladrillos de 2" x 4" x 8". 50.000 u 20.00 1,000.00
7.032 Aceite de cocina. 0.005 gls 260.00 1.30
7.033 Mezcla 1:3 0.012 m3 4,087.52 49.05
7.034 Estopa. 0.050 lb 52.00 2.60
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 105
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
7.035 Corte de ladrillos. 0.071 u 3.50 0.25
7.036 Colocacion de ladrillos limpios a una cara. 50.000 u 6.15 307.50
7.037 Herramientas y equipos. 1.000 m2 20.41 20.41 1,381.11
8.000 Pinturas (Dos Manos):
8.010 Acrílica sobre muros.
8.011 Pintura acrílica preparada. 0.110 gl 430.00 47.30
8.012 Desperdicio y retoque de Pintura. 0.011 gl 430.00 4.73
8.013 Materiales diversos, 1.000 m2 8.63 8.63
8.014 Pintura de agua 1ra mano inc. masilla, lija y
piedra. 1.000 m2 16.80 16.80
8.015 Pintura de agua 2da mano. 1.000 m2 10.80 10.80
8.016 Herramientas y equipos 1.000 m2 1.32 1.32 89.58
8.020 Económica en Techos..
8.021 Pintura econónica. 0.110 gl 270.00 29.70
8.022 Desperdicio y retoque de Pintura. 0.011 gl 270.00 2.97
8.023 Materiales diversos, 1.000 m2 8.63 8.63
8.024 Pintura de agua 1ra mano inc. masilla, lija y
piedra. 1.000 m2 16.80 16.80
8.025 Pintura de agua 2da mano. 1.000 m2 10.80 10.80
8.026 Herramientas y equipos 1.000 m2 1.03 1.03 69.93
8.030 Económica Blanco 50 (Una Mano).
8.031 Pintura econónica. 0.055 gl 270.00 14.85
8.032 Desperdicio y retoque de Pintura. 0.006 gl 270.00 1.49
8.033 Materiales diversos, 1.000 m2 8.63 8.63
8.034 Pintura de agua 1ra mano inc. masilla, lija y
piedra. 1.000 m2 16.80 16.80
8.035 Herramientas y equipos 1.000 m2 0.63 0.63 42.40
9.000 Terminación de Techos:
9.010 Fino de mezcla en techo plano:
9.011 Madera de pino 0.013 p2 45.00 0.59
9.012 Mezcla 1:3 0.042 m3 4,087.52 171.68
9.013 Fino en techo 1.000 m2 75.86 75.86
9.014 Herramientas y equipos. 1.000 m2 3.72 3.72 251.85
9.020 Fino de mezcla en techo inclinado:
9.021 Madera de pino 0.013 p2 45.00 0.59
9.022 Mezcla 1:3 0.021 m3 4,087.52 85.84
9.023 Fino en techo 1.000 m2 43.62 43.62
9.024 Herramientas y equipos. 1.000 m2 1.95 1.95 132.00
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 106
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
9.030 Zabaletas de cemento
9.031 Mezcla 1:3 0.008 m3 4,087.52 32.70
9.032 Zabaletas en techo 1.000 ml 34.24 34.24
9.033 Herramientas y equipos. 1.000 ml 1.00 1.00 67.94
9.040 Teja en techo
9.041 Teja en techo 1.000 m2 620.00 620.00
9.041 Mezcla 1:3 0.008 m3 4,087.52 32.70
9.042 Mano de obra 1.000 m2 250.00 250.00
9.043 Herramientas y equipos. 1.000 ml 4.24 4.24 906.94
9.040 Desagües de Techo f 3" h = 13.00 m.
9.041 Parrilla de 3" 1.000 u 63.80 63.80
9.042 Cemento PVC 0.010 gls 1,102.00 11.02
9.043 Codo de drenaje 3 x 90° 2.000 u 47.56 95.12
9.044 Tubo de drenaje SDR-41 de 3"*20' 2.300 u 545.00 1,253.50
9.045 Instalacion de desagüe pluvial de 3" cuatro nivel. 1.000 u 1,200.00 1,200.00
9.046 Herramientas y equipos. 1.000 u 39.35 39.35 2,662.79
9.050 Antepecho de Muros de Bloques H = 1.00mts:
9.051 Muros de bloque de 0.15 mts 1.000 m2 701.34 701.34
9.052 Pañete liso sobre muros. 2.350 m2 206.57 485.44
9.053 Cantos en general. 2.000 ml 58.30 116.60
9.054 Pintura acrílica. 2.350 m2 89.58 210.51
9.055 Herramientas y equipos 1.000 PA 22.71 22.71 1,536.60
10.000 Varios.
10.010 Verja frontal de Muros de Bloques y hierro H = 2.60 mts:
10.011 Replanteo 165.000 ml 10.00 1,650.00
10.012 Muros de bloque de 0.15 mts 220.000 m2 701.34 154,294.80
10.013 Pañete liso sobre muros. 480.000 m2 206.57 99,153.60
10.014 Cantos en general. 330.000 ml 58.30 19,239.00
10.015 Pintura acrílica. 480.000 m2 89.58 42,998.40
10.016 Zapata de muros 18.560 m3 4,200.00 77,952.00
10.017 Viga de muros 6.600 m3 12,446.19 82,144.85
10.018 Columna de muros 5.040 m3 12,401.08 62,501.44
10.019 Puerta de hierro 6.000 ml 6,400.00 38,400.00
10.01A Puerta de hierro grande 32.000 ml 9,500.00 304,000.00
10.01B Hierro en verja 165.000 m2 1,600.00 264,000.00
10.01C Excavacion 37.130 m3 800.00 29,704.00
10.01D Reposicion 15.000 m3 91.20 1,368.00
10.01E Herramientas y equipos 1.000 PA 4,735.29 4,735.29 1,182,141.38
Costo/ml = 7,164.49
10.020 Acera perimetral incluye zabaleta perimetral..
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 107
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
10.021 Madera de pino 0.220 p2 36.00 7.92
10.022 Mezcla 1:3 0.021 m3 4,087.52 85.84
10.023 Hormigón 140 kg/cm 0.084 m3 3,192.41 268.16
10.024 Cantos 2.000 ml 32.20 64.39
10.025 Zabaleta de piso. 1.000 ml 57.55 57.55
10.026 Construcción de aceras 0.100 m3 354.00 35.40
10.027 Herramientas y equipos 1.000 m2 7.79 7.79 527.05
10.030 Parqueos
10.031 Preparacion de area 1.000 m2 15.00 15.00
10.032 Relleno de 0.20m 0.200 m3 407.02 81.40
10.033 hormigon estampado armado 1.000 m2 700.00 700.00
10.034 Herramientas y equipos 1.000 ml 11.95 11.95 808.35
11.000 Instalación Sanitaria:
11.010 Desagües de piso f 2"
11.011 Parrila de 2" 1.000 u 50.46 50.46
11.012 Adaptador macho de 2" 1.000 u 22.04 22.04
11.013 Sifón de 2" 1.000 u 110.20 110.20
11.014 Cemento PVC 0.014 gls 1,102.00 15.43
11.015 Instalación de desagüe de piso. 1.000 u 300.00 300.00
11.016 Herramientas y equipos 1.000 u 7.47 7.47 505.60
11.020 Columna de Agua Fría f 2 1/2" en un Nivel (H = 2.85 mts).
11.021 Tubo de presión f 2 1/2" 1.000 u 375.00 375.00
11.022 Codos f 2 1/2" 2.000 u 30.00 60.00
11.023 Cemento PVC 0.045 gls 1,102.00 49.59
11.024 Instalación de C. A. F. f 2 1/2" 1.000 u 600.00 600.00
11.025 Herramientas y equipos 1.000 u 16.27 16.27 1,100.86
10.042 Columna de Ventilación f 2" (h = 10 mts).
10.043 Tubo de drenaje f 3" 1.760 u 352.00 619.52
10.044 Yees f 2" 1.000 u 55.00 55.00
10.045 Codos f 2" 2.000 u 60.00 120.00
10.046 Cemento PVC 0.035 gls 1,102.00 38.57
10.047 Instalación de Bajante de Descarga 1.000 u 800.00 800.00
10.048 Herramientas y equipos 1.000 u 24.50 24.50 1,657.59
11.030 Columna de Ventilación f 3" (h = 10 mts).
11.031 Tubo de drenaje f 3" 1.760 u 759.00 1,335.84
11.032 Yees f 3" 1.000 u 82.36 82.36
11.033 Codos f 3" 2.000 u 47.56 95.12
11.034 Cemento PVC 0.035 gls 1,102.00 38.57
11.035 Instalación de Bajante de Descarga 1.000 u 800.00 800.00
11.036 Herramientas y equipos 1.000 u 35.28 35.28 2,387.17
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 108
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
11.040 Bajante de Descarga f 4" (h = 10 .00mts).
11.041 Tubo de drenaje f 4" 1.760 u 882.00 1,552.32
11.042 Yees f 4" 1.000 u 142.68 142.68
11.043 Codos f 4" 1.000 u 74.24 74.24
11.044 Cemento PVC 0.045 gls 1,102.00 49.59
11.045 Instalación de Bajante de Descarga 1.000 u 800.00 800.00
11.046 Herramientas y equipos 1.000 u 39.28 39.28 2,658.11
11.050 Tapon de Registro f 4"
11.051 Cemento PVC 0.007 gls 1,102.00 7.71
11.052 Codos f 4" 1.000 u 74.24 74.24
11.053 Tapon de Registro f 4" 1.000 u 116.00 116.00
11.054 Instalacióú de Tapon de Registro f 4" 1.000 u 200.00 200.00
11.055 Herramientas y equipos 1.000 u 7.96 7.96 405.91
11.060 Tapon de Registro f 2"
11.061 Cemento PVC 0.007 gls 1,102.00 7.71
11.062 Codos f 2" 1.000 u 18.21 18.21
11.063 Tapon de Registro f 2" 1.000 u 23.20 23.20
11.064 Instalacióú de Tapon de Registro f 2" 1.000 u 175.00 175.00
11.065 Herramientas y equipos 1.000 u 4.48 4.48 228.60
11.070 Trampa de Grasa de (0.80*0.80*0.75)mts.
11.071 Excavacion 0.600 m3 647.71 388.63
11.072 Bote de material. 0.900 m3 233.74 210.36
11.073 Losa de fondo. 0.080 m3 7,055.30 564.42
11.074 Losa de superior. 0.080 m3 6,423.45 513.88
11.075 Bloques de 0.10 m 2.520 m2 588.93 1,484.10
11.076 Pañete pulido. 3.320 m2 215.99 717.09
11.077 Tuberías y piezas 1.000 pa 1,326.42 1,326.42 4,605.91
11.080 Cámaras de inspección (0.0.50*0.50*0.75) mts.
11.081 Excavacion 0.150 m3 647.71 97.16
11.082 Bote de material. 0.210 m3 233.74 49.08
11.083 Losa de fondo. 0.003 m3 7,055.30 21.17
11.084 Losa de superior. 0.040 m3 6,423.45 256.94
11.085 Bloques de 0.10 m 1.200 m2 588.93 706.72
11.086 Pañete pulido. 1.200 m2 215.99 259.19
11.087 Tuberías y piezas 1.000 pa 300.00 300.00 1,690.26
12.000 Instalación Eléctrica 2 Niveles:
12.010 Salida de Iluminación de Techo ( DP = 41'):
12.011 Caja octagonal americana. 1.000 u 30.00 30.00
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 109
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
12.012 Roseta de porcelana. 0.290 u 40.00 11.60
12.013 Tubo de 1/2" PVC SDR-26. 41.000 pl 3.66 150.06
12.014 Curva de 1/2" PVC Reforzada. 1.000 u 3.25 3.25
12.015 Bombillo de 100 Watts. 1.000 u 7.50 7.50
12.016 2C-Alambre THW N° 12. 84.000 pl 6.44 540.96
12.017 Materiales miscelaneos (4% de los materiales). 1.000 PA 29.73 29.73
12.018 Mano de obra. 1.000 PA 312.00 312.00 1,085.10
12.020 Salida de Interruptor Simple (DP = 20'):
12.021 Caja de rectangular 2" * 4" americana. 1.000 u 30.00 30.00
12.022 Interruptor simple levitong 1.000 u 68.00 68.00
12.023 Tubo de 1/2" PVC SDR-26. 20.000 pl 3.66 73.20
12.024 Curva de 1/2" PVC Reforzada. 1.000 u 3.25 3.25
12.025 2C-Alambre THW N° 12. 42.000 pl 6.44 270.48
12.026 Materiales miscelaneos (4% de los materiales). 1.000 PA 17.80 17.80
12.027 Mano de obra. 1.000 PA 312.00 312.00 774.73
12.030 Salida de Interruptor Doble (D = 19'):
12.031 Caja de rectangular 2" * 4" americana. 1.000 u 30.00 30.00
12.032 Interruptor doble levitong 1.000 u 109.00 109.00
12.033 Tubo de 1/2" PVC SDR-26. 19.000 pl 3.66 69.54
12.034 Curva de 1/2" PVC Reforzada. 1.000 u 3.25 3.25
12.035 3C-Alambre THW N° 12. 60.000 pl 6.44 386.40
12.036 Interructor doble 1.000 u 60.00 60.00
12.037 Materiales miscelaneos (4% de los materiales). 1.000 PA 23.93 23.93
12.038 Mano de obra. 1.000 PA 350.00 350.00 1,032.12
12.040 Salida de Interruptor Triple (Dp = 25'):
12.041 Caja de rectangular 2" * 4" americana. 1.000 u 30.00 30.00
12.042 Interruptor triple levitong 1.000 u 80.00 80.00
12.043 Tubo de 1/2" PVC SDR-26. 25.000 pl 3.66 91.50
12.044 Curva de 1/2" PVC Reforzada. 1.000 u 3.25 3.25
12.045 3C-Alambre THW N° 12. 104.000 pl 6.44 669.76
12.046 Interructor triple 1.000 u 180.00 180.00
12.047 Materiales miscelaneos (4% de los materiales). 1.000 PA 34.98 34.98
12.048 Mano de obra. 1.000 PA 364.00 364.00 1,453.49
12.050 Salida de Interruptor Piloto (D = 22'):
12.051 Caja de rectangular 2" * 4" americana. 1.000 u 30.00 30.00
12.052 Interruptor piloto levitong 1.000 u 165.00 165.00
12.053 Tubo de 1/2" PVC SDR-26. 22.000 pl 3.66 80.52
12.054 Curva de 1/2" PVC Reforzada. 1.000 u 3.25 3.25
12.055 2C-Alambre THW N° 12. 46.000 pl 6.44 296.24
12.056 Interructor piloto 1.000 u 300.00 300.00
12.057 Materiales miscelaneos (4% de los materiales). 1.000 PA 23.00 23.00
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 110
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
12.058 Mano de obra. 1.000 PA 312.00 312.00 1,210.01
12.060 Salida de Tomacorriente Doble de 110 V (DP = 18'):
12.061 Caja de rectangular 2" * 4" americana. 1.000 u 30.00 30.00
12.062 Tomacorriente a 120 doble levitong. 1.000 u 37.00 37.00
12.063 Tubo de 1/2" PVC SDR-26. 18.000 pl 3.66 65.88
12.064 Curva de 1/2" PVC Reforzada. 2.000 u 3.25 6.50
12.065 2C-Alambre THW N° 12. 38.000 pl 6.44 244.72
12.066 1C-Alambre THW N° 14. 19.000 pl 4.00 76.00
12.067 Tomacorriente a 120 doble levitong. 1.000 u 50.00 50.00
12.068 Materiales miscelaneos (4% de los materiales). 1.000 PA 32.21 32.21
12.069 Mano de obra. 1.000 PA 312.00 312.00 854.31
12.070 Salida de Tomacorriente Simple 15A, 220 V (DP = 22'):
12.071 Caja de rectangular 2" * 4" KO-1/2". 1.000 u 30.00 30.00
12.072 Tubo de 1/2" PVC SDR-26. 22.000 pl 3.66 80.52
12.073 Curva de 1/2" PVC Reforzada. 2.000 u 3.25 6.50
12.074 2C-Alambre THW N° 10. 46.000 pl 9.05 416.30
12.075 1C-Alambre THW N° 12. 23.000 pl 6.44 148.12
12.076 Tomacorriente a 240 doble levitong. 1.000 u 70.00 70.00
12.077 Materiales miscelaneos (4% de los materiales). 1.000 PA 27.26 27.26
12.078 Mano de obra. 1.000 PA 364.00 364.00 1,142.70
12.080 Salida de Tomacorriente Doble de 110 V (DP = 28'):
12.081 Caja de rectangular 2" * 4" americana. 1.000 u 30.00 30.00
12.082 Tomacorriente a 120 doble levitong. 1.000 u 27.00 27.00
12.083 Tubo de 1/2" PVC SDR-26. 28.000 pl 3.66 102.48
12.084 Curva de 1/2" PVC Reforzada. 2.000 u 3.25 6.50
12.085 2C-Alambre THW N° 12. 58.000 pl 6.44 373.52
12.086 1C-Alambre THW N° 14. 29.000 pl 3.89 112.81
12.087 Materiales miscelaneos (4% de los materiales). 1.000 PA 45.66 45.66
12.088 Mano de obra. 1.000 PA 312.00 312.00 1,009.97
12.090 Salida Para Teléfono (DP = 30'):
12.091 Caja de rectangular 2" * 4" americana 3/4". 1.000 u 30.00 30.00
12.092 Tubo de 3/4" PVC SDR-26. 30.000 pl 7.00 210.00
12.093 Curva de 1/2" PVC Reforzada. 2.000 u 4.32 8.64
12.094 Tapa de telefono 1.000 u 50.00 50.00
12.095 Materiales miscelaneos (4% de los materiales). 1.000 PA 9.95 9.95
12.096 Mano de obra. 1.000 PA 310.00 310.00 618.59
12.100 Salida Para Antena TV-C (DP = 35'):
12.101 Caja de rectangular 2" * 4" KO-3/4".(Am.) 1.000 u 30.00 30.00
12.102 Tubo de 3/4" PVC SDR-26. 35.000 pl 7.00 245.00
12.103 Curva de 3/4" PVC Reforzada. 2.000 u 4.32 8.64
12.104 Materiales miscelaneos (4% de los materiales). 1.000 PA 19.85 19.85
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 111
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
12.105 Mano de obra. 1.000 PA 310.00 310.00 613.49
12.110 Panel de Distribución L(C-1),GE f 1" 120/208V CAT N° TLM 12 de 90/2
formado Por:
12.111 Panel de Distribución A(P-C1) 1.000 u 1,100.00 1,100.00
12.112 breakers de 20A/1P 3.000 u 200.00 600.00
12.113 breakers de 30A/2P 3.000 u 320.00 960.00
12.114 Materiales miscelaneos (3% de los materiales). 1.000 PA 51.00 51.00
12.115 Mano de obra (44% de los materiales). 1.000 PA 1,192.84 1,192.84 3,903.84
12.120 Alimentador al Panel (C-1):
12.121 2C-THW Nº 4 2.000 pl 27.00 54.00
12.122 1C-THW Nº 6 1.000 pl 17.00 17.00
12.123 1C-THW Nº 8 1.000 pl 13.00 13.00
12.124 Ducto de PVC f 2" SDR-26. 1.000 pl 12.00 12.00
12.125 Materiales miscelaneos (3% de los materiales). 1.000 pl 2.88 2.88
12.126 Mano de obra (39 % de los materiales). 1.000 pl 38.56 38.56 137.44
12.130 Panel de Distribución A(P-C2),GE f 1" 120/240V CAT N° TLM 12 de 70/2
formado Por:
12.131 Panel de Distribución A(P-C2) 1.000 u 1,100.00 1,100.00
12.132 breakers de 20A/1P 2.000 u 200.00 400.00
12.133 breakers de 30A/2P 2.000 u 320.00 640.00
12.134 Materiales miscelaneos (3% de los materiales). 1.000 PA 45.00 45.00
12.135 Mano de obra (44% de los materiales). 1.000 PA 961.40 961.40 3,146.40
12.140 Alimentador al Panel (P-C2):
12.141 2C-THW Nº 6 2.000 pl 17.00 34.00
12.142 1C-THW Nº 8 1.000 pl 13.00 13.00
12.143 1C-THW Nº 10 1.000 pl 9.05 9.05
12.144 Ducto de PVC f 2" SDR-26. 1.000 pl 12.00 12.00
12.145 Materiales miscelaneos (3% de los materiales). 1.000 pl 2.04 2.04
12.146 Mano de obra (39 % de los materiales). 1.000 pl 27.34 27.34 97.43
13.000 Escalera Común:
13.010 Salida de Iluminación de Techo ( DP = 22'):
13.011 Caja octagonal americana. 1.000 u 30.00 30.00
13.012 Roseta de porcelana. 1.000 u 40.00 40.00
13.013 Tubo de 1/2" PVC SDR-26. 22.000 pl 3.66 80.52
13.014 Curva de 1/2" PVC Reforzada. 1.000 u 3.25 3.25
13.015 Bombillo de 100 Watts. 1.000 u 7.50 7.50
13.016 2C-Alambre THW N° 12. 46.000 pl 6.44 296.24
13.017 Materiales miscelaneos (4% de los materiales). 1.000 PA 18.30 18.30
13.018 Mano de obra. 1.000 PA 321.00 321.00 796.81
13.020 Salida de Interruptor Tres Vias (D = 18'):
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 112
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
13.011 Caja de rectangular 2" * 4" americana. 1.000 u 30.00 30.00
13.012 Interruptor tres vías levitong 1.000 u 110.00 110.00
13.013 Tubo de 1/2" PVC SDR-26. 18.000 pl 3.66 65.88
13.014 Curva de 1/2" PVC Reforzada. 1.000 u 3.25 3.25
13.015 3C-Alambre THW N° 12. 57.000 pl 6.44 367.08
13.016 Materiales miscelaneos (4% de los materiales). 1.000 PA 23.05 23.05
13.017 Mano de obra. 1.000 PA 350.00 350.00 949.26
13.030 Salida de Interruptor Cuatro Vìas (D = 18'):
13.031 Caja de rectangular 2" * 4" americana. 1.000 u 30.00 30.00
13.032 Interruptor cuatro vías levitong 1.000 u 160.00 160.00
13.033 Tubo de 1/2" PVC SDR-26. 18.000 pl 3.66 65.88
13.034 Curva de 1/2" PVC Reforzada. 1.000 u 3.25 3.25
13.035 4C-Alambre THW N° 12. 76.000 pl 6.44 489.44
13.036 Materiales miscelaneos (4% de los materiales). 1.000 PA 29.94 29.94
13.037 Mano de obra. 1.000 PA 371.00 371.00 1,149.51
13.040 Salida Para Motor de Bomba (DP = 59'):
13.041 Caja de rectangular 2" * 4" KO-13/4". 1.000 u 60.00 60.00
13.042 Tubo de 1/2" PVC SDR-26. 59.000 pl 4.53 267.27
13.043 Curva de 1/2" PVC Reforzada. 2.000 u 6.00 12.00
13.044 2C-Alambre THW N° 10. 120.000 pl 9.05 1,086.00
13.045 1C-Alambre THW N° 12. 60.000 pl 6.44 386.40
13.046 Materiales miscelaneos (4% de los materiales). 1.000 PA 72.47 72.47
13.047 Mano de obra. 1.000 PA 350.00 350.00 2,234.14
13.050 Salida Para Puera Eléctrica (DP = 70'):
13.051 Caja rectangular 2" * 4" KO-3/4". 1.000 u 60.00 60.00
13.052 Tubo de 3/4" PVC SDR-26. 70.000 pl 4.53 317.10
13.053 Curva de 3/4" PVC Reforzada. 2.000 u 6.00 12.00
13.054 2C-Alambre THW N° 12. 142.000 pl 6.44 914.48
13.055 Materiales miscelaneos (4% de los materiales). 1.000 PA 52.14 52.14
13.056 Mano de obra. 1.000 PA 310.00 310.00 1,665.72
13.060 Alimentador al Modulo de contador:
0.001 9C-THW Nº 3/0 9.000 pl 90.00 810.00
13.061 2C-THW Nº 3/0 2.000 pl 90.00 180.00
13.062 2C-THW Nº 1/0 2.000 pl 120.00 240.00
13.063 Ducto de PVC f 1-3" SDR-26. 1.000 pl 40.00 40.00
13.064 Materiales miscelaneos (3% de los materiales). 1.000 pl 13.80 13.80
13.065 Mano de obra (39 % de los materiales). 1.000 pl 184.78 184.78 658.58
13.070 Panel de Distribución (P-S),GE f 1" 120/240V CAT N° TLM 712
formado Por:
13.071 Panel de Distribución C(P-S) 1.000 u 3,600.00 3,600.00
13.072 breakers de 20A/1P 12.000 u 200.00 2,400.00
13.073 breakers de 30A/2P 1.000 u 340.00 340.00
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 113
SANTO DOMINGO, D. N.
(ANÁLISIS DE COSTOS)
N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL
13.074 Materiales miscelaneos (3% de los materiales). 1.000 PA 190.20 190.20
13.075 Mano de obra (44% de los materiales). 1.000 PA 2,873.29 2,873.29 9,403.49
13.080 Alimentador al Panel (P-S):
13.081 2C-THW Nº 6 2.000 pl 17.00 34.00
13.082 1C-THW Nº 8 1.000 pl 13.00 13.00
13.083 1C-THW Nº 10 1.000 pl 9.05 9.05
13.084 Ducto de PVC f 2" SDR-26. 1.000 pl 19.84 19.84
13.085 Materiales miscelaneos (3% de los materiales). 1.000 pl 2.28 2.28
13.086 Mano de obra (25 % de los materiales). 1.000 pl 19.54 19.54 97.71
Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 114
EFN-CONSTRUCTION
CONSTRUCCION, SUPERVISION.
PRESUPUESTO PARA CONSTRUCCION DE CASA ( 62,0 MT2 )
N° PARTIDAS CANTIDAD U.D P. U. VALOR SUB-TOTAL
1.000 TRABAJOS PRELIMINARES
1.010 Replanteos casa ( incluye madera y pago a maestro ) 62.00 M² 65.00 4,030.00
1.020
Conexiones temporales o facilidades de agua y energía eléctrica para áreas de
construcción y campamento personal 1.00 PA 1,500.00 1,500.00
1.030 Habilitar área almacén materiales 1.00 PA 6,000.00 6,000.00 11,530.00RD$
2.000 MOVIMIENTO DE TIERRAS
2.010 Zapatas muros bloques 6´´ 17.45 M3 400.00 6,978.40
2.020 Zapatas muros bloques 4´´ 0.56 M3 400.00 224.00
2.020 Zapatas columnas ( 1,0 x 1,0 ) mts 3.20 M3 400.00 1,280.00
2.030 Relleno compactado interior casa material seleccionado 24.80 M3 480.00 11,904.00
2.040 Relleno de reposicion interior casa material excavado 10.32 M3 180.00 1,857.60 22,244.00RD$
3.000 HORMIGON ARMADO EN ESTRUCTURAS DE :
3.100 ZAPATA DE MUROS
3.110 Zapatas muros 6" =3 Ø 3/8" con cangrejos @ 0.25 m. 8.32 M3 8,159.69 67,888.62
3.120 Zapatas muros 4" =3 Ø 3/8" con cangrejos @ 0.25 m. 0.34 M3 8,385.02 2,850.91
3.130 Zapatas columnas =6 Ø 3/8" con S= @ 0.20 m. 1.00 M3 7,231.14 7,231.14
3.200 COLUMNAS DE CARGAS
3.210 C1, primer nivel = 6 Ø 3/8" con estribos @ 0.20 m. 0.43 M3 25,702.65 11,103.54
3.300 VIGAS DE CARGAS Y DINTLES
3.310 Vigas de cargas en primer nivel = 3 Ø 1/2" + 2 Ø 3/8"con estribos @ 0.20 m. 1.20 M3 14,833.62 17,800.34
3.320 Vigas perimetral nivel de piso = 4 Ø 3/8" con estribos @ 0.20 m. 1.34 M3 18,486.83 24,846.30
3.330 Viga dintel 4 Ø 3/8" con estribos @ 0.20 m. 0.63 M3 18,486.83 11,646.70
3.400 LOSA DE ENTREPISO Y TECHO
3.410 Losa de Hormigon Armado de H= 0.12m con Fc= 210kg/cm2 incluye vuelo 7.84 M3 12,429.40 97,446.50 240,814.05RD$
4.000 MAMPOSTERIA
4.100 Block 15 cms. con acero vertical=Ø 3/8" @ 0.80 m.
4.110 1er nivel BNP 29.10 M² 850.00 24,735.00
4.120 1er nivel SNP 99.01 M² 786.65 77,886.03
4.130 Antepecho 6.54 M² 820.00 5,362.80
4.200 Block 10 cms. con acero vertical=Ø 3/8" @ 0.80 m.
4.210 BNP 1.36 M² 742.23 1,009.43
4.220 1er nivel SNP 14.03 M² 761.00 10,676.83 119,670.09RD$
5.000 TERMINACIÓN DE SUPERFICIES
5.100 Fraguache de superficies hormigones
5.110 1er nivel exterior 79.02 M² 25.00 1,975.50
5.120 1er nivel interior 163.02 M² 25.00 4,075.50
5.130 Techo 62 + techo galeria 63.40 M² 25.00 1,585.00
5.140 Antepecho 6.54 M² 25.00 163.50
5.200 Pañete liso en muros de bloques en General
5.210 1er nivel exterior 79.02 M² 234.55 18,534.14
5.220 1er nivel interior 163.02 M² 199.09 32,456.32
5.230 En techo 63.40 M² 214.23 13,582.18
5.240 Antepecho 6.54 M² 214.23 1,401.06
5.250 Mocheta en general en puertas y ventanas y muros 46.50 ML 92.25 4,289.63
5.260 Cantos en general, incluye vuelo perímetral 93.00 ML 46.10 4,287.30 82,350.13RD$
6.000 TERMINACION DE TECHOS
6.010 Fino de techo en losas planas 62.00 M² 329.02 20,399.40
6.020 Zabaletas en general en losas 37.15 ML 120.00 4,458.00
6.030 Impermebilizante acrilico dos manos 62.00 M² 175.00 10,850.00 35,707.40RD$
7.000 TERMINACION DE PISOS
7.010 Torta de piso 64.00 M² 147.00 9,408.00
7.020 1er nivel porcelanato 56.50 M² 868.53 49,071.95
7.030 Zocalos en porcelanato 52.30 ml 178.68 9,344.96
7.040 Pisos baños primer nivel 5.80 M² 645.20 3,742.16 71,567.07RD$
8.000 REVESTIMIENTO CERAMICA EN PAREDES COCINA Y BAÑOS
8.100 BAÑOS
8.110 1er nivel 20.48 M² 460.00 9,420.80
8.200 COCINA
8.210 1er nivel 1.74 M² 465.00 809.10 10,229.90RD$
9.000 INSTALACION SANITARIA DOS NIVELES
9.010 Suministro e instalacion de inodoros 2.00 uds 3,750.00 7,500.00
9.020 Suministro e instalacion cortina de cristal bañera 2.00 uds 8,000.00 16,000.00
9.030 Suministro e instalacion de Lavamanos 2.00 uds 2,250.00 4,500.00
9.040 Suminiostro e instalacion de Fragadero sencillo 1.00 uds 1,750.00 1,750.00
9.050 Suministro e instalacion de Duchas mezcladora en baños 2.00 uds 4,250.00 8,500.00
9.060 Suministro e instalacion de Duchas mezcladora en Fragadero 1.00 uds 1,240.00 1,240.00
9.070 Suminisrtro e instalacion de tubeerias de arrastre de 2" interior desague de fondo 2.00 pa 1,500.00 3,000.00
9.080 Suminisrtro e instalacion tanque agua potable de 200 galones 1.00 pa 2,500.00 2,500.00
9.090 Suminisrtro e instalacion de tubeerias de arrastre de 4" exterior descarga baños 1.00 pa 2,500.00 2,500.00
9.100 Construcion de registro sanitario 1.00 uds 1,200.00 1,200.00
9.110 Construcion de registro trampa de grasa 1.00 uds 1,500.00 1,500.00 50,190.00RD$
10.000 COCINA
10.010 Gabinetes de piso 3.28 PL 1,200.00 3,936.00

Proyecto vivienda económica programa con cpm-per derby intec

  • 48.
    CONSTRUCTORA HERNANDEZ JAVIER& ASOCS. DISEÑOS, CONSTRUCCION, SUPERVISION. AV. Independencia # 1103 Residencial Don Pedro Local 101 Tel. 809-534-5696 Cel: 829-657-1404, Santo Domingo, Rep. Dom. Email: felixhj2@hotmail.com LISTA DE MATERIALES PARA CONSTRUCCION DE CASA ESTHER ROBLES ( 42 MT2 ) N° PARTIDAS CANTIDAD U.D P. U. VALOR SUB-TOTAL LISTA DE MATERIALES 1.000 MATERIALES VARIOS 1.010 BLOCKS 6´´ 1,301.00 UNDS 24.00 31,224.00 1.020 BLOCKS 4´´ 65.00 UNDS 22.00 1,430.00 1.030 CEMENTO GRIS 290.00 FUNDAS 300.00 87,000.00 1.040 CEMENTO BLANCO 2.00 FUNDAS 675.00 1,350.00 PAGATO 12.00 FUNDAS 225.00 2,700.00 1.050 VARILLAS Ø 3/8" 24.75 QQ 2,080.00 51,480.00 1.060 VARILLAS Ø 1/2" 5.50 QQ 2,080.00 11,440.00 1.070 ALAMBRE CAL 18 60.50 LBS 35.00 2,117.50 1.080 ARENA ITABO PARA H.A 10.00 M3 750.00 7,500.00 1.090 ARENA ITABO PARA COLOCAR BLOCKS 5.00 M3 750.00 3,750.00 1.100 GRAVA PARA H.A 8.00 M3 850.00 6,800.00 1.110 ARENA FINA PARA PAÑETE 8.00 M3 900.00 7,200.00 1.120 ARENA PARA FINO DE TECHO 3.00 M3 750.00 2,250.00 1.130 CALICHE O MATERIAL DE RELLENO CLASIFICADO 18.00 M3 300.00 5,400.00 1.140 IMPERMEABILIZANTE ACRILICO 1.00 CUBETA 3,850.00 3,850.00 1.150 PORCELANATO REGULAR ANTI MANCHAS 40X40 CMS 40.00 M2 380.00 15,200.00 1.160 PISO CERAMICA PARA BAÑO 2.50 M2 210.00 525.00 1.170 CERAMICA DE PARED PARA BAÑO 15.00 M2 225.00 3,375.00 1.180 CERAMICA DE PARED PARA COCINA 1.50 M2 250.00 375.00 1.190 INODORO 1.00 UNDS 2,650.00 2,650.00 1.200 PLATO DE DUCHA 1.00 UNDS 1,800.00 1,800.00 1.210 LAVAMANO TAINO 1.00 UNDS 850.00 850.00 1.220 FREGADERO SENCILLO 1.00 UNDS 1,200.00 1,200.00 1.230 LLAVE MEZCLADORA PARA DUCHA 1.00 UNDS 850.00 850.00 1.240 LLAVE MEZCLADORA PARA FREGADERO 1.00 UNDS 750.00 750.00 1.250 LLAVE MEZCLADORA PARA LAVAMANO 1.00 UNDS 450.00 450.00 1.260 TUBERIAS Y PIEZAS 1.00 UNDS 4,500.00 4,500.00 1.270 Panel de distribucion de 4 circuitos a 8 circuitos INCLUYE BREAKERS 1.00 ud 1,200.00 1,200.00 1.280 toma corriente 110v 8.00 uds 75.00 600.00 1.290 toma corriente 220v 2.00 uds 75.00 150.00 1.300 Insterruptores sencillo 5.00 uds 75.00 375.00 1.310 Luces cenitales 5.00 uds 60.00 300.00 1.320 salida de cable tv 3.00 uds 75.00 225.00 1.330 salida de telefono 2.00 uds 95.00 190.00 1.340 Alambre calibre 8 para conexion desde calle hasta caja de breaker 300.00 pies 18.00 5,400.00
  • 49.
    1.350 Pintura acrilicainterior exterior TROPICAL CONTARTOR PARA PROYECTOS 3.00 CUBETAS 2,350.00 7,050.00 - 2.000 SUBTOTAL GENERAL COSTOS DIRECTOS 273,506.50RD$ 3.000 COSTOS INDIRETOS 2.010 Dirección Técnica y Beneficio 10.00% 27,350.65 27,350.65RD$ 4.000 SUBTOTAL GENERAL GASTOS INDIRECTOS 5.000 COSTO TOTAL DE CONSTRUCCION 300,857.15RD$ Notas: a) Presupuesto elaborado conforme a planos tipos b) Presupuesto elaborado con precios y mano de obra vigentes Octubre 2012 c) Los precios podrían variar conforme a los cambios en el mercado. 12 de Octubre 2012 PREPARADO POR ING: FELIX HERNANDEZ JAVIER Codia 23110 Tels: 809-657-1404 809-445-1404
  • 50.
    CONSTRUCTORA HERNANDEZ JAVIER& ASOCS. DISEÑOS, CONSTRUCCION, SUPERVISION. AV. Independencia # 1103 Residencial Don Pedro Local 101 Tel. 809-534-5696 Cel: 829-657-1404, Santo Domingo, Rep. Dom. Email: felixhj2@hotmail.com LISTA DE MANO DE OBRA CONSTRUCCION CASA ESTHER ROBLES ( 42 MT2 ) N° PARTIDAS CANTIDAD U.D P. U. VALOR LISTA DE MANO DE OBRA A PAGAR 1.000 TRABAJOS PRELIMINARES 1.010 Replanteos casa ( incluye madera y pago a maestro ) 42.00 M² 30.00 1,260.00 1.020 Conexiones temporales o facilidades de agua y energía eléctrica para áreas de construcción y campamento personal 1.00 PA 1,500.00 1,500.00 1.030 Habilitar área almacén materiales 1.00 PA 10,000.00 10,000.00 2.000 MOVIMIENTO DE TIERRAS 2.010 M.O EXCAVACION Zapatas muros bloques 6´´ 13.28 M3 300.00 3,985.20 2.020 M.O EXCAVACION Zapatas muros bloques 4´´ 0.24 M3 300.00 72.00 2.020 M.O EXCAVACION Zapatas columnas ( 1,0 x 1,0 ) mts 5.40 M3 300.00 1,620.00 2.030 M.O Relleno compactado interior casa material seleccionado 16.80 M3 100.00 1,680.00 2.040 M.O Relleno de reposicion interior casa material excavado 9.34 M3 80.00 747.36 3.000 HORMIGON ARMADO EN ESTRUCTURAS DE : 3.100 ZAPATA DE MUROS DE 6´´ 3.110 M.O ACERO EN Zapatas muros 6" =3 Ø 3/8" con cangrejos @ 0.25 m. 36.90 M.L 50.00 1,845.00 3.120 M.O LIGADO Y VACIADO DE Zapatas muros 6" =3 Ø 3/8" con cangrejos @ 0.25 m. 3.32 M3 700.00 2,324.70 3.200 ZAPATA DE MUROS DE 4´´ 3.210 M.O ACERO EN Zapatas muros 4" =3 Ø 3/8" con cangrejos @ 0.25 m. 2.00 M.L 50.00 100.00 3.220 M.O LIGADO Y VACIADO DE Zapatas muros 4" =3 Ø 3/8" con cangrejos @ 0.25 m. 1.50 M3 7,231.14 10,846.71 3.300 ZAPATA DE COLUMNAS DE CARGAS 3.310 M.O ACERO EN Zapatas columnas =6 Ø 1/2" con S= @ 0.20 m. 6.00 UNDS 100.00 600.00 3.320 M.O LIGADO Y VACIADO DE Zapatas columnas =6 Ø 1/2" con S= @ 0.20 m. 1.50 M3 700.00 1,050.00 3.400 COLUMNAS DE CARGAS - 3.410 M.O ACERO C1, primer nivel = 4 Ø 1/2" con estribos @ 0.20 m. 21.60 M.L 60.00 1,296.00 3.420 M.O ENCOFRADO C1, primer nivel = 4 Ø 1/2" con estribos @ 0.20 m. 21.60 M.L 175.00 3,780.00 3.430 M.O LIGADO Y VACIADO C1, primer nivel = 4 Ø 1/2" con estribos @ 0.20 m. 1.00 PA 1,200.00 1,200.00 3.500 VIGAS DE CARGAS Y DINTLES - 3.510 M.O ACERO EN Vigas de cargas en primer nivel = 3 Ø 1/2" + 2 Ø 3/8"con estribos @ 0.20 m. 41.00 M.L 60.00 2,460.00 3.520 M.O ENCOFRADO Vigas de cargas en primer nivel = 3 Ø 1/2" + 2 Ø 3/8"con estribos @ 0.20 m. 41.00 M.L 175.00 7,175.00 3.530 M.O LIGADO Y VACIADO Vigas de cargas en primer nivel = 3 Ø 1/2" + 2 Ø 3/8"con estribos @ 0.20 m. 1.85 M3 850.00 1,568.25 3.520 M.O ACERO Vigas perimetral nivel de piso = 4 Ø 3/8" con estribos @ 0.20 m. 28.00 M.L 55.00 1,540.00 3.530 M.O ENCOFRADO Vigas perimetral nivel de piso = 4 Ø 3/8" con estribos @ 0.20 m. 28.00 M.L 175.00 4,900.00
  • 51.
    3.540 M.O LIGADOY VACIADO Vigas perimetral nivel de piso = 4 Ø 3/8" con estribos @ 0.20 m. 1.00 PA 900.00 900.00 3.530 M.O ACERO Viga dintel 4 Ø 3/8" con estribos @ 0.20 m. 13.80 M.L 55.00 759.00 3.540 M.O ENCOFRADO Viga dintel 4 Ø 3/8" con estribos @ 0.20 m. 13.80 M.L 175.00 2,415.00 3.550 M.O LIGADO Y VACIADO Viga dintel 4 Ø 3/8" con estribos @ 0.20 m. 1.00 PA 900.00 900.00 3.600 LOSA DE ENTREPISO Y TECHO - 3.610 M.O ACERO Losa de Hormigon Armado de H= 0.12m con Fc= 210kg/cm2 incluye vuelo ( Ø 3/8") 7.00 QQ 190.00 1,330.00 3.620 M.O ENCOFRADO Losa de Hormigon Armado de H= 0.12m con Fc= 210kg/cm2 incluye vuelo 42.00 M2 175.00 7,350.00 3.630 M.O LIGADO Y VACIADO Losa de Hormigon Armado de H= 0.12m con Fc= 210kg/cm2 incluye vuelo 5.04 M3 850.00 4,284.00 4.000 MAMPOSTERIA - 4.100 Block 15 cms. con acero vertical=Ø 3/8" @ 0.80 m. - 0.010 M.O COLOCACION BLOCKS 1er nivel BNP 288.00 UNDS 10.00 2,880.00 4.010 M.O COLOCACION BLOCKS 1er nivel SNP 940.00 UNDS 10.00 9,400.00 4.110 M.O COLOCACION BLOCKS Antepecho 73.00 UNDS 10.00 730.00 4.200 Block 10 cms. con acero vertical=Ø 3/8" @ 0.80 m. - 4.210 M.O COLOCACION BLOCK SBNP 5.20 UNDS 10.00 52.00 4.220 M.O COLOCACION BLOCKS 1er nivel SNP 59.80 UNDS 10.00 598.00 - 5.000 TERMINACIÓN DE SUPERFICIES - 5.100 Fraguache de superficies hormigones - 5.110 M.O FRAGUECHE 1er nivel exterior 65.86 M² 10.00 658.60 5.120 M.O FRAGUACHE 1er nivel interior 126.90 M² 10.00 1,269.00 5.130 M.O FRAGUACHE Techo 42.00 M² 10.00 420.00 5.140 M.O FRAGUACHE Antepecho 11.20 M² 10.00 112.00 5.200 Pañete liso en muros de bloques en General - 5.210 M.O PAÑETE 1er nivel exterior 65.86 M² 90.00 5,927.40 5.220 M.O PAÑETE 1er nivel interior 126.90 M² 80.00 10,152.00 5.230 M.O PAÑETE En techo 42.00 M² 85.00 3,570.00 5.240 M.O PAÑETE Antepecho 11.20 M² 90.00 1,008.00 5.250 M.O CONFECCION Mocheta en general en puertas y ventanas y muros 41.60 ML 40.00 1,664.00 5.260 M.O CONFECCION Cantos en general, incluye vuelo perímetral 83.20 ML 20.00 1,664.00 - 6.000 TERMINACION DE TECHOS - 6.010 M.O CONFECCION Fino de techo en losas planas 40.00 M² 100.00 4,000.00 6.020 M.O CONFECCION Zabaletas en general en losas 28.00 ML 40.00 1,120.00 6.030 M.O Impermebilizante acrilico dos manos lanco 40.00 M² 50.00 2,000.00 - 7.000 TERMINACION DE PISOS - 7.010 M.O COLOCACION 1er nivel porcelanato 40.00 M² 200.00 8,000.00 7.020 M.O COLOCACION Zocalos en porcelanato 45.80 ml 50.00 2,290.00 7.030 M.O COLOCACION Pisos baños primer nivel 2.00 M² 150.00 300.00 - 8.000 REVESTIMIENTO CERAMICA EN PAREDES COCINA Y BAÑOS - 8.100 BAÑOS - 8.110 M.O COLOCACION 1er nivel 15.00 M² 150.00 2,250.00
  • 52.
    8.200 COCINA - 8.210M.O COLOCACION 1er nivel 1.08 M² 150.00 162.00 - 9.000 INSTALACION SANITARIA DOS NIVELES - 9.010 M.O instalacion de inodoros 1.00 uds 500.00 500.00 9.020 M.O instalacion de ducha de plato en esquina 1.00 uds 500.00 500.00 9.030 M.O instalacion de Lavamanos 1.00 uds 350.00 350.00 9.040 M.O instalacion de Fragadero sencillo 1.00 uds 500.00 500.00 9.050 M.O instalacion de Duchas mezcladora en Fragadero 1.00 uds 350.00 350.00 9.060 M.O instalacion de Duchas mezcladora en cabina 1.00 uds 350.00 350.00 9.070 M.O instalacion de tubeerias de arrastre de 2" interior desague de fondo 1.00 pa 750.00 750.00 9.080 M.O instalacion de tubeerias de arrastre de 4" exterior descarga baños 1.00 pa 500.00 500.00 9.090 M.O Construcion de registro sanitario 2.00 uds 800.00 1,600.00 9.100 M.O Construcion de registro trampa de grasa 1.00 uds 800.00 800.00 - 10.000 COCINA - 10.010 Gabinetes de piso 6.56 PL 1,200.00 7,872.00 10.020 Gabinetes de pared 6.56 PL 1,200.00 7,872.00 10.030 Topes de cocina en granito 6.45 P2 480.00 3,098.30 - 11.000 INSTALACION ELECTRICA EN GENERAL - 11.010 M.O INSTALACION Panel de distribucion de 4 circuitos a 8 circuitos 1.00 ud 500.00 500.00 11.020 M.O INSTALACION toma corriente 110v 8.00 uds 250.00 2,000.00 11.030 M.O INSTALACION toma corriente 220v 2.00 uds 250.00 500.00 11.040 M.O INSTALACION Insterruptores sencillo 5.00 uds 250.00 1,250.00 11.050 M.O INSTALACION Luces cenitales 5.00 uds 250.00 1,250.00 11.060 M.O INSTALACION salida de cable tv 3.00 uds 250.00 750.00 11.070 M.O INSTALACION salida de telefono 2.00 uds 250.00 500.00 11.080 M.O conexion exterior desde poste hasta casa 1.00 pa 2,000.00 2,000.00 - 12.000 PORTAJE - 13.100 1er nivel - 13.110 Puerta principal en madera completa 1.00 uds 8,500.00 8,500.00 13.120 Puerta salida patio exerior 1.00 uds 5,500.00 5,500.00 13.130 Puertas en baños 1.00 uds 5,500.00 5,500.00 13.140 Puerta entrada habitaciones 3.00 uds 5,500.00 16,500.00 - 13.000 VENTANAS - 14.100 1er nivel - 14.110 V1 ( 1.20*1.10)m 7 unidades iguales 85.20 p2 170.00 14,484.57 14.120 V2 ( 0.60*0,60)m en baño ´´celosias´´ 17.43 p2 170.00 2,962.75 - 14.000 PINTURA - 15.100 1er nivel 2do nivel - 15.110 Pintura acrilica interior exterior 245.96 M² 30.00 7,378.80 -
  • 53.
    15.000 MICELANEOS - 15.010Jardineria en patio 1.00 pa 5,000.00 5,000.00 15.020 Acera de hormigon simple laterales en hormigon frotado 6.80 M² 100.00 680.00 15.030 Piezas de Gramaquin de 20*20 cm entrada puerta principal 15.00 und 50.00 750.00 15.040 Limpieza general continua y final ( incluye bote de escombros ) 1.00 pa 5,000.00 5,000.00 16.000 SUBTOTAL GENERAL COSTOS DIRECTOS 17.000 COSTOS INDIRETOS 16.010 Dirección Técnica y Beneficio 10.00% - - 18.000 SUBTOTAL GENERAL GASTOS INDIRECTOS 19.000 COSTO TOTAL DE CONSTRUCCION Notas: a) Presupuesto elaborado conforme a planos tipos b) Presupuesto elaborado con precios y mano de obra vigentes Octubre 2012 c) Los precios podrían variar conforme a los cambios en el mercado. 12 de Octubre 2012 PREPARADO POR ING: FELIX HERNANDEZ JAVIER Codia 23110 Tels: 809-657-1404 809-445-1404
  • 54.
  • 55.
  • 56.
  • 57.
  • 58.
    INSTALACION ELECTRICA ENGENERAL - Panel de distribucion de 8 circuitos a 12 circuitos 2.00 ud 550.00 1,100.00 toma corriente 110v 25.00 uds 250.00 6,250.00 toma corriente 220v 3.00 uds 250.00 750.00 Insterruptores doble 2.00 uds 250.00 500.00 Insterruptores sencillo 10.00 uds 250.00 2,500.00 Luces cenitales 18.00 uds 250.00 4,500.00 salida de cable tv 4.00 uds 250.00 1,000.00 salida de telefono 3.00 uds 250.00 750.00 registros 4.00 uds 250.00 1,000.00 18,350.00RD$ INSTALACION SANITARIA DOS NIVELES - Instalacion de inodoros 3.00 uds 800.00 2,400.00 Instalacion de Bañeras 2.00 uds 1,200.00 2,400.00 Instalacion de Lavamanos 3.00 uds 500.00 1,500.00 Instalacion de Fragadero 1.00 uds 700.00 700.00 Instalacion de Duchas mezcladora en baños 2.00 uds 350.00 700.00 Instalacion de Duchas mezcladora en Fragadero 1.00 uds 350.00 350.00 Instalacion de Duchas mezcladora en Bañeras 2.00 uds 350.00 700.00 Instalacion Lavadero de una boca 1.00 uds 700.00 700.00 Instalacion de tubeerias de arrastre de 4" exterior descarga baños 1.00 pa 4,500.00 4,500.00 Construcion de registro sanitario 4.00 uds 800.00 3,200.00 Construcion de registro trampa de grasa 1.00 uds 800.00 800.00 17,950.00RD$
  • 59.
    No. Costo 1 RD$5,158.40 2RD$1,920.00 3 RD$7,680.00 4 RD$10,857.47 5 RD$27,212.24 6 RD$80,477.38 7 RD$43,597.76 8 RD$120,968.43 9 RD$5,833.73 10 RD$64,715.10 11 RD$78,137.87 12 RD$6,864.38 13 RD$45,705.47 14 RD$25,517.06 15 RD$39,446.53 16 RD$9,983.36 17 RD$68,808.91 18 RD$60,787.20 19 RD$69,907.75 20 RD$42,880.00 21 RD$22,605.23 22 RD$4,160.00 23 RD$119,937.24 24 RD$37,757.07 25 RD$18,408.33 26 RD$1,920.00 LISTA DE ACTIVIDADES CON COSTO Actividad Replanteos casa Conexiones temporales Habilitar área almacén materiales Excavaciones de zapatas muros bloques y columnas Acero para zapatas de muros y columnas y para columnas de carga Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas Colocación de bloques BNP de 0.15 y 0.10 mts Colocación de bloques SNP de 0.15 y 0.10 mts Construcion de registro sanitario y registro trampa de grasa Acero para dintel, losa y vigas Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas Colocación de bloques antepecho de 0.15 mts Fino , zabaletas y impermeabilizante Pañete exterior y antepecho Encofrado para dintel, losa y vigas Fraguache interior, exterior y techo + techo galeria Suministro e instalacion de accesorios electricos Suministro e instalacion de accesorios sanitarios Pintura acrilica interior y exterior Cocina (gabinetes de piso, pared y topes de cocina en granito) Limpieza general continua y final Pañete interior, en techo y mochetas Portaje Ventanas Jardineria en patio Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de
  • 60.

    No. Actividad Descripción(t) Pésimo (t) Más probable (t)Optimo Duración 1 Replanteos casa Consta del confeccionado de la charrancha, marcar las zapatas de muros y columnas. 3 1 1 1 2 Conexiones temporales Poner en funcionamiento los servicios de agua, luz y aguas negras. 3 1 1 1 3 Habilitar área almacén materiales Delimitar el area donde se construira el almacen y construirlo. 4 2 1 2 4 Excavaciones de zapatas muros bloques y columnas Excavacion a mano de las zapatas de muros y columnas 4 2 1 2 5 Acero para zapatas de muros y columnas y para columnas de carga Armado y colocacion de acero para las zapatas del muros y columnas. 5 3 2 3 6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas Ligado del hormigon con su especificacion f´c= 210 kg/cm2 en trompo y vaciado en las diferentes zapatas de muros y columnas. 3 1 1 1 7 Colocación de bloques BNP de 0.15 y 0.10 mts Postura de bloques de hormigon bajo nivel de piso con todos lo huecos del bloque relleno de hormigon simple. 5 3 2 3 8 Colocación de bloques SNP de 0.15 y 0.10 mts Postura de bloques sobre nivel de piso, con las especificaciones en planos. 6 4 3 4 9 Construcion de registro sanitario y registro trampa de grasa Excavacion y construccion de registro sanitarios y trampa de grasa. 7 5 4 5 10 Acero para dintel, losa y vigas Armado y colocacion de acero para dinteles, losa y vigas con las especificaciones que demandan los planos. 5 3 1 3 11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas Ligado del hormigon con su especificacion f´c= 210 kg/cm2 en trompo y vaciado en los dinteles, losa y viga. 3 1 1 1 12 Colocación de bloques antepecho de 0.15 mts Postura de bloques en antepecho con bloques de 0.15mtrs. Con las especificaciones que demandan los planos. 4 2 1 2 13 Fino , zabaletas y impermeabilizante Ligado y vaciado de mortero para el fino y sabaleta, curado del hormigos y luego colocacion del impermeabilizante. 7 5 4 5 14 Pañete exterior y antepecho Pañete de los muros exteriores y antepecho. 5 3 2 3 15 Encofrado para dintel, losa y vigas Preparacion del encofrado para la losa, dintel y vigas. 16 14 13 14 16 Fraguache interior, exterior y techo + techo galeria Fraguache en muros interiore y exteriores, techo y galeria. 4 2 1 2 17 Suministro e instalacion de accesorios electricos Compra y colocacion de instalaciones electricas con sus accesorios correspondientes. 27 25 24 25 18 Suministro e instalacion de accesorios sanitarios Compra y colocacion de instalaciones sanitarias con sus accesorios correspondientes. 27 25 24 25 19 Pañete interior, en techo y mochetas Pañete de los muros interiores junto al pañete de mochetas. 7 5 4 5 20 Portaje Colocacion de puertas. 8 6 5 6 21 Ventanas Colocacion de ventanas. 8 6 5 6 22 Jardineria en patio Construccion de la jardineria exterior y colocacion de piezas de gramaquin. 6 4 3 4 23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina Vaciado con hormigon armado en ligadora, curado del hormigon, colocacion de pisos, colocacion de ceramica y colocacion de zocalos. 8 6 5 6 24 Pintura acrilica interior y exterior Pintura para los muros exteriores, antepecho, techo, muros interiores, vigas y columnas. 5 3 2 3 25 Cocina (gabinetes de piso, pared y topes de cocina en granito) Colocacion de tope de granito, construccion y colocacion de ganitenes de piso para la cocina. 5 3 2 3 26 Limpieza general continua y final Limppieza final y correccion de algun detalle faltante. 3 1 1 1 MATRIZ DE TIEMPOS Unidad de Tiempo= Dias PRESUPUESTO PARA CONSTRUCCION DE CASA ( 62,0 MT2 )
  • 61.
    No. Actividad DescripciónAntecedentes Secuencias Duración 1 Replanteos casa Consta del confeccionado de la charrancha, marcar las zapatas de muros y columnas. - 5 1 2 Conexiones temporales Poner en funcionamiento los servicios de agua, luz y aguas negras. - 4 1 3 Habilitar área almacén materiales Delimitar el area donde se construira el almacen y construirlo. - - 2 4 Excavaciones de zapatas muros bloques y columnas Excavacion a mano de las zapatas de muros y columnas 2 - 2 5 Acero para zapatas de muros y columnas y para columnas de carga Armado y colocacion de acero para las zapatas del muros y columnas. 1 1 3 6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas Ligado del hormigon con su especificacion f´c= 210 kg/cm2 en trompo y vaciado en las diferentes zapatas de muros y columnas. 5 7 3 7 Colocación de bloques BNP de 0.15 y 0.10 mts Postura de bloques de hormigon bajo nivel de piso con todos lo huecos del bloque relleno de hormigon simple. 6 8, 9, 17, 18 3 8 Colocación de bloques SNP de 0.15 y 0.10 mts Postura de bloques sobre nivel de piso, con las especificaciones en planos. 8 10, 15 5 9 Construcion de registro sanitario y registro trampa de grasa Excavacion y construccion de registro sanitarios y trampa de grasa. 7 - 4 10 Acero para dintel, losa y vigas Armado y colocacion de acero para dinteles, losa y vigas con las especificaciones que demandan los planos. 8 11 3 11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas Ligado del hormigon con su especificacion f´c= 210 kg/cm2 en trompo y vaciado en los dinteles, losa y viga. 10 12 1 12 Colocación de bloques antepecho de 0.15 mts Postura de bloques en antepecho con bloques de 0.15mtrs. Con las especificaciones que demandan los planos. 11 13 2 13 Fino , zabaletas y impermeabilizante Ligado y vaciado de mortero para el fino y sabaleta, curado del hormigos y luego colocacion del impermeabilizante. 12 14 5 14 Pañete exterior y antepecho Pañete de los muros exteriores y antepecho. 13 - 3 15 Encofrado para dintel, losa y vigas Preparacion del encofrado para la losa, dintel y vigas. 8 16 14 16 Fraguache interior, exterior y techo + techo galeria Fraguache en muros interiore y exteriores, techo y galeria. 15 19, 20, 21 2 17 Suministro e instalacion de accesorios electricos Compra y colocacion de instalaciones electricas con sus accesorios correspondientes. 7 - 25 18 Suministro e instalacion de accesorios sanitarios Compra y colocacion de instalaciones sanitarias con sus accesorios correspondientes. 7 22 25 19 Pañete interior, en techo y mochetas Pañete de los muros interiores junto al pañete de mochetas. 16 23 5 20 Portaje Colocacion de puertas. 16 - 6 21 Ventanas Colocacion de ventanas. 16 - 6 22 Jardineria en patio Construccion de la jardineria exterior. 18 - 4 23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina Vaciado con hormigon armado en ligadora, curado del hormigon, colocacion de pisos, colocacion de ceramica y colocacion de zocalos. 19 24, 25 6 24 Pintura acrilica interior y exterior Pintura para los muros exteriores, antepecho, techo, muros interiores, vigas y columnas. 23 - 3 25 Cocina (gabinetes de piso, pared y topes de cocina en granito) Colocacion de tope de granito, construccion y colocacion de ganitenes de piso para la cocina. 23 26 1 26 Limpieza general continua y final ( incluye bote de escombros ) Limppieza final y correccion de algun detalle faltante. 25 - 1 Simultaneo con actividades 8, 17, 18 MATRIZ DE INFORMACION PRESUPUESTO PARA CONSTRUCCION DE CASA ( 62,0 MT2 ) Observaciones Simultaneo con actividad 2 y 3. Simultaneo con actividad 1 y 3. Simultaneo con actividad 1 y 2. Simultaneo con colocacion de acerod en zapata y columnas. - - - Simultaneo con actividades 9, 17, 18 Simultaneo con actividades Simultaneo con actividades 15, 17, 18 Simultaneo con actividades 15, 17, 18 Simultaneo con actividades 15, 17, 18 Simultaneo con actividades 15, 17, 18 Simultaneo con actividades Simultaneo con actividades 10, 11, 12, 13, 14, 17, 18 Simultaneo con actividades 17, 18 Simultaneo con actividades 8, 9, 10, 11, 12, 13, 14, 15, 16, Simultaneo con actividades 8, 9, 10, 11, 12, 13, 14, 15, 16, Simultaneo con actividades 17, 18, 20, 21, 22 Simultaneo con actividades Simultaneo con actividades Simultaneo con actividades 20, 21, 22 Simultaneo con actividades 25 Simultaneo con actididad 24 Actividad final
  • 62.

    Replanteoscasa Conexionestemporales Habilitaráreaalmacénmateriales Excavacionesdezapatasmurosbloquesy columnas Aceroparazapatasdemurosycolumnasypara columnasdecarga LigadoyvaciadoHormigónFc=210kg/cm2para zapatasdemurosycolumnas ColocacióndebloquesBNPde0.15y0.10mts ColocacióndebloquesSNPde0.15y0.10mts Construcionderegistrosanitarioyregistro trampadegrasa Aceroparadintel,losayvigas LigadoyvaciadoHormigónFc=210kg/cm2para dintel,losayvigas Colocacióndebloquesantepechode0.15mts Fino,zabaletasyimpermeabilizante Pañeteexterioryantepecho Encofradoparadintel,losayvigas Fraguacheinterior,exteriorytecho+techo galeria Suministroeinstalaciondeaccesorioselectricos Suministroeinstalaciondeaccesoriossanitarios Pañeteinterior,entechoymochetas Portaje Ventanas Jardineriaenpatio Tortadepiso,porcelanatoen1ernivel,zocalos, pisosdebañosyrevestimientosdebañosy cocina Pinturaacrilicainterioryexterior Cocina(gabinetesdepiso,paredytopesde cocinaengranito) Limpiezageneralcontinuayfinal 1 2 34 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 1 Replanteos casa X 2 Conexiones temporales X 3 Habilitar área almacén materiales 4 Excavaciones de zapatas muros bloques y columnas 5 Acero para zapatas de muros y columnas y para columnas de carga X 6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas X 7 Colocación de bloques BNP de 0.15 y 0.10 mts X X X X 8 Colocación de bloques SNP de 0.15 y 0.10 mts X X 9 Construcion de registro sanitario y registro trampa de grasa 10 Acero para dintel, losa y vigas X 11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas X 12 Colocación de bloques antepecho de 0.15 mts X 13 Fino , zabaletas y impermeabilizante X 14 Pañete exterior y antepecho 15 Encofrado para dintel, losa y vigas X 16 Fraguache interior, exterior y techo + techo galeria X X X 17 Suministro e instalacion de accesorios electricos 18 Suministro e instalacion de accesorios sanitarios X 19 Pañete interior, en techo y mochetas X 20 Portaje 21 Ventanas 22 Jardineria en patio 23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina X X 24 Pintura acrilica interior y exterior 25 Cocina (gabinetes de piso, pared y topes de cocina en granito) X 26 Limpieza general continua y final Actividad anterior Actividadsiguiente ANTECEDENTES SECUENCIAS ANTECEDENTES SECUENCIAS
  • 63.
    No. Actividad tO $N $L m 1 Replanteos casa 1 1 5,158.40 5,158.40 0.00 2 Conexiones temporales 1 1 1,920.00 1,920.00 0.00 3 Habilitar área almacén materiales 2 1 7,680.00 10,944.00 3,264.00 4 Excavaciones de zapatas muros bloques y columnas 2 1 10,857.47 15,471.90 4,614.43 5 Acero para zapatas de muros y columnas y para columnas de carga 3 2 27,212.24 42,632.52 15,420.27 6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1 1 80,477.38 80,477.38 0.00 7 Colocación de bloques BNP de 0.15 y 0.10 mts 3 2 43,597.76 68,303.16 24,705.40 8 Colocación de bloques SNP de 0.15 y 0.10 mts 4 3 120,968.43 198,085.80 77,117.37 9 Construcion de registro sanitario y registro trampa de grasa 5 4 5,833.73 9,800.66 3,966.94 10 Acero para dintel, losa y vigas 3 1 64,715.10 101,386.99 18,335.94 11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas 1 1 78,137.87 78,137.87 0.00 12 Colocación de bloques antepecho de 0.15 mts 2 1 6,864.38 9,781.75 2,917.36 13 Fino , zabaletas y impermeabilizante 5 4 45,705.47 76,785.18 31,079.72 14 Pañete exterior y antepecho 3 2 25,517.06 39,976.73 14,459.67 15 Encofrado para dintel, losa y vigas 14 13 39,446.53 70,581.11 31,134.58 16 Fraguache interior, exterior y techo + techo galeria 1 1 9,983.36 9,983.36 0.00 17 Suministro e instalacion de accesorios electricos 25 24 68,808.91 124,956.98 56,148.07 18 Suministro e instalacion de accesorios sanitarios 25 24 60,787.20 110,389.56 49,602.36 19 Pañete interior, en techo y mochetas 5 4 69,907.75 117,445.01 47,537.27 20 Portaje 6 5 42,880.00 73,253.33 30,373.33 21 Ventanas 6 5 22,605.23 38,617.26 16,012.04 22 Jardineria en patio 4 3 4,160.00 6,812.00 2,652.00 23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 5 119,937.24 204,892.79 84,955.55 24 Pintura acrilica interior y exterior 3 2 37,757.07 59,152.74 21,395.67 25 Cocina (gabinetes de piso, pared y topes de cocina en granito) 3 2 18,408.33 28,839.71 10,431.38 26 Limpieza general continua y final 1 1 1,920.00 1,920.00 0.00 m= Pendiente m= Costo/tiempo= ($L-$N)/(t-o) t= Tiempo Estandar Nota: o= Tiempo Optimo $N= Costo a tiempo Estándar $L= Costo a tiempo Optimo PRESUPUESTO PARA CONSTRUCCION DE CASA ( 62,0 MT2 ) El valor de $L se obtuvo realizando una relación de tres con los días a tiempo estándar y su costo asociado. Luego se consideró el 85% del valor: ( 0.85*($N * O)/t ) MATRIZ DE PENDIENTES
  • 64.
    Costos Directos Proyectoen Tiempo Estandar= RD $ 797,849.15 Costo Operación Proyecto en Tiempo Estándar= RD $ 223,397.76 No. Actividad e Costo Total de Proyecto (Sin ITBIS)= RD $ 1,021,246.91 1 Replanteos casa 1 2 Conexiones temporales 1 Duración Estándar de Proyecto= 44 días 3 Habilitar área almacén materiales 2 Costo Operación / día= RD $ 5,077.22 4 Excavaciones de zapatas muros bloques y columnas 2 5 Acero para zapatas de muros y columnas y para columnas de carga 3 Actividad Compresiones Operaciones Costo Total Costo Directo Total Costo Operación Costo Total Proyecto 6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1 16 1 día 1*4,242.93 RD $ 4,242.93 44-1= 43.00 RD $ 797,849.15 RD $ 218,320.54 RD $ 1,020,412.62 7 Colocación de bloques BNP de 0.15 y 0.10 mts 3 25 1 día 1*10,431.38 RD $ 10,431.38 43-1= 42 RD $ 1,020,412.62 RD $ 213,243.32 RD $ 1,244,087.32 8 Colocación de bloques SNP de 0.15 y 0.10 mts 4 9 Construcion de registro sanitario y registro trampa de grasa 5 10 Acero para dintel, losa y vigas 3 11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas 1 12 Colocación de bloques antepecho de 0.15 mts 2 13 Fino , zabaletas y impermeabilizante 5 14 Pañete exterior y antepecho 3 15 Encofrado para dintel, losa y vigas 14 16 Fraguache interior, exterior y techo + techo galeria 1 17 Suministro e instalacion de accesorios electricos 25 18 Suministro e instalacion de accesorios sanitarios 25 19 Pañete interior, en techo y mochetas 5 20 Portaje 6 21 Ventanas 6 22 Jardineria en patio 4 23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 24 Pintura acrilica interior y exterior 3 25 Cocina (gabinetes de piso, pared y topes de cocina en granito) 3 26 Limpieza general continua y final 1 Duración= Costos Directos Proyecto Comprimido= Costo Operación Proyecto Comprimido= Nuevo Costo de Proyecto = TABLA DE COMPRESIONES SUCESIVAS PROYECTO COMPRIMIDO ADECUACION DE ZONA PARA PARQUEO EN CENTRO ASISTENCIAL AL AUTOMOVILISTA COSTO OPTIMO Y DURACION DEL PROYECTO Duración Reducida
  • 65.
    Costo RD $ 5,158.40 RD$ 1,920.00 RD $ 7,680.00 RD $ 10,857.47 RD $ 27,212.24 RD $ 80,477.38 RD $ 43,597.76 RD $ 120,968.43 RD $ 5,833.73 RD $ 64,715.10 RD $ 78,137.87 RD $ 6,864.38 RD $ 45,705.47 RD $ 25,517.06 RD $ 39,446.53 RD $ 4,906.14 RD $ 68,808.91 RD $ 60,787.20 RD $ 69,907.75 RD $ 42,880.00 RD $ 22,605.23 RD $ 4,160.00 RD $ 119,937.24 RD $ 37,757.07 RD $ 18,408.33 RD $ 1,920.00 43 RD $ 802,092.08 RD $ 218,320.54 RD $ 1,020,412.62 PROYECTO COMPRIMIDO COSTO OPTIMO Y DURACION DEL PROYECTO
  • 66.
    No. Actividad Descripción (t)Pésimo (t)Másprobable (t)Optimo Duración 1 Replanteos casa Consta delconfeccionado de la charrancha, marcar las zapatas de muros y columnas. 3 1 1 1 2 Conexiones temporales Poner en funcionamiento los servicios de agua, luz y aguas negras. 3 1 1 1 3 Habilitar área almacén materiales Delimitar el area donde se construira el almacen y construirlo. 4 2 1 2 4 Excavaciones de zapatas muros bloques y columnas Excavacion a mano de las zapatas de muros y columnas 4 2 1 2 5 Acero para zapatas de muros y columnas y para columnas de carga Armado y colocacion de acero para las zapatas del muros y columnas. 5 3 2 3 6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas Ligado del hormigon con su especificacion f´c= 210 kg/cm2 en trompo y vaciado en las diferentes zapatas de muros y 3 1 1 1 7 Colocación de bloques BNP de 0.15 y 0.10 mts Postura de bloques de hormigon bajo nivel de piso con todos lo huecos del bloque relleno de hormigon simple. 5 3 2 3 8 Colocación de bloques SNP de 0.15 y 0.10 mts Postura de bloques sobre nivel de piso, con las especificaciones en planos. 6 4 3 4 9 Construcion de registro sanitario y registro trampa de grasa Excavacion y construccion de registro sanitarios y trampa de grasa. 7 5 4 5 10 Acero para dintel, losa y vigas Armado y colocacion de acero para dinteles, losa y vigas con las especificaciones que demandan los planos. 5 3 1 3 11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas Ligado del hormigon con su especificacion f´c= 210 kg/cm2 en trompo y vaciado en los dinteles, losa y viga. 3 1 1 1 12 Colocación de bloques antepecho de 0.15 mts Postura de bloques en antepecho con bloques de 0.15mtrs. Con las especificaciones que demandan los planos. 4 2 1 2 13 Fino , zabaletas y impermeabilizante Ligado y vaciado de mortero para el fino y sabaleta, curado del hormigos y luego colocacion del impermeabilizante. 7 5 4 5 14 Pañete exterior y antepecho Pañete de los muros exteriores y antepecho. 5 3 2 3 15 Encofrado para dintel, losa y vigas Preparacion del encofrado para la losa, dintel y vigas. 16 14 13 14 16 Fraguache interior, exterior y techo + techo galeria Fraguache en muros interiore y exteriores, techo y galeria. 3 1 1 1 17 Suministro e instalacion de accesorios electricos Compra y colocacion de instalaciones electricas con sus accesorios correspondientes. 27 25 24 25 18 Suministro e instalacion de accesorios sanitarios Compra y colocacion de instalaciones sanitarias con sus accesorios correspondientes. 27 25 24 25 19 Pañete interior, en techo y mochetas Pañete de los muros interiores junto al pañete de mochetas. 7 5 4 5 20 Portaje Colocacion de puertas. 8 6 5 6 21 Ventanas Colocacion de ventanas. 8 6 5 6 22 Jardineria en patio Construccion de la jardineria exterior y colocacion de piezas de gramaquin. 6 4 3 4 23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina Vaciado con hormigon armado en ligadora, curado del hormigon, colocacion de pisos, colocacion de ceramica y colocacion de zocalos. 8 6 5 6 24 Pintura acrilica interior y exterior Pintura para los muros exteriores, antepecho, techo, muros interiores, vigas y columnas. 5 3 2 3 25 Cocina (gabinetes de piso, pared y topes de cocina en granito) Colocacion de tope de granito, construccion y colocacion de ganitenes de piso para la cocina. 5 3 2 3 26 Limpieza general continua y final Limppieza final y correccion de algun detalle faltante. 3 1 1 1 Duración= ( o + 4*M + p)/6 MATRIZ DE TIEMPOS Unidad de Tiempo= Dias PRESUPUESTO PARA CONSTRUCCION DE CASA ( 62,0 MT2 )
  • 67.
    No. Actividad Descripción Antecedentes Secuencias Duración 1Replanteos casa Consta del confeccionado de la charrancha, marcar las zapatas de muros y columnas. - 5 1 2 Conexiones temporales Poner en funcionamiento los servicios de agua, luz y aguas negras. - 4 1 3 Habilitar área almacén materiales Delimitar el area donde se construira el almacen y construirlo. - - 2 4 Excavaciones de zapatas muros bloques y columnas Excavacion a mano de las zapatas de muros y columnas 2 - 2 5 Acero para zapatas de muros y columnas y para columnas de carga Armado y colocacion de acero para las zapatas del muros y columnas. 1 6 3 6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas Ligado del hormigon con su especificacion f´c= 210 kg/cm2 en trompo y vaciado en las diferentes zapatas de muros y columnas. 5 7 1 7 Colocación de bloques BNP de 0.15 y 0.10 mts Postura de bloques de hormigon bajo nivel de piso con todos lo huecos del bloque relleno de hormigon simple. 6 8, 17, 18. 3 8 Colocación de bloques SNP de 0.15 y 0.10 mts Postura de bloques sobre nivel de piso, con las especificaciones en planos. 7 9, 10, 15. 4 9 Construcion de registro sanitario y registro trampa de grasa Excavacion y construccion de registro sanitarios y trampa de grasa. 8 - 5 10 Acero para dintel, losa y vigas Armado y colocacion de acero para dinteles, losa y vigas con las especificaciones que demandan los planos. 8 11 3 11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas Ligado del hormigon con su especificacion f´c= 210 kg/cm2 en trompo y vaciado en los dinteles, losa y viga. 10 12 1 12 Colocación de bloques antepecho de 0.15 mts Postura de bloques en antepecho con bloques de 0.15mtrs. Con las especificaciones que demandan los planos. 11 13 2 13 Fino , zabaletas y impermeabilizante Ligado y vaciado de mortero para el fino y sabaleta, curado del hormigos y luego colocacion del impermeabilizante. 12 14 5 14 Pañete exterior y antepecho Pañete de los muros exteriores y antepecho. 13 - 3 15 Encofrado para dintel, losa y vigas Preparacion del encofrado para la losa, dintel y vigas. 8 16 14 16 Fraguache interior, exterior y techo + techo galeria Fraguache en muros interiore y exteriores, techo y galeria. 15 19, 20. 2 17 Suministro e instalacion de accesorios electricos Compra y colocacion de instalaciones electricas con sus accesorios correspondientes. 7 - 25 18 Suministro e instalacion de accesorios sanitarios Compra y colocacion de instalaciones sanitarias con sus accesorios correspondientes. 7 22 25 19 Pañete interior, en techo y mochetas Pañete de los muros interiores junto al pañete de mochetas. 16 23 5 20 Portaje Colocacion de puertas. 16 21 6 21 Ventanas Colocacion de ventanas. 20 - 6 22 Jardineria en patio Construccion de la jardineria exterior y colocacion de piezas de gramaquin. 18 - 4 23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina Vaciado con hormigon armado en ligadora, curado del hormigon, colocacion de pisos, colocacion de ceramica y colocacion de zocalos. 19 24, 25. 6 24 Pintura acrilica interior y exterior Pintura para los muros exteriores, antepecho, techo, muros interiores, vigas y columnas. 23 - 3 25 Cocina (gabinetes de piso, pared y topes de cocina en granito) Colocacion de tope de granito, construccion y colocacion de ganitenes de piso para la cocina. 23 26 3 26 Limpieza general continua y final ( incluye bote de escombros ) Limppieza final y correccion de algun detalle faltante. 25 - 1 MATRIZ DE INFORMACION Simultanea con las actividades 9, 15, 17, 18. Simultanea con las actividades 15, 17, 18. Simultanea con las actividades 15, 17, 18. PRESUPUESTO PARA CONSTRUCCION DE CASA ( 62,0 MT2 ) Observaciones Simultanea con las actividades 2 y 3. Simultanea con las actividades 1 y 3. Simultanea con las actividades 8, 9, 10, 11, 12, 14, 17, 20. Simultanea con las actividades 17, 18, 19. Simultanea con las actividades 22, 23. Simultanea con las actividades 21, 22. Simultanea con las actividades 1 y 2. Simultanea con las actividades 17 y 18. - Simultanea con las actividad 5. Simultanea con la actividad 4. - Simultanea con las actividades 10 y 15. Simultanea con las actividades 15, 17, 18. Simultanea con las actividades 9, 10, 11, 12, 14, 17, 18. Simultanea con las actividades 17 y 18. Simultanea con las actividades 8, 9, 10, 11, 12, 14, 18, 20. Simultanea con las actividades 9, 15, 17, 18. Simultanea con las actividades 21, 23. Simultanea con las actividade 25. Simultanea con la actividad 24. - Simultanea con las actividades 17, 18, 20.
  • 68.

    Replanteoscasa Conexionestemporales Habilitaráreaalmacénmateriales Excavacionesdezapatasmurosbloquesy columnas Aceroparazapatasdemurosycolumnasypara columnasdecarga LigadoyvaciadoHormigónFc=210kg/cm2para zapatasdemurosycolumnas ColocacióndebloquesBNPde0.15y0.10mts ColocacióndebloquesSNPde0.15y0.10mts Construcionderegistrosanitarioyregistro trampadegrasa Aceroparadintel,losayvigas LigadoyvaciadoHormigónFc=210kg/cm2para dintel,losayvigas Colocacióndebloquesantepechode0.15mts Fino,zabaletasyimpermeabilizante Pañeteexterioryantepecho Encofradoparadintel,losayvigas Fraguacheinterior,exteriorytecho+techo galeria Suministroeinstalaciondeaccesorioselectricos Suministroeinstalaciondeaccesoriossanitarios Pañeteinterior,entechoymochetas Portaje Ventanas Jardineriaenpatio Tortadepiso,porcelanatoen1ernivel,zocalos, pisosdebañosyrevestimientosdebañosy cocina Pinturaacrilicainterioryexterior Cocina(gabinetesdepiso,paredytopesde cocinaengranito) Limpiezageneralcontinuayfinal 1 2 34 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 1 Replanteos casa X 2 Conexiones temporales X 3 Habilitar área almacén materiales 4 Excavaciones de zapatas muros bloques y columnas 5 Acero para zapatas de muros y columnas y para columnas de carga X 6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas X 7 Colocación de bloques BNP de 0.15 y 0.10 mts X X X 8 Colocación de bloques SNP de 0.15 y 0.10 mts X X X 9 Construcion de registro sanitario y registro trampa de grasa 10 Acero para dintel, losa y vigas X 11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas X 12 Colocación de bloques antepecho de 0.15 mts X 13 Fino , zabaletas y impermeabilizante X 14 Pañete exterior y antepecho 15 Encofrado para dintel, losa y vigas X 16 Fraguache interior, exterior y techo + techo galeria X X 17 Suministro e instalacion de accesorios electricos 18 Suministro e instalacion de accesorios sanitarios X 19 Pañete interior, en techo y mochetas X 20 Portaje X 21 Ventanas 22 Jardineria en patio 23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina X X 24 Pintura acrilica interior y exterior 25 Cocina (gabinetes de piso, pared y topes de cocina en granito) X 26 Limpieza general continua y final Actividadsiguiente Actividad anterior ANTECEDENTES SECUENCIAS ANTECEDENTES SECUENCIAS
  • 69.
    No. Actividad tO $N $L m 1 Replanteos casa 1 1 5,158.40 5,158.40 0.00 2 Conexiones temporales 1 1 1,920.00 1,920.00 0.00 3 Habilitar área almacén materiales 2 1 7,680.00 10,944.00 3,264.00 4 Excavaciones de zapatas muros bloques y columnas 2 1 10,857.47 15,471.90 4,614.43 5 Acero para zapatas de muros y columnas y para columnas de carga 3 2 27,212.24 42,632.52 15,420.27 6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1 1 80,477.38 80,477.38 0.00 7 Colocación de bloques BNP de 0.15 y 0.10 mts 3 2 43,597.76 68,303.16 24,705.40 8 Colocación de bloques SNP de 0.15 y 0.10 mts 4 3 120,968.43 198,085.80 77,117.37 9 Construcion de registro sanitario y registro trampa de grasa 5 4 5,833.73 9,800.66 3,966.94 10 Acero para dintel, losa y vigas 3 1 64,715.10 101,386.99 18,335.94 11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas 1 1 78,137.87 78,137.87 0.00 12 Colocación de bloques antepecho de 0.15 mts 2 1 6,864.38 9,781.75 2,917.36 13 Fino , zabaletas y impermeabilizante 5 4 45,705.47 76,785.18 31,079.72 14 Pañete exterior y antepecho 3 2 25,517.06 39,976.73 14,459.67 15 Encofrado para dintel, losa y vigas 14 13 39,446.53 70,581.11 31,134.58 16 Fraguache interior, exterior y techo + techo galeria 1 1 14,226.29 14,226.29 0.00 17 Suministro e instalacion de accesorios electricos 25 24 68,808.91 124,956.98 56,148.07 18 Suministro e instalacion de accesorios sanitarios 25 24 60,787.20 110,389.56 49,602.36 19 Pañete interior, en techo y mochetas 5 4 69,907.75 117,445.01 47,537.27 20 Portaje 6 5 42,880.00 73,253.33 30,373.33 21 Ventanas 6 5 22,605.23 38,617.26 16,012.04 22 Jardineria en patio 4 3 4,160.00 6,812.00 2,652.00 23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 5 119,937.24 204,892.79 84,955.55 24 Pintura acrilica interior y exterior 3 2 37,757.07 59,152.74 21,395.67 25 Cocina (gabinetes de piso, pared y topes de cocina en granito) 3 2 18,408.33 28,839.71 10,431.38 26 Limpieza general continua y final 1 1 1,920.00 1,920.00 0.00 m= Pendiente m= Costo/tiempo= ($L-$N)/(t-o) t= Tiempo Estandar Nota: o= Tiempo Optimo $N= Costo a tiempo Estándar $L= Costo a tiempo Optimo El valor de $L se obtuvo realizando una relación de tres con los días a tiempo estándar y su costo asociado. Luego se consideró el 85% del valor: ( 0.85*($N * O)/t ) MATRIZ DE PENDIENTES CON LIMITACIONES PRESUPUESTO PARA CONSTRUCCION DE CASA ( 62,0 MT2 )
  • 70.
    1 2 34 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 HT HL HI Compresion No. Actividad Secuencia o M p e $N $L m TR1 IP1 TR2 IP2 dias % CI D D D % σ 1 Replanteos casa 1 1 3 1 5,158.40 5,158.40 0.00 0 0 1 1 0 0.00 C 0 0 0 0.25 0.33 2 Conexiones temporales 1 1 3 1 1,920.00 1,920.00 0.00 0 0 1 2 0 0.00 0 0 0 0.25 0.33 3 Habilitar área almacén materiales 1 2 4 2 7,680.00 10,944.00 3,264.00 0 0 4 4 2 0.00 2 2 1 0.54 0.50 4 Excavaciones de zapatas muros bloques y columnas 1 2 4 2 10,857.47 15,471.90 4,614.43 2 1 4 4 1 0.00 0 1 1 0.54 0.50 5 Acero para zapatas de muros y columnas y para columnas de carga 2 3 5 3 27,212.24 42,632.52 15,420.27 1 1 4 4 0 0.00 C 0 0 1 0.37 0.50 6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1 1 3 1 80,477.38 80,477.38 0.00 4 4 5 5 0 0.00 C 0 0 0 0.25 0.33 7 Colocación de bloques BNP de 0.15 y 0.10 mts 2 3 5 3 43,597.76 68,303.16 24,705.40 5 5 8 8 0 0.00 C 0 0 1 0.37 0.50 8 Colocación de bloques SNP de 0.15 y 0.10 mts 3 4 6 4 120,968.43 198,085.80 77,117.37 8 8 13 13 1 0.20 C 1 1 1 0.28 0.50 9 Construcion de registro sanitario y registro trampa de grasa 4 5 7 5 5,833.73 9,800.66 3,966.94 13 13 25 17 7 1.32 7 7 1 0.23 0.50 10 Acero para dintel, losa y vigas 1 3 5 3 64,715.10 101,386.99 18,335.94 13 13 16 22 0 0.00 0 0 2 0.67 0.67 11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas 1 1 3 1 78,137.87 78,137.87 0.00 22 16 17 23 0 0.00 6 0 0 0.25 0.33 12 Colocación de bloques antepecho de 0.15 mts 1 2 4 2 6,864.38 9,781.75 2,917.36 23 16 19 25 6 0.00 6 1 1 0.54 0.50 13 Fino , zabaletas y impermeabilizante 4 5 7 5 45,705.47 76,785.18 31,079.72 25 19 27 33 3 0.00 3 3 1 0.23 0.50 14 Pañete exterior y antepecho 2 3 5 3 25,517.06 39,976.73 14,459.67 30 24 33 33 6 0.00 0 6 1 0.37 0.50 15 Encofrado para dintel, losa y vigas 13 14 16 14 39,446.53 70,581.11 31,134.58 13 13 27 27 0 0.00 C 0 0 1 0.08 0.50 16 Fraguache interior, exterior y techo + techo galeria 1 1 3 1 9,983.36 9,983.36 0.00 27 27 28 28 0 0.00 C 0 0 0 0.00 0.33 17 Suministro e instalacion de accesorios electricos 24 25 27 25 68,808.91 124,956.98 56,148.07 8 8 43 43 10 0.39 10 10 1 0.05 0.50 18 Suministro e instalacion de accesorios sanitarios 24 25 27 25 60,787.20 110,389.56 49,602.36 8 8 33 39 0 0.00 0 0 1 0.05 0.50 19 Pañete interior, en techo y mochetas 4 5 7 5 69,907.75 117,445.01 47,537.27 28 28 33 33 0 0.00 C 0 0 1 0.23 0.50 20 Portaje 5 6 8 6 42,880.00 73,253.33 30,373.33 28 28 39 39 5 0.78 5 5 1 0.19 0.50 21 Ventanas 5 6 8 6 22,605.23 38,617.26 16,012.04 39 34 42 42 3 0.49 2 2 1 0.19 0.50 22 Jardineria en patio 3 4 6 4 4,160.00 6,812.00 2,652.00 39 33 43 43 6 0.00 0 6 1 0.28 0.50 23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 5 6 8 6 119,937.24 204,892.79 84,955.55 33 33 39 39 0 0.00 C 0 0 1 0.19 0.50 24 Pintura acrilica interior y exterior 2 3 5 3 37,757.07 59,152.74 21,395.67 39 39 43 43 1 0.26 1 1 1 0.37 0.50 25 Cocina (gabinetes de piso, pared y topes de cocina en granito) 2 3 5 3 18,408.33 28,839.71 10,431.38 39 39 42 42 0 0.00 C 0 0 1 0.37 0.50 26 Limpieza general continua y final 1 1 3 1 1,920.00 1,920.00 0.00 42 42 43 43 0 0.00 C 0 0 0 0.25 0.33 Tiempos Costos Lecturas
  • 71.
    Desviación Ruta No. Actividadσ t Σt t + σ Σ(t + σ) 1 Replanteos casa 0.33 1 1 1.33 1.33 5 Acero para zapatas de muros y columnas y para columnas de carga 0.50 3 4 3.50 4.83 6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 0.33 1 5 1.33 6.16 7 Colocación de bloques BNP de 0.15 y 0.10 mts 0.50 3 8 3.50 9.66 8 Colocación de bloques SNP de 0.15 y 0.10 mts 0.50 4 12 4.50 14.16 15 Encofrado para dintel, losa y vigas 0.50 14 26 14.50 28.66 16 Fraguache interior, exterior y techo + techo galeria 0.50 1 27 1.50 30.16 19 Pañete interior, en techo y mochetas 0.50 5 32 5.50 35.66 23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.50 6 38 6.50 42.16 25 Cocina (gabinetes de piso, pared y topes de cocina en granito) 0.50 3 41 3.50 45.66 26 Limpieza general continua y final 0.33 1 42 1.33 46.99 Σ 5.00 El proyecto se va a ejecutar entre: 44 + 4.99 = 50 días Σt= Tiempo Programado Σ(t + σ)= Tiempo Tolerado 0.10 0.9204 1.10 0.2714 2.10 0.0358 0.20 0.8414 1.20 0.2302 2.20 0.0278 0.30 0.7642 1.30 0.1936 2.30 0.0214 0.40 0.6892 1.40 0.1616 2.40 0.0164 0.50 0.6170 1.50 0.1336 2.50 0.0124 0.60 0.5486 1.60 0.1096 2.60 0.0094 0.70 0.4840 1.70 0.0892 2.70 0.0070 0.80 0.4238 1.80 0.0718 2.80 0.0052 0.90 0.3682 1.90 0.0574 2.90 0.0038 1.00 0.3174 2.00 0.0456 3.00 0.0026 6 dias Probabilidad de que se atrase 1 dia¨? 0.2 x1 0.1 0.8414 y1 x 0.20 0.9204 x2 0.2 0.9204 y2 92% Probabilidad de que se atrase 3 dias? 0.6 x1 0.5 0.617 y1 x 0.60 0.5486 x2 0.6 0.5486 y2 55% σ Probabilidad de Retraso Retraso Previsto en el Camino Crítico DIAS TOLERADOS Desviación σ Probabilidad de Retraso σ Probabilid ad de Retraso
  • 72.

    Dia Actividades pordia Actividades Acumuladas Avance Programado por Dia Dia Actividades por dia Actividades Acumuladas Avance Programado por Dia 1 3 3 0.022 25 4 80 0.593 2 3 6 0.044 26 4 84 0.622 3 2 8 0.059 27 4 88 0.652 4 1 9 0.067 28 3 91 0.674 5 1 10 0.074 29 4 95 0.704 6 1 11 0.081 30 4 99 0.733 7 1 12 0.089 31 4 103 0.763 8 1 13 0.096 32 4 107 0.793 9 3 16 0.119 33 4 111 0.822 10 3 19 0.141 34 3 114 0.844 11 3 22 0.163 35 3 117 0.867 12 3 25 0.185 36 3 120 0.889 13 3 28 0.207 37 3 123 0.911 14 5 33 0.244 38 2 125 0.926 15 5 38 0.281 39 2 127 0.941 16 5 43 0.319 40 3 130 0.963 17 5 48 0.356 41 2 132 0.978 18 4 52 0.385 42 2 134 0.993 19 4 56 0.415 43 1 135 1.000 20 4 60 0.444 21 4 64 0.474 1 22 4 68 0.504 ∑ Act. Acum. 23 4 72 0.533 24 4 76 0.563 fa = 0.00741 CALCULO DE AVANCE PROGRAMADO
  • 73.
    1 2 34 5 6 7 8 9 10 11 12 13 Dia a(Actividades) e(DiasProgramados) 1/e DiasTranscurridos (Programados) Porcentaje Programados PorcentajeReal fa(FactorAvance) Avancedea Porcentaje acumulado AvancedelProyecto AvanceProgramado E(p) 1 Replanteos casa 1 1.00 1.00 1.00 1.00 0.0074 0.0074 T Conexiones temporales 1 1.00 1.00 1.00 1.00 0.0074 0.0074 T Habilitar área almacén materiales 2 0.50 1.00 0.50 0.50 0.0148 0.0074 0.0222 0.0222 1.000 2 T 0.0148 Habilitar área almacén materiales 2 0.50 2.00 1.00 1.00 0.0148 0.0148 T Excavaciones de zapatas muros bloques y columnas 2 0.50 1.00 0.50 0.50 0.0148 0.0074 Acero para zapatas de muros y columnas y para columnas de carga 3 0.33 1.00 0.33 0.33 0.0222 0.0073 0.0444 0.0444 0.998 3 T 0.0296 Excavaciones de zapatas muros bloques y columnas 2 0.50 2.00 1.00 1.00 0.0148 0.0148 T Acero para zapatas de muros y columnas y para columnas de carga 3 0.33 2.00 0.66 0.66 0.0222 0.0147 0.0591 0.0593 0.998 4 T 0.0444 Acero para zapatas de muros y columnas y para columnas de carga 3 0.33 3.00 1.00 1.00 0.0222 0.0222 T 0.0667 0.0667 1.000 5 T 0.0667 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1 1.00 1.00 1.00 1.00 0.0074 0.0074 T 0.0741 0.0741 1.000 6 T 0.0741 Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 1.00 0.33 0.00 0.0222 0.0000 0.0741 0.0815 0.909 7 T 0.0741 Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 2.00 0.66 0.50 0.0222 0.0111 0.0852 0.0889 0.958 8 T 0.0741 Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 3.00 1.00 1.00 0.0222 0.0222 T 0.0963 0.0963 1.000 9 T 0.0963 Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 1.00 0.20 0.00 0.0370 0.0000 Suministro e instalacion de accesorios electricos 25 0.04 1.00 0.04 0.00 0.1852 0.0000 Suministro e instalacion de accesorios sanitarios 25 0.04 1.00 0.04 0.00 0.1852 0.0000 0.0963 0.1185 0.813 10 T 0.0963 Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 2.00 0.40 0.00 0.0370 0.0000 Suministro e instalacion de accesorios electricos 25 0.04 2.00 0.08 0.00 0.1852 0.0000 Suministro e instalacion de accesorios sanitarios 25 0.04 2.00 0.08 0.00 0.1852 0.0000 0.0963 0.1407 0.684 11 T 0.0963 Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 3.00 0.60 0.50 0.0370 0.0185 Suministro e instalacion de accesorios electricos 25 0.04 3.00 0.12 0.12 0.1852 0.0222 Suministro e instalacion de accesorios sanitarios 25 0.04 3.00 0.12 0.12 0.1852 0.0222 0.1593 0.1630 0.977 12 T 0.0963 Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 4.00 0.80 0.00 0.0370 0.0000 Suministro e instalacion de accesorios electricos 25 0.04 4.00 0.16 0.16 0.1852 0.0296 Suministro e instalacion de accesorios sanitarios 25 0.04 4.00 0.16 0.16 0.1852 0.0296 0.1556 0.1852 0.840 13 T 0.0963 Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 5.00 1.00 1.00 0.0370 0.0370 T Suministro e instalacion de accesorios electricos 25 0.04 5.00 0.20 0.20 0.1852 0.0370 Suministro e instalacion de accesorios sanitarios 25 0.04 5.00 0.20 0.20 0.1852 0.0370 0.2074 0.2074 1.000 14 T 0.1333 Suministro e instalacion de accesorios electricos 25 0.04 6.00 0.24 0.24 0.1852 0.0444 Suministro e instalacion de accesorios sanitarios 25 0.04 6.00 0.24 0.24 0.1852 0.0444 Acero para dintel, losa y vigas 3 0.33 1.00 0.33 0.33 0.0222 0.0073 Construcion de registro sanitario y registro trampa de grasa 4 0.25 1.00 0.25 0.00 0.0296 0.0000 Encofrado para dintel, losa y vigas 14 0.07 1.00 0.07 0.07 0.1037 0.0073 0.2368 0.2444 0.969 15 T 0.1333 Suministro e instalacion de accesorios electricos 25 0.04 7.00 0.28 0.28 0.1852 0.0519 Suministro e instalacion de accesorios sanitarios 25 0.04 7.00 0.28 0.28 0.1852 0.0519 Acero para dintel, losa y vigas 3 0.33 2.00 0.66 0.66 0.0222 0.0147 Construcion de registro sanitario y registro trampa de grasa 4 0.25 2.00 0.50 0.30 0.0296 0.0089 Encofrado para dintel, losa y vigas 14 0.07 2.00 0.14 0.14 0.1037 0.0145 0.2751 0.2815 0.977 16 T 0.1333 Suministro e instalacion de accesorios electricos 25 0.04 8.00 0.32 0.32 0.1852 0.0593 Suministro e instalacion de accesorios sanitarios 25 0.04 8.00 0.32 0.32 0.1852 0.0593 Acero para dintel, losa y vigas 3 0.33 3.00 1.00 1.00 0.0222 0.0222 T Construcion de registro sanitario y registro trampa de grasa 4 0.25 3.00 0.75 0.70 0.0296 0.0207 Encofrado para dintel, losa y vigas 14 0.07 3.00 0.21 0.21 0.1037 0.0218 0.3166 0.3185 0.994 17 T 0.1556 Suministro e instalacion de accesorios electricos 25 0.04 9.00 0.36 0.36 0.1852 0.0667 Suministro e instalacion de accesorios sanitarios 25 0.04 9.00 0.36 0.36 0.1852 0.0667 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas 1 1.00 1.00 1.00 1.00 0.0074 0.0074 T Construcion de registro sanitario y registro trampa de grasa 4 0.25 4.00 1.00 1.00 0.0296 0.0296 T Encofrado para dintel, losa y vigas 14 0.07 4.00 0.28 0.28 0.1037 0.0290 0.3550 0.3556 0.998 18 T 0.1926 Suministro e instalacion de accesorios electricos 25 0.04 10.00 0.40 0.40 0.1852 0.0741 Suministro e instalacion de accesorios sanitarios 25 0.04 10.00 0.40 0.40 0.1852 0.0741 Colocación de bloques antepecho de 0.15 mts 2 0.50 1.00 0.50 0.50 0.0148 0.0074 Encofrado para dintel, losa y vigas 14 0.07 5.00 0.35 0.35 0.1037 0.0363 0.3844 0.3852 0.998 19 T 0.1926 Suministro e instalacion de accesorios electricos 25 0.04 11.00 0.44 0.44 0.1852 0.0815 Suministro e instalacion de accesorios sanitarios 25 0.04 11.00 0.44 0.44 0.1852 0.0815 Colocación de bloques antepecho de 0.15 mts 2 0.50 2.00 1.00 1.00 0.0148 0.0148 T Encofrado para dintel, losa y vigas 14 0.07 6.00 0.42 0.42 0.1037 0.0436 0.4139 0.4148 0.998 20 T 0.2074 Suministro e instalacion de accesorios electricos 25 0.04 12.00 0.48 0.48 0.1852 0.0889 Suministro e instalacion de accesorios sanitarios 25 0.04 12.00 0.48 0.48 0.1852 0.0889 Encofrado para dintel, losa y vigas 14 0.07 7.00 0.49 0.49 0.1037 0.0508 Fino , zabaletas y impermeabilizante 5 0.20 1.00 0.20 0.20 0.0370 0.0074 0.4434 0.4444 0.998 21 T 0.2074 Suministro e instalacion de accesorios electricos 25 0.04 13.00 0.52 0.52 0.1852 0.0963 Suministro e instalacion de accesorios sanitarios 25 0.04 13.00 0.52 0.52 0.1852 0.0963 Encofrado para dintel, losa y vigas 14 0.07 8.00 0.56 0.56 0.1037 0.0581 Fino , zabaletas y impermeabilizante 5 0.20 2.00 0.40 0.40 0.0370 0.0148 0.4729 0.4741 0.998 22 T 0.2074 Suministro e instalacion de accesorios electricos 25 0.04 14.00 0.56 0.56 0.1852 0.1037 Suministro e instalacion de accesorios sanitarios 25 0.04 14.00 0.56 0.56 0.1852 0.1037 Encofrado para dintel, losa y vigas 14 0.07 9.00 0.63 0.63 0.1037 0.0653 Fino , zabaletas y impermeabilizante 5 0.20 3.00 0.60 0.60 0.0370 0.0222 0.5024 0.5037 0.997 23 T 0.2074 Suministro e instalacion de accesorios electricos 25 0.04 15.00 0.60 0.60 0.1852 0.1111 Suministro e instalacion de accesorios sanitarios 25 0.04 15.00 0.60 0.60 0.1852 0.1111 Encofrado para dintel, losa y vigas 14 0.07 10.00 0.70 0.70 0.1037 0.0726 Fino , zabaletas y impermeabilizante 5 0.20 4.00 0.80 0.80 0.0370 0.0296 0.5319 0.5333 0.997 24 T 0.2074 Suministro e instalacion de accesorios electricos 25 0.04 16.00 0.64 0.64 0.1852 0.1185 Suministro e instalacion de accesorios sanitarios 25 0.04 16.00 0.64 0.64 0.1852 0.1185 Encofrado para dintel, losa y vigas 14 0.07 11.00 0.77 0.77 0.1037 0.0799
  • 74.
    Fino , zabaletasy impermeabilizante 5 0.20 5.00 1.00 1.00 0.0370 0.0370 T 0.5613 0.5630 0.997 25 T 0.2444 Suministro e instalacion de accesorios electricos 25 0.04 17.00 0.68 0.68 0.1852 0.1259 Suministro e instalacion de accesorios sanitarios 25 0.04 17.00 0.68 0.68 0.1852 0.1259 Encofrado para dintel, losa y vigas 14 0.07 12.00 0.84 0.84 0.1037 0.0871 Pañete exterior y antepecho 3 0.33 1.00 0.33 0.20 0.0222 0.0044 0.5879 0.5926 0.992 26 T 0.2444 Suministro e instalacion de accesorios electricos 25 0.04 18.00 0.72 0.72 0.1852 0.1333 Suministro e instalacion de accesorios sanitarios 25 0.04 18.00 0.72 0.72 0.1852 0.1333 Encofrado para dintel, losa y vigas 14 0.07 13.00 0.91 0.91 0.1037 0.0944 Pañete exterior y antepecho 3 0.33 2.00 0.66 0.80 0.0222 0.0178 0.6233 0.6222 1.002 27 T 0.2444 Suministro e instalacion de accesorios electricos 25 0.04 19.00 0.76 0.76 0.1852 0.1407 Suministro e instalacion de accesorios sanitarios 25 0.04 19.00 0.76 0.76 0.1852 0.1407 Encofrado para dintel, losa y vigas 14 0.07 14.00 1.00 1.00 0.1037 0.1037 T Pañete exterior y antepecho 3 0.33 3.00 1.00 1.00 0.0222 0.0222 T 0.6519 0.6519 1.000 28 T 0.3704 Suministro e instalacion de accesorios electricos 25 0.04 20.00 0.80 0.80 0.1852 0.1481 Suministro e instalacion de accesorios sanitarios 25 0.04 20.00 0.80 0.80 0.1852 0.1481 Fraguache interior, exterior y techo + techo galeria 1 1.00 1.00 1.00 1.00 0.0074 0.0074 T 0.6741 0.6741 1.000 29 T 0.3778 Suministro e instalacion de accesorios electricos 25 0.04 21.00 0.84 0.84 0.1852 0.1556 Suministro e instalacion de accesorios sanitarios 25 0.04 21.00 0.84 0.84 0.1852 0.1556 Pañete interior, en techo y mochetas 5 0.20 1.00 0.20 0.20 0.0370 0.0074 Portaje 6 0.17 1.00 0.17 0.17 0.0444 0.0076 0.7039 0.7037 1.000 30 T 0.3778 Suministro e instalacion de accesorios electricos 25 0.04 22.00 0.88 0.88 0.1852 0.1630 Suministro e instalacion de accesorios sanitarios 25 0.04 22.00 0.88 0.88 0.1852 0.1630 Pañete interior, en techo y mochetas 5 0.20 2.00 0.40 0.40 0.0370 0.0148 Portaje 6 0.17 2.00 0.34 0.34 0.0444 0.0151 0.7336 0.7333 1.000 31 T 0.3778 Suministro e instalacion de accesorios electricos 25 0.04 23.00 0.92 0.92 0.1852 0.1704 Suministro e instalacion de accesorios sanitarios 25 0.04 23.00 0.92 0.92 0.1852 0.1704 Pañete interior, en techo y mochetas 5 0.20 3.00 0.60 0.60 0.0370 0.0222 Portaje 6 0.17 3.00 0.51 0.51 0.0444 0.0227 0.7634 0.7630 1.001 32 T 0.3778 Suministro e instalacion de accesorios electricos 25 0.04 24.00 0.96 0.96 0.1852 0.1778 Suministro e instalacion de accesorios sanitarios 25 0.04 24.00 0.96 0.96 0.1852 0.1778 Pañete interior, en techo y mochetas 5 0.20 4.00 0.80 0.80 0.0370 0.0296 Portaje 6 0.17 4.00 0.68 0.68 0.0444 0.0302 0.7932 0.7926 1.001 33 T 0.3778 Suministro e instalacion de accesorios electricos 25 0.04 25.00 1.00 1.00 0.1852 0.1852 T Suministro e instalacion de accesorios sanitarios 25 0.04 25.00 1.00 1.00 0.1852 0.1852 T Pañete interior, en techo y mochetas 5 0.20 5.00 1.00 1.00 0.0370 0.0370 T Portaje 6 0.17 5.00 0.85 0.85 0.0444 0.0378 0.8230 0.8222 1.001 34 T 0.7852 Portaje 6 0.17 6.00 1.00 1.00 0.0444 0.0444 T Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 1.00 0.17 0.17 0.0444 0.0076 Jardineria en patio 4 0.25 1.00 0.25 0.00 0.0296 0.0000 0.8372 0.8444 0.991 35 T 0.8296 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 2.00 0.34 0.34 0.0444 0.0151 Jardineria en patio 4 0.25 2.00 0.50 0.50 0.0296 0.0148 Ventanas 6 0.17 1.00 0.17 0.17 0.0444 0.0076 0.8671 0.8667 1.001 36 T 0.8296 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 3.00 0.51 0.51 0.0444 0.0227 Jardineria en patio 4 0.25 3.00 0.75 0.50 0.0296 0.0148 Ventanas 6 0.17 2.00 0.34 0.34 0.0444 0.0151 0.8822 0.8889 0.993 37 T 0.8296 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 4.00 0.68 0.68 0.0444 0.0302 Jardineria en patio 4 0.25 4.00 1.00 1.00 0.0296 0.0296 T Ventanas 6 0.17 3.00 0.51 0.51 0.0444 0.0227 0.9121 0.9111 1.001 38 T 0.8593 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 5.00 0.85 0.85 0.0444 0.0378 Ventanas 6 0.17 4.00 0.68 0.40 0.0444 0.0178 0.9148 0.9259 0.988 39 T 0.8593 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 6.00 1.00 1.00 0.0444 0.0444 T Ventanas 5 0.20 5.00 0.85 0.60 0.0370 0.0222 0.9259 0.9407 0.984 40 T 0.9037 Ventanas 6 0.17 6.00 1.00 1.00 0.0444 0.0444 T Pintura acrilica interior y exterior 3 0.33 1.00 0.33 0.20 0.0222 0.0044 Cocina (gabinetes de piso, pared y topes de cocina en granito) 3 0.33 1.00 0.33 0.33 0.0222 0.0073 0.9599 0.9630 0.997 41 T 0.9481 Pintura acrilica interior y exterior 3 0.33 2.00 0.66 0.80 0.0222 0.0178 Cocina (gabinetes de piso, pared y topes de cocina en granito) 3 0.33 2.00 0.66 0.66 0.0222 0.0147 0.9806 0.9778 1.003 42 T 0.9481 Pintura acrilica interior y exterior 3 0.33 3.00 1.00 1.00 0.0222 0.0222 T Cocina (gabinetes de piso, pared y topes de cocina en granito) 3 0.33 3.00 1.00 1.00 0.0222 0.0222 T 0.9926 0.9926 1.000 43 T 0.9926 Limpieza general continua y final ( incluye bote de escombros ) 1 1.00 1.00 1.00 1.00 0.0074 0.0074 T 1.0000 1.0000 1.000
  • 75.
    Dia Actividades pordia Actividades Acumuladas Avance Programado por Dia Dia Actividades por dia Actividades Acumuladas Avance Programado por Dia 1 1 1 0.023 23 1 23 0.535 2 1 2 0.047 24 1 24 0.558 3 1 3 0.070 25 1 25 0.581 4 1 4 0.093 26 1 26 0.605 5 1 5 0.116 27 1 27 0.628 6 1 6 0.140 28 1 28 0.651 7 1 7 0.163 29 1 29 0.674 8 1 8 0.186 30 1 30 0.698 9 1 9 0.209 31 1 31 0.721 10 1 10 0.233 32 1 32 0.744 11 1 11 0.256 33 1 33 0.767 12 1 12 0.279 34 1 34 0.791 13 1 13 0.302 35 1 35 0.814 14 1 14 0.326 36 1 36 0.837 15 1 15 0.349 37 1 37 0.860 16 1 16 0.372 38 1 38 0.884 17 1 17 0.395 39 1 39 0.907 18 1 18 0.419 40 1 40 0.930 19 1 19 0.442 41 1 41 0.953 20 1 20 0.465 42 1 42 0.977 21 1 21 0.488 43 1 43 1.000 22 1 22 0.512 1 ∑ Act. Acum. fa = 0.02326 CALCULO DE AVANCE PROGRAMADO
  • 76.
    1 2 34 5 6 7 8 9 10 11 12 13 Dia a(Actividades) e(DiasProgramados) 1/e DiasTranscurridos (Programados) Porcentaje Programados PorcentajeReal fa(FactorAvance) Avancedea Porcentaje acumulado AvancedelProyecto AvanceProgramado E(p) 1 Replanteos casa 1 1.00 1.00 1.00 1.00 0.0233 0.0233 T 0.0233 0.0233 1.00 2 T 0.0233 Acero para zapatas de muros y columnas y para columnas de carga 3 0.33 1.00 0.33 0.00 0.0698 0.0000 0.0233 0.0465 0.50 3 T 0.0233 Acero para zapatas de muros y columnas y para columnas de carga 3 0.33 2.00 0.66 0.60 0.0698 0.0419 0.0651 0.0698 0.93 4 T 0.0233 Acero para zapatas de muros y columnas y para columnas de carga 3 0.33 3.00 1.00 1.00 0.0698 0.0698 T 0.0930 0.0930 1.00 5 T 0.0930 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1 1.00 1.00 1.00 1.00 0.0233 0.0233 T 0.1163 0.1163 1.00 6 T 0.1163 Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 1.00 0.33 0.00 0.0698 0.0000 0.1163 0.1395 0.83 7 T 0.1163 Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 2.00 0.66 0.00 0.0698 0.0000 0.1163 0.1628 0.71 8 T 0.1163 Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 3.00 1.00 1.00 0.0698 0.0698 T 0.1860 0.1860 1.00 9 T 0.1860 Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 1.00 0.20 0.00 0.1163 0.0000 0.1860 0.2093 0.89 10 T 0.1860 Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 2.00 0.40 0.00 0.1163 0.0000 0.1860 0.2326 0.80 11 T 0.1860 Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 3.00 0.60 0.20 0.1163 0.0233 0.2093 0.2558 0.82 12 T 0.1860 Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 4.00 0.80 0.70 0.1163 0.0814 0.2674 0.2791 0.96 13 T 0.1860 Colocación de bloques SNP de 0.15 y 0.10 mts 5 0.20 5.00 1.00 1.00 0.1163 0.1163 T 0.3023 0.3023 1.00 14 T 0.3023 Encofrado para dintel, losa y vigas 14 0.07 1.00 0.07 0.07 0.3256 0.0228 0.3251 0.3256 1.00 15 T 0.3023 Encofrado para dintel, losa y vigas 14 0.07 2.00 0.14 0.14 0.3256 0.0456 0.3479 0.3488 1.00 16 T 0.3023 Encofrado para dintel, losa y vigas 14 0.07 3.00 0.21 0.21 0.3256 0.0684 0.3707 0.3721 1.00 17 T 0.3023 Encofrado para dintel, losa y vigas 14 0.07 4.00 0.28 0.28 0.3256 0.0912 0.3935 0.3953 1.00 18 T 0.3023 Encofrado para dintel, losa y vigas 14 0.07 5.00 0.35 0.35 0.3256 0.1140 0.4163 0.4186 0.99 19 T 0.3023 Encofrado para dintel, losa y vigas 14 0.07 6.00 0.42 0.42 0.3256 0.1367 0.4391 0.4419 0.99 20 T 0.3023 Encofrado para dintel, losa y vigas 14 0.07 7.00 0.49 0.49 0.3256 0.1595 0.4619 0.4651 0.99 21 T 0.3023 Encofrado para dintel, losa y vigas 14 0.07 8.00 0.56 0.56 0.3256 0.1823 0.4847 0.4884 0.99 22 T 0.3023 Encofrado para dintel, losa y vigas 14 0.07 9.00 0.63 0.63 0.3256 0.2051 0.5074 0.5116 0.99 23 T 0.3023 Encofrado para dintel, losa y vigas 14 0.07 10.00 0.70 0.70 0.3256 0.2279 0.5302 0.5349 0.99 24 T 0.3023 Encofrado para dintel, losa y vigas 14 0.07 11.00 0.77 0.77 0.3256 0.2507 0.5530 0.5581 0.99 25 T 0.3023 Encofrado para dintel, losa y vigas 14 0.07 12.00 0.84 0.84 0.3256 0.2735 0.5758 0.5814 0.99 26 T 0.3023 Encofrado para dintel, losa y vigas 14 0.07 13.00 0.91 0.91 0.3256 0.2963 0.5986 0.6047 0.99 27 T 0.3023 Encofrado para dintel, losa y vigas 14 0.07 14.00 1.00 1.00 0.3256 0.3256 T 0.6279 0.6279 1.00 28 T 0.6279 Fraguache interior, exterior y techo + techo galeria 1 1.00 1.00 1.00 1.00 0.0233 0.0233 T 0.6512 0.6512 1.00 29 T 0.6512 Pañete interior, en techo y mochetas 5 0.20 1.00 0.20 0.00 0.1163 0.0000 0.6512 0.6744 0.97 30 T 0.6512 Pañete interior, en techo y mochetas 5 0.20 2.00 0.40 0.35 0.1163 0.0407 0.6919 0.6977 0.99 31 T 0.6512 Pañete interior, en techo y mochetas 5 0.20 3.00 0.60 0.70 0.1163 0.0814 0.7326 0.7209 1.02 32 T 0.6512 Pañete interior, en techo y mochetas 5 0.20 4.00 0.80 0.80 0.1163 0.0930 0.7442 0.7442 1.00 33 T 0.6512 Pañete interior, en techo y mochetas 5 0.20 5.00 1.00 1.00 0.1163 0.1163 T 0.7674 0.7674 1.00 34 T 0.7674 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 1.00 0.17 0.17 0.1395 0.0237 0.7912 0.7907 1.00 35 T 0.7674 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 2.00 0.34 0.34 0.1395 0.0474 0.8149 0.8140 1.00 36 T 0.7674 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 3.00 0.51 0.51 0.1395 0.0712 0.8386 0.8372 1.00 37 T 0.7674 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 4.00 0.68 0.68 0.1395 0.0949 0.8623 0.8605 1.00 38 T 0.7674 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 5.00 0.85 0.85 0.1395 0.1186 0.8860 0.8837 1.00 39 T 0.7674 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 6 0.17 6.00 1.00 1.00 0.1395 0.1395 T 0.9070 0.9070 1.00 40 T 0.9070 Cocina (gabinetes de piso, pared y topes de cocina en granito) 3 0.33 1.00 0.33 0.00 0.0698 0.0000 0.9070 0.9302 0.98 41 T 0.9070 Cocina (gabinetes de piso, pared y topes de cocina en granito) 3 0.33 2.00 0.66 0.00 0.0698 0.0000 0.9070 0.9535 0.95 42 T 0.9070 Cocina (gabinetes de piso, pared y topes de cocina en granito) 3 0.33 3.00 1.00 1.00 0.0698 0.0698 T 0.9767 0.9767 1.00 43 T 0.9767 Limpieza general continua y final ( incluye bote de escombros ) 1 1.00 1.00 1.00 1.00 0.0233 0.0233 T 1.0000 1.0000 1.00
  • 77.
    Dia Actividades pordia Actividades Acumuladas Avance Programado por Dia Dia Actividades por dia Actividades Acumuladas Avance Programado por Dia 1 1 1 0.027 23 1 23 0.622 2 1 2 0.054 24 1 24 0.649 3 1 3 0.081 25 1 25 0.676 4 1 4 0.108 26 1 26 0.703 5 1 5 0.135 27 1 27 0.730 6 1 6 0.162 28 1 28 0.757 7 1 7 0.189 29 1 29 0.784 8 1 8 0.216 30 1 30 0.811 9 1 9 0.243 31 1 31 0.838 10 1 10 0.270 32 1 32 0.865 11 1 11 0.297 33 1 33 0.892 12 1 12 0.324 34 1 34 0.919 13 1 13 0.351 35 1 35 0.946 14 1 14 0.378 36 1 36 0.973 15 1 15 0.405 37 1 37 1.000 16 1 16 0.432 17 1 17 0.459 1 18 1 18 0.486 ∑ Act. Acum. 19 1 19 0.514 20 1 20 0.541 21 1 21 0.568 22 1 22 0.595 fa = 0.02703 CALCULO DE AVANCE PROGRAMADO
  • 78.
    Dia a(Actividades) e(Dias Programados) 1/e Dias Transcurridos (Programados) Porcentaje Programados PorcentajeReal fa(FactorAvance) Avancedea Porcentaje acumulado Avancedel Proyecto Avance Programado E(p) 1 Conexiones temporales1 1.00 1.00 1.00 1.00 0.0270 0.0270 T 0.0270 0.0270 1.00 2 T 0.0270 Excavaciones de zapatas muros bloques y columnas 2 0.50 1.00 0.50 0.50 0.0541 0.0270 0.0541 0.0541 1.00 3 T 0.0270 Excavaciones de zapatas muros bloques y columnas 2 0.50 2.00 1.00 1.00 0.0541 0.0541 T 0.0811 0.0811 1.00 4 T 0.0811 Actividad ficticia 0 - - 1.00 1.00 0.0000 0.0000 T 0.0811 0.1081 0.75 5 T 0.0811 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1 1.00 1.00 1.00 1.00 0.0270 0.0270 T 0.1081 0.1351 0.80 6 T 0.1081 Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 1.00 0.33 0.00 0.0811 0.0000 0.1081 0.1622 0.67 7 T 0.1081 Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 2.00 0.66 0.50 0.0811 0.0405 0.1486 0.1892 0.79 8 T 0.1081 Colocación de bloques BNP de 0.15 y 0.10 mts 3 0.33 3.00 1.00 1.00 0.0811 0.0811 T 0.1892 0.2162 0.88 9 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 1.00 0.04 0.02 0.6757 0.0135 0.2027 0.2432 0.83 10 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 2.00 0.08 0.02 0.6757 0.0135 0.2027 0.2703 0.75 11 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 3.00 0.12 0.02 0.6757 0.0135 0.2027 0.2973 0.68 12 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 4.00 0.16 0.10 0.6757 0.0676 0.2568 0.3243 0.79 13 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 5.00 0.20 0.12 0.6757 0.0811 0.2703 0.3514 0.77 14 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 6.00 0.24 0.16 0.6757 0.1081 0.2973 0.3784 0.79 15 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 7.00 0.28 0.20 0.6757 0.1351 0.3243 0.4054 0.80 16 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 8.00 0.32 0.24 0.6757 0.1622 0.3514 0.4324 0.81 17 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 9.00 0.36 0.30 0.6757 0.2027 0.3919 0.4595 0.85 18 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 10.00 0.40 0.35 0.6757 0.2365 0.4257 0.4865 0.88 19 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 11.00 0.44 0.40 0.6757 0.2703 0.4595 0.5135 0.89 20 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 12.00 0.48 0.45 0.6757 0.3041 0.4932 0.5405 0.91 21 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 13.00 0.52 0.50 0.6757 0.3378 0.5270 0.5676 0.93 22 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 14.00 0.56 0.54 0.6757 0.3649 0.5541 0.5946 0.93 23 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 15.00 0.60 0.60 0.6757 0.4054 0.5946 0.6216 0.96 24 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 16.00 0.64 0.62 0.6757 0.4189 0.6081 0.6486 0.94 25 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 17.00 0.68 0.66 0.6757 0.4459 0.6351 0.6757 0.94 26 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 18.00 0.72 0.70 0.6757 0.4730 0.6622 0.7027 0.94 27 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 19.00 0.76 0.78 0.6757 0.5270 0.7162 0.7297 0.98 28 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 20.00 0.80 0.85 0.6757 0.5743 0.7635 0.7568 1.01 29 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 21.00 0.84 0.86 0.6757 0.5811 0.7703 0.7838 0.98 30 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 22.00 0.88 0.87 0.6757 0.5878 0.7770 0.8108 0.96 31 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 23.00 0.92 0.95 0.6757 0.6419 0.8311 0.8378 0.99 32 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 24.00 0.96 0.96 0.6757 0.6486 0.8378 0.8649 0.97 33 T 0.1892 Suministro e instalacion de accesorios sanitarios 25 0.04 25.00 1.00 1.00 0.6757 0.6757 T 0.8649 0.8919 0.97 34 T 0.8649 Jardineria en patio 4 0.25 1.00 0.25 0.00 0.1081 0.0000 0.8649 0.9189 0.94 35 T 0.8649 Jardineria en patio 4 0.25 2.00 0.50 0.50 0.1081 0.0541 0.9189 0.9459 0.97 36 T 0.8649 Jardineria en patio 4 0.25 3.00 0.75 0.75 0.1081 0.0811 0.9459 0.9730 0.97 37 T 0.8649 Jardineria en patio 4 0.25 4.00 1.00 1.00 0.1081 0.1081 T 1.0000 1.0000 1.00
  • 79.
    1 2 34 5 6 7 8 9 Dea DelProyecto Delproceso Procentajeacumulado Totaldelproceso 1 Replanteos casa 1 0.00740741 0.0233 T 0.0000 0.0233 0.0233 1.00 2 T 0.0233 0.0233 Acero para zapatas de muros y columnas y para columnas de carga 0.33 0.00733333 0.02302326 0.0233 0.0463 0.0465 1.00 3 T 0.0233 0.0233 Acero para zapatas de muros y columnas y para columnas de carga 0.66 0.01466667 0.04604651 0.0233 0.0693 0.0698 0.99 4 T 0.0233 0.0233 Acero para zapatas de muros y columnas y para columnas de carga 1 0.02222222 0.0698 T 0.0233 0.0930 0.0930 1.00 5 T 0.0930 0.0930 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1 0.00740741 0.0233 T 0.0930 0.1163 0.1163 1.00 6 T 0.1163 0.1163 Colocación de bloques BNP de 0.15 y 0.10 mts 0.33 0 0 0.1163 0.1163 0.1395 0.83 7 T 0.1163 0.1163 Colocación de bloques BNP de 0.15 y 0.10 mts 0.66 0.01111111 0.03488372 0.1163 0.1512 0.1628 0.93 8 T 0.1163 0.1163 Colocación de bloques BNP de 0.15 y 0.10 mts 1 0.02222222 0.0698 T 0.1163 0.1860 0.1860 1.00 9 T 0.1860 0.1860 Colocación de bloques SNP de 0.15 y 0.10 mts 0.2 0 0 0.1860 0.1860 0.2093 0.89 10 T 0.1860 0.1860 Colocación de bloques SNP de 0.15 y 0.10 mts 0.4 0 0 0.1860 0.1860 0.2326 0.80 11 T 0.1860 0.1860 Colocación de bloques SNP de 0.15 y 0.10 mts 0.6 0.01851852 0.05813953 0.1860 0.2442 0.2558 0.95 12 T 0.1860 0.1860 Colocación de bloques SNP de 0.15 y 0.10 mts 0.8 0 0 0.1860 0.1860 0.2791 0.67 13 T 0.1860 0.1860 Colocación de bloques SNP de 0.15 y 0.10 mts 1 0.03703704 0.1163 T 0.1860 0.3023 0.3023 1.00 14 T 0.3023 0.3023 Encofrado para dintel, losa y vigas 0.07 0.00725926 0.0227907 0.3023 0.3251 0.3256 1.00 15 T 0.3023 0.3023 Encofrado para dintel, losa y vigas 0.14 0.01451852 0.0455814 0.3023 0.3479 0.3488 1.00 16 T 0.3023 0.3023 Encofrado para dintel, losa y vigas 0.21 0.02177778 0.06837209 0.3023 0.3707 0.3721 1.00 17 T 0.3023 0.3023 Encofrado para dintel, losa y vigas 0.28 0.02903704 0.09116279 0.3023 0.3935 0.3953 1.00 18 T 0.3023 0.3023 Encofrado para dintel, losa y vigas 0.35 0.0362963 0.11395349 0.3023 0.4163 0.4186 0.99 19 T 0.3023 0.3023 Encofrado para dintel, losa y vigas 0.42 0.04355556 0.13674419 0.3023 0.4391 0.4419 0.99 20 T 0.3023 0.3023 Encofrado para dintel, losa y vigas 0.49 0.05081481 0.15953488 0.3023 0.4619 0.4651 0.99 21 T 0.3023 0.3023 Encofrado para dintel, losa y vigas 0.56 0.05807407 0.18232558 0.3023 0.4847 0.4884 0.99 22 T 0.3023 0.3023 Encofrado para dintel, losa y vigas 0.63 0.06533333 0.20511628 0.3023 0.5074 0.5116 0.99 23 T 0.3023 0.3023 Encofrado para dintel, losa y vigas 0.7 0.07259259 0.22790698 0.3023 0.5302 0.5349 0.99 24 T 0.3023 0.3023 Encofrado para dintel, losa y vigas 0.77 0.07985185 0.25069767 0.3023 0.5530 0.5581 0.99 25 T 0.3023 0.3023 Encofrado para dintel, losa y vigas 0.84 0.08711111 0.27348837 0.3023 0.5758 0.5814 0.99 26 T 0.3023 0.3023 Encofrado para dintel, losa y vigas 0.91 0.09437037 0.29627907 0.3023 0.5986 0.6047 0.99 27 T 0.3023 0.3023 Encofrado para dintel, losa y vigas 1 0.1037037 0.3256 T 0.3023 0.6279 0.6279 1.00 28 T 0.6279 0.6279 Fraguache interior, exterior y techo + techo galeria 1 0.00740741 0.0233 T 0.6279 0.6512 0.6512 1.00 29 T 0.6512 0.6512 Pañete interior, en techo y mochetas 0.2 0.00740741 0.02325581 0.6512 0.6744 0.6744 1.00 30 T 0.6512 0.6512 Pañete interior, en techo y mochetas 0.4 0.01481481 0.04651163 0.6512 0.6977 0.6977 1.00 31 T 0.6512 0.6512 Pañete interior, en techo y mochetas 0.6 0.02222222 0.06976744 0.6512 0.7209 0.7209 1.00 32 T 0.6512 0.6512 Pañete interior, en techo y mochetas 0.8 0.02962963 0.09302326 0.6512 0.7442 0.7442 1.00 33 T 0.6512 0.6512 Pañete interior, en techo y mochetas 1 0.03703704 0.1163 T 0.6512 0.7674 0.7674 1.00 34 T 0.7674 0.7674 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.17 0.00755556 0.02372093 0.7674 0.7912 0.7907 1.00 35 T 0.7674 0.7674 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.34 0.01511111 0.04744186 0.7674 0.8149 0.8140 1.00 36 T 0.7674 0.7674 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.51 0.02266667 0.07116279 0.7674 0.8386 0.8372 1.00 37 T 0.7674 0.7674 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.68 0.03022222 0.09488372 0.7674 0.8623 0.8605 1.00 38 T 0.7674 0.7674 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.85 0.03777778 0.11860465 0.7674 0.8860 0.8837 1.00 39 T 0.7674 0.7674 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 1 0.04444444 0.1395 T 0.7674 0.9070 0.9070 1.00 40 T 0.9070 0.9070 Cocina (gabinetes de piso, pared y topes de cocina en granito) 0.33 0.00733333 0.02302326 0.9070 0.9300 0.9302 1.00 41 T 0.9070 0.9070 Cocina (gabinetes de piso, pared y topes de cocina en granito) 0.66 0.01466667 0.04604651 0.9070 0.9530 0.9535 1.00 42 T 0.9070 0.9070 Cocina (gabinetes de piso, pared y topes de cocina en granito) 1 0.02222222 0.0698 T 0.9070 0.9767 0.9767 1.00 43 T 0.9767 0.9767 Limpieza general continua y final ( incluye bote de escombros ) 1 0.00740741 0.0233 T 0.9767 1.0000 1.0000 1.00 Cuadro de avance del proceso A Día Actividad AVANCE
  • 80.
    1 2 34 5 6 7 8 9 Dea DelProyecto Delproceso Procentajeacumulado Totaldelproceso 1 Conexiones temporales 1.00 0.00740741 0.0270 T 0.0000 0.0270 0.0270 1.00 2 T 0.0270 0.0270 Excavaciones de zapatas muros bloques y columnas 0.50 0.00740741 0.02702703 0.0270 0.0541 0.0541 1.00 3 T 0.0270 0.0270 Excavaciones de zapatas muros bloques y columnas 1.00 0.01481481 0.0541 T 0.0270 0.0811 0.0811 1.00 4 T 0.0811 0.0811 Actividad ficticia 1.00 0 0.0000 T 0.0811 0.0811 0.1081 0.75 5 T 0.0811 0.0811 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1.00 0.00740741 0.0270 T 0.0811 0.1081 0.1351 0.80 6 T 0.1081 0.1081 Colocación de bloques BNP de 0.15 y 0.10 mts 0.33 0 0 0.1081 0.1081 0.1622 0.67 7 T 0.1081 0.1081 Colocación de bloques BNP de 0.15 y 0.10 mts 0.66 0.01111111 0.04054054 0.1081 0.1486 0.1892 0.79 8 T 0.1081 0.1081 Colocación de bloques BNP de 0.15 y 0.10 mts 1.00 0.02222222 0.0811 T 0.1081 0.1892 0.2162 0.88 9 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.04 0 0 0.1892 0.1892 0.2432 0.78 10 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.08 0 0 0.1892 0.1892 0.2703 0.70 11 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.12 0.02222222 0.08108108 0.1892 0.2703 0.2973 0.91 12 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.16 0.02962963 0.10810811 0.1892 0.2973 0.3243 0.92 13 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.20 0.03703704 0.13513514 0.1892 0.3243 0.3514 0.92 14 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.24 0.04444444 0.16216216 0.1892 0.3514 0.3784 0.93 15 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.28 0.05185185 0.18918919 0.1892 0.3784 0.4054 0.93 16 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.32 0.05925926 0.21621622 0.1892 0.4054 0.4324 0.94 17 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.36 0.06666667 0.24324324 0.1892 0.4324 0.4595 0.94 18 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.40 0.07407407 0.27027027 0.1892 0.4595 0.4865 0.94 19 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.44 0.08148148 0.2972973 0.1892 0.4865 0.5135 0.95 20 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.48 0.08888889 0.32432432 0.1892 0.5135 0.5405 0.95 21 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.52 0.0962963 0.35135135 0.1892 0.5405 0.5676 0.95 22 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.56 0.1037037 0.37837838 0.1892 0.5676 0.5946 0.95 23 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.60 0.11111111 0.40540541 0.1892 0.5946 0.6216 0.96 24 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.64 0.11851852 0.43243243 0.1892 0.6216 0.6486 0.96 25 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.68 0.12592593 0.45945946 0.1892 0.6486 0.6757 0.96 26 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.72 0.13333333 0.48648649 0.1892 0.6757 0.7027 0.96 27 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.76 0.14074074 0.51351351 0.1892 0.7027 0.7297 0.96 28 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.80 0.14814815 0.54054054 0.1892 0.7297 0.7568 0.96 29 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.84 0.15555556 0.56756757 0.1892 0.7568 0.7838 0.97 30 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.88 0.16296296 0.59459459 0.1892 0.7838 0.8108 0.97 31 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.92 0.17037037 0.62162162 0.1892 0.8108 0.8378 0.97 32 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 0.96 0.17777778 0.64864865 0.1892 0.8378 0.8649 0.97 33 T 0.1892 0.1892 Suministro e instalacion de accesorios sanitarios 1.00 0.18518519 0.6757 T 0.1892 0.8649 0.8919 0.97 34 T 0.8649 0.8649 Jardineria en patio 0.25 0 0 0.8649 0.8649 0.9189 0.94 35 T 0.8649 0.8649 Jardineria en patio 0.50 0.01481481 0.05405405 0.8649 0.9189 0.9459 0.97 36 T 0.8649 0.8649 Jardineria en patio 0.75 0.01481481 0.05405405 0.8649 0.9189 0.9730 0.94 37 T 0.8649 0.8649 Jardineria en patio 1.00 0.02962963 0.1081 T 0.8649 0.9730 1.0000 0.97 Cuadro de avance del proceso A Día Actividad AVANCE
  • 81.
    0 1 23 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32 33 34 35 36 37 38 39 40 41 42 43 1 Replanteos casa 5 Acero para zapatas de muros y columnas y para columnas de carga 6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 7 Colocación de bloques BNP de 0.15 y 0.10 mts 8 Colocación de bloques SNP de 0.15 y 0.10 mts 15 Encofrado para dintel, losa y vigas 16 Fraguache interior, exterior y techo + techo galeria 19 Pañete interior, en techo y mochetas 23 Torta de piso 25 Cocina (gabinetes de piso, pared y topes de cocina en granito) 26 Limpieza general continua y final ( incluye bote de escombros ) 2 Conexiones temporales 4 Excavacion zapatas Actividad ficticia 3 Almacen Actividad ficticia Suministro y colocacion de accesorios electricos Actividad ficticia Suministro y colocacion de accesorios sanitarios Jardineria Acero de dinteles y vigas y losa H.A. dintel, viga y losa Bloques de antepecho Fino, zabaleta e impermeablizante de techo Pañete exterior Actividad ficticia Construccion de registro Actividad ficticia Pintura Actividad ficticia Puertas Ventanas Actividad ficticia Actividad ficticia Tiempos remotos Tiempos próximos Actividad crítica DIAGRAMA DE GANTT CONSTRUCCION DE CASA ( 62,0 MT2 ) No. Actividad Días
  • 82.

    APLICACIÓN METODO BURGESS Actividad:Construccion de registros Duración= 4 HL= 2 M.O= 5 Hombres/ día 5 Hombres/Actividad 1 IP13-IP14 IP14-IP15 IP15-IP16 IP16-IP17 IP17-IP18 IP18-IP19 (5)²+(0)²+(0)²+(0)²+ (0)²+(0)²+(0)²+(0)²=25 1 1 1 1 1 IP13-IP14 IP14-IP15 IP15-IP16 IP16-IP17 IP17-IP18 IP18-IP19 (4)²+(1)²+(0)²+(0)²+ (0)²+(0)²+(0)²+(0)²=17 1 1 1 1 1 IP13-IP14 IP14-IP15 IP15-IP16 IP16-IP17 IP17-IP18 IP18-IP19 (3)²+(2)²+(0)²+(0)²+ (0)²+(0)²+(0)²+(0)²=13 1 1 1 1 1 IP13-IP14 IP14-IP15 IP15-IP16 IP16-IP17 IP17-IP18 IP18-IP19 (2)²+(2)²+(1)²+(0)²+ (0)²+(0)²+(0)²+(0)²=9 1 1 1 1 1 IP13-IP14 IP14-IP15 IP15-IP16 IP16-IP17 IP17-IP18 IP18-IP19 (1)²+(1)²+(1)²+(1)²+ (1)²+(0)²+(0)²+(0)²=5 MEJOR OPCION 1 1 1 1 1 IP13-IP14 IP14-IP15 IP15-IP16 IP16-IP17 IP17-IP18 IP18-IP19 (1)²+(3)²+(1)²+(0)²+ (0)²+(0)²+(0)²+(0)²=11 1 1 1 1 1 Actividad: Jardineria Duración= 4 HL= 5 M.O= 3 Hombres/ día 3 Hombres/Actividad IP34-IP35 IP35-IP36 IP36-IP37 IP37-IP38 IP38-IP39 IP39-IP40 IP40-IP41 IP41-IP42 IP42-IP43 (3)²+(0)²+(0)²+(0)²+ (0)²+(0)²+(0)²+(0)²=9 1 1 1 IP34-IP35 IP35-IP36 IP36-IP37 IP37-IP38 IP38-IP39 IP39-IP40 IP40-IP41 IP41-IP42 IP42-IP43 (2)²+(1)²+(0)²+(0)²+ (0)²+(0)²+(0)²+(0)²=5 1 1 1 IP34-IP35 IP35-IP36 IP36-IP37 IP37-IP38 IP38-IP39 IP39-IP40 IP40-IP41 IP41-IP42 IP42-IP43 (1)²+(1)²+(1)²+(0)²+ (0)²+(0)²+(0)²+(0)²=3 MEJOR OPCION 1 1 1
  • 83.
    Premisas: 1. Laprovisión de efectivo para el proyecto estará distribuida de la forma siguiente: Día - 1: 40% RD $ 408,165.05 Día 10: 50% RD $ 510,206.31 Día 20: 10% RD $ 102,041.26 RD $ 1,020,412.62 3. El costo de los gastos fijos estan incluidos en las actividades. Día Saldo Inicial Provisión Préstamo Suma Ingresos Actividad Anticipos Liquidación Fijos Pago Préstamo Suma Egresos Saldo Final -1 -RD$ 408,165.05RD$ -RD$ 408,165.05RD$ 1 2,579.20RD$ -RD$ -RD$ -RD$ 2 960.00RD$ -RD$ -RD$ -RD$ 3 3,840.00RD$ -RD$ -RD$ -RD$ 7,379.20RD$ 400,785.85RD$ 0 400,785.85RD$ -RD$ -RD$ 400,785.85RD$ 4 5,428.74RD$ -RD$ -RD$ -RD$ 5 13,606.12RD$ -RD$ -RD$ -RD$ 19,034.86RD$ 381,750.99RD$ 1 381,750.99RD$ -RD$ -RD$ 381,750.99RD$ 1 -RD$ 2,579.20RD$ -RD$ -RD$ 2 -RD$ 960.00RD$ -RD$ -RD$ 3,539.20RD$ 378,211.79RD$ 2 378,211.79RD$ -RD$ -RD$ 378,211.79RD$ 3 -RD$ 3,840.00RD$ -RD$ -RD$ 3,840.00RD$ 374,371.79RD$ 3 374,371.79RD$ -RD$ -RD$ 374,371.79RD$ 4 -RD$ 5,428.74RD$ -RD$ -RD$ 6 40,238.69 -RD$ -RD$ -RD$ 45,667.43RD$ 328,704.36RD$ 4 328,704.36RD$ -RD$ -RD$ 328,704.36RD$ 5 -RD$ 13,606.12RD$ -RD$ -RD$ 7 21,798.88RD$ -RD$ -RD$ -RD$ 35,405.00RD$ 293,299.36RD$ 5 293,299.36RD$ -RD$ -RD$ 293,299.36RD$ 6 -RD$ 40,238.69RD$ -RD$ -RD$ 40,238.69RD$ 253,060.67RD$ 6 253,060.67RD$ -RD$ -RD$ 253,060.67RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 253,060.67RD$ 7 253,060.67RD$ -RD$ -RD$ 253,060.67RD$ 8 60,484.21RD$ -RD$ -RD$ -RD$ 17 34,404.45RD$ -RD$ -RD$ -RD$ 18 30,393.60RD$ -RD$ -RD$ -RD$ 125,282.27RD$ 127,778.40RD$ 8 127,778.40RD$ -RD$ -RD$ 127,778.40RD$ 7 -RD$ 21,798.88RD$ -RD$ -RD$ 21,798.88RD$ 105,979.52RD$ 9 105,979.52RD$ -RD$ -RD$ 105,979.52RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 105,979.52RD$ 10 105,979.52RD$ -RD$ -RD$ 105,979.52RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 105,979.52RD$ 11 105,979.52RD$ -RD$ -RD$ 105,979.52RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 105,979.52RD$ 12 105,979.52RD$ -RD$ -RD$ 105,979.52RD$ 9 2,916.86RD$ -RD$ -RD$ -RD$ 10 32,357.55RD$ -RD$ -RD$ -RD$ 15 19,723.27RD$ -RD$ -RD$ -RD$ 54,997.68RD$ 50,981.84RD$ 13 50,981.84RD$ 510,206.31RD$ -RD$ 561,188.15RD$ 8 -RD$ 60,484.21RD$ -RD$ -RD$ 60,484.21RD$ 500,703.93RD$ 14 500,703.93RD$ -RD$ -RD$ 500,703.93RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 500,703.93RD$ 15 500,703.93RD$ -RD$ -RD$ 500,703.93RD$ 11 39,068.94RD$ -RD$ -RD$ -RD$ 39,068.94RD$ 461,635.00RD$ 16 461,635.00RD$ -RD$ -RD$ 461,635.00RD$ 10 -RD$ 32,357.55RD$ -RD$ -RD$ 12 3,432.19RD$ -RD$ -RD$ -RD$ 35,789.74RD$ 425,845.25RD$ 17 425,845.25RD$ -RD$ -RD$ 425,845.25RD$ 9 -RD$ 2,916.86RD$ -RD$ -RD$ 11 -RD$ 39,068.94RD$ -RD$ -RD$ 41,985.80RD$ 383,859.45RD$ 18 383,859.45RD$ -RD$ -RD$ 383,859.45RD$ 13 22,852.73RD$ -RD$ -RD$ -RD$ 22,852.73RD$ 361,006.72RD$ 19 361,006.72RD$ -RD$ -RD$ 361,006.72RD$ 12 -RD$ 3,432.19RD$ -RD$ -RD$ 3,432.19RD$ 357,574.53RD$ 20 357,574.53RD$ -RD$ -RD$ 357,574.53RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 357,574.53RD$ 21 357,574.53RD$ -RD$ -RD$ 357,574.53RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 357,574.53RD$ 22 357,574.53RD$ -RD$ -RD$ 357,574.53RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 357,574.53RD$ 23 357,574.53RD$ -RD$ -RD$ 357,574.53RD$ 14 12,758.53RD$ -RD$ -RD$ -RD$ 12,758.53RD$ 344,816.00RD$ 24 344,816.00RD$ -RD$ -RD$ 344,816.00RD$ 13 -RD$ 22,852.73RD$ -RD$ -RD$ 22,852.73RD$ 321,963.26RD$ 25 321,963.26RD$ -RD$ -RD$ 321,963.26RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 321,963.26RD$ 26 321,963.26RD$ -RD$ -RD$ 321,963.26RD$ 16 2,453.07RD$ -RD$ -RD$ -RD$ 2,453.07RD$ 319,510.19RD$ 27 319,510.19RD$ -RD$ -RD$ 319,510.19RD$ 14 -RD$ 12,758.53RD$ -RD$ -RD$ 15 -RD$ 19,723.27RD$ -RD$ -RD$ 19 34,953.87RD$ -RD$ -RD$ -RD$ 20 21,440.00RD$ -RD$ -RD$ -RD$ 88,875.67RD$ 230,634.53RD$ 28 230,634.53RD$ -RD$ -RD$ 230,634.53RD$ 16 -RD$ 2,453.07RD$ -RD$ -RD$ 2,453.07RD$ 228,181.46RD$ 29 228,181.46RD$ -RD$ -RD$ 228,181.46RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 228,181.46RD$ 30 228,181.46RD$ -RD$ -RD$ 228,181.46RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 228,181.46RD$ 31 228,181.46RD$ -RD$ -RD$ 228,181.46RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 228,181.46RD$ 32 228,181.46RD$ -RD$ -RD$ 228,181.46RD$ 22 2,080.00RD$ -RD$ -RD$ -RD$ 23 59,968.62RD$ -RD$ -RD$ -RD$ 62,048.62RD$ 166,132.84RD$ 33 166,132.84RD$ 102,041.26RD$ -RD$ 268,174.10RD$ 17 -RD$ 34,404.45RD$ -RD$ -RD$ 18 -RD$ 30,393.60RD$ -RD$ -RD$ 19 -RD$ 34,953.87RD$ -RD$ -RD$ 21 11,302.61RD$ -RD$ -RD$ -RD$ 111,054.54RD$ 157,119.56RD$ 34 157,119.56RD$ -RD$ -RD$ 157,119.56RD$ 20 -RD$ 21,440.00RD$ -RD$ -RD$ 21,440.00RD$ 135,679.56RD$ 35 135,679.56RD$ -RD$ -RD$ 135,679.56RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 135,679.56RD$ 36 135,679.56RD$ -RD$ -RD$ 135,679.56RD$ - -RD$ -RD$ -RD$ -RD$ -RD$ 135,679.56RD$ 37 135,679.56RD$ -RD$ -RD$ 135,679.56RD$ 22 -RD$ 2,080.00RD$ -RD$ -RD$ 2,080.00RD$ 133,599.56RD$ 38 133,599.56RD$ -RD$ -RD$ 133,599.56RD$ 24 18,878.53RD$ -RD$ -RD$ -RD$ 25 9,204.16RD$ -RD$ -RD$ -RD$ 28,082.70RD$ 105,516.86RD$ 39 105,516.86RD$ -RD$ -RD$ 105,516.86RD$ 23 -RD$ 59,968.62RD$ -RD$ -RD$ 59,968.62RD$ 45,548.24RD$ 40 45,548.24RD$ -RD$ -RD$ 45,548.24RD$ 21 -RD$ 11,302.61RD$ -RD$ -RD$ 11,302.61RD$ 34,245.63RD$ 41 34,245.63RD$ -RD$ -RD$ 34,245.63RD$ 26 960.00RD$ -RD$ -RD$ -RD$ 960.00RD$ 33,285.63RD$ 42 33,285.63RD$ -RD$ -RD$ 33,285.63RD$ 24 -RD$ 18,878.53RD$ -RD$ -RD$ 25 -RD$ 9,204.16RD$ -RD$ -RD$ 28,082.70RD$ 5,202.93RD$ 43 5,202.93RD$ -RD$ -RD$ 5,202.93RD$ 26 -RD$ 960.00RD$ -RD$ -RD$ 960.00RD$ 4,242.93RD$ Σ 1,020,412.62RD$ -RD$ 1,020,412.62RD$ 508,084.84RD$ 508,084.84RD$ -RD$ -RD$ 1,016,169.69RD$ 4,242.93RD$ 2. Deberá pagarse 50% del monto a los proveedores un día antes de inicio de la actividad, y el 50% restante una vez finalizada la actividad. ESTADO DE FLUJO DE CAJA CONSTRUCCION DE VIVIENDA ECONOMICA 62 M2
  • 84.
    A -1 0 12 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32 33 34 35 36 37 38 39 40 41 42 43 1 2,579.20 2,579.20 2 960.00 960.00 3 3,840.00 3,840.00 4 5,428.74 5,428.74 5 13,606.12 13,606.12 6 40,238.69 40,238.69 7 21,798.88 21,798.88 8 60,484.21 60,484.21 9 2,916.86RD$ 2,916.86 10 32,357.55 32,357.55 11 39,068.94 39,068.94 12 3,432.19 3,432.19 13 22,852.73 22,852.73 14 12,758.53 12,758.53 15 19,723.27 19,723.27 16 30,393.60 4,574.53 4,574.53 17 34,404.45 34,404.45 18 30,393.60 19 34,953.87 34,953.87 20 21,440.00 21,440.00 21 11,302.61 11,302.61 22 2,080.00 2,080.00 23 59,968.62 59,968.62 24 18,878.53 18,878.53 25 9,204.16 9,204.16 26 960.00 960.00 Equipos Costo Fijo Total 7,379.20 19,034.86 3,539.20 3,840.00 45,667.43 35,405.00 40,238.69 0.00 94,888.66 21,798.88 0.00 0.00 0.00 85,391.28 60,484.21 0.00 39,068.94 35,789.74 41,985.80 22,852.73 3,432.19 0.00 0.00 0.00 12,758.53 22,852.73 0.00 4,574.53 88,875.67 4,574.53 0.00 0.00 0.00 62,048.62 111,054.53 21,440.00 0.00 0.00 2,080.00 28,082.69 59,968.62 11,302.61 960.00 28,082.69 960.00 Nota: El costo de los gastos fijos estan incluidos en las actividades. DIAS PRESUPUESTO Y PROGRAMACION DE EGRESOS CONSTRUCCION DE VIVIENDA 62M2
  • 85.
    PERIODO= 5 díasdel Proyecto Día Gasto Diario Dotación -1 7,379.20RD$ 0 19,034.86RD$ 1 3,539.20RD$ 2 3,840.00RD$ 3 45,667.43RD$ 4 35,405.00RD$ 5 40,238.69RD$ 155,104.38RD$ 6 -RD$ 7 94,888.66RD$ 8 21,798.88RD$ 9 -RD$ 10 -RD$ 116,687.54RD$ 11 -RD$ 12 85,391.28RD$ 13 60,484.21RD$ 14 -RD$ 15 39,068.94RD$ 184,944.43RD$ 16 35,789.74RD$ 17 41,985.80RD$ 18 22,852.73RD$ 19 3,432.19RD$ 20 -RD$ 104,060.47RD$ 21 -RD$ 22 -RD$ 23 12,758.53RD$ 24 22,852.73RD$ 25 -RD$ 35,611.26RD$ 26 4,574.53RD$ 27 88,875.67RD$ 28 4,574.53RD$ 29 -RD$ 30 -RD$ 98,024.73RD$ 31 -RD$ 32 62,048.62RD$ 33 111,054.53RD$ 34 21,440.00RD$ 35 -RD$ 194,543.15RD$ 36 -RD$ 37 2,080.00RD$ 38 28,082.69RD$ 39 59,968.62RD$ 40 11,302.61RD$ 101,433.92RD$ 41 960.00RD$ 42 28,082.69RD$ 43 960.00RD$ 30,002.69RD$ Σ 1,020,412.57 DOTACION DE GASTOS
  • 86.
    No. Actividad DescripciónAntecedentes Secuencias Duración 1 Replanteos casa Consta del confeccionado de la charrancha, marcar las zapatas de muros y columnas. - 5 1 2 Conexiones temporales Poner en funcionamiento los servicios de agua, luz y aguas negras. - 4 1 3 Habilitar área almacén materiales Delimitar el area donde se construira el almacen y construirlo. - - 2 4 Excavaciones de zapatas muros bloques y columnas Excavacion a mano de las zapatas de muros y columnas 2 - 2 5 Acero para zapatas de muros y columnas y para columnas de carga Armado y colocacion de acero para las zapatas del muros y columnas. 1 6 3 6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas Ligado del hormigon con su especificacion f´c= 210 kg/cm2 en trompo y vaciado en las diferentes zapatas de muros y columnas. 5 7 1 7 Colocación de bloques BNP de 0.15 y 0.10 mts Postura de bloques de hormigon bajo nivel de piso con todos lo huecos del bloque relleno de hormigon simple. 6 8, 17, 18. 3 8 Colocación de bloques SNP de 0.15 y 0.10 mts Postura de bloques sobre nivel de piso, con las especificaciones en planos. 7 9, 10, 15. 4 LIMITACION POR M.O. POR ACTIVIDAD 9 9 Construcion de registro sanitario y registro trampa de grasa Excavacion y construccion de registro sanitarios y trampa de grasa. 8 - 5 LIMITACION POR M.O. POR ACTIVIDAD 8 10 Acero para dintel, losa y vigas Armado y colocacion de acero para dinteles, losa y vigas con las especificaciones que demandan los planos. 8 11 3 11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas Ligado del hormigon con su especificacion f´c= 210 kg/cm2 en trompo y vaciado en los dinteles, losa y viga. 10 12 1 12 Colocación de bloques antepecho de 0.15 mts Postura de bloques en antepecho con bloques de 0.15mtrs. Con las especificaciones que demandan los planos. 11 13 2 13 Fino , zabaletas y impermeabilizante Ligado y vaciado de mortero para el fino y sabaleta, curado del hormigos y luego colocacion del impermeabilizante. 12 14 5 14 Pañete exterior y antepecho Pañete de los muros exteriores y antepecho. 13 - 3 15 Encofrado para dintel, losa y vigas Preparacion del encofrado para la losa, dintel y vigas. 8 16 14 16 Fraguache interior, exterior y techo + techo galeria Fraguache en muros interiore y exteriores, techo y galeria. 15 19, 20. 2 17 Suministro e instalacion de accesorios electricos Compra y colocacion de instalaciones electricas con sus accesorios correspondientes. 7 - 25 18 Suministro e instalacion de accesorios sanitarios Compra y colocacion de instalaciones sanitarias con sus accesorios correspondientes. 7 22 25 19 Pañete interior, en techo y mochetas Pañete de los muros interiores junto al pañete de mochetas. 16 23 5 20 Portaje Colocacion de puertas. 16 21 6 21 Ventanas Colocacion de ventanas. 20 - 6 LIMITACION DE RECURSOS ACTIVIDAD 22 22 Jardineria en patio Construccion de la jardineria exterior y colocacion de piezas de gramaquin. 18 - 4 LIMITACION DE RECURSOS ACTIVIDAD 21 23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina Vaciado con hormigon armado en ligadora, curado del hormigon, colocacion de pisos, colocacion de ceramica y colocacion de zocalos. 19 24, 25. 6 24 Pintura acrilica interior y exterior Pintura para los muros exteriores, antepecho, techo, muros interiores, vigas y columnas. 23 - 3 25 Cocina (gabinetes de piso, pared y topes de cocina en granito) Colocacion de tope de granito, construccion y colocacion de ganitenes de piso para la cocina. 23 26 3 26 Limpieza final Limppieza final y correccion de algun detalle faltante. 25 - 1 LIMITACIONES CONSTRUCCION DE CASA ( 62,0 MT2 ) Limitaciones
  • 87.
    Actividades Recurso AdicionalCosto Adicional Fraguache interior, exterior y techo + techo galeria 2 AYUDANTES 4,242.93 4,242.93 RECURSOS ADICIONALES
  • 88.
    1 2 34 6 8 9 ING MAE O A T P PV Replanteos casa X X Hilo, Nivel, etc 700.00 Conexiones temporales X Materiales y Herramientas 300.00 Habilitar área almacén materiales X Materiales y Herramientas 12000.00 Excavaciones de zapatas muros bloques y columnas X X Pico y pala 2450.00 Acero para zapatas de muros y columnas y para columnas de carga X disco de corte, alambre, etc 1500.00 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas X Ligadoras y herramientas menores 10000.00 Colocación de bloques BNP de 0.15 y 0.10 mts X Hilo, Nivel, etc 700.00 Colocación de bloques SNP de 0.15 y 0.10 mts X Hilo, Nivel, etc 700.00 Construcion de registro sanitario y registro trampa de grasa X X Herramientas menores 1375.00 Acero para dintel, losa y vigas X X disco de corte, alambre, etc 1500.00 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas X X Ligadoras y herramientas menores 10000.00 Colocación de bloques antepecho de 0.15 mts X X herramientas 9000.00 Fino , zabaletas y impermeabilizante X X X X herramientas 500.00 Pañete exterior y antepecho X X Herramientas 525.00 Encofrado para dintel, losa y vigas X X madera y herramientas 600.00 Fraguache interior, exterior y techo + techo galeria X X madera y herramientas 500.00 Suministro e instalacion de accesorios electricos X accesorios electricos 420.00 Suministro e instalacion de accesorios sanitarios X accesorios sanitarios 530.00 Pañete interior, en techo y mochetas X X X herramientas 800.00 Portaje X herramientas para puertas 2000.00 Ventanas X herramientas para ventanas 1200.00 Jardineria en patio X - - Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina X X herramientas 8000.00 Pintura acrilica interior y exterior X Pintura y Herramientas Menores 15000.00 Cocina (gabinetes de piso, pared y topes de cocina en granito) X Herramientas 9000.00 Limpieza general continua y final X Herramientas menores 1500.00 INGENIERO ING MAESTRO MAE OPERADOR O ALBANIL A TERMINADOR T PINTURA P PUERTAS Y VENTANAS PV Actividades Materiales y Equipos Costo Directo DISTRIBUCION DE RECURSOS
  • 89.

    Dia Lunes 4Martes 5 Miercoles 6 Jueves 7 Viernes8 1 2 3 4 6 Dia Lunes 11 Martes 12 Miercoles 13 Jueves 14 Viernes 15 7 8 9 10 11 Dia Lunes 18 Martes 19 Miercoles 20 Jueves 21 Viernes 22 12 13 14 15 16 Dia Lunes 25 Martes 26 Miercoles 27 Jueves 28 Viernes 29 17 18 19 20 21 Dia Lunes 1 Martes 2 Miercoles 3 Jueves 4 Viernes 5 22 23 24 25 26 Dia Lunes 8 Martes 9 Miercoles 10 Jueves 11 Viernes 12 27 28 29 30 31 Dia Lunes 15 Martes 16 Miercoles 17 Jueves 18 Viernes 19 32 33 34 35 36 Dia Lunes 22 Martes 23 Miercoles 24 Jueves 25 Viernes 26 37 38 39 40 41 Dia Lunes 29 Martes 30 42 43 CALENDARIZACION : Mayo-Junio
  • 90.
    No. Actividades 01/05/2015-15/05/2015 16/05/2015 -29/01/2015 01/06/2015 -15/06/2015 16/06/2015 -30/06/2015 1 Replanteos casa RD$5,158.40 2 Conexiones temporales RD$1,920.00 3 Habilitar área almacén materiales RD$7,680.00 4 Excavaciones de zapatas muros bloques y columnas RD$10,857.47 5 Acero para zapatas de muros y columnas y para columnas de carga RD$27,212.24 6 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas RD$80,477.38 7 Colocación de bloques BNP de 0.15 y 0.10 mts RD$43,597.76 8 Colocación de bloques SNP de 0.15 y 0.10 mts RD$120,968.43 9 Construcion de registro sanitario y registro trampa de grasa RD$5,833.73 10 Acero para dintel, losa y vigas RD$64,715.10 11 Ligado y vaciado Hormigón Fc=210 kg/cm2 para dintel, losa y vigas RD$78,137.87 12 Colocación de bloques antepecho de 0.15 mts RD$6,864.38 13 Fino , zabaletas y impermeabilizante RD$45,705.47 14 Pañete exterior y antepecho RD$25,517.06 15 Encofrado para dintel, losa y vigas RD$39,446.53 16 Fraguache interior, exterior y techo + techo galeria RD$9,983.36 17 Suministro e instalacion de accesorios electricos RD$68,808.91 18 Suministro e instalacion de accesorios sanitarios RD$60,787.20 19 Pañete interior, en techo y mochetas RD$69,907.75 20 Portaje RD$42,880.00 21 Ventanas RD$22,605.23 22 Jardineria en patio RD$4,160.00 23 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina RD$119,937.24 24 Pintura acrilica interior y exterior RD$37,757.07 25 Cocina (gabinetes de piso, pared y topes de cocina en granito) RD$18,408.33 26 Limpieza general continua y final RD$1,920.00 Desembolsos
  • 91.
    D a avanceresto e transc necesario disp faltante d usada disp o neces faltante m e-o resto costo 1 Replanteos casa 1 0 1 1 0 0 0 0 0 0 1 0 0 0 0 0 0 2 Acero para zapatas de muros y columnas y para columnas de carga 0.33 0.67 3 1 2.01 2 0.01 0 0 0 2 1.34 0 15420.27195 1 0.67 10331.58221 3 Acero para zapatas de muros y columnas y para columnas de carga 0.66 0.34 3 2 1.02 1 0.02 0 0 0 2 0.68 0 15420.27195 1 0.34 5242.892464 4 Acero para zapatas de muros y columnas y para columnas de carga 1 0 3 3 0 0 0 0 0 0 2 0 0 15420.27195 1 0 0 5 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1 0 1 1 0 0 0 0 0 0 1 0 0 0 0 0 0 6 Colocación de bloques BNP de 0.15 y 0.10 mts 0.33 0.67 3 1 2.01 2 0.01 0 0 0 2 1.34 0 24705.39853 1 0.67 16552.61701 7 Colocación de bloques BNP de 0.15 y 0.10 mts 0.66 0.34 3 2 1.02 1 0.02 0 0 0 2 0.68 0 24705.39853 1 0.34 8399.8355 8 Colocación de bloques BNP de 0.15 y 0.10 mts 1 0 3 3 0 0 0 0 0 0 2 0 0 24705.39853 1 0 0 9 Colocación de bloques SNP de 0.15 y 0.10 mts 0.2 0.8 5 1 4 4 0 0 0 0 3 2.4 0 77117.37236 2 0.8 123387.7958 10 Colocación de bloques SNP de 0.15 y 0.10 mts 0.4 0.6 5 2 3 3 0 0 0 0 3 1.8 0 77117.37236 2 0.6 92540.84683 11 Colocación de bloques SNP de 0.15 y 0.10 mts 0.6 0.4 5 3 2 2 0 0 0 0 3 1.2 0 77117.37236 2 0.4 61693.89789 12 Colocación de bloques SNP de 0.15 y 0.10 mts 0.8 0.2 5 4 1 1 0 0 0 0 3 0.6 0 77117.37236 2 0.2 30846.94894 13 Colocación de bloques SNP de 0.15 y 0.10 mts 1 0 5 5 0 0 0 0 0 0 3 0 0 77117.37236 2 0 0 14 Encofrado para dintel, losa y vigas 0.07 0.93 14 1 13.02 13 0.02 0 0 0 13 12.09 0 31134.58289 1 0.93 28955.16209 15 Encofrado para dintel, losa y vigas 0.14 0.86 14 2 12.04 12 0.04 0 0 0 13 11.18 0 31134.58289 1 0.86 26775.74129 16 Encofrado para dintel, losa y vigas 0.21 0.79 14 3 11.06 11 0.06 0 0 0 13 10.27 0 31134.58289 1 0.79 24596.32049 17 Encofrado para dintel, losa y vigas 0.28 0.72 14 4 10.08 10 0.08 0 0 0 13 9.36 0 31134.58289 1 0.72 22416.89968 18 Encofrado para dintel, losa y vigas 0.35 0.65 14 5 9.1 9 0.1 0 0 0 13 8.45 0 31134.58289 1 0.65 20237.47888 19 Encofrado para dintel, losa y vigas 0.42 0.58 14 6 8.12 8 0.12 0 0 0 13 7.54 0 31134.58289 1 0.58 18058.05808 20 Encofrado para dintel, losa y vigas 0.49 0.51 14 7 7.14 7 0.14 0 0 0 13 6.63 0 31134.58289 1 0.51 15878.63728 21 Encofrado para dintel, losa y vigas 0.56 0.44 14 8 6.16 6 0.16 0 0 0 13 5.72 0 31134.58289 1 0.44 13699.21647 22 Encofrado para dintel, losa y vigas 0.63 0.37 14 9 5.18 5 0.18 0 0 0 13 4.81 0 31134.58289 1 0.37 11519.79567 23 Encofrado para dintel, losa y vigas 0.7 0.3 14 10 4.2 4 0.2 0 0 0 13 3.9 0 31134.58289 1 0.3 9340.374868 24 Encofrado para dintel, losa y vigas 0.77 0.23 14 11 3.22 3 0.22 0 0 0 13 2.99 0 31134.58289 1 0.23 7160.954066 25 Encofrado para dintel, losa y vigas 0.84 0.16 14 12 2.24 2 0.24 0 0 0 13 2.08 0.24 31134.58289 1 0.16 4981.533263 26 Encofrado para dintel, losa y vigas 0.91 0.09 14 13 1.26 1 0.26 0 0 0 13 1.17 0.26 31134.58289 1 0.09 2802.11246 27 Encofrado para dintel, losa y vigas 1 0 14 14 0 0 0 0 0 0 13 0 0 31134.58289 1 0 0 28 Fraguache interior, exterior y techo + techo galeria 1 0 1 1 0 0 0 0 0 0 1 0 0 4242.928 0 0 0 29 Pañete interior, en techo y mochetas 0.2 0.8 5 1 4 4 0 0 0 0 4 3.2 0 47537.26723 1 0.8 38029.81378 30 Pañete interior, en techo y mochetas 0.4 0.6 5 2 3 3 0 0 0 0 4 2.4 0 47537.26723 1 0.6 28522.36034 31 Pañete interior, en techo y mochetas 0.6 0.4 5 3 2 2 0 0 0 0 4 1.6 0 47537.26723 1 0.4 19014.90689 32 Pañete interior, en techo y mochetas 0.8 0.2 5 4 1 1 0 0 0 0 4 0.8 0 47537.26723 1 0.2 9507.453446 33 Pañete interior, en techo y mochetas 1 0 5 5 0 0 0 0 0 0 4 0 0 47537.26723 1 0 0 34 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.17 0.83 6 1 4.98 5 -0.02 0 0 0 5 4.15 0 84955.54523 1 0.83 70513.10254 35 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.34 0.66 6 2 3.96 4 -0.04 0 0 0 5 3.3 0 84955.54523 1 0.66 56070.65985 36 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.51 0.49 6 3 2.94 3 -0.06 0 0 0 5 2.45 0 84955.54523 1 0.49 41628.21716 37 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.68 0.32 6 4 1.92 2 -0.08 0 0 0 5 1.6 0 84955.54523 1 0.32 27185.77447 38 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 0.85 0.15 6 5 0.9 1 -0.1 0 0 0 5 0.75 0 84955.54523 1 0.15 12743.33178 39 Torta de piso, porcelanato en 1er nivel, zocalos, pisos de baños y revestimientos de baños y cocina 1 0 6 6 0 0 0 0 0 0 5 0 0 84955.54523 1 0 0 40 Cocina (gabinetes de piso, pared y topes de cocina en granito) 0.33 0.67 3 1 2.01 2 0.01 0 0 0 2 1.34 0 10431.38423 1 0.67 6989.027437 41 Cocina (gabinetes de piso, pared y topes de cocina en granito) 0.66 0.34 3 2 1.02 1 0.02 0 0 0 2 0.68 0 10431.38423 1 0.34 3546.67064 42 Cocina (gabinetes de piso, pared y topes de cocina en granito) 1 0 3 3 0 0 0 0 0 0 2 0 0 10431.38423 1 0 0 43 Limpieza general continua y final ( incluye bote de escombros ) 1 0 1 1 0 0 0 0 0 0 1 0 0 0 0 0 0 Proceso A % Tiempo Holgura Total a ejecucion
  • 92.
    D a avanceresto e transc necesario disp faltante d usada disp o neces faltante m e-o resto costo 1 Conexiones temporales 1 0 1 1 0 0 0 1 0 1 1 0 0 0 0 0 0 2 Excavaciones de zapatas muros bloques y columnas 0.5 0.5 2 1 1 1 0 1 0 1 1 0.5 0 4614.4256 1 0.5 2307.2128 3 Excavaciones de zapatas muros bloques y columnas 1 0 2 2 0 0 0 1 0 1 1 0 0 4614.4256 1 0 0 4 Actividad ficticia 1 0 1 1 0 0 0 0 0 0 0 0 0 0 1 0 0 5 Ligado y vaciado Hormigón Fc=210 kg/cm2 para zapatas de muros y columnas 1 0 1 1 0 0 0 0 0 0 1 0 0 0 0 0 0 6 Colocación de bloques BNP de 0.15 y 0.10 mts 0.33 0.67 3 1 2.01 2 0.01 0 0 0 2 1.34 0 24705.39853 1 0.67 16552.61701 7 Colocación de bloques BNP de 0.15 y 0.10 mts 0.66 0.34 3 2 1.02 1 0.02 0 0 0 2 0.68 0 24705.39853 1 0.34 8399.8355 8 Colocación de bloques BNP de 0.15 y 0.10 mts 1 0 3 3 0 0 0 0 0 0 2 0 0 24705.39853 1 0 0 9 Suministro e instalacion de accesorios sanitarios 0.04 0.96 25 1 24 24 0 6 0 6 24 23.04 0 49602.3552 1 0.96 47618.26099 10 Suministro e instalacion de accesorios sanitarios 0.08 0.92 25 2 23 23 0 6 0 6 24 22.08 0 49602.3552 1 0.92 45634.16678 11 Suministro e instalacion de accesorios sanitarios 0.12 0.88 25 3 22 22 0 6 0 6 24 21.12 0 49602.3552 1 0.88 43650.07258 12 Suministro e instalacion de accesorios sanitarios 0.16 0.84 25 4 21 21 0 6 0 6 24 20.16 0 49602.3552 1 0.84 41665.97837 13 Suministro e instalacion de accesorios sanitarios 0.2 0.8 25 5 20 20 0 6 0 6 24 19.2 0 49602.3552 1 0.8 39681.88416 14 Suministro e instalacion de accesorios sanitarios 0.24 0.76 25 6 19 19 0 6 0 6 24 18.24 0 49602.3552 1 0.76 37697.78995 15 Suministro e instalacion de accesorios sanitarios 0.28 0.72 25 7 18 18 0 6 0 6 24 17.28 0 49602.3552 1 0.72 35713.69574 16 Suministro e instalacion de accesorios sanitarios 0.32 0.68 25 8 17 17 0 6 0 6 24 16.32 0 49602.3552 1 0.68 33729.60154 17 Suministro e instalacion de accesorios sanitarios 0.36 0.64 25 9 16 16 0 6 0 6 24 15.36 0 49602.3552 1 0.64 31745.50733 18 Suministro e instalacion de accesorios sanitarios 0.4 0.6 25 10 15 15 0 6 0 6 24 14.4 0 49602.3552 1 0.6 29761.41312 19 Suministro e instalacion de accesorios sanitarios 0.44 0.56 25 11 14 14 0 6 0 6 24 13.44 0 49602.3552 1 0.56 27777.31891 20 Suministro e instalacion de accesorios sanitarios 0.48 0.52 25 12 13 13 0 6 0 6 24 12.48 0 49602.3552 1 0.52 25793.2247 21 Suministro e instalacion de accesorios sanitarios 0.52 0.48 25 13 12 12 0 6 0 6 24 11.52 0 49602.3552 1 0.48 23809.1305 22 Suministro e instalacion de accesorios sanitarios 0.56 0.44 25 14 11 11 0 6 0 6 24 10.56 0 49602.3552 1 0.44 21825.03629 23 Suministro e instalacion de accesorios sanitarios 0.6 0.4 25 15 10 10 0 6 0 6 24 9.6 0 49602.3552 1 0.4 19840.94208 24 Suministro e instalacion de accesorios sanitarios 0.64 0.36 25 16 9 9 0 6 0 6 24 8.64 0 49602.3552 1 0.36 17856.84787 25 Suministro e instalacion de accesorios sanitarios 0.68 0.32 25 17 8 8 0 6 0 6 24 7.68 0 49602.3552 1 0.32 15872.75366 26 Suministro e instalacion de accesorios sanitarios 0.72 0.28 25 18 7 7 0 6 0 6 24 6.72 0 49602.3552 1 0.28 13888.65946 27 Suministro e instalacion de accesorios sanitarios 0.76 0.24 25 19 6 6 0 6 0 6 24 5.76 0 49602.3552 1 0.24 11904.56525 28 Suministro e instalacion de accesorios sanitarios 0.8 0.2 25 20 5 5 0 6 0 6 24 4.8 0 49602.3552 1 0.2 9920.47104 29 Suministro e instalacion de accesorios sanitarios 0.84 0.16 25 21 4 4 0 6 0 6 24 3.84 0 49602.3552 1 0.16 7936.376832 30 Suministro e instalacion de accesorios sanitarios 0.88 0.12 25 22 3 3 0 6 0 6 24 2.88 0 49602.3552 1 0.12 5952.282624 31 Suministro e instalacion de accesorios sanitarios 0.92 0.08 25 23 2 2 0 6 0 6 24 1.92 0 49602.3552 1 0.08 3968.188416 32 Suministro e instalacion de accesorios sanitarios 0.96 0.04 25 24 1 1 0 6 0 6 24 0.96 0 49602.3552 1 0.04 1984.094208 33 Suministro e instalacion de accesorios sanitarios 1 0 25 25 0 0 0 6 0 6 24 0 0 49602.3552 1 0 0 34 Jardineria en patio 0.25 0.75 4 1 3 3 0 6 0 6 3 2.25 0 2652 1 0.75 1989 35 Jardineria en patio 0.5 0.5 4 2 2 2 0 6 0 6 3 1.5 0 2652 1 0.5 1326 36 Jardineria en patio 0.75 0.25 4 3 1 1 0 6 0 6 3 0.75 0 2652 1 0.25 663 37 Jardineria en patio 1 0 4 4 0 0 0 6 0 6 3 0 0 2652 1 0 0 Proceso B % Tiempo Holgura Total a ejecucion
  • 93.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 1.000 Hormigón Armado en: 1.010 Zapata de muro Muros de 0.15m. 1.011 Hormigón Fc=210 kg/cm2. 1.050 m3 5,336.00 5,602.80 1.012 Ligado y vaciado. 1.050 m3 650.00 682.50 1.013 Acero f 3/8" 0.740 qq 2,100.00 1,554.00 1.014 Calzos 0.740 qq 2.40 1.78 1.015 M. O. Acero 0.740 qq 183.60 135.86 1.016 Alambre #18 1.480 lbs 42.00 62.16 1.017 Herramientas y equipos 1.000 m3 120.59 120.59 8,159.69 0.010 Zapata de muro Muros de 0.10m. 0.011 Hormigón Fc=210 kg/cm2. 1.050 m3 5,336.00 5,602.80 0.012 Ligado y vaciado. 1.050 m3 650.00 682.50 0.013 Acero f 3/8" 0.740 qq 2,400.00 1,776.00 0.014 Calzos 0.740 qq 2.40 1.78 0.015 M. O. Acero 0.740 qq 183.60 135.86 0.016 Alambre #18 1.480 lbs 42.00 62.16 0.017 Herramientas y equipos 1.000 m3 123.92 123.92 8,385.02 1.020 Zapatas de Columnas. 1.021 Hormigón Fc=210 kg/cm2. 1.050 m3 5,336.00 5,602.80 1.022 Ligado y vaciado. 1.050 m3 650.00 682.50 1.023 Acero f 3/8" qq - 1.024 Acero f 1/2" 0.354 qq 2,100.00 743.40 1.025 Acero f 3/4" qq - 1.026 Acero f 1" qq - 1.027 Calzos 0.354 qq 2.40 0.85 1.028 M. O. Acero 0.354 qq 183.60 64.99 1.029 Alambre #18 0.708 lbs 42.00 29.74 1.030 Herramientas y equipos 1.000 m3 106.86 106.86 7,231.14 1.030 Platea de Escaleras y Ascensor. 1.031 Hormigón Fc=210 kg/cm2. 1.050 m3 5,336.00 5,602.80 1.032 Ligado y vaciado. 1.050 m3 425.00 446.25 1.033 Acero f 3/4" 2.156 qq 1,504.94 3,244.65 1.034 Acero f 1" 1.515 qq 1,504.94 2,279.99 1.035 Calzos 3.671 qq 2.40 8.81 1.036 M. O. Acero 2.156 qq 183.60 395.84 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 93
  • 94.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 1.037 Alambre #18 4.312 lbs 42.00 181.10 1.038 Herramientas y equipos 1.000 m3 182.39 182.39 12,341.83 1.040 Columnas C1 (0.30*0.40) mts. 5to al 8vo Nivel. 1.041 Hormigón industrial Fc=240 kg/cm2. 1.050 m3 5,742.00 6,029.10 1.042 Ligado y vaciado. 1.050 m3 425.00 446.25 1.043 Acero f 3/4" 4.500 qq 1,504.94 6,772.24 1.044 Acero f 3/8" 2.461 qq 1,504.94 3,703.66 1.045 M. O. Acero 6.961 qq 183.60 1,278.04 1.046 Alambre #18 13.922 lbs 42.00 584.72 1.047 Madera a todo costo. 8.333 ml 1,020.00 8,500.00 1.048 Herramientas y equipos 1.000 m3 409.71 409.71 27,723.72 1.050 Columnas C1 (0.15*0.20) mts.1ro al 2do Nivel. 1.051 Hormigón industrial Fc=240 kg/cm2. 1.050 m3 5,742.00 6,029.10 1.052 Ligado y vaciado. 1.050 m3 650.00 682.50 1.053 Acero f 1/2" 3.280 qq 2,100.00 6,888.00 1.054 Acero f 3/8" 1.765 qq 2,100.00 3,706.50 1.055 M. O. Acero 5.045 qq 183.60 926.26 1.056 Alambre #18 10.090 lbs 42.00 423.78 1.057 Madera a todo costo. 33.333 ml 200.00 6,666.67 1.058 Herramientas y equipos 1.000 m3 379.84 379.84 25,702.65 1.060 Columnas C3 (0.30*0.40) mts. 1ro al 4to Nivel. 1.061 Hormigón industrial Fc=240 kg/cm2. 1.050 m3 5,742.00 6,029.10 1.062 Ligado y vaciado. 1.050 m3 425.00 446.25 1.063 Acero f 1" 3.799 qq 1,504.94 5,717.27 1.064 Acero f 3/4" 2.134 qq 1,504.94 3,211.55 1.065 Acero f 3/8" 2.551 qq 1,504.94 3,839.11 1.066 M. O. Acero 8.484 qq 183.60 1,557.66 1.067 Alambre #18 16.968 lbs 42.00 712.66 1.068 Madera a todo costo. 3.125 ml 1,020.00 3,187.50 1.069 Herramientas y equipos 1.000 m3 370.52 370.52 25,071.62 1.070 Rampas de Escalera (h = 0.12 mts): 1.071 Hormigón Fc=210 kg/cm2. 1.050 m3 5,336.00 5,602.80 1.072 Ligado y vaciado. 1.050 m3 425.00 446.25 1.073 Acero f 3/8" 0.210 qq 1,504.94 316.04 1.074 Acero f 1/2" 4.270 qq 1,504.94 6,426.10 1.075 M. O. Acero 4.480 qq 300.00 1,344.00 1.076 Alambre #18 8.960 lbs 42.00 376.32 1.077 Madera a todo costo. 8.333 m2 400.00 3,333.33 1.078 Herramientas y equipos 1.000 m3 267.67 267.67 18,112.51 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 94
  • 95.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 1.080 Vigas de amarre primer nivel de (0.15*0.30) mts. 1.081 Hormigón Fc=210 kg/cm2. 1.050 m3 5,742.00 6,029.10 1.082 Ligado y vaciado. 1.050 m3 425.00 446.25 1.083 Acero f 3/8" 1.751 qq 2,100.00 3,677.10 1.084 Acero f 1/2" 0.955 qq 2,100.00 2,005.50 1.085 M. O. Acero 2.706 qq 183.60 496.82 1.086 Alambre #18 5.412 lbs 42.00 227.30 1.087 Madera a todo costo. 12.500 ml 300.00 3,750.00 1.088 Herramientas y equipos 1.000 m3 249.48 249.48 16,881.55 1.090 Vigas amarre segundo nivel de (0.15*0.25) mts. 1.091 Hormigón Fc=210 kg/cm2. 1.050 m3 5,742.00 6,029.10 1.092 Ligado y vaciado. 1.050 m3 425.00 446.25 1.093 Acero f 3/8" 1.673 qq 1,504.94 2,517.77 1.094 M. O. Acero 1.673 qq 183.60 307.16 1.095 Alambre #18 3.346 lbs 42.00 140.53 1.096 Madera a todo costo. 8.333 ml 300.00 2,500.00 1.097 Herramientas y equipos 1.000 m3 179.11 179.11 12,119.92 1.100 Vigas V1- de (0.15*0.30) mts. 1.101 Hormigón Fc=210 kg/cm2. 1.050 m3 5,742.00 6,029.10 1.102 Ligado y vaciado. 1.050 m3 650.00 682.50 1.103 Acero f 3/8" 1.110 qq 2,100.00 2,331.00 1.104 Acero f 1/2" 0.820 qq 2,100.00 1,722.00 1.105 Acero f 3/4" qq 1,504.94 - 1.106 M. O. Acero 1.930 qq 183.60 354.35 1.107 Alambre #18 3.860 lbs 42.00 162.12 1.108 Madera a todo costo. 11.111 ml 300.00 3,333.33 1.109 Herramientas y equipos 1.000 m3 219.22 219.22 14,833.62 1.110 Dinteles de (0.15*0.20) mts. 1.111 Hormigón Fc=210 kg/cm2. 1.050 m3 3,587.88 3,767.27 1.112 Ligado y vaciado. 1.050 m3 650.00 682.50 1.113 Acero f 3/8" 3.420 qq 2,100.00 7,182.00 1.114 M. O. Acero 3.420 qq 183.60 627.91 1.115 Alambre #18 6.840 lbs 42.00 287.28 1.116 Madera a todo costo. 33.333 ml 170.00 5,666.67 1.117 Herramientas y equipos 1.000 m3 273.20 273.20 18,486.83 1.120 Losas de entrepiso (h = 0.15mts): 1.121 Hormigón Industrial Fc=210kg/cm2. 1.050 m3 5,336.00 5,602.80 1.122 Ligado y vaciado. 1.050 m3 425.00 446.25 1.123 Acero f 3/8" 1.600 qq 1,504.94 2,407.91 1.124 M. O. Acero 1.600 qq 183.60 293.76 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 95
  • 96.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 1.125 Alambre #18 3.200 lbs 42.00 134.40 1.125 Madera a todo costo. 6.667 m2 200.00 1,333.33 1.126 Herramientas y equipos 1.000 m3 153.28 153.28 10,371.73 1.130 Losas de entrepiso (h = 0.12mts): 1.131 Hormigón Industrial Fc=210kg/cm2. 1.050 m3 5,336.00 5,602.80 1.132 Ligado y vaciado. 1.050 m3 650.00 682.50 1.133 Acero f 3/8" 1.510 qq 2,300.00 3,473.00 1.134 M. O. Acero 1.510 qq 183.60 277.24 1.135 Alambre #18 3.020 lbs 42.00 126.84 1.135 Madera a todo costo. 8.333 m2 250.00 2,083.33 1.136 Herramientas y equipos 1.000 m3 183.69 183.69 12,429.40 1.140 Losas de Techo (h = 0.12mts): 1.141 Hormigón Industrial Fc=210kg/cm2. 1.050 m3 5,336.00 5,602.80 1.142 Ligado y vaciado. 1.050 m3 425.00 446.25 1.143 Acero f 3/8" 1.410 qq 1,504.94 2,121.97 1.144 M. O. Acero 1.410 qq 183.60 258.88 1.145 Alambre #18 2.820 lbs 42.00 118.44 1.145 Madera a todo costo. 8.333 m2 250.00 2,083.33 1.146 Herramientas y equipos 1.000 m3 159.48 159.48 10,791.15 1.150 Losas de piso (h = 0.15mts): 1.151 Hormigón Industrial Fc=210kg/cm2. 1.050 m3 5,336.00 5,602.80 1.152 Ligado y vaciado. 1.050 m3 425.00 446.25 1.153 Acero f 3/8" 1.410 qq 1,504.94 2,121.97 1.154 M. O. Acero 1.410 qq 183.60 258.88 1.155 Alambre #18 2.820 lbs 42.00 118.44 1.155 Regla de madera 10.000 ml 40.00 400.00 1.156 Herramientas y equipos 1.000 m3 134.23 134.23 9,082.57 1.160 Losas Superior de Cisterna 1.161 Hormigón Fc=180kg/cm2. 1.050 m3 3,409.62 3,580.10 1.162 Ligado y vaciado. 1.050 m3 420.00 441.00 1.163 Acero f3/8" 1.200 qq 1,504.94 1,805.93 1.164 Calzos 1.200 qq 2.40 2.88 1.165 M. O. Acero 1.200 qq 183.60 220.32 1.166 Alambre #18 2.400 lbs 42.00 100.80 1.167 Madera a todo costo 6.667 m2 120.00 800.00 1.168 Herramientas y equipos 1.000 m3 104.27 104.27 7,055.30 1.170 Losas Fondo de Cisterna 1.171 Hormigón Fc=180kg/cm2. 1.050 m3 3,409.62 3,580.10 1.172 Ligado y vaciado. 1.050 m3 420.00 441.00 1.173 Acero f3/8" 1.300 qq 1,504.94 1,956.42 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 96
  • 97.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 1.174 Calzos 1.300 qq 2.40 3.12 1.175 M. O. Acero 1.300 qq 183.60 238.68 1.176 Alambre #18 2.600 lbs 42.00 109.20 1.177 Herramientas y equipos 1.000 m3 94.93 94.93 6,423.45 1.180 Vigas de Cisterna y/o vigas de amarre. 1.181 Hormigón Fc=180kg/cm2. 1.050 m3 3,409.62 3,580.10 1.182 Ligado y vaciado. 1.050 m3 420.00 441.00 1.183 Acero f3/8" 1.901 qq 1,504.94 2,860.89 1.184 Acero f1/2" 1.620 qq 1,504.94 2,438.01 1.185 M. O. Acero 3.521 qq 183.60 646.46 1.186 Alambre #18 7.042 lbs 42.00 295.76 1.187 Madera a todo costo 16.667 ml 120.00 2,000.04 1.188 Herramientas y equipos 1.000 m3 183.93 183.93 12,446.19 1.190 Antepecho de Cisterna. 1.191 Hormigón Fc=180kg/cm2 1.050 m3 3,409.62 3,580.10 1.192 Ligado vaciado 1.050 m3 420.00 441.00 1.193 Acero f1/4" 3.140 qq 2,646.47 8,309.92 1.194 Acero f3/8" 1.680 qq 1,504.94 2,528.30 1.195 Acero f1/2" 3.000 qq 1,504.94 4,514.82 1.196 M. O. Acero 4.680 qq 183.60 859.25 1.197 Alambre #18 9.360 lbs 42.00 393.12 1.198 Madera a todo costo 50.000 ml 80.00 4,000.00 1.199 Herramientas y equipos 1.000 m3 369.40 369.40 24,995.91 1.200 Columnas y columnas de Amare de Cisterna. 1.201 Hormigón Fc=210kg/cm2 1.050 m3 3,409.62 3,580.10 1.202 Ligado vaciado 1.050 m3 420.00 441.00 1.203 Acero f3/8" 1.512 qq 1,504.94 2,275.47 1.204 Acero f1/2" 1.386 qq 1,504.94 2,085.85 1.205 M. O. Acero 2.898 qq 183.60 532.07 1.206 Alambre #18 5.796 lbs 42.00 243.43 1.207 Madera a todo costo 25.000 ml 120.00 3,000.00 1.208 Herramientas y equipos 1.000 m3 243.16 243.16 12,401.08 1.210 Losas de Caseta de Bomba. 1.211 Hormigón Fc=180kg/cm2. 1.050 m3 3,409.62 3,580.10 1.212 Ligado y vaciado. 1.050 m3 420.00 441.00 1.213 Acero f3/8" 1.180 qq 1,504.94 1,775.83 1.214 Calzos 1.180 qq 2.40 2.83 1.215 M. O. Acero 1.180 qq 183.60 216.65 1.216 Alambre #18 2.360 lbs 42.00 99.12 1.217 Madera a todo costo 10.000 m2 120.00 1,200.00 1.218 Herramientas y equipos 1.000 m3 109.73 109.73 7,425.26 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 97
  • 98.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 1.220 Vigas de Caseta de Bomba. 1.221 Hormigón Fc=180kg/cm2. 1.050 m3 3,409.62 3,580.10 1.222 Ligado y vaciado. 1.050 m3 420.00 441.00 1.223 Acero f3/8" 1.900 qq 1,504.94 2,859.39 1.224 M. O. Acero 1.900 qq 183.60 348.84 1.225 Alambre #18 3.800 lbs 42.00 159.60 1.226 Madera a todo costo 16.667 ml 120.00 2,000.04 1.227 Herramientas y equipos 1.000 m3 140.83 140.83 9,529.80 2.000 Sub-Partidas: 2.010 Mezcla 1:3 2.011 Cemento gris 11.510 fds 300.00 3,453.00 2.012 Arena gruesa 1.000 m3 600.00 600.00 2.013 Agua 69.040 gls 0.50 34.52 2.014 Herramientas y equipos 1.000 m3 61.31 61.31 4,087.52 2.020 Mezcla 1:4 2.021 Cemento gris 9.110 fds 300.00 2,733.00 2.022 Arena gruesa 1.060 m3 600.00 636.00 2.023 Agua 68.160 gls 0.50 34.08 2.024 Herramientas y equipos 1.000 m3 51.05 51.05 3,454.13 2.030 Mezcla 1:5 2.031 Cemento gris 7.560 fds 300.00 2,268.00 2.032 Arena gruesa 1.091 m3 600.00 654.60 2.033 Agua 67.990 gls 0.50 34.00 2.034 Herramientas y equipos 1.000 m3 44.35 44.35 3,000.95 2.040 Mortero 1:1.5:5 2.041 Cemento gris 9.460 fds 300.00 2,838.00 2.042 Arena para pañetes 0.910 m3 700.00 637.00 2.043 Agua 45.240 gls 0.50 22.62 2.044 Cal 50 lbs 6.290 fds 240.12 1,510.35 2.045 Herramientas y equipos 1.000 m3 75.12 75.12 5,083.09 2.050 Hormigón F´c=140 kgs/cm2 2.051 Cemento gris 7.530 fds 300.00 2,259.00 2.052 Arena gruesa 0.524 m3 600.00 314.40 2.053 Grava 0.726 m3 750.00 544.50 2.054 Agua 54.650 gls 0.50 27.33 2.055 Herramientas y equipos 1.000 m3 47.18 47.18 3,192.41 2.060 Mezcla 1:2.5:4 kgs/cm2 ciclopeos 2.061 Cemento gris 6.680 fds 300.00 2,004.00 2.062 Arena gruesa 0.480 m3 600.00 288.00 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 98
  • 99.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 2.063 Grava 0.770 m3 750.00 577.50 2.064 Agua 54.650 gls 0.50 27.33 2.065 Herramientas y equipos 1.000 m3 43.45 43.45 2,940.28 2.070 Hormigón F´c=180 kgs/cm2 2.071 Cemento gris 8.310 fds 300.00 2,493.00 2.072 Arena gruesa 0.512 m3 600.00 307.20 2.073 Grava 0.710 m3 750.00 532.50 2.074 Agua 53.060 gls 0.50 26.53 2.075 Herramientas y equipos 1.000 m3 50.39 50.39 3,409.62 2.080 Hormigón F´c=210 kgs/cm2 2.081 Cemento gris 8.940 fds 300.00 2,682.00 2.082 Arena gruesa 0.505 m3 600.00 303.00 2.083 Grava 0.699 m3 750.00 524.25 2.084 Agua 51.220 gls 0.50 25.61 2.085 Herramientas y equipos 1.000 m3 53.02 53.02 3,587.88 2.090 Relleno compactado: 2.091 Relleno de caliche 1.300 m3 250.00 325.00 2.092 Regado, nivelado y apisonado 1.000 m3 76.00 76.00 2.093 Herramientas y equipos 1.000 m2 6.02 6.02 407.02 2.100 Relleno de reposición con material de mina: 2.101 Relleno de caliche 1.300 m3 250.00 325.00 2.102 Regado y nivelado. 1.000 m3 40.00 40.00 2.103 Herramientas y equipos 1.000 m2 5.48 5.48 370.48 2.110 Suministo y regado de Grava: 2.111 Grava. 1.000 m3 750.00 750.00 2.112 Regado de grava. 1.000 m3 50.00 50.00 2.113 Herramientas y equipos. 1.000 m2 12.00 12.00 812.00 2.120 Suministo y regado de piedra: 2.121 Piedra 1.000 m3 400.00 400.00 2.122 Regado de piedra. 1.000 m3 50.00 50.00 2.123 Herramientas y equipos. 1.000 m2 6.75 6.75 456.75 2.130 Andamios Interiores 2.131 Madera de pino 0.182 p2 45.00 8.19 2.132 Colocacion de andamios int. 1.000 m2 7.80 7.80 2.133 Herramientas y equipos 1.000 m2 0.24 0.24 16.23 2.140 Andamios Exteriores 2.141 Madera de pino 1.150 p2 45.00 51.75 2.142 Clavos Corrientes 0.160 lbs 29.00 4.64 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 99
  • 100.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 2.143 Clavos de acero 0.030 lbs 47.00 1.41 2.144 Colocacion de andamios ext. 11.410 p2 4.50 51.35 2.145 Herramientas y equipos 1.000 m2 1.64 1.64 110.79 3.000 Muros de Bloques: 3.010 De 0.10mts B.N.P. 3.011 Bloques de 0.10 mts 12.875 u 22.00 283.25 3.012 Acero f 3/8" 0.011 qq 2,646.47 29.11 3.013 Alambre #18 0.022 lbs 42.00 0.92 3.014 Mezcla 1:3 0.020 m3 4,087.52 81.75 3.015 Hormigón Fc=140 kgs/cm2 0.009 m3 3,192.41 28.73 3.016 Colocación de bloques de 0.10 mts 13.000 u 10.80 140.40 3.017 Llenado de huecos a 0.80 mts 13.000 u 0.82 10.61 3.018 Corte y amarre de acero a 0.80 mts 13.000 u 0.42 5.46 3.019 Herramientas y equipos 1.000 m2 8.70 8.70 588.93 3.020 De 0.15mts B.N.P. 3.021 Bloques de 0.15 mts 12.875 u 24.00 309.00 3.022 Acero f 3/8" 0.024 qq 1,504.94 36.12 3.023 Alambre #18 0.048 lbs 42.00 2.02 3.024 Mezcla 1:3 0.031 m3 4,087.52 126.71 3.025 Hormigón Fc=140 kgs/cm2 0.019 m3 3,192.41 60.66 3.026 Colocación de bloques de 0.15 mts 13.000 u 10.80 140.40 3.027 Llenado de huecos a 0.80 mts 13.000 u 0.82 10.61 3.028 Corte y amarre de acero a 0.80 mts 13.000 u 0.42 5.46 3.029 Herramientas y equipos 1.000 m2 10.36 10.36 701.34 3.030 De 0.20 B.N.P. 3.031 Bloques de 0.20 mts 12.875 u 30.00 386.25 3.032 Acero f 3/8" 0.037 qq 1,504.94 55.68 3.033 Acero f 1/2" y 3/8" de refuerzos 0.025 qq 1,504.94 37.62 3.034 Alambre #18 0.124 lbs 42.00 5.21 3.035 Mezcla 1:3 0.039 m3 4,087.52 159.41 3.036 Hormigón Fc=140 kgs/cm2 0.048 m3 3,192.41 153.24 3.037 Colocación de bloques de 0.20 mts 13.000 u 10.80 140.40 3.038 Llenado de huecos a 0.80 mts 13.000 u 0.82 10.61 3.039 Corte y amarre de acero a 0.80 mts 13.000 u 0.93 12.09 3.03A Herramientas y equipos 1.000 m2 14.41 14.41 974.92 3.040 De 0.15 mts B.N.P. con C/LL y f 3/8" a 0.40 mts. 3.041 Bloques de 0.15 mts 12.875 u 24.00 309.00 3.042 Acero f 3/8" 0.037 qq 1,504.94 55.68 3.043 Alambre #18 0.074 lbs 42.00 3.11 3.044 Mezcla 1:3 0.031 m3 4,087.52 126.71 3.045 Hormigón Fc=140 kgs/cm2 0.048 m3 3,192.41 153.24 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 100
  • 101.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 3.046 Colocación de bloques de 0.15 mts 13.000 u 10.80 140.40 3.047 Llenado de huecos a 0.40 mts 13.000 u 1.66 21.53 3.048 Corte y amarre de acero a 0.40 mts 13.000 u 0.82 10.61 3.049 Herramientas y equipos 1.000 m2 12.30 12.30 832.58 3.050 De 0.20 mts B.N.P. con C/LL y f 3/8" a 0.40 mts. 3.051 Bloques de 0.20 mts 12.875 u 30.00 386.25 3.052 Acero f 3/8" 0.024 qq 1,504.94 36.12 3.053 Alambre #18 0.048 lbs 42.00 2.02 3.054 Mezcla 1:3 0.039 m3 4,087.52 159.41 3.055 Hormigón Fc=140 kgs/cm2 0.031 m3 3,192.41 98.96 3.056 Colocación de bloques de 0.20 mts 13.000 u 10.80 140.40 3.057 Llenado de huecos a 0.80 mts 13.000 u 1.66 21.53 3.058 Corte y amarre de acero a 0.80 mts 13.000 u 0.82 10.61 3.059 Herramientas y equipos 1.000 m2 12.83 12.83 868.13 3.060 De 0.10mts S.N.P. 3.061 Bloques de 0.10 mts 12.875 u 22.00 283.25 3.062 Acero f 1/4" 0.011 qq 2,646.47 29.11 3.063 Alambre #18 0.022 lbs 42.00 0.92 3.064 Mezcla 1:3 0.020 m3 4,087.52 81.75 3.065 Hormigón Fc=140 kgs/cm2 0.009 m3 3,192.41 28.73 3.066 Colocación de bloques de 0.10 mts 13.000 u 10.80 140.40 3.067 Llenado de huecos a 0.80 mts 13.000 u 0.82 10.61 3.068 Corte y amarre de acero a 0.80 mts 13.000 u 0.42 5.46 3.069 Andamios interiores 1.000 m2 16.23 16.23 3.06A Herramientas y equipos 1.000 m2 8.95 8.95 605.41 3.070 De 0.15mts S.N.P. 3.071 Bloques de 0.15mts 12.875 u 24.00 309.00 3.072 Acero f 3/8" 0.024 qq 1,504.94 36.12 3.073 Alambre #18 0.048 lbs 42.00 2.02 3.074 Mezcla 1:3 0.031 m3 4,087.52 126.71 3.075 Hormigón Fc=140 kgs/cm2 0.019 m3 3,192.41 60.66 3.076 Colocación de bloques de 0.15 mts 13.000 u 10.80 140.40 3.077 Llenado de huecos a 0.80 mts 13.000 u 0.82 10.61 3.078 Corte y amarre de acero a 0.80 mts 13.000 u 0.42 5.46 3.079 Andamios interiores 1.000 m2 16.23 16.23 3.07A Herramientas y equipos 1.000 m2 10.61 10.61 717.82 3.080 De 0.20 Mts. S.N.P. 3.081 Bloques de 0.15mts 12.875 u 30.00 386.25 3.082 Acero f 3/8" 0.037 qq 1,504.94 55.68 3.083 Acero f 1/2" y 3/8" de refuerzos 0.025 qq 1,504.94 37.62 3.084 Alambre #18 0.124 lbs 42.00 5.21 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 101
  • 102.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 3.085 Mezcla 1:3 0.039 m3 4,087.52 159.41 3.086 Hormigón Fc=140 kgs/cm2 0.048 m3 3,192.41 153.24 3.087 Colocación de bloques de 0.15 mts 13.000 u 10.80 140.40 3.088 Llenado de huecos a 0.80 mts 13.000 u 0.82 10.61 3.089 Corte y amarre de acero a 0.80 mts 13.000 u 0.93 12.09 3.08A Andamios interiores 1.000 m2 16.23 16.23 3.08B Herramientas y equipos 1.000 m2 14.65 14.65 991.39 4.000 Terminacion de Superficies: 4.010 Pañete liso en muros interiores. 4.011 Madera de pino 0.033 p2 45.00 1.49 4.012 Mortero 1:1.5:5 0.022 m3 5,083.09 111.83 4.013 Andamios interiores 1.000 m2 16.23 16.23 4.014 Pañete en interior,en paredes maestreado y a plomo 1.000 m2 73.97 73.97 4.015 Herramientas y equipos 1.000 m2 3.05 3.05 206.57 4.020 Pañete liso en muros exteriores. 4.021 Madera de pino 0.033 p2 45.00 1.49 4.022 Mortero 1:1.5:5 0.022 m3 5,083.09 111.83 4.023 Andamios interiores 1.000 m2 16.23 16.23 4.024 Pañete en exterior,en paredes maestreado y a plomo 1.000 m2 94.13 94.13 4.025 Herramientas y equipos 1.000 m2 3.36 3.36 227.04 4.030 Pañete liso en superficie de hormigón 4.031 Madera de pino 0.033 p2 45.00 1.49 4.032 Mortero 1:1.5:5 0.022 m3 5,083.09 111.83 4.033 Andamios interiores 1.000 m2 16.23 16.23 4.034 Pañete en techos y vigas 1.000 m2 95.88 95.88 4.035 Herramientas y equipos 1.000 m2 3.38 3.38 228.81 4.040 Pañete Pulido 4.041 Madera de pino 0.033 p2 45.00 1.49 4.042 Mortero 1:1.5:5 0.020 m3 5,083.09 101.66 4.043 Andamios interiores 1.000 m2 16.23 16.23 4.044 Pañete pulido sin color 1.000 m2 80.70 80.70 4.045 Cemento Gris 0.053 fds 240.00 12.72 4.046 Herramientas y equipos 1.000 m2 3.19 3.19 215.99 4.050 Zabaleta de Piso: 4.051 Mezcla 1:3. 0.008 m3 4,087.52 32.70 4.052 Zabaleta en Piso: 1.000 ml 24.00 24.00 4.053 Herramientas y equipos 1.000 ml 0.85 0.85 57.55 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 102
  • 103.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 4.060 Fino en Losa Superior: 4.061 Madera de pino 0.013 p2 45.00 0.59 4.062 Mortero 1:3 0.021 m3 4,087.52 85.84 4.063 Fino en septicos y cisternas 1.000 m2 42.00 42.00 4.064 Herramientas y equipos 1.000 ml 1.93 1.93 130.36 4.070 Violines: 4.071 Mortero 1:1.5:5 0.009 m3 5,083.09 45.75 4.072 Confección y colocación 1.000 m2 12.75 12.75 4.073 Herramientas y equipos 1.000 m2 0.88 0.88 59.38 4.080 Fraguache en superficie de hormigón 4.081 Escoba 0.010 u 10.00 0.10 4.082 Mezcla 1:5 0.008 m3 3,000.95 24.01 4.083 Fraguache con escoba 1.000 m2 11.11 11.11 4.084 Herramientas y equipos 1.000 m2 0.53 0.53 35.75 4.090 Cantos 4.091 Madera de pino 0.109 p2 45.00 4.91 4.092 Mortero 1:1.5:5 0.004 m3 5,083.09 20.33 4.093 Cantos en vigas, columnas y muros 1.000 ml 32.20 32.20 4.094 Herramientas y equipos 1.000 ml 0.86 0.86 58.30 5.000 Terminación de Pisos: 5.010 Piso de Porcelanato de Importada de 0.40*0.40 mts. 5.011 Piso de cerámica de importada 0.40*0.40 m. 1.100 m2 400.00 440.00 5.012 Derretido cemento blanco. 0.070 fda. 406.00 28.42 5.013 Estopa. 0.050 lb 52.00 2.60 5.014 Mezcla 1:4 0.032 m3 3,454.13 110.53 5.015 Colocación de pisos de cerámica. 1.000 m2 252.00 252.00 5.016 Corte de chazos de 0.40m. 3.000 u 7.38 22.14 5.017 Herramientas y equipos 1.000 m2 12.84 12.84 868.53 5.020 Piso de Cerámica de Alto de Tráfico 0.30*0.30 mts. 5.021 Piso de cerámica de alto tráfico 0.30*0.30 mts. 1.100 m2 450.00 495.00 5.022 Derretido cemento blanco. 0.070 fda. 406.00 28.42 5.023 Estopa. 0.050 lb 52.00 2.60 5.024 Mezcla 1:4 0.032 m3 3,454.13 110.53 5.025 Colocación de pisos de cerámica importada. 1.000 m2 252.00 252.00 5.026 Corte de chazos de 0.40m. 3.000 u 7.38 22.14 5.027 Herramientas y equipos 1.000 m2 13.66 13.66 924.35 5.030 Piso de Cerámica de 0.30*0.30 mts. 5.031 Piso de cerámica de 0.30*0.30 mts. 1.100 m2 350.00 385.00 5.032 Derretido cemento blanco. 0.070 fda. 406.00 28.42 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 103
  • 104.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 5.033 Estopa. 0.050 lb 52.00 2.60 5.034 Mezcla 1:4 0.032 m3 3,454.13 110.53 5.035 Colocación de pisos de cerámica importada. 1.000 m2 252.00 252.00 5.036 Corte de chazos de 0.40m. 3.000 u 7.38 22.14 5.037 Herramientas y equipos 1.000 m2 12.01 12.01 812.70 5.040 Zócalos de Porcelanato de 0.10*0.40 m. 5.041 Zocalos de porcelanato de 0.10*0.33m. 1.050 ml. 110.00 115.50 5.042 Derretido cemento blanco. 0.022 fda. 406.00 8.93 5.043 Mezcla 1:4 0.002 m3 3,454.13 6.91 5.044 Colocacion de zocalos 1.000 ml. 37.32 37.32 5.045 Corte de chazos de 0.40m 1.000 u 7.38 7.38 5.046 Herramientas y equipos 1.000 ml. 2.64 2.64 178.68 5.050 Zócalos de Cerámica de Alto Trafico de 0.10*0.40 m. 5.051 Zocalos de cerámica de alto trafico de 0.10*0.33m. 1.050 ml. 80.00 84.00 5.052 Derretido cemento blanco. 0.022 fda. 406.00 8.93 5.053 Mezcla 1:4 0.002 m3 3,454.13 6.91 5.054 Colocacion de zocalos 1.000 ml. 37.32 37.32 5.055 Corte de chazos de 0.40m 1.000 u 7.38 7.38 5.056 Herramientas y equipos 1.000 ml. 2.17 2.17 146.71 5.060 Zócalos de Cerámica de Importada de 0.10*0.40 m. 5.061 Zocalos de cerámica de Importada de 0.10*0.33m. 1.050 ml. 35.00 36.75 5.062 Derretido cemento blanco. 0.022 fda. 406.00 8.93 5.063 Mezcla 1:4 0.002 m3 3,454.13 6.91 5.064 Colocacion de zocalos 1.000 ml. 37.32 37.32 5.065 Corte de chazos de 0.40m 1.000 u 7.38 7.38 5.066 Herramientas y equipos 1.000 ml. 1.46 1.46 98.75 5.050 Piso de Hormigón Frotado. 5.051 Madera de Pino 0.088 p2 45.00 3.96 5.052 Mezcla 1:3 0.020 m3 4,087.52 81.75 5.053 Hormigón F'c = 140 kg/cm2 0.080 m3 3,192.41 255.39 5.054 Piso de hormigón frotado e = 0.08 m 1.000 m2 75.00 75.00 5.055 Cantos en pisos 0.800 ml 20.00 16.00 5.056 Herramientas y equipos 1.000 m2 6.48 6.48 438.58 5.060 Piso de Hormigón estampado. 5.061 Madera de Pino 0.088 p2 45.00 3.96 5.062 Mezcla 1:3 0.020 m3 4,087.52 81.75 5.063 Hormigón F'c = 140 kg/cm2 0.080 m3 3,192.41 255.39 5.064 Piso de hormigón frotado e = 0.08 m 1.000 m2 100.00 100.00 5.065 Acero malla" de 2.3*2.3 a 0.10*0.10m 1.000 m2 100.00 100.00 5.066 Estampado en piso de cemento con color 1.000 m2 200.00 200.00 5.067 Cantos en pisos 0.800 ml 20.00 16.00 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 104
  • 105.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 5.068 Herramientas y equipos 1.000 m2 11.36 11.36 768.46 6.000 Terminación de Escaleras: 6.010 Escalones Revestidos de Porcelanato 6.011 Derretido de cemento blanco 0.025 fda 406.00 10.15 6.012 Escalones de porcelanato. 1.000 ml 300.00 300.00 6.013 Mezcla 1:3 0.007 m3 4,087.52 28.61 6.014 Hormigón F´c=140 kgs/cm2 0.025 m3 3,192.41 79.81 6.015 Confección de escalones revestido de mezcla. 1.000 ml 120.76 120.76 6.016 Montura de escalones en escalera 1.000 ml 132.72 132.72 6.017 Limpieza de escalones 1.000 ml 72.00 72.00 6.018 Herramientas y equipos 1.000 ml. 11.16 11.16 755.21 6.020 Zócalos de porcelanato. 6.021 Derretido de cemento blanco 0.022 fda 406.00 8.93 6.022 Zócalos de porcelanato en escalones. 1.050 u 140.00 147.00 6.023 Mezcla 1:4 0.001 m3 3,454.13 3.45 6.024 Colocación de zócalos para escaleras. 1.000 u 65.86 65.86 6.025 Herramientas y equipos 1.000 ml. 3.38 3.38 228.62 7.000 Enchapes o Revestimientos: 7.010 Cerámica Importada de Pared 0.20x0.30mts.En baños principales y cocinas 7.011 Derretido de cemento blanco. 0.070 fda 406.00 28.42 7.012 Estopa 0.050 lb 52.00 2.60 7.013 Cerámica importada de pared de 0.20*0.30 m. 1.050 m2 350.00 367.50 7.014 Mortero 1:1.5:5 0.022 m3 5,083.09 111.83 7.015 Colocacion de azulejos 1.000 m2 213.26 213.26 7.016 Corte de losetas de cerámica 3.750 u 7.38 27.68 7.017 Herramientas y equipos 1.000 m2 11.27 11.27 762.56 7.020 Cerámica Importada de Pared 0.20x0.30mts.En baños de servicio. 7.021 Derretido de cemento blanco. 0.070 fda 406.00 28.42 7.022 Estopa 0.050 lb 52.00 2.60 7.023 Cerámica importada de pared de 0.20*0.30 m. 1.050 m2 280.00 294.00 7.024 Mortero 1:1.5:5 0.022 m3 5,083.09 111.83 7.025 Colocacion de azulejos 1.000 m2 213.26 213.26 7.026 Corte de losetas de cerámica 3.750 u 7.38 27.68 7.027 Herramientas y equipos 1.000 m2 10.17 10.17 687.96 7.030 Ladrillos de 2" x 4" x 8". 7.031 Ladrillos de 2" x 4" x 8". 50.000 u 20.00 1,000.00 7.032 Aceite de cocina. 0.005 gls 260.00 1.30 7.033 Mezcla 1:3 0.012 m3 4,087.52 49.05 7.034 Estopa. 0.050 lb 52.00 2.60 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 105
  • 106.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 7.035 Corte de ladrillos. 0.071 u 3.50 0.25 7.036 Colocacion de ladrillos limpios a una cara. 50.000 u 6.15 307.50 7.037 Herramientas y equipos. 1.000 m2 20.41 20.41 1,381.11 8.000 Pinturas (Dos Manos): 8.010 Acrílica sobre muros. 8.011 Pintura acrílica preparada. 0.110 gl 430.00 47.30 8.012 Desperdicio y retoque de Pintura. 0.011 gl 430.00 4.73 8.013 Materiales diversos, 1.000 m2 8.63 8.63 8.014 Pintura de agua 1ra mano inc. masilla, lija y piedra. 1.000 m2 16.80 16.80 8.015 Pintura de agua 2da mano. 1.000 m2 10.80 10.80 8.016 Herramientas y equipos 1.000 m2 1.32 1.32 89.58 8.020 Económica en Techos.. 8.021 Pintura econónica. 0.110 gl 270.00 29.70 8.022 Desperdicio y retoque de Pintura. 0.011 gl 270.00 2.97 8.023 Materiales diversos, 1.000 m2 8.63 8.63 8.024 Pintura de agua 1ra mano inc. masilla, lija y piedra. 1.000 m2 16.80 16.80 8.025 Pintura de agua 2da mano. 1.000 m2 10.80 10.80 8.026 Herramientas y equipos 1.000 m2 1.03 1.03 69.93 8.030 Económica Blanco 50 (Una Mano). 8.031 Pintura econónica. 0.055 gl 270.00 14.85 8.032 Desperdicio y retoque de Pintura. 0.006 gl 270.00 1.49 8.033 Materiales diversos, 1.000 m2 8.63 8.63 8.034 Pintura de agua 1ra mano inc. masilla, lija y piedra. 1.000 m2 16.80 16.80 8.035 Herramientas y equipos 1.000 m2 0.63 0.63 42.40 9.000 Terminación de Techos: 9.010 Fino de mezcla en techo plano: 9.011 Madera de pino 0.013 p2 45.00 0.59 9.012 Mezcla 1:3 0.042 m3 4,087.52 171.68 9.013 Fino en techo 1.000 m2 75.86 75.86 9.014 Herramientas y equipos. 1.000 m2 3.72 3.72 251.85 9.020 Fino de mezcla en techo inclinado: 9.021 Madera de pino 0.013 p2 45.00 0.59 9.022 Mezcla 1:3 0.021 m3 4,087.52 85.84 9.023 Fino en techo 1.000 m2 43.62 43.62 9.024 Herramientas y equipos. 1.000 m2 1.95 1.95 132.00 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 106
  • 107.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 9.030 Zabaletas de cemento 9.031 Mezcla 1:3 0.008 m3 4,087.52 32.70 9.032 Zabaletas en techo 1.000 ml 34.24 34.24 9.033 Herramientas y equipos. 1.000 ml 1.00 1.00 67.94 9.040 Teja en techo 9.041 Teja en techo 1.000 m2 620.00 620.00 9.041 Mezcla 1:3 0.008 m3 4,087.52 32.70 9.042 Mano de obra 1.000 m2 250.00 250.00 9.043 Herramientas y equipos. 1.000 ml 4.24 4.24 906.94 9.040 Desagües de Techo f 3" h = 13.00 m. 9.041 Parrilla de 3" 1.000 u 63.80 63.80 9.042 Cemento PVC 0.010 gls 1,102.00 11.02 9.043 Codo de drenaje 3 x 90° 2.000 u 47.56 95.12 9.044 Tubo de drenaje SDR-41 de 3"*20' 2.300 u 545.00 1,253.50 9.045 Instalacion de desagüe pluvial de 3" cuatro nivel. 1.000 u 1,200.00 1,200.00 9.046 Herramientas y equipos. 1.000 u 39.35 39.35 2,662.79 9.050 Antepecho de Muros de Bloques H = 1.00mts: 9.051 Muros de bloque de 0.15 mts 1.000 m2 701.34 701.34 9.052 Pañete liso sobre muros. 2.350 m2 206.57 485.44 9.053 Cantos en general. 2.000 ml 58.30 116.60 9.054 Pintura acrílica. 2.350 m2 89.58 210.51 9.055 Herramientas y equipos 1.000 PA 22.71 22.71 1,536.60 10.000 Varios. 10.010 Verja frontal de Muros de Bloques y hierro H = 2.60 mts: 10.011 Replanteo 165.000 ml 10.00 1,650.00 10.012 Muros de bloque de 0.15 mts 220.000 m2 701.34 154,294.80 10.013 Pañete liso sobre muros. 480.000 m2 206.57 99,153.60 10.014 Cantos en general. 330.000 ml 58.30 19,239.00 10.015 Pintura acrílica. 480.000 m2 89.58 42,998.40 10.016 Zapata de muros 18.560 m3 4,200.00 77,952.00 10.017 Viga de muros 6.600 m3 12,446.19 82,144.85 10.018 Columna de muros 5.040 m3 12,401.08 62,501.44 10.019 Puerta de hierro 6.000 ml 6,400.00 38,400.00 10.01A Puerta de hierro grande 32.000 ml 9,500.00 304,000.00 10.01B Hierro en verja 165.000 m2 1,600.00 264,000.00 10.01C Excavacion 37.130 m3 800.00 29,704.00 10.01D Reposicion 15.000 m3 91.20 1,368.00 10.01E Herramientas y equipos 1.000 PA 4,735.29 4,735.29 1,182,141.38 Costo/ml = 7,164.49 10.020 Acera perimetral incluye zabaleta perimetral.. Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 107
  • 108.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 10.021 Madera de pino 0.220 p2 36.00 7.92 10.022 Mezcla 1:3 0.021 m3 4,087.52 85.84 10.023 Hormigón 140 kg/cm 0.084 m3 3,192.41 268.16 10.024 Cantos 2.000 ml 32.20 64.39 10.025 Zabaleta de piso. 1.000 ml 57.55 57.55 10.026 Construcción de aceras 0.100 m3 354.00 35.40 10.027 Herramientas y equipos 1.000 m2 7.79 7.79 527.05 10.030 Parqueos 10.031 Preparacion de area 1.000 m2 15.00 15.00 10.032 Relleno de 0.20m 0.200 m3 407.02 81.40 10.033 hormigon estampado armado 1.000 m2 700.00 700.00 10.034 Herramientas y equipos 1.000 ml 11.95 11.95 808.35 11.000 Instalación Sanitaria: 11.010 Desagües de piso f 2" 11.011 Parrila de 2" 1.000 u 50.46 50.46 11.012 Adaptador macho de 2" 1.000 u 22.04 22.04 11.013 Sifón de 2" 1.000 u 110.20 110.20 11.014 Cemento PVC 0.014 gls 1,102.00 15.43 11.015 Instalación de desagüe de piso. 1.000 u 300.00 300.00 11.016 Herramientas y equipos 1.000 u 7.47 7.47 505.60 11.020 Columna de Agua Fría f 2 1/2" en un Nivel (H = 2.85 mts). 11.021 Tubo de presión f 2 1/2" 1.000 u 375.00 375.00 11.022 Codos f 2 1/2" 2.000 u 30.00 60.00 11.023 Cemento PVC 0.045 gls 1,102.00 49.59 11.024 Instalación de C. A. F. f 2 1/2" 1.000 u 600.00 600.00 11.025 Herramientas y equipos 1.000 u 16.27 16.27 1,100.86 10.042 Columna de Ventilación f 2" (h = 10 mts). 10.043 Tubo de drenaje f 3" 1.760 u 352.00 619.52 10.044 Yees f 2" 1.000 u 55.00 55.00 10.045 Codos f 2" 2.000 u 60.00 120.00 10.046 Cemento PVC 0.035 gls 1,102.00 38.57 10.047 Instalación de Bajante de Descarga 1.000 u 800.00 800.00 10.048 Herramientas y equipos 1.000 u 24.50 24.50 1,657.59 11.030 Columna de Ventilación f 3" (h = 10 mts). 11.031 Tubo de drenaje f 3" 1.760 u 759.00 1,335.84 11.032 Yees f 3" 1.000 u 82.36 82.36 11.033 Codos f 3" 2.000 u 47.56 95.12 11.034 Cemento PVC 0.035 gls 1,102.00 38.57 11.035 Instalación de Bajante de Descarga 1.000 u 800.00 800.00 11.036 Herramientas y equipos 1.000 u 35.28 35.28 2,387.17 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 108
  • 109.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 11.040 Bajante de Descarga f 4" (h = 10 .00mts). 11.041 Tubo de drenaje f 4" 1.760 u 882.00 1,552.32 11.042 Yees f 4" 1.000 u 142.68 142.68 11.043 Codos f 4" 1.000 u 74.24 74.24 11.044 Cemento PVC 0.045 gls 1,102.00 49.59 11.045 Instalación de Bajante de Descarga 1.000 u 800.00 800.00 11.046 Herramientas y equipos 1.000 u 39.28 39.28 2,658.11 11.050 Tapon de Registro f 4" 11.051 Cemento PVC 0.007 gls 1,102.00 7.71 11.052 Codos f 4" 1.000 u 74.24 74.24 11.053 Tapon de Registro f 4" 1.000 u 116.00 116.00 11.054 Instalacióú de Tapon de Registro f 4" 1.000 u 200.00 200.00 11.055 Herramientas y equipos 1.000 u 7.96 7.96 405.91 11.060 Tapon de Registro f 2" 11.061 Cemento PVC 0.007 gls 1,102.00 7.71 11.062 Codos f 2" 1.000 u 18.21 18.21 11.063 Tapon de Registro f 2" 1.000 u 23.20 23.20 11.064 Instalacióú de Tapon de Registro f 2" 1.000 u 175.00 175.00 11.065 Herramientas y equipos 1.000 u 4.48 4.48 228.60 11.070 Trampa de Grasa de (0.80*0.80*0.75)mts. 11.071 Excavacion 0.600 m3 647.71 388.63 11.072 Bote de material. 0.900 m3 233.74 210.36 11.073 Losa de fondo. 0.080 m3 7,055.30 564.42 11.074 Losa de superior. 0.080 m3 6,423.45 513.88 11.075 Bloques de 0.10 m 2.520 m2 588.93 1,484.10 11.076 Pañete pulido. 3.320 m2 215.99 717.09 11.077 Tuberías y piezas 1.000 pa 1,326.42 1,326.42 4,605.91 11.080 Cámaras de inspección (0.0.50*0.50*0.75) mts. 11.081 Excavacion 0.150 m3 647.71 97.16 11.082 Bote de material. 0.210 m3 233.74 49.08 11.083 Losa de fondo. 0.003 m3 7,055.30 21.17 11.084 Losa de superior. 0.040 m3 6,423.45 256.94 11.085 Bloques de 0.10 m 1.200 m2 588.93 706.72 11.086 Pañete pulido. 1.200 m2 215.99 259.19 11.087 Tuberías y piezas 1.000 pa 300.00 300.00 1,690.26 12.000 Instalación Eléctrica 2 Niveles: 12.010 Salida de Iluminación de Techo ( DP = 41'): 12.011 Caja octagonal americana. 1.000 u 30.00 30.00 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 109
  • 110.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 12.012 Roseta de porcelana. 0.290 u 40.00 11.60 12.013 Tubo de 1/2" PVC SDR-26. 41.000 pl 3.66 150.06 12.014 Curva de 1/2" PVC Reforzada. 1.000 u 3.25 3.25 12.015 Bombillo de 100 Watts. 1.000 u 7.50 7.50 12.016 2C-Alambre THW N° 12. 84.000 pl 6.44 540.96 12.017 Materiales miscelaneos (4% de los materiales). 1.000 PA 29.73 29.73 12.018 Mano de obra. 1.000 PA 312.00 312.00 1,085.10 12.020 Salida de Interruptor Simple (DP = 20'): 12.021 Caja de rectangular 2" * 4" americana. 1.000 u 30.00 30.00 12.022 Interruptor simple levitong 1.000 u 68.00 68.00 12.023 Tubo de 1/2" PVC SDR-26. 20.000 pl 3.66 73.20 12.024 Curva de 1/2" PVC Reforzada. 1.000 u 3.25 3.25 12.025 2C-Alambre THW N° 12. 42.000 pl 6.44 270.48 12.026 Materiales miscelaneos (4% de los materiales). 1.000 PA 17.80 17.80 12.027 Mano de obra. 1.000 PA 312.00 312.00 774.73 12.030 Salida de Interruptor Doble (D = 19'): 12.031 Caja de rectangular 2" * 4" americana. 1.000 u 30.00 30.00 12.032 Interruptor doble levitong 1.000 u 109.00 109.00 12.033 Tubo de 1/2" PVC SDR-26. 19.000 pl 3.66 69.54 12.034 Curva de 1/2" PVC Reforzada. 1.000 u 3.25 3.25 12.035 3C-Alambre THW N° 12. 60.000 pl 6.44 386.40 12.036 Interructor doble 1.000 u 60.00 60.00 12.037 Materiales miscelaneos (4% de los materiales). 1.000 PA 23.93 23.93 12.038 Mano de obra. 1.000 PA 350.00 350.00 1,032.12 12.040 Salida de Interruptor Triple (Dp = 25'): 12.041 Caja de rectangular 2" * 4" americana. 1.000 u 30.00 30.00 12.042 Interruptor triple levitong 1.000 u 80.00 80.00 12.043 Tubo de 1/2" PVC SDR-26. 25.000 pl 3.66 91.50 12.044 Curva de 1/2" PVC Reforzada. 1.000 u 3.25 3.25 12.045 3C-Alambre THW N° 12. 104.000 pl 6.44 669.76 12.046 Interructor triple 1.000 u 180.00 180.00 12.047 Materiales miscelaneos (4% de los materiales). 1.000 PA 34.98 34.98 12.048 Mano de obra. 1.000 PA 364.00 364.00 1,453.49 12.050 Salida de Interruptor Piloto (D = 22'): 12.051 Caja de rectangular 2" * 4" americana. 1.000 u 30.00 30.00 12.052 Interruptor piloto levitong 1.000 u 165.00 165.00 12.053 Tubo de 1/2" PVC SDR-26. 22.000 pl 3.66 80.52 12.054 Curva de 1/2" PVC Reforzada. 1.000 u 3.25 3.25 12.055 2C-Alambre THW N° 12. 46.000 pl 6.44 296.24 12.056 Interructor piloto 1.000 u 300.00 300.00 12.057 Materiales miscelaneos (4% de los materiales). 1.000 PA 23.00 23.00 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 110
  • 111.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 12.058 Mano de obra. 1.000 PA 312.00 312.00 1,210.01 12.060 Salida de Tomacorriente Doble de 110 V (DP = 18'): 12.061 Caja de rectangular 2" * 4" americana. 1.000 u 30.00 30.00 12.062 Tomacorriente a 120 doble levitong. 1.000 u 37.00 37.00 12.063 Tubo de 1/2" PVC SDR-26. 18.000 pl 3.66 65.88 12.064 Curva de 1/2" PVC Reforzada. 2.000 u 3.25 6.50 12.065 2C-Alambre THW N° 12. 38.000 pl 6.44 244.72 12.066 1C-Alambre THW N° 14. 19.000 pl 4.00 76.00 12.067 Tomacorriente a 120 doble levitong. 1.000 u 50.00 50.00 12.068 Materiales miscelaneos (4% de los materiales). 1.000 PA 32.21 32.21 12.069 Mano de obra. 1.000 PA 312.00 312.00 854.31 12.070 Salida de Tomacorriente Simple 15A, 220 V (DP = 22'): 12.071 Caja de rectangular 2" * 4" KO-1/2". 1.000 u 30.00 30.00 12.072 Tubo de 1/2" PVC SDR-26. 22.000 pl 3.66 80.52 12.073 Curva de 1/2" PVC Reforzada. 2.000 u 3.25 6.50 12.074 2C-Alambre THW N° 10. 46.000 pl 9.05 416.30 12.075 1C-Alambre THW N° 12. 23.000 pl 6.44 148.12 12.076 Tomacorriente a 240 doble levitong. 1.000 u 70.00 70.00 12.077 Materiales miscelaneos (4% de los materiales). 1.000 PA 27.26 27.26 12.078 Mano de obra. 1.000 PA 364.00 364.00 1,142.70 12.080 Salida de Tomacorriente Doble de 110 V (DP = 28'): 12.081 Caja de rectangular 2" * 4" americana. 1.000 u 30.00 30.00 12.082 Tomacorriente a 120 doble levitong. 1.000 u 27.00 27.00 12.083 Tubo de 1/2" PVC SDR-26. 28.000 pl 3.66 102.48 12.084 Curva de 1/2" PVC Reforzada. 2.000 u 3.25 6.50 12.085 2C-Alambre THW N° 12. 58.000 pl 6.44 373.52 12.086 1C-Alambre THW N° 14. 29.000 pl 3.89 112.81 12.087 Materiales miscelaneos (4% de los materiales). 1.000 PA 45.66 45.66 12.088 Mano de obra. 1.000 PA 312.00 312.00 1,009.97 12.090 Salida Para Teléfono (DP = 30'): 12.091 Caja de rectangular 2" * 4" americana 3/4". 1.000 u 30.00 30.00 12.092 Tubo de 3/4" PVC SDR-26. 30.000 pl 7.00 210.00 12.093 Curva de 1/2" PVC Reforzada. 2.000 u 4.32 8.64 12.094 Tapa de telefono 1.000 u 50.00 50.00 12.095 Materiales miscelaneos (4% de los materiales). 1.000 PA 9.95 9.95 12.096 Mano de obra. 1.000 PA 310.00 310.00 618.59 12.100 Salida Para Antena TV-C (DP = 35'): 12.101 Caja de rectangular 2" * 4" KO-3/4".(Am.) 1.000 u 30.00 30.00 12.102 Tubo de 3/4" PVC SDR-26. 35.000 pl 7.00 245.00 12.103 Curva de 3/4" PVC Reforzada. 2.000 u 4.32 8.64 12.104 Materiales miscelaneos (4% de los materiales). 1.000 PA 19.85 19.85 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 111
  • 112.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 12.105 Mano de obra. 1.000 PA 310.00 310.00 613.49 12.110 Panel de Distribución L(C-1),GE f 1" 120/208V CAT N° TLM 12 de 90/2 formado Por: 12.111 Panel de Distribución A(P-C1) 1.000 u 1,100.00 1,100.00 12.112 breakers de 20A/1P 3.000 u 200.00 600.00 12.113 breakers de 30A/2P 3.000 u 320.00 960.00 12.114 Materiales miscelaneos (3% de los materiales). 1.000 PA 51.00 51.00 12.115 Mano de obra (44% de los materiales). 1.000 PA 1,192.84 1,192.84 3,903.84 12.120 Alimentador al Panel (C-1): 12.121 2C-THW Nº 4 2.000 pl 27.00 54.00 12.122 1C-THW Nº 6 1.000 pl 17.00 17.00 12.123 1C-THW Nº 8 1.000 pl 13.00 13.00 12.124 Ducto de PVC f 2" SDR-26. 1.000 pl 12.00 12.00 12.125 Materiales miscelaneos (3% de los materiales). 1.000 pl 2.88 2.88 12.126 Mano de obra (39 % de los materiales). 1.000 pl 38.56 38.56 137.44 12.130 Panel de Distribución A(P-C2),GE f 1" 120/240V CAT N° TLM 12 de 70/2 formado Por: 12.131 Panel de Distribución A(P-C2) 1.000 u 1,100.00 1,100.00 12.132 breakers de 20A/1P 2.000 u 200.00 400.00 12.133 breakers de 30A/2P 2.000 u 320.00 640.00 12.134 Materiales miscelaneos (3% de los materiales). 1.000 PA 45.00 45.00 12.135 Mano de obra (44% de los materiales). 1.000 PA 961.40 961.40 3,146.40 12.140 Alimentador al Panel (P-C2): 12.141 2C-THW Nº 6 2.000 pl 17.00 34.00 12.142 1C-THW Nº 8 1.000 pl 13.00 13.00 12.143 1C-THW Nº 10 1.000 pl 9.05 9.05 12.144 Ducto de PVC f 2" SDR-26. 1.000 pl 12.00 12.00 12.145 Materiales miscelaneos (3% de los materiales). 1.000 pl 2.04 2.04 12.146 Mano de obra (39 % de los materiales). 1.000 pl 27.34 27.34 97.43 13.000 Escalera Común: 13.010 Salida de Iluminación de Techo ( DP = 22'): 13.011 Caja octagonal americana. 1.000 u 30.00 30.00 13.012 Roseta de porcelana. 1.000 u 40.00 40.00 13.013 Tubo de 1/2" PVC SDR-26. 22.000 pl 3.66 80.52 13.014 Curva de 1/2" PVC Reforzada. 1.000 u 3.25 3.25 13.015 Bombillo de 100 Watts. 1.000 u 7.50 7.50 13.016 2C-Alambre THW N° 12. 46.000 pl 6.44 296.24 13.017 Materiales miscelaneos (4% de los materiales). 1.000 PA 18.30 18.30 13.018 Mano de obra. 1.000 PA 321.00 321.00 796.81 13.020 Salida de Interruptor Tres Vias (D = 18'): Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 112
  • 113.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 13.011 Caja de rectangular 2" * 4" americana. 1.000 u 30.00 30.00 13.012 Interruptor tres vías levitong 1.000 u 110.00 110.00 13.013 Tubo de 1/2" PVC SDR-26. 18.000 pl 3.66 65.88 13.014 Curva de 1/2" PVC Reforzada. 1.000 u 3.25 3.25 13.015 3C-Alambre THW N° 12. 57.000 pl 6.44 367.08 13.016 Materiales miscelaneos (4% de los materiales). 1.000 PA 23.05 23.05 13.017 Mano de obra. 1.000 PA 350.00 350.00 949.26 13.030 Salida de Interruptor Cuatro Vìas (D = 18'): 13.031 Caja de rectangular 2" * 4" americana. 1.000 u 30.00 30.00 13.032 Interruptor cuatro vías levitong 1.000 u 160.00 160.00 13.033 Tubo de 1/2" PVC SDR-26. 18.000 pl 3.66 65.88 13.034 Curva de 1/2" PVC Reforzada. 1.000 u 3.25 3.25 13.035 4C-Alambre THW N° 12. 76.000 pl 6.44 489.44 13.036 Materiales miscelaneos (4% de los materiales). 1.000 PA 29.94 29.94 13.037 Mano de obra. 1.000 PA 371.00 371.00 1,149.51 13.040 Salida Para Motor de Bomba (DP = 59'): 13.041 Caja de rectangular 2" * 4" KO-13/4". 1.000 u 60.00 60.00 13.042 Tubo de 1/2" PVC SDR-26. 59.000 pl 4.53 267.27 13.043 Curva de 1/2" PVC Reforzada. 2.000 u 6.00 12.00 13.044 2C-Alambre THW N° 10. 120.000 pl 9.05 1,086.00 13.045 1C-Alambre THW N° 12. 60.000 pl 6.44 386.40 13.046 Materiales miscelaneos (4% de los materiales). 1.000 PA 72.47 72.47 13.047 Mano de obra. 1.000 PA 350.00 350.00 2,234.14 13.050 Salida Para Puera Eléctrica (DP = 70'): 13.051 Caja rectangular 2" * 4" KO-3/4". 1.000 u 60.00 60.00 13.052 Tubo de 3/4" PVC SDR-26. 70.000 pl 4.53 317.10 13.053 Curva de 3/4" PVC Reforzada. 2.000 u 6.00 12.00 13.054 2C-Alambre THW N° 12. 142.000 pl 6.44 914.48 13.055 Materiales miscelaneos (4% de los materiales). 1.000 PA 52.14 52.14 13.056 Mano de obra. 1.000 PA 310.00 310.00 1,665.72 13.060 Alimentador al Modulo de contador: 0.001 9C-THW Nº 3/0 9.000 pl 90.00 810.00 13.061 2C-THW Nº 3/0 2.000 pl 90.00 180.00 13.062 2C-THW Nº 1/0 2.000 pl 120.00 240.00 13.063 Ducto de PVC f 1-3" SDR-26. 1.000 pl 40.00 40.00 13.064 Materiales miscelaneos (3% de los materiales). 1.000 pl 13.80 13.80 13.065 Mano de obra (39 % de los materiales). 1.000 pl 184.78 184.78 658.58 13.070 Panel de Distribución (P-S),GE f 1" 120/240V CAT N° TLM 712 formado Por: 13.071 Panel de Distribución C(P-S) 1.000 u 3,600.00 3,600.00 13.072 breakers de 20A/1P 12.000 u 200.00 2,400.00 13.073 breakers de 30A/2P 1.000 u 340.00 340.00 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 113
  • 114.
    SANTO DOMINGO, D.N. (ANÁLISIS DE COSTOS) N° PARTIDAS CANTIDAD U P. U. VALOR SUB-TOTAL 13.074 Materiales miscelaneos (3% de los materiales). 1.000 PA 190.20 190.20 13.075 Mano de obra (44% de los materiales). 1.000 PA 2,873.29 2,873.29 9,403.49 13.080 Alimentador al Panel (P-S): 13.081 2C-THW Nº 6 2.000 pl 17.00 34.00 13.082 1C-THW Nº 8 1.000 pl 13.00 13.00 13.083 1C-THW Nº 10 1.000 pl 9.05 9.05 13.084 Ducto de PVC f 2" SDR-26. 1.000 pl 19.84 19.84 13.085 Materiales miscelaneos (3% de los materiales). 1.000 pl 2.28 2.28 13.086 Mano de obra (25 % de los materiales). 1.000 pl 19.54 19.54 97.71 Nmbre del Archivo: PROYECTO VIVIENDA ECONOMICA 114
  • 115.
    EFN-CONSTRUCTION CONSTRUCCION, SUPERVISION. PRESUPUESTO PARACONSTRUCCION DE CASA ( 62,0 MT2 ) N° PARTIDAS CANTIDAD U.D P. U. VALOR SUB-TOTAL 1.000 TRABAJOS PRELIMINARES 1.010 Replanteos casa ( incluye madera y pago a maestro ) 62.00 M² 65.00 4,030.00 1.020 Conexiones temporales o facilidades de agua y energía eléctrica para áreas de construcción y campamento personal 1.00 PA 1,500.00 1,500.00 1.030 Habilitar área almacén materiales 1.00 PA 6,000.00 6,000.00 11,530.00RD$ 2.000 MOVIMIENTO DE TIERRAS 2.010 Zapatas muros bloques 6´´ 17.45 M3 400.00 6,978.40 2.020 Zapatas muros bloques 4´´ 0.56 M3 400.00 224.00 2.020 Zapatas columnas ( 1,0 x 1,0 ) mts 3.20 M3 400.00 1,280.00 2.030 Relleno compactado interior casa material seleccionado 24.80 M3 480.00 11,904.00 2.040 Relleno de reposicion interior casa material excavado 10.32 M3 180.00 1,857.60 22,244.00RD$ 3.000 HORMIGON ARMADO EN ESTRUCTURAS DE : 3.100 ZAPATA DE MUROS 3.110 Zapatas muros 6" =3 Ø 3/8" con cangrejos @ 0.25 m. 8.32 M3 8,159.69 67,888.62 3.120 Zapatas muros 4" =3 Ø 3/8" con cangrejos @ 0.25 m. 0.34 M3 8,385.02 2,850.91 3.130 Zapatas columnas =6 Ø 3/8" con S= @ 0.20 m. 1.00 M3 7,231.14 7,231.14 3.200 COLUMNAS DE CARGAS 3.210 C1, primer nivel = 6 Ø 3/8" con estribos @ 0.20 m. 0.43 M3 25,702.65 11,103.54 3.300 VIGAS DE CARGAS Y DINTLES 3.310 Vigas de cargas en primer nivel = 3 Ø 1/2" + 2 Ø 3/8"con estribos @ 0.20 m. 1.20 M3 14,833.62 17,800.34 3.320 Vigas perimetral nivel de piso = 4 Ø 3/8" con estribos @ 0.20 m. 1.34 M3 18,486.83 24,846.30 3.330 Viga dintel 4 Ø 3/8" con estribos @ 0.20 m. 0.63 M3 18,486.83 11,646.70 3.400 LOSA DE ENTREPISO Y TECHO 3.410 Losa de Hormigon Armado de H= 0.12m con Fc= 210kg/cm2 incluye vuelo 7.84 M3 12,429.40 97,446.50 240,814.05RD$ 4.000 MAMPOSTERIA 4.100 Block 15 cms. con acero vertical=Ø 3/8" @ 0.80 m. 4.110 1er nivel BNP 29.10 M² 850.00 24,735.00 4.120 1er nivel SNP 99.01 M² 786.65 77,886.03 4.130 Antepecho 6.54 M² 820.00 5,362.80 4.200 Block 10 cms. con acero vertical=Ø 3/8" @ 0.80 m. 4.210 BNP 1.36 M² 742.23 1,009.43 4.220 1er nivel SNP 14.03 M² 761.00 10,676.83 119,670.09RD$ 5.000 TERMINACIÓN DE SUPERFICIES 5.100 Fraguache de superficies hormigones 5.110 1er nivel exterior 79.02 M² 25.00 1,975.50 5.120 1er nivel interior 163.02 M² 25.00 4,075.50 5.130 Techo 62 + techo galeria 63.40 M² 25.00 1,585.00 5.140 Antepecho 6.54 M² 25.00 163.50 5.200 Pañete liso en muros de bloques en General 5.210 1er nivel exterior 79.02 M² 234.55 18,534.14 5.220 1er nivel interior 163.02 M² 199.09 32,456.32 5.230 En techo 63.40 M² 214.23 13,582.18 5.240 Antepecho 6.54 M² 214.23 1,401.06 5.250 Mocheta en general en puertas y ventanas y muros 46.50 ML 92.25 4,289.63 5.260 Cantos en general, incluye vuelo perímetral 93.00 ML 46.10 4,287.30 82,350.13RD$ 6.000 TERMINACION DE TECHOS 6.010 Fino de techo en losas planas 62.00 M² 329.02 20,399.40 6.020 Zabaletas en general en losas 37.15 ML 120.00 4,458.00 6.030 Impermebilizante acrilico dos manos 62.00 M² 175.00 10,850.00 35,707.40RD$ 7.000 TERMINACION DE PISOS 7.010 Torta de piso 64.00 M² 147.00 9,408.00 7.020 1er nivel porcelanato 56.50 M² 868.53 49,071.95 7.030 Zocalos en porcelanato 52.30 ml 178.68 9,344.96 7.040 Pisos baños primer nivel 5.80 M² 645.20 3,742.16 71,567.07RD$ 8.000 REVESTIMIENTO CERAMICA EN PAREDES COCINA Y BAÑOS 8.100 BAÑOS 8.110 1er nivel 20.48 M² 460.00 9,420.80 8.200 COCINA 8.210 1er nivel 1.74 M² 465.00 809.10 10,229.90RD$ 9.000 INSTALACION SANITARIA DOS NIVELES 9.010 Suministro e instalacion de inodoros 2.00 uds 3,750.00 7,500.00 9.020 Suministro e instalacion cortina de cristal bañera 2.00 uds 8,000.00 16,000.00 9.030 Suministro e instalacion de Lavamanos 2.00 uds 2,250.00 4,500.00 9.040 Suminiostro e instalacion de Fragadero sencillo 1.00 uds 1,750.00 1,750.00 9.050 Suministro e instalacion de Duchas mezcladora en baños 2.00 uds 4,250.00 8,500.00 9.060 Suministro e instalacion de Duchas mezcladora en Fragadero 1.00 uds 1,240.00 1,240.00 9.070 Suminisrtro e instalacion de tubeerias de arrastre de 2" interior desague de fondo 2.00 pa 1,500.00 3,000.00 9.080 Suminisrtro e instalacion tanque agua potable de 200 galones 1.00 pa 2,500.00 2,500.00 9.090 Suminisrtro e instalacion de tubeerias de arrastre de 4" exterior descarga baños 1.00 pa 2,500.00 2,500.00 9.100 Construcion de registro sanitario 1.00 uds 1,200.00 1,200.00 9.110 Construcion de registro trampa de grasa 1.00 uds 1,500.00 1,500.00 50,190.00RD$ 10.000 COCINA 10.010 Gabinetes de piso 3.28 PL 1,200.00 3,936.00
