El documento presenta la normatividad vigente para la liquidación de obras públicas en Perú. Explica que las obras deben ejecutarse mediante contratación y licitación pública de acuerdo con la Constitución peruana y otras leyes. También describe los diferentes sistemas de contratación, los roles de residente, inspector y coordinador de obra, y el proceso de preliquidación, recepción y liquidación final de una obra.
Construction Scheduling, Work Study and Work Measurement _ Unit 2 _ Construct...Shrikant Kate
Construction Scheduling, Work Study and Work Measurement _ Unit 2 _ Construction Management _ Final Year (BE) _ Department of Civil Engineering _ TAE _ SPPU _ by Shrikant R. Kate
Construction scheduling, work study and work measurement Construction scheduling.
Construction project scheduling – purpose, factors affecting scheduling, time as a control tool
Work Breakdown Structure, project work breakdown levels, line of balance technique
Repetitive project management Work study and work measurement
Definition, objectives, basic procedure of work study, symbols, activity charts, string diagrams, time and motion studies.
The document provides information on construction project planning and scheduling using the Critical Path Method (CPM). It discusses preliminary and detailed planning, developing activity lists, and using different types of planning diagrams including Gantt charts, PERT charts, and logic diagrams. The Critical Path Method (CPM) uses logic diagrams and precedence relationships between activities to develop an accurate schedule for a construction project from start to finish.
Este documento presenta las especificaciones técnicas para la creación de un tanque séptico y pozo percolador para la comunidad campesina de Ayaranga en el distrito de Paccho, provincia de Huaura, departamento de Lima. Incluye detalles sobre los materiales, la mano de obra, las pruebas requeridas y los procedimientos de construcción para el sistema de saneamiento. También especifica los requisitos para la limpieza y desbroce del terreno, la excavación, y la instalación de tuberías y otros componentes necesarios para el
Este documento contiene información sobre el proceso de liquidación de contratos de obras públicas en Perú. En 3 oraciones:
1) Explica que el contratista debe presentar la liquidación dentro de los 60 días posteriores a la recepción de la obra, incluyendo cálculos y documentación detallados.
2) La entidad tiene 60 días para aprobar u observar la liquidación presentada y el contratista 15 días para pronunciarse sobre observaciones.
3) Se describe el proceso para resolver discrepancias en la liquidación, que incluye conciliación y
We are an independent firm of Project Managers and Quantity Surveyors based in Preston, UK that has 60 years of combined experience in client negotiation. We offer a range of services including project management, quantity surveying, employers agency, commercial consultancy, and CDM coordination. As a Quantity Surveyor, some of our key responsibilities include measuring quantities of construction materials, preparing bills of quantities and schedules, cost planning, and ensuring projects are delivered on budget.
An introduction to taking off building quantities Arshad Mohanut
This document provides an introduction to taking off building quantities according to an Irish approach. It discusses the process of measurement and quantification, which involves accurately describing building components and determining their quantities. Dimension paper is introduced as a traditional tool for recording measurements in a standardized format. The key components and uses of dimension paper are described. The document then demonstrates how to enter various types of measurements, such as numbers, lengths, areas and volumes, onto dimension paper according to standard measurement methods. The goal is to lead the reader step-by-step through the handwritten measurement process.
Resolución de contraloría n° 195 88—cg - obras x administracion directaArchitect
La resolución establece 12 normas para regular la ejecución de obras públicas por administración directa. Las normas requieren que las entidades tengan asignación presupuestaria, personal y equipos para ejecutar obras, y que los convenios precisen la capacidad operativa de la entidad ejecutora. También se requiere un expediente técnico aprobado con planos, especificaciones y presupuesto antes de iniciar las obras.
Este documento presenta un cuaderno de obra tipo para registrar los eventos clave que ocurren durante la ejecución de proyectos de infraestructura. Explica que el cuaderno de obra es un documento oficial requerido por ley que debe ser llenado por el residente de obra y supervisor. Además, destaca las diferencias en el procedimiento de llenado de cuadernos de obra para proyectos bajo contrato versus administración directa, e incluye detalles sobre el contenido que debe registrarse al inicio y durante la ejecución de una obra.
Construction Scheduling, Work Study and Work Measurement _ Unit 2 _ Construct...Shrikant Kate
Construction Scheduling, Work Study and Work Measurement _ Unit 2 _ Construction Management _ Final Year (BE) _ Department of Civil Engineering _ TAE _ SPPU _ by Shrikant R. Kate
Construction scheduling, work study and work measurement Construction scheduling.
Construction project scheduling – purpose, factors affecting scheduling, time as a control tool
Work Breakdown Structure, project work breakdown levels, line of balance technique
Repetitive project management Work study and work measurement
Definition, objectives, basic procedure of work study, symbols, activity charts, string diagrams, time and motion studies.
The document provides information on construction project planning and scheduling using the Critical Path Method (CPM). It discusses preliminary and detailed planning, developing activity lists, and using different types of planning diagrams including Gantt charts, PERT charts, and logic diagrams. The Critical Path Method (CPM) uses logic diagrams and precedence relationships between activities to develop an accurate schedule for a construction project from start to finish.
Este documento presenta las especificaciones técnicas para la creación de un tanque séptico y pozo percolador para la comunidad campesina de Ayaranga en el distrito de Paccho, provincia de Huaura, departamento de Lima. Incluye detalles sobre los materiales, la mano de obra, las pruebas requeridas y los procedimientos de construcción para el sistema de saneamiento. También especifica los requisitos para la limpieza y desbroce del terreno, la excavación, y la instalación de tuberías y otros componentes necesarios para el
Este documento contiene información sobre el proceso de liquidación de contratos de obras públicas en Perú. En 3 oraciones:
1) Explica que el contratista debe presentar la liquidación dentro de los 60 días posteriores a la recepción de la obra, incluyendo cálculos y documentación detallados.
2) La entidad tiene 60 días para aprobar u observar la liquidación presentada y el contratista 15 días para pronunciarse sobre observaciones.
3) Se describe el proceso para resolver discrepancias en la liquidación, que incluye conciliación y
We are an independent firm of Project Managers and Quantity Surveyors based in Preston, UK that has 60 years of combined experience in client negotiation. We offer a range of services including project management, quantity surveying, employers agency, commercial consultancy, and CDM coordination. As a Quantity Surveyor, some of our key responsibilities include measuring quantities of construction materials, preparing bills of quantities and schedules, cost planning, and ensuring projects are delivered on budget.
An introduction to taking off building quantities Arshad Mohanut
This document provides an introduction to taking off building quantities according to an Irish approach. It discusses the process of measurement and quantification, which involves accurately describing building components and determining their quantities. Dimension paper is introduced as a traditional tool for recording measurements in a standardized format. The key components and uses of dimension paper are described. The document then demonstrates how to enter various types of measurements, such as numbers, lengths, areas and volumes, onto dimension paper according to standard measurement methods. The goal is to lead the reader step-by-step through the handwritten measurement process.
Resolución de contraloría n° 195 88—cg - obras x administracion directaArchitect
La resolución establece 12 normas para regular la ejecución de obras públicas por administración directa. Las normas requieren que las entidades tengan asignación presupuestaria, personal y equipos para ejecutar obras, y que los convenios precisen la capacidad operativa de la entidad ejecutora. También se requiere un expediente técnico aprobado con planos, especificaciones y presupuesto antes de iniciar las obras.
Este documento presenta un cuaderno de obra tipo para registrar los eventos clave que ocurren durante la ejecución de proyectos de infraestructura. Explica que el cuaderno de obra es un documento oficial requerido por ley que debe ser llenado por el residente de obra y supervisor. Además, destaca las diferencias en el procedimiento de llenado de cuadernos de obra para proyectos bajo contrato versus administración directa, e incluye detalles sobre el contenido que debe registrarse al inicio y durante la ejecución de una obra.
Este documento presenta el flujo del trámite y pago de un adicional de obra, incluyendo la anotación de la necesidad, la presentación del expediente técnico por el contratista, la aprobación por la entidad, y la ampliación de la garantía. También describe el contenido requerido en el expediente técnico de un adicional como la memoria descriptiva, planillas de metrados, presupuesto, cronograma, y planos. Finalmente, detalla el proceso de valorización de un adicional para el pago incluyendo la presentación
El documento describe el procedimiento para la liquidación de obras realizadas por administración directa por los gobiernos locales. Se requiere presentar documentos como el acta de recepción, liquidación técnica y financiera, resoluciones, estados financieros, entre otros. Se conforma una comisión que realiza la recepción física de la obra y la liquidación. El proyecto presenta informes finales y la documentación requerida. La comisión verifica y aprueba la liquidación en un plazo de 30 días.
Este documento describe las actividades de mantenimiento rutinario que deben realizarse en caminos vecinales o rurales por parte de los gobiernos locales. Detalla 16 actividades priorizadas como limpieza de calzada, bacheo, desquinche, entre otras, con sus respectivas descripciones, mediciones, rendimientos y tolerancias. También incluye subactividades como transporte de materiales y registro de tráfico y precipitaciones, además de indicar penalidades por incumplimientos durante los trabajos.
Quantity surveyors provide cost management services throughout construction projects. They estimate costs, prepare bills of quantities, and advise clients on procurement and contractual methods. The Quantity Surveyor Certified Board regulates the profession and consists of a president, registrar, secretary, and 16 members appointed by the Ministry of Works. Quantity surveyors' responsibilities include cost planning, estimating, tendering, and certifying payments during construction stages. They help control costs, resolve disputes, and ensure projects are delivered within budget.
Chapter 8 introduction to construction equipmentsKHUSHBU SHAH
The document discusses the importance of construction equipment for major construction projects. It states that construction equipment accounts for 25-40% of total project costs and discusses factors for selecting equipment such as operating costs, availability of spare parts, and suitability for future projects. It also covers types of equipment, methods of financing purchases versus renting, and factors that influence the cost of owning and operating equipment.
The document discusses road construction technology and processes. It covers:
1. The main phases of road construction including earthwork, pavement construction, and protection works.
2. The various activities and equipment used in road construction like excavation, drainage works, protection works, and pavement works. Equipment include dozers, rollers, pavers and more.
3. Methods of soil stabilization for road construction including mechanical stabilization, soil-cement stabilization, soil-lime stabilization and soil-bitumen stabilization. Factors affecting stabilization and construction procedures are also covered.
El documento proporciona pautas para realizar una liquidación de oficio de proyectos de infraestructura cuando no existe suficiente documentación técnica o financiera. Explica que una comisión debe ser designada para realizar la liquidación y seleccionar peritos que emitan informes periciales técnicos y financieros. La comisión luego elabora un informe de liquidación para su aprobación, y se realizan los registros contables y patrimoniales correspondientes para transferir el proyecto a su área operativa.
Este documento proporciona instrucciones en 3 pasos para georreferenciar un mapa de satélite en AutoCAD. Primero, se inicia sesión en Autodesk 360 y se abre el archivo de AutoCAD. Luego, se ejecuta el comando GEO para localizar un punto en el mapa usando un archivo KML previamente exportado de Google Earth. Finalmente, se selecciona el punto correspondiente en el archivo de AutoCAD para georreferenciarlo.
Este documento describe el proceso de valorización de obras públicas en Perú. Explica que la valorización cuantifica el avance físico de la obra en un período determinado para calcular el monto que corresponde pagar al contratista. Detalla los procedimientos de valorización según los sistemas de contratación de precios unitarios y suma alzada, así como el esquema mixto. Además, especifica los plazos para la aprobación y pago de las valorizaciones y los casos en que la entidad puede objetar una valorización.
Este documento presenta información sobre el diseño geométrico de carreteras. En 3 oraciones o menos:
El documento introduce los conceptos clave del diseño geométrico de carreteras, incluyendo los elementos físicos de la vía, las condiciones de operación de los vehículos, y las características del terreno. También describe factores como alineamientos horizontales y verticales, secciones transversales, vehículos de diseño, giros de vehículos, clasificación de carreteras, y representación del terreno. El diseño
El documento proporciona información sobre el Libro de Obras, un documento clave en la gestión, monitoreo y supervisión de proyectos de construcción. De acuerdo a la ley, es responsabilidad del constructor mantener actualizado el Libro de Obras, el cual debe contener detalles sobre avances, problemas, observaciones y otros asuntos relevantes que surjan durante la ejecución del proyecto. El Libro de Obras sirve para transparentar los procesos y como respaldo en caso de fallas o reclamos posteriores.
The document describes a transport management system called Transport Plus. It has four main sections:
1. It introduces the system and describes its four types of users: administrator, approver, transport, and guest.
2. It outlines the system analysis process and modules including employee information, transport categories/routes, and requests.
3. It covers the system design including user functions, application design diagrams, use case diagram, and key tables to store employee, vehicle, route, and request data.
4. It identifies the advantages of the proposed system such as easy reporting and historical data management over the existing manual process.
Este documento describe los adicionales de obra, que son prestaciones no previstas originalmente que resultan indispensables para completar la obra. Explica que existen adicionales menores al 15% del monto original, que requieren aprobación de la entidad, y adicionales entre 15-50%, que también necesitan aprobación de la Contraloría. Si un adicional supera 50% del monto original, el contrato debe resolverse y convocarse a un nuevo proceso de selección.
Este documento presenta las especificaciones técnicas para la construcción de un muro de contención en la Institución Educativa N° 84251 en Rajrajpa, Perú. Detalla los requisitos para el personal, materiales, construcción, tolerancias, mediciones y pagos. El residente de obra será responsable de ejecutar el proyecto de acuerdo a los planos y especificaciones, nombrando personal calificado y asegurando la disponibilidad de maquinaria, herramientas y materiales de alta calidad. Cualquier cambio al diseño requ
Construction material management_Construction Management (2180611) (Semester-...A Makwana
This document outlines material management functions for construction projects. It discusses inventory management and economic order quantity models. It covers topics like job layout, material planning, procurement, storage, transportation, and disposal. The objectives of material management are to minimize costs, ensure quality and availability of materials, and reduce waste. Inventory policies aim to absorb uncertainties in demand and supply.
El documento describe los procedimientos de valorización de obras de construcción, incluyendo la elaboración de valorizaciones, aprobación, pago y tipos de valorizaciones. También cubre temas como reajustes de precios, liquidación de obras, ampliación de plazos y solución de controversias.
El documento presenta información sobre la programación de obras, incluyendo diagramas de Gantt, métodos de ruta crítica como CPM y PERT, y holguras en la programación. También incluye los nombres de los integrantes del proyecto y su docente a cargo. Finalmente, detalla los contenidos que serán tratados como introducción, procesos administrativos, técnicas de programación y aplicaciones a proyectos.
El documento presenta la liquidación técnica y financiera de la obra de mejoramiento del sistema de agua potable y alcantarillado en Santa Bárbara de Carhuacayan. Se describe el proyecto, los objetivos, alcances, presupuesto base, revisión del expediente técnico, verificación de los trabajos ejecutados y su cumplimiento de metas. La obra cumplió con un 118.16% de los trabajos previstos originalmente.
Construction Project Management is an important subject to learn in Civil Engineering.
Significance • As construction involves various activities starting from the design and planning to project completion and quality check, there is a exorbitant need for Management of construction. • Construction Industry plays a crucial role in the economy and development of a nation.
4. Objectives To complete the project in specified time and with allocated budget. To Plan and schedule the work and distribute between various departments. Deployment of personnel in Different tasks. To achieve High quality workmanship. Creating an organisation that works as a team. Using the limited available resources and producing maximum output. Providing safe and satisfactory working conditions for all personnel and workers.
5. Functions: Planning & Scheduling Organizing Staffing Directing Controlling & Co-ordinating
6. Stages of construction Briefing Designing Tendering Construction Commissioning
7. 1) Briefing Stage • This stage consists of framework required for the construction work to take a shape from the ideology of client and feasibility of Project which involves architects, engineers and project manager.
Objectives Developing Alternatives Feasible Solution ? Evaluation of Alternatives Report & Recommendation Technical and non technical Investigations
8. 2) Designing or planning Stage Prepare construction schedule Prepare final cost estimate Prepare Working Drawings and specificati ons Prepare scheme and detailed designs Soil investigations, Topographic investigation, material supply and market surveys etc Carry out Technical Investigations Final adoption of the most suitable summary Finalize Project Summary
Este documento establece 12 normas que regulan la ejecución de obras públicas por administración directa. Las normas requieren que las entidades cuenten con presupuesto, personal y equipos para ejecutar obras, y que los convenios precisen la capacidad operativa. También establecen que se debe contar con un expediente técnico aprobado, demostrar que el costo es igual o menor al presupuesto, llevar un cuaderno de obra, designar supervisores e ingenieros, y realizar liquidaciones técnicas y financieras dentro de los
Este documento presenta información sobre la administración directa de obras públicas, incluyendo normativa, roles y responsabilidades, procesos de aprobación, ejecución, recepción y liquidación de obras. Se explican conceptos como presupuesto, crédito presupuestario y ejecución presupuestaria en el contexto de obras públicas.
Este documento presenta el flujo del trámite y pago de un adicional de obra, incluyendo la anotación de la necesidad, la presentación del expediente técnico por el contratista, la aprobación por la entidad, y la ampliación de la garantía. También describe el contenido requerido en el expediente técnico de un adicional como la memoria descriptiva, planillas de metrados, presupuesto, cronograma, y planos. Finalmente, detalla el proceso de valorización de un adicional para el pago incluyendo la presentación
El documento describe el procedimiento para la liquidación de obras realizadas por administración directa por los gobiernos locales. Se requiere presentar documentos como el acta de recepción, liquidación técnica y financiera, resoluciones, estados financieros, entre otros. Se conforma una comisión que realiza la recepción física de la obra y la liquidación. El proyecto presenta informes finales y la documentación requerida. La comisión verifica y aprueba la liquidación en un plazo de 30 días.
Este documento describe las actividades de mantenimiento rutinario que deben realizarse en caminos vecinales o rurales por parte de los gobiernos locales. Detalla 16 actividades priorizadas como limpieza de calzada, bacheo, desquinche, entre otras, con sus respectivas descripciones, mediciones, rendimientos y tolerancias. También incluye subactividades como transporte de materiales y registro de tráfico y precipitaciones, además de indicar penalidades por incumplimientos durante los trabajos.
Quantity surveyors provide cost management services throughout construction projects. They estimate costs, prepare bills of quantities, and advise clients on procurement and contractual methods. The Quantity Surveyor Certified Board regulates the profession and consists of a president, registrar, secretary, and 16 members appointed by the Ministry of Works. Quantity surveyors' responsibilities include cost planning, estimating, tendering, and certifying payments during construction stages. They help control costs, resolve disputes, and ensure projects are delivered within budget.
Chapter 8 introduction to construction equipmentsKHUSHBU SHAH
The document discusses the importance of construction equipment for major construction projects. It states that construction equipment accounts for 25-40% of total project costs and discusses factors for selecting equipment such as operating costs, availability of spare parts, and suitability for future projects. It also covers types of equipment, methods of financing purchases versus renting, and factors that influence the cost of owning and operating equipment.
The document discusses road construction technology and processes. It covers:
1. The main phases of road construction including earthwork, pavement construction, and protection works.
2. The various activities and equipment used in road construction like excavation, drainage works, protection works, and pavement works. Equipment include dozers, rollers, pavers and more.
3. Methods of soil stabilization for road construction including mechanical stabilization, soil-cement stabilization, soil-lime stabilization and soil-bitumen stabilization. Factors affecting stabilization and construction procedures are also covered.
El documento proporciona pautas para realizar una liquidación de oficio de proyectos de infraestructura cuando no existe suficiente documentación técnica o financiera. Explica que una comisión debe ser designada para realizar la liquidación y seleccionar peritos que emitan informes periciales técnicos y financieros. La comisión luego elabora un informe de liquidación para su aprobación, y se realizan los registros contables y patrimoniales correspondientes para transferir el proyecto a su área operativa.
Este documento proporciona instrucciones en 3 pasos para georreferenciar un mapa de satélite en AutoCAD. Primero, se inicia sesión en Autodesk 360 y se abre el archivo de AutoCAD. Luego, se ejecuta el comando GEO para localizar un punto en el mapa usando un archivo KML previamente exportado de Google Earth. Finalmente, se selecciona el punto correspondiente en el archivo de AutoCAD para georreferenciarlo.
Este documento describe el proceso de valorización de obras públicas en Perú. Explica que la valorización cuantifica el avance físico de la obra en un período determinado para calcular el monto que corresponde pagar al contratista. Detalla los procedimientos de valorización según los sistemas de contratación de precios unitarios y suma alzada, así como el esquema mixto. Además, especifica los plazos para la aprobación y pago de las valorizaciones y los casos en que la entidad puede objetar una valorización.
Este documento presenta información sobre el diseño geométrico de carreteras. En 3 oraciones o menos:
El documento introduce los conceptos clave del diseño geométrico de carreteras, incluyendo los elementos físicos de la vía, las condiciones de operación de los vehículos, y las características del terreno. También describe factores como alineamientos horizontales y verticales, secciones transversales, vehículos de diseño, giros de vehículos, clasificación de carreteras, y representación del terreno. El diseño
El documento proporciona información sobre el Libro de Obras, un documento clave en la gestión, monitoreo y supervisión de proyectos de construcción. De acuerdo a la ley, es responsabilidad del constructor mantener actualizado el Libro de Obras, el cual debe contener detalles sobre avances, problemas, observaciones y otros asuntos relevantes que surjan durante la ejecución del proyecto. El Libro de Obras sirve para transparentar los procesos y como respaldo en caso de fallas o reclamos posteriores.
The document describes a transport management system called Transport Plus. It has four main sections:
1. It introduces the system and describes its four types of users: administrator, approver, transport, and guest.
2. It outlines the system analysis process and modules including employee information, transport categories/routes, and requests.
3. It covers the system design including user functions, application design diagrams, use case diagram, and key tables to store employee, vehicle, route, and request data.
4. It identifies the advantages of the proposed system such as easy reporting and historical data management over the existing manual process.
Este documento describe los adicionales de obra, que son prestaciones no previstas originalmente que resultan indispensables para completar la obra. Explica que existen adicionales menores al 15% del monto original, que requieren aprobación de la entidad, y adicionales entre 15-50%, que también necesitan aprobación de la Contraloría. Si un adicional supera 50% del monto original, el contrato debe resolverse y convocarse a un nuevo proceso de selección.
Este documento presenta las especificaciones técnicas para la construcción de un muro de contención en la Institución Educativa N° 84251 en Rajrajpa, Perú. Detalla los requisitos para el personal, materiales, construcción, tolerancias, mediciones y pagos. El residente de obra será responsable de ejecutar el proyecto de acuerdo a los planos y especificaciones, nombrando personal calificado y asegurando la disponibilidad de maquinaria, herramientas y materiales de alta calidad. Cualquier cambio al diseño requ
Construction material management_Construction Management (2180611) (Semester-...A Makwana
This document outlines material management functions for construction projects. It discusses inventory management and economic order quantity models. It covers topics like job layout, material planning, procurement, storage, transportation, and disposal. The objectives of material management are to minimize costs, ensure quality and availability of materials, and reduce waste. Inventory policies aim to absorb uncertainties in demand and supply.
El documento describe los procedimientos de valorización de obras de construcción, incluyendo la elaboración de valorizaciones, aprobación, pago y tipos de valorizaciones. También cubre temas como reajustes de precios, liquidación de obras, ampliación de plazos y solución de controversias.
El documento presenta información sobre la programación de obras, incluyendo diagramas de Gantt, métodos de ruta crítica como CPM y PERT, y holguras en la programación. También incluye los nombres de los integrantes del proyecto y su docente a cargo. Finalmente, detalla los contenidos que serán tratados como introducción, procesos administrativos, técnicas de programación y aplicaciones a proyectos.
El documento presenta la liquidación técnica y financiera de la obra de mejoramiento del sistema de agua potable y alcantarillado en Santa Bárbara de Carhuacayan. Se describe el proyecto, los objetivos, alcances, presupuesto base, revisión del expediente técnico, verificación de los trabajos ejecutados y su cumplimiento de metas. La obra cumplió con un 118.16% de los trabajos previstos originalmente.
Construction Project Management is an important subject to learn in Civil Engineering.
Significance • As construction involves various activities starting from the design and planning to project completion and quality check, there is a exorbitant need for Management of construction. • Construction Industry plays a crucial role in the economy and development of a nation.
4. Objectives To complete the project in specified time and with allocated budget. To Plan and schedule the work and distribute between various departments. Deployment of personnel in Different tasks. To achieve High quality workmanship. Creating an organisation that works as a team. Using the limited available resources and producing maximum output. Providing safe and satisfactory working conditions for all personnel and workers.
5. Functions: Planning & Scheduling Organizing Staffing Directing Controlling & Co-ordinating
6. Stages of construction Briefing Designing Tendering Construction Commissioning
7. 1) Briefing Stage • This stage consists of framework required for the construction work to take a shape from the ideology of client and feasibility of Project which involves architects, engineers and project manager.
Objectives Developing Alternatives Feasible Solution ? Evaluation of Alternatives Report & Recommendation Technical and non technical Investigations
8. 2) Designing or planning Stage Prepare construction schedule Prepare final cost estimate Prepare Working Drawings and specificati ons Prepare scheme and detailed designs Soil investigations, Topographic investigation, material supply and market surveys etc Carry out Technical Investigations Final adoption of the most suitable summary Finalize Project Summary
Este documento establece 12 normas que regulan la ejecución de obras públicas por administración directa. Las normas requieren que las entidades cuenten con presupuesto, personal y equipos para ejecutar obras, y que los convenios precisen la capacidad operativa. También establecen que se debe contar con un expediente técnico aprobado, demostrar que el costo es igual o menor al presupuesto, llevar un cuaderno de obra, designar supervisores e ingenieros, y realizar liquidaciones técnicas y financieras dentro de los
Este documento presenta información sobre la administración directa de obras públicas, incluyendo normativa, roles y responsabilidades, procesos de aprobación, ejecución, recepción y liquidación de obras. Se explican conceptos como presupuesto, crédito presupuestario y ejecución presupuestaria en el contexto de obras públicas.
una organización que se encarga de gestionar y supervisar las tareas y actividades relacionadas con la administración de la empresa. Esta unidad generalmente se encarga de aspectos clave como la gestión de recursos humanos, la gestión financiera, la logística, la planificación estratégica y otras funciones administrativas esenciales.
Este documento establece normas y procedimientos para la ejecución, supervisión, recepción, liquidación y transferencia de obras y proyectos por administración directa en la Municipalidad Distrital de Cielo Punco. Define roles como residente de obra, supervisor de obra e inspector de obra. Describe etapas como ejecución presupuestaria directa, supervisión previa y concurrente, control de calidad, liquidación físico financiera. El objetivo es uniformizar criterios para el análisis, evaluación y control de obras desde la ejecución hasta
La resolución establece 12 normas para regular la ejecución de obras públicas por administración directa. Las normas requieren que las entidades tengan asignación presupuestaria, personal y equipos para ejecutar obras, y que los convenios precisen la capacidad operativa de la entidad ejecutora. También se requiere un expediente técnico aprobado que incluya planos, especificaciones y presupuesto, así como supervisión de la obra y presentación de informes.
Este documento establece los requisitos técnicos mínimos para la contratación del servicio de consultoría de supervisión de la obra "Instalación del Sistema Integrado de Agua Potable y Saneamiento en la Localidad de Callalli, Distrito de Callalli-Arequipa". El plazo de ejecución es de 210 días y la supervisión incluirá actividades como la revisión de avances, valorizaciones mensuales, informes y asegurar el cumplimiento de especificaciones.
Esta resolución establece las normas para la ejecución de obras públicas por administración directa, requiriendo que las entidades cuenten con los recursos presupuestales, personal y equipos necesarios, así como con el expediente técnico aprobado de la obra. Asimismo, designa a un ingeniero residente o inspector responsable de supervisar la ejecución de la obra y presentar informes mensuales, y establece el proceso de recepción, liquidación y entrega de la obra una vez concluida.
Este documento proporciona instrucciones para elaborar ejemplos de cuatro tipos de contratos de obra - por administración, por precio unitario, por precio alzado y por llave en mano. Incluye un ejemplo detallado de un contrato por administración para el puesto de supervisor de una obra de construcción de un parque turístico.
La Contraloría General de la República aprobó la Directiva N° 002-2010-CG/OEA para regular el control previo externo de las prestaciones adicionales de obra. La nueva directiva establece los procedimientos, criterios de evaluación e información requerida para la autorización previa de presupuestos adicionales de obra. Con esto, se busca dotar de celeridad, eficacia y transparencia al proceso de aprobación de prestaciones adicionales, reemplazando la directiva anterior sobre este tema.
Este documento establece los procedimientos para la designación de ingenieros residentes para obras públicas ejecutadas directamente por la Municipalidad Provincial de Chiclayo. Define los requisitos mínimos y el proceso de contratación de los ingenieros residentes, así como sus funciones, obligaciones y remuneración. También especifica las responsabilidades de la municipalidad y establece penalidades por incumplimiento de la directiva.
1) La supervisión de obra consiste en realizar un seguimiento puntual de carácter normativo, técnico, administrativo y de control de calidad para asegurar que la obra se ejecute con calidad, costo y tiempo establecidos.
2) El supervisor es la persona encargada de representar a la entidad financiadora y supervisar la ejecución de la obra por parte del contratista, controlando tiempo, calidad y costo.
3) Las principales funciones del supervisor son velar por el cumplimiento del contrato, normas y especificaciones técn
La liquidación final de obras es un proceso técnico-legal-administrativo para determinar el costo real y total de una obra. Existen dos tipos de liquidación: por contrata y por administración directa. La liquidación por contrata implica que el contratista presente su liquidación dentro de plazos establecidos y sea observada por la entidad, mientras que la liquidación por administración directa requiere una comisión para realizar la liquidación técnica y financiera dentro de 30 días de recibida la obra.
El documento determina la normativa aplicable a la ejecución presupuestaria indirecta (obras por contrata) y directa. Establece similitudes y diferencias entre ambos tipos de ejecución, como los controles de calidad y los mayores costos en la modalidad indirecta. También determina que los presupuestos adicionales y deductivos pueden recibir el mismo tratamiento en ambas modalidades y analiza las diferencias en los controles técnico-administrativos dependiendo de si la obra es ejecutada directa o indirectamente. Finalmente, recom
La Contraloría General de la República de Perú aprobó una nueva Directiva que norma el control previo externo de las prestaciones adicionales de obra. La Directiva establece los procedimientos, criterios y requisitos para la aprobación de presupuestos adicionales de obra que requieren autorización previa de la Contraloría. Se deja sin efecto la Directiva anterior sobre este tema y se encarga la difusión de la nueva Directiva.
La Contraloría General de la República de Perú aprobó la Directiva N° 002-2010-CG/OEA para regular el control previo de las prestaciones adicionales de obra. La nueva directiva actualiza las normas anteriores a fin de asegurar un proceso de control transparente y eficaz. Asimismo, orienta a las entidades ejecutoras sobre el procedimiento para obtener la autorización de prestaciones adicionales y deja sin efecto directivas anteriores.
La Contraloría General de la República aprobó la Directiva No 002-2010-CG/OEA para regular el control previo externo de las prestaciones adicionales de obra. La nueva directiva actualiza las normas anteriores a fin de estar acorde con la legislación vigente sobre contrataciones del Estado. La directiva establece los procedimientos, criterios y alcances del control previo que realiza la Contraloría a las prestaciones adicionales de obra aprobadas por las entidades ejecutoras.
La propuesta de directiva establece los procedimientos para la liquidación técnica y financiera de obras públicas construidas por contratistas. Determina el costo total de las obras, compara los montos pagados con los costos y determina el saldo a favor del contratista o de la entidad. Establece normas para regular los procesos de liquidación de obras ejecutadas por la Municipalidad Provincial de San Román Juliaca y uniformizar la elaboración y aprobación de las liquidaciones de contrato.
000012 mc 98-2005-gob-reg__hvca_gsrt-basesHomar Vilabaña
TERMINO DE REFERENCIA PARA LIQUIDACION DE OBRAS
I.- OBJETIVOS:
Contratar a la Persona Natural o Jurídica, para la formulación de la liquidación físico
Financiero de los proyectos de inversión, estudios y obras ejecutadas por la modalidad de administración directa, para determinar el costo final de la obra que luego de ser transferida al sector o beneficiario, correspondiente este regularice la inscripción en los registros públicos previa declaratoria de fabrica y/o memoria descriptiva según el caso y se le permita su uso, mantenimiento y conservación adecuada.
El documento establece normas y procedimientos para la ejecución de obras públicas por la modalidad de ejecución presupuestaria directa en el Gobierno Regional de Junín. Define términos clave como residente de obra, supervisor, expediente técnico y establece disposiciones generales sobre los informes técnicos, legales y presupuestarios requeridos, así como las condiciones básicas para la ejecución presupuestaria directa de obras, entre otros aspectos relevantes para el proceso de ejecución de obras públicas por
CONGRESO NACIONAL GRATUITO DE SECRETARIAS Y ASISTENTES DE GERENCIA
MODALIDAD VIRTUAL ONLINE A NIVEL NACIONAL E INTERNACIONAL
Fecha: sábado 7 de noviembre de 2020
Horario: 10:00am a 1:00pm y 4:00pm a 7:00pm
Plataforma: Zoom, Facebook Live, quedará grabado en campus virtual Cietsi: https://institutocietsi.com/p/congreso-secretarias/
Informes y consultas:
(074) 637020, WhatsApp: 968059963, 956272261, informes@cietsiperu.com, www.cietsiperu.com
Sistema integrado de gestión administrativa – SIGA MEF que formó parte del CONGRESO NACIONAL DE GESTIÓN PÚBLICA 2020 organizado por el Centro de Altos Estudios Cietsi Perú
Campus virtual: https://institutocietsi.com/p/cngp/
Contacto: (074) 637020, Celular/WhatsApp: 956272261, 968059963
Sistema integrado de administración financiera – SIAF que formó parte del CONGRESO NACIONAL DE GESTIÓN PÚBLICA 2020 organizado por el Centro de Altos Estudios Cietsi Perú
Campus virtual: https://institutocietsi.com/p/cngp/
Contacto: (074) 637020, Celular/WhatsApp: 956272261, 968059963
Taller Control gubernamental que formó parte del CONGRESO NACIONAL DE GESTIÓN PÚBLICA 2020 organizado por el Centro de Altos Estudios Cietsi Perú
Campus virtual: https://institutocietsi.com/p/cngp/
Contacto: (074) 637020, Celular/WhatsApp: 956272261, 968059963
Muy pronto en Chiclayo y por PRIMERA VEZ podrás rendir el examen de certificación oficial ITIL 2011 y se brindará al finalizar el entrenamiento del curso “Fundamentos de Gestión de Servicios de TI”
Instructor
Ing. Julio Mamani Amanca (Lima)
Ing. de Sistemas UNI, +12 años de experiencia profesional como consultor e instructor de Gestión de Servicios de TI.
Fechas:
Sábado 12 y domingo 13 de julio 2014 de 8:00am a 1:00pm – 2:00pm a 6:00pm
Mayor detalle aquí: http://bit.ly/1qxeR4A
"El examen de certificación oficial es opcional"
DIPLOMADO DE ESPECIALIZACIÓN EN SIAF 2014 - Nuevo inicio: 05 de Abril 2014
Se desarrollaran los siguientes módulos: Presupuesto, Administrativo, Tesorería y Contable
Además:
Aprenderá a utilizar los Software Melissa y Clarissa (Generador de reportes SIAF)
Transmisiones en Clase
Complementamos tu aprendizaje con clases de reforzamiento presenciales totalmente gratis!
Asistencia Virtual las 24 horas, todos los días.
Plataforma Virtual con todo el material de clase (campus.cietsiperu.com).
Capacitación en el cumplimiento de metas – MEF
Consulta de expediente SIAF vía Web
Formulario electrónico de atención al usuario SIAF
Instalación del SIAF real (sin DEMO) desde CERO para servidores y PC Clientes
Incluye:
Material impreso
Computador por alumno
Material oficial del MEF (demos)
Vídeos de todas las sesiones grabadas
Coffee Breaks
VACANTES LIMITADAS!!!
Informes e inscripciones: Calle Colón 474, Chiclayo
Teléfono: 074 637020, Celular: 968059963, RPM: #968059963, Email: informes@cietsiperu.com, Web: www.cietsiperu.com
Este documento describe la historia y desarrollo de la televisión por cable. Comenzó en los años 1940 cuando un técnico montó una pequeña red que distribuía señales de televisión a vecinos a través de cable para mejorar la recepción. La televisión por cable ha evolucionado para ofrecer varios canales a través de redes de cable coaxial o fibra óptica. Actualmente opera bajo licencias o comunicaciones previas y distribuye canales de televisión, radio, video bajo demanda y otros servicios interactivos a hogares y com
El Premio Graña y Montero a la Investigación en Ingeniería Peruana aceptará hasta el 22 de marzo del 2013 la inscripción de trabajos en sus dos categorías: investigación profesional y tesis universitaria.
El documento habla sobre estrategias de marketing y redes sociales. Explica conceptos clave como qué es el marketing, las fases de implantación de estrategias de marketing relacional y por qué es necesario hacer marketing online e integral. También cubre estrategias específicas de marketing en redes sociales como la conectividad, honestidad, ser humano, generosidad e imaginación para comunicarse de manera efectiva con los clientes.
Este documento presenta una charla sobre hacking ético y defensa en profundidad. Explica los problemas comunes de seguridad de la información, como la falta de inversión y cultura de seguridad. Luego describe las fases de un análisis de seguridad ético, incluido el reconocimiento pasivo, el reconocimiento activo y el análisis de vulnerabilidades. Finalmente, compara el hacking ético con la defensa en profundidad como enfoques para la seguridad.
Metasploit es un proyecto de código abierto que proporciona información sobre vulnerabilidades de seguridad y ayuda en pruebas de penetración. Su componente principal es el Metasploit Framework, una herramienta para desarrollar y ejecutar exploits contra sistemas remotos. Originalmente fue creado en Perl pero ahora está escrito en Ruby. Armitage es un administrador gráfico de ataques de ciberseguridad para Metasploit que permite visualizar objetivos de forma gráfica y recomienda exploits, además de exponer opciones av
¿Cómo ser un Hacker? realizado por Eric Raymond, donde nos informa entre otras cosas la diferencia entre un hacker y cracker, como también los diferentes lenguajes de programación que debemos saber (Python, Perl, C, Lisp y HTML) para inicializarnos en el mundo de los grandes hackers.
Este documento proporciona una introducción a las máquinas virtuales. Explica brevemente qué son las máquinas virtuales y sus usos principales. Luego discute diferentes plataformas de virtualización como VMware, VirtualBox y Windows Virtual PC. Finalmente, cubre temas como la descarga, instalación y configuración básica de máquinas virtuales usando VirtualBox.
Más de Centro de Altos Estudios en Ciencias, Tecnologias y Seguridad de la Información (16)
En la ciudad de Pasto, estamos revolucionando el acceso a microcréditos y la formalización de microempresarios informales con nuestra aplicación CrediAvanza. Nuestro objetivo es empoderar a los emprendedores locales proporcionándoles una plataforma integral que facilite el acceso a servicios financieros y asesoría profesional.
José Luis Jiménez Rodríguez
Junio 2024.
“La pedagogía es la metodología de la educación. Constituye una problemática de medios y fines, y en esa problemática estudia las situaciones educativas, las selecciona y luego organiza y asegura su explotación situacional”. Louis Not. 1993.
ACERTIJO DESCIFRANDO CÓDIGO DEL CANDADO DE LA TORRE EIFFEL EN PARÍS. Por JAVI...JAVIER SOLIS NOYOLA
El Mtro. JAVIER SOLIS NOYOLA crea y desarrolla el “DESCIFRANDO CÓDIGO DEL CANDADO DE LA TORRE EIFFEL EN PARIS”. Esta actividad de aprendizaje propone el reto de descubrir el la secuencia números para abrir un candado, el cual destaca la percepción geométrica y conceptual. La intención de esta actividad de aprendizaje lúdico es, promover los pensamientos lógico (convergente) y creativo (divergente o lateral), mediante modelos mentales de: atención, memoria, imaginación, percepción (Geométrica y conceptual), perspicacia, inferencia y viso-espacialidad. Didácticamente, ésta actividad de aprendizaje es transversal, y que integra áreas del conocimiento: matemático, Lenguaje, artístico y las neurociencias. Acertijo dedicado a los Juegos Olímpicos de París 2024.
3. • Normatividad Vigente:
1) Constitución Política del Perú, Art 76° “Obligatoriedad de la
Contrata y Licitación Pública”
Las obras y la adquisición de suministros con utilización de fondos o
recursos públicos, se ejecutan obligatoriamente por contrata y
licitación pública, así como también la adquisición de bienes.
La contratación de servicios y Proyectos cuya importancia y cuyo
monto señala la ley de Presupuesto, se hace por CONCURSO PÚBLICO,
la ley establece el procedimiento, las excepciones y las respectivas
responsabilidades.
Marco Normativo
www.cietsiperu.com

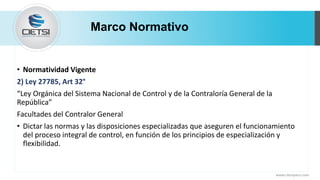

4. Marco Normativo
• Normatividad Vigente
2) Ley 27785, Art 32°
“Ley Orgánica del Sistema Nacional de Control y de la Contraloría General de la
República”
Facultades del Contralor General
• Dictar las normas y las disposiciones especializadas que aseguren el funcionamiento
del proceso integral de control, en función de los principios de especialización y
flexibilidad.
www.cietsiperu.com
5. Marco Normativo
www.cietsiperu.com
3) Resolución de la Contraloría N° 195-1988-CG. , Art° 01
• Entidades deben contar con asignación presupuestal, personal técnico administrativo y
equipos necesarios.
• Requisito indispensable: Expediente Técnico completo.
• Demostrar que el costo total de la obra por A.D. resulta <o= al presupuesto base.
• Se contará con un Cuaderno de Obra.
• La entidad contará con Supervisión de Obras.
• Entidad designará al Residente de Obra.
• El Ingeniero residente y/o Inspector presentará mensualmente un informe detallado al nivel
correspondiente sobre el avance físico valorizado de la obra, precisando los aspectos
limitantes y las recomendaciones para superarlos, debiendo la entidad disponer de las
medidas correctivas.

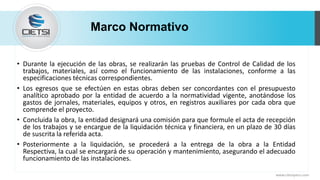

6. Marco Normativo
• Durante la ejecución de las obras, se realizarán las pruebas de Control de Calidad de los
trabajos, materiales, así como el funcionamiento de las instalaciones, conforme a las
especificaciones técnicas correspondientes.
• Los egresos que se efectúen en estas obras deben ser concordantes con el presupuesto
analítico aprobado por la entidad de acuerdo a la normatividad vigente, anotándose los
gastos de jornales, materiales, equipos y otros, en registros auxiliares por cada obra que
comprende el proyecto.
• Concluida la obra, la entidad designará una comisión para que formule el acta de recepción
de los trabajos y se encargue de la liquidación técnica y financiera, en un plazo de 30 días
de suscrita la referida acta.
• Posteriormente a la liquidación, se procederá a la entrega de la obra a la Entidad
Respectiva, la cual se encargará de su operación y mantenimiento, asegurando el adecuado
funcionamiento de las instalaciones.
www.cietsiperu.com

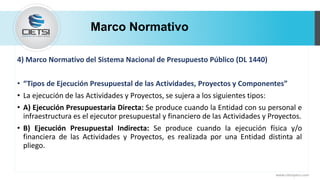

7. Marco Normativo
www.cietsiperu.com
4) Marco Normativo del Sistema Nacional de Presupuesto Público (DL 1440)
• “Tipos de Ejecución Presupuestal de las Actividades, Proyectos y Componentes”
• La ejecución de las Actividades y Proyectos, se sujera a los siguientes tipos:
• A) Ejecución Presupuestaria Directa: Se produce cuando la Entidad con su personal e
infraestructura es el ejecutor presupuestal y financiero de las Actividades y Proyectos.
• B) Ejecución Presupuestal Indirecta: Se produce cuando la ejecución física y/o
financiera de las Actividades y Proyectos, es realizada por una Entidad distinta al
pliego.

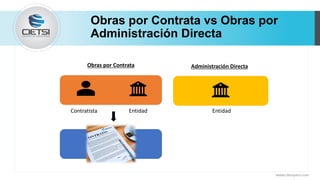

8. Obras por Contrata vs Obras por
Administración Directa
www.cietsiperu.com
Obras por Contrata Administración Directa
Contratista Entidad Entidad

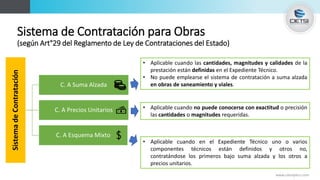

9. Sistema de Contratación para Obras
(según Art°29 del Reglamento de Ley de Contrataciones del Estado)
www.cietsiperu.com
SistemadeContratación
C. A Suma Alzada
C. A Precios Unitarios
C. A Esquema Mixto
• Aplicable cuando las cantidades, magnitudes y calidades de la
prestación están definidas en el Expediente Técnico.
• No puede emplearse el sistema de contratación a suma alzada
en obras de saneamiento y viales.
• Aplicable cuando no puede conocerse con exactitud o precisión
las cantidades o magnitudes requeridas.
• Aplicable cuando en el Expediente Técnico uno o varios
componentes técnicos están definidos y otros no,
contratándose los primeros bajo suma alzada y los otros a
precios unitarios.
10. Sistema de Contratación para Obras
(según Art°29 del Reglamento de Ley de Contrataciones del Estado)
www.cietsiperu.com
SistemadeContratación
De Tarifa
En base a porcentajes
Honorario Mixto y Comisión de
Éxito
• Se emplea exclusivamente para consultorías en general y
consultorías de obra cuando no se conoce con precisión el
tiempo de prestación de servicios.
• Ej.: Las supervisiones de obra.
• Se emplea para la contratación de servicios de cobranza,
recuperaciones o prestaciones de naturaleza similar
• Ej.: servicios de terceros para cobranzas.
• Se emplea para contrataciones de servicios cuando el postor
formula su oferta con un monto fijo y adicional a ello hay un
monto con un incentivo por resultado.
• Ej.: la contratación de un abogado para un patrocinio judicial.
11. Normatividad Específica:
• Para el caso de entidades públicas ya sea Gobiernos Regionales o Municipalidades
estas deberán contar con Normatividad Propia Específica y Resolución de
Aprobación para ejecución de obras por Administración Directa, donde se
establezcan los criterios y pasos a seguir para la ejecución de las mismas, de no
tenerlas se sujetaran a la resolución de Contraloría N°195-88-CG del 18 de julio de
1988.
www.cietsiperu.com
12. Normatividad Específica:
• DIRECTIVA N° 004 - 2012 –
MPCHI/GIP
"PROCEDIMIENTO PARA EL PROCESO
DE RECEPCIÓN, LIQUIDACIÓN y
TRANSFERENClA DE LAS OBRAS Y
PROYECTOS EJECUTADOS POR
ADMINISTRACIÓN DIRECTA”
www.cietsiperu.com
13. Personajes Vinculados
• Residente de Obra:
- Toda obra contará de manera permanente y Directo
con Residente de Obra.
- Profesional Colegiado y Habilitado, servidor o
funcionario de la Entidad, expresamente designado por
esta.
- Para trabajos especializados; la Entidad está en la
obligación de contratar un profesional con experiencia
en la misma, de manera de garantizar el trabajo que se
realice.
www.cietsiperu.com

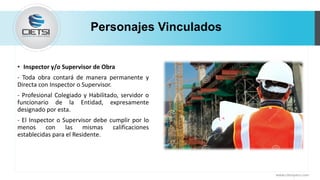

14. Personajes Vinculados
• Inspector y/o Supervisor de Obra
- Toda obra contará de manera permanente y
Directa con Inspector o Supervisor.
- Profesional Colegiado y Habilitado, servidor o
funcionario de la Entidad, expresamente
designado por esta.
- El Inspector o Supervisor debe cumplir por lo
menos con las mismas calificaciones
establecidas para el Residente.
www.cietsiperu.com

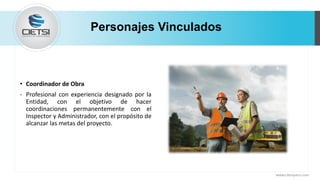

15. Personajes Vinculados
• Coordinador de Obra
- Profesional con experiencia designado por la
Entidad, con el objetivo de hacer
coordinaciones permanentemente con el
Inspector y Administrador, con el propósito de
alcanzar las metas del proyecto.
www.cietsiperu.com
16. Pre Liquidación de Obra
• La pre-liquidación de obra consiste en ordenar toda la documentación
técnica y financiera del proyecto y sirve de base para la liquidación.
• A la fecha de la recepción de obra, el Residente y/o Inspector deben
contar con un 80% de avance de la Pre Liquidación, siendo el
Coordinador el responsable de velar por su cumplimiento.
• El Residente y el Inspector son responsables de preparar el Expediente
de Pre Liquidación de Obra, el cual presentaran a la Oficina de
Liquidaciones y transferencia o quien haga sus veces.
www.cietsiperu.com

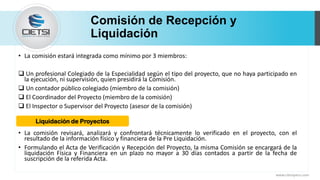

17. Comisión de Recepción y
Liquidación
• Concluida la Obra, la Entidad designará una comisión para que formule
el Acta de Recepción de los trabajos, y se encargue de la liquidación
Técnica y Financiera, en un plazo de 30 días de suscrita la referida Acta.
• La misma Comisión revisará la Memoria Descriptiva elaborada por el
Residente y/o Inspector de la Obra, que servirá de base para la
elaboración final de la Liquidación Técnica Financiera.
www.cietsiperu.com
Art°1, Inciso 11, R.C. 195-88-CG
18. Comisión de Recepción y
Liquidación
• La comisión estará integrada como mínimo por 3 miembros:
Un profesional Colegiado de la Especialidad según el tipo del proyecto, que no haya participado en
la ejecución, ni supervisión, quien presidirá la Comisión.
Un contador público colegiado (miembro de la comisión)
El Coordinador del Proyecto (miembro de la comisión)
El Inspector o Supervisor del Proyecto (asesor de la comisión)
• La comisión revisará, analizará y confrontará técnicamente lo verificado en el proyecto, con el
resultado de la información físico y financiera de la Pre Liquidación.
• Formulando el Acta de Verificación y Recepción del Proyecto, la misma Comisión se encargará de la
liquidación Física y Financiera en un plazo no mayor a 30 días contados a partir de la fecha de
suscripción de la referida Acta.
www.cietsiperu.com
Liquidación de Proyectos

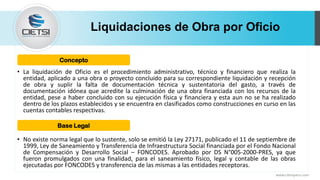

19. Liquidaciones de Obra por Oficio
• La liquidación de Oficio es el procedimiento administrativo, técnico y financiero que realiza la
entidad, aplicado a una obra o proyecto concluido para su correspondiente liquidación y recepción
de obra y suplir la falta de documentación técnica y sustentatoria del gasto, a través de
documentación idónea que acredite la culminación de una obra financiada con los recursos de la
entidad, pese a haber concluido con su ejecución física y financiera y esta aun no se ha realizado
dentro de los plazos establecidos y se encuentra en clasificados como construcciones en curso en las
cuentas contables respectivas.
• No existe norma legal que lo sustente, solo se emitió la Ley 27171, publicado el 11 de septiembre de
1999, Ley de Saneamiento y Transferencia de Infraestructura Social financiada por el Fondo Nacional
de Compensación y Desarrollo Social – FONCODES. Aprobado por DS N°005-2000-PRES, ya que
fueron promulgados con una finalidad, para el saneamiento físico, legal y contable de las obras
ejecutadas por FONCODES y transferencia de las mismas a las entidades receptoras.
www.cietsiperu.com
Concepto
Base Legal

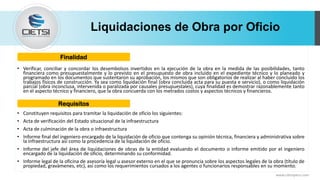

20. Liquidaciones de Obra por Oficio
• Verificar, conciliar y concordar los desembolsos invertidos en la ejecución de la obra en la medida de las posibilidades, tanto
financiera como presupuestalmente y lo previsto en el presupuesto de obra incluido en el expediente técnico y lo planeado y
programado en los documentos que sustentaron su aprobación, los mismos que son obligatorios de realizar al haber concluido los
trabajos físicos de construcción. Ya sea como liquidación final (obra concluida acta para su puesta e servicio), o como liquidación
parcial (obra inconclusa, intervenida o paralizada por causales presupuestales), cuya finalidad es demostrar razonablemente tanto
en el aspecto técnico y financiero, que la obra concuerda con los metrados costos y aspectos técnicos y financieros.
• Constituyen requisitos para tramitar la liquidación de oficio los siguientes:
• Acta de verificación del Estado situacional de la infraestructura
• Acta de culminación de la obra o infraestructura
• Informe final del ingeniero encargado de la liquidación de oficio que contenga su opinión técnica, financiera y administrativa sobre
la infraestructura así como la procedencia de la liquidación de oficio.
• Informe del jefe del área de liquidaciones de obras de la entidad evaluando el documento o informe emitido por el ingeniero
encargado de la liquidación de oficio, determinando su conformidad.
• Informe legal de la oficina de asesoría legal u asesor externo en el que se pronuncia sobre los aspectos legales de la obra (título de
propiedad, gravámenes, etc), así como los requerimientos cursados a los agentes o funcionarios responsables en su momento.
www.cietsiperu.com
Finalidad
Requisitos
21. Liquidaciones de Obra por Oficio
• Informe legal: así mismo documento que acredite el inicio
de las acciones administrativas, civiles y/o penales.
• Valorización final de la obra.
• Fotografías de la obra terminada en presencia del
ingeniero encargado.
• Copia del contrato y/o expediente técnico de ser el caso.
www.cietsiperu.com
Requisitos
